  1. MicroBooNE Working Group Meeting June 22, 2010 2:00– 3:00 PM Snake Pit

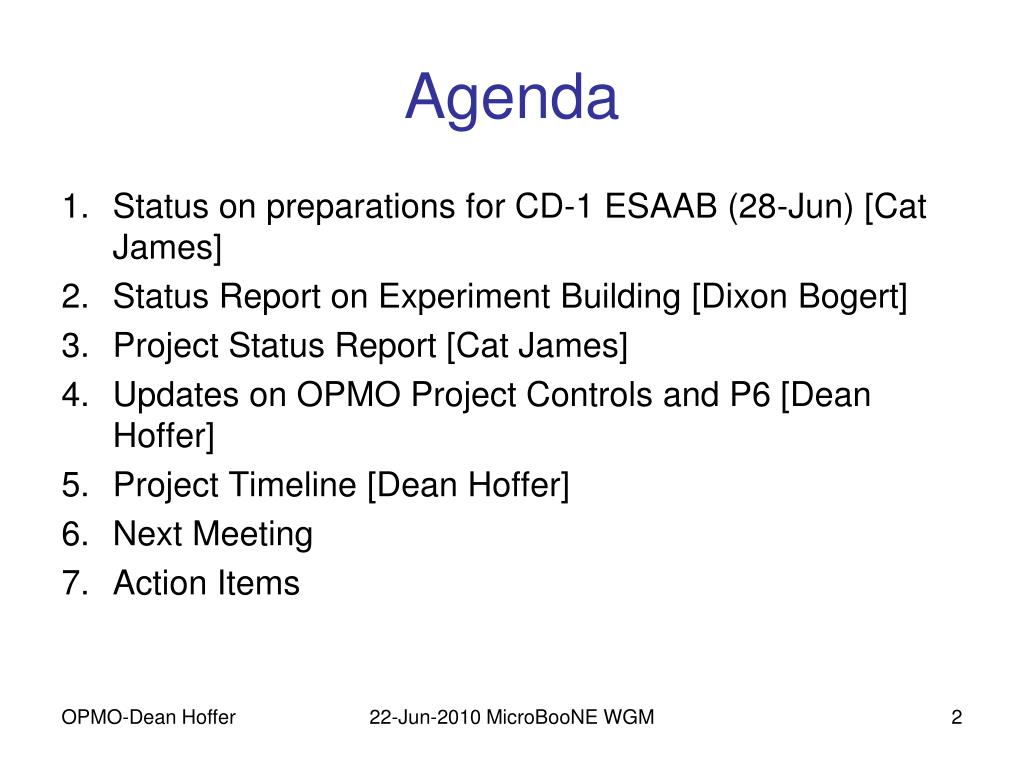

  2. Agenda • Status on preparations for CD-1 ESAAB (28-Jun) [Cat James] • Status Report on Experiment Building [Dixon Bogert] • Project Status Report [Cat James] • Updates on OPMO Project Controls and P6 [Dean Hoffer] • Project Timeline [Dean Hoffer] • Next Meeting • Action Items 22-Jun-2010 MicroBooNE WGM

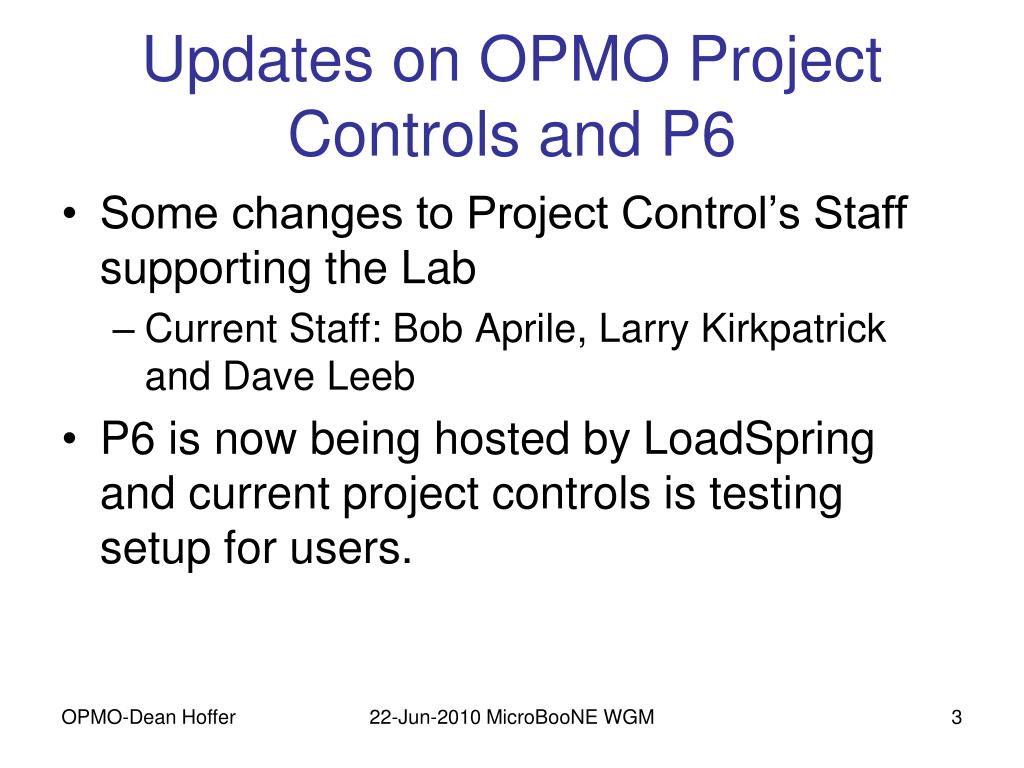

  3. Updates on OPMO Project Controls and P6 • Some changes to Project Control’s Staff supporting the Lab • Current Staff: Bob Aprile, Larry Kirkpatrick and Dave Leeb • P6 is now being hosted by LoadSpring and current project controls is testing setup for users. 22-Jun-2010 MicroBooNE WGM

  4. 22-Jun-2010 MicroBooNE WGM

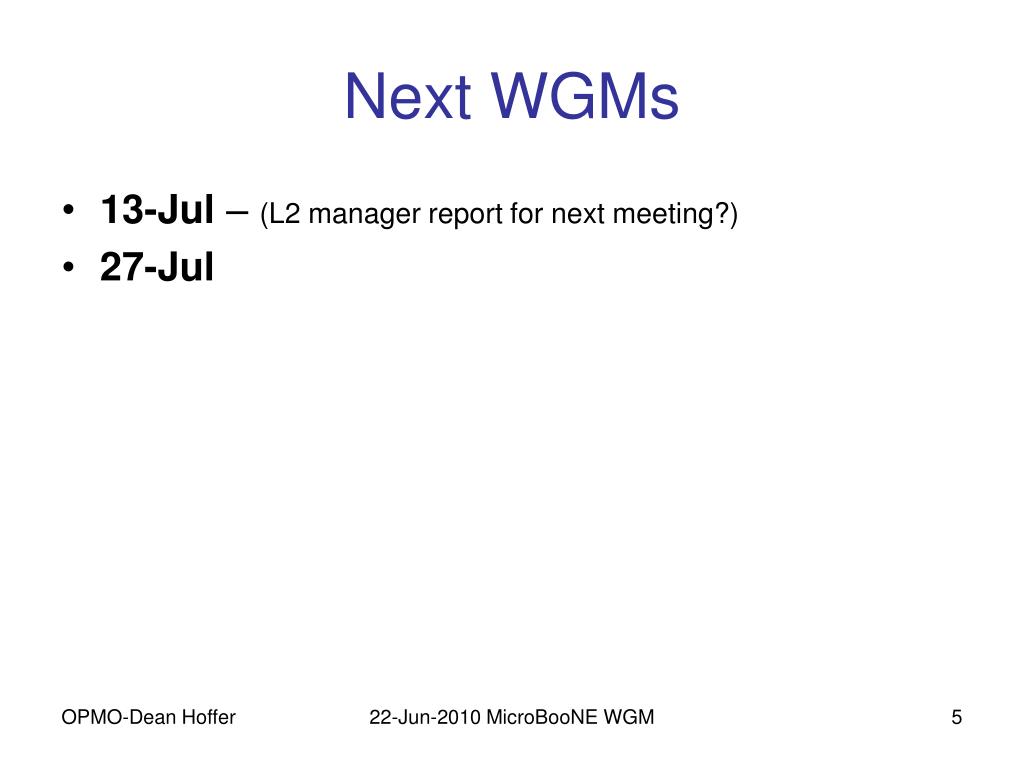

  5. Next WGMs • 13-Jul – (L2 manager report for next meeting?) • 27-Jul 22-Jun-2010 MicroBooNE WGM

  6. Action Items Open Items from Last WGM: • Paul Philp – update the cost range in the PEP and Acquisition Strategy and get the documents signed off. • Ted Lavine – check on issuance of Dan Lehman’s CD-1 report to Fermilab. • Dean – Update the project timeline with the ESAAB date. Open Items from Prior Meetings: • Dean - Arrange formal training for users of Primavera. • Cat - Fill remaining positions in project office 22-Jun-2010 MicroBooNE WGM
