Undulator Assembly and Installation Planning. Rodd Pope, SLAC. By Scott Doran, ANL. UNDULATOR CELL ASSEMBLY NEXT CELL UNDULATOR SHOWN FOR CLARITY. By Scott Doran, ANL. UNDULATOR CELL ASSEMBLY NEXT CELL UNDULATOR SHOWN FOR CLARITY. Collaboration Roles and Responsibilities (abridged).
E N D
Undulator Assembly and Installation Planning Rodd Pope, SLAC
By Scott Doran, ANL UNDULATOR CELL ASSEMBLY NEXT CELL UNDULATOR SHOWN FOR CLARITY
By Scott Doran, ANL UNDULATOR CELL ASSEMBLY NEXT CELL UNDULATOR SHOWN FOR CLARITY
Collaboration Roles and Responsibilities(abridged) • ANL – Stephen Milton Geoff Pile • Design the System and Sub-assemblies minus WPM/HLS • Supply Designed Sub-assemblies • Provide Expertise • SLAC Metrology – Robert Ruland • Design and Supply WPM/HLS System • Undulator Tuning & Quadrupole Measurement • Develop and Test Fiducialization Procedures • Provide Expertise • SLAC Assembly & Installation – Ben Poling • Girder Assembly • System Installation • Material Handling and Storage • Provide Expertise
Assembly, Installation, and Maintenance Group • Undulator Assembly, Installation and Maintenance Group (U-AIM) • Supervisor – Ben Poling • Principal Technician – Ed Akerstrom • Principal Technician – Nick Horton • Material Handling, Assembly Preparation, Installation Planning • Three Engineering Assistants • Michelle Chan, William Rowan, Austin Schuh • Summer Support of Design, Engineering, Production Activities
Assembly – Installation Outline • Receive Assemblies, Sub-assemblies, and Kits • Inspect, Modify, Store • Girder Rough Assembly • Girder Precision Assembly • Anchor Installation (Davis-Bacon) • Pedestal Installation (Davis-Bacon) • Girder Installation (Davis-Bacon) and Mover Startup • Vacuum System Completion • WPM/HLS Installation and Startup • Undulator Magnet Installation
Assembly, Install, & Storage Space Undulator Tunnel B081 – MMF Tuning/Fiducialization B750 – Storage/Assembly
Undulator System Girder Assembly Precise/Vacuum Assembly performed in a control environment Field Installation
SLAC Magnetic Measurement FacilityWolf, Zachary, LCLS Management Presentation, April 11, 2006, Slide 3 • Floor plan divided into three functional areas • Magnetic Measurements (± 0.1º C) • Fiducialization and Assembly (± 1º C) • Storage (± 2.5º C) Assembly Area Storage and Queuing LCLS-TN-04-1

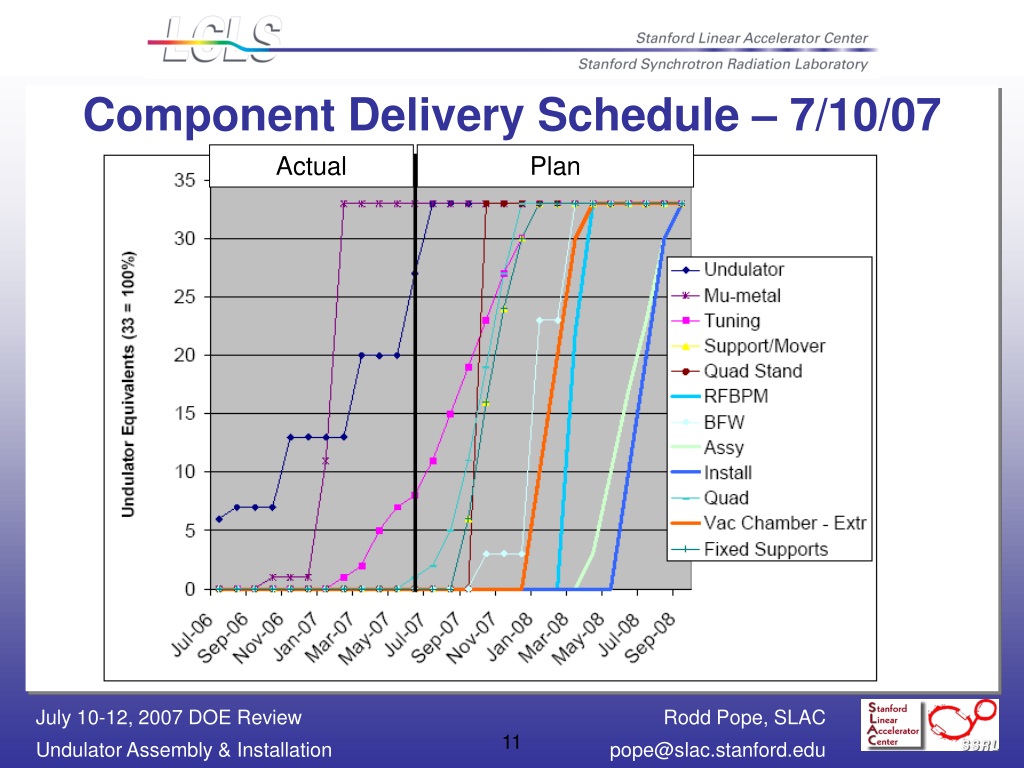

Component Delivery Schedule – 7/10/07 Actual Plan

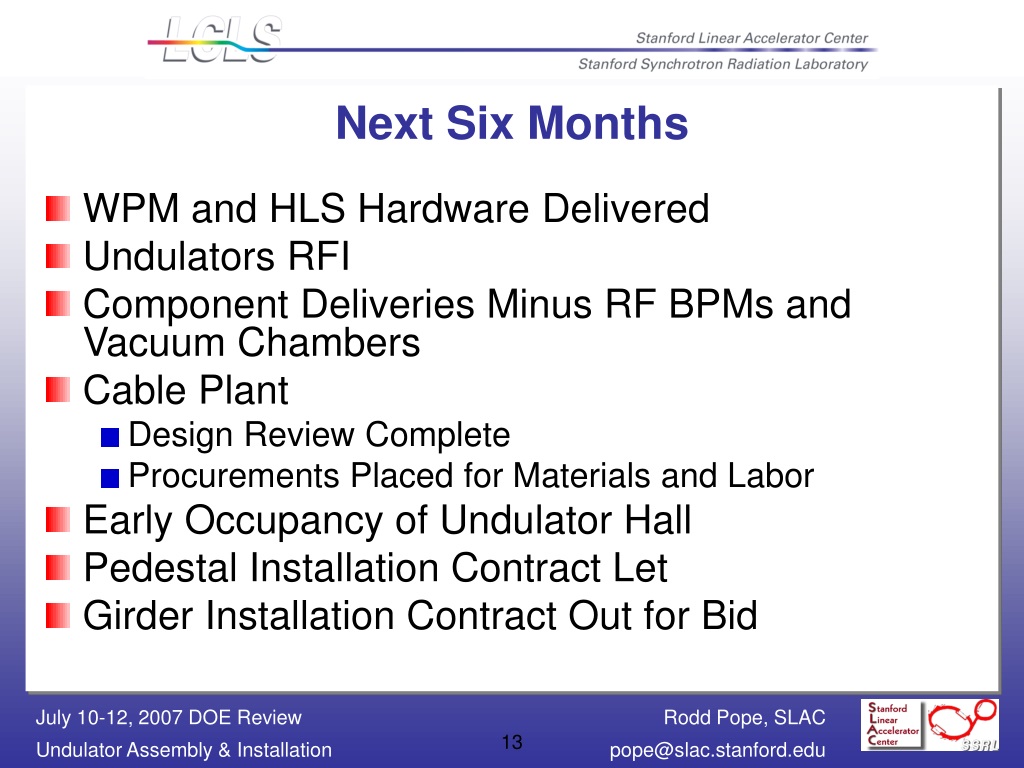

Next Six Months • WPM and HLS Hardware Delivered • Undulators RFI • Component Deliveries Minus RF BPMs and Vacuum Chambers • Cable Plant • Design Review Complete • Procurements Placed for Materials and Labor • Early Occupancy of Undulator Hall • Pedestal Installation Contract Let • Girder Installation Contract Out for Bid
By Scott Doran, ANL SHORT BREAK
By Scott Doran, ANL SHORT BREAK CROSS SECTIONS
By Scott Doran, ANL LONG BREAK
By Scott Doran, ANL LONG BREAK CROSS SECTIONS

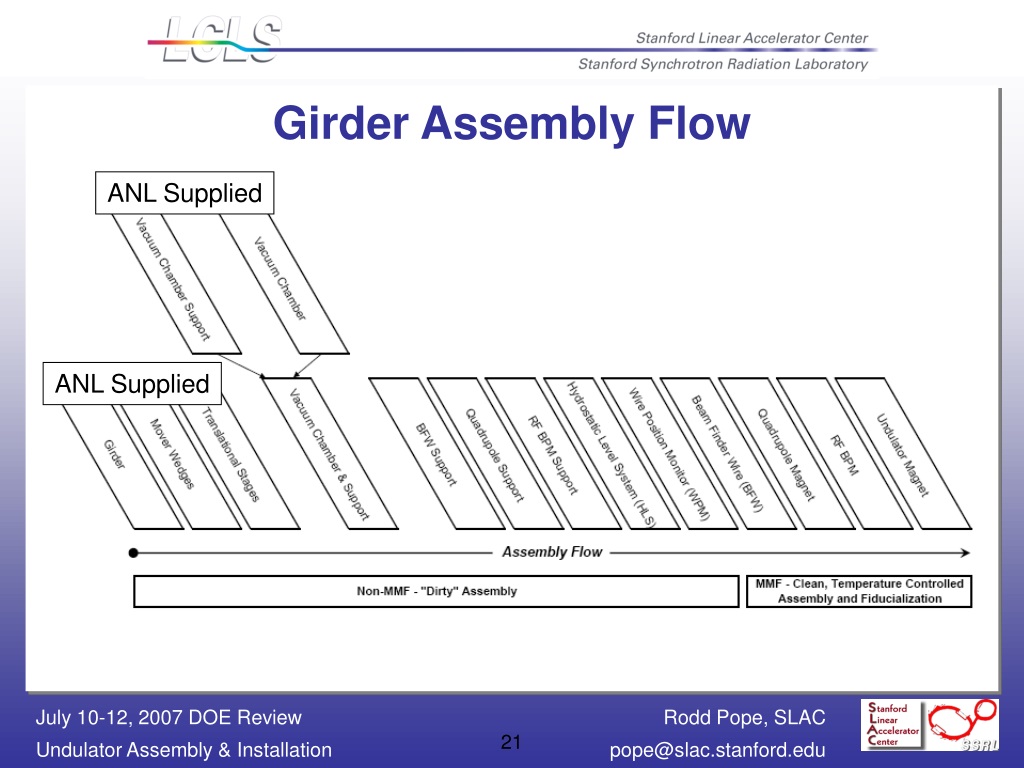

Girder Assembly Flow ANL Supplied ANL Supplied
