quasar
Uploaded by
24 SLIDES
422 VIEWS
250LIKES

Project Manager’s report

DESCRIPTION

Project Manager’s report. Status/progress since CM18 Looking forward Organisation Conclusions. Status (progress since CM18): . CM18. Status (progress since CM18):. CM19: Status reports on Phase I equipment and progress towards Phase II. Accomplishments: head lines:. Target:

1 / 24

Download Presentation

Project Manager’s report

An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript


  1. Project Manager’s report • Status/progress since CM18 • Looking forward • Organisation • Conclusions

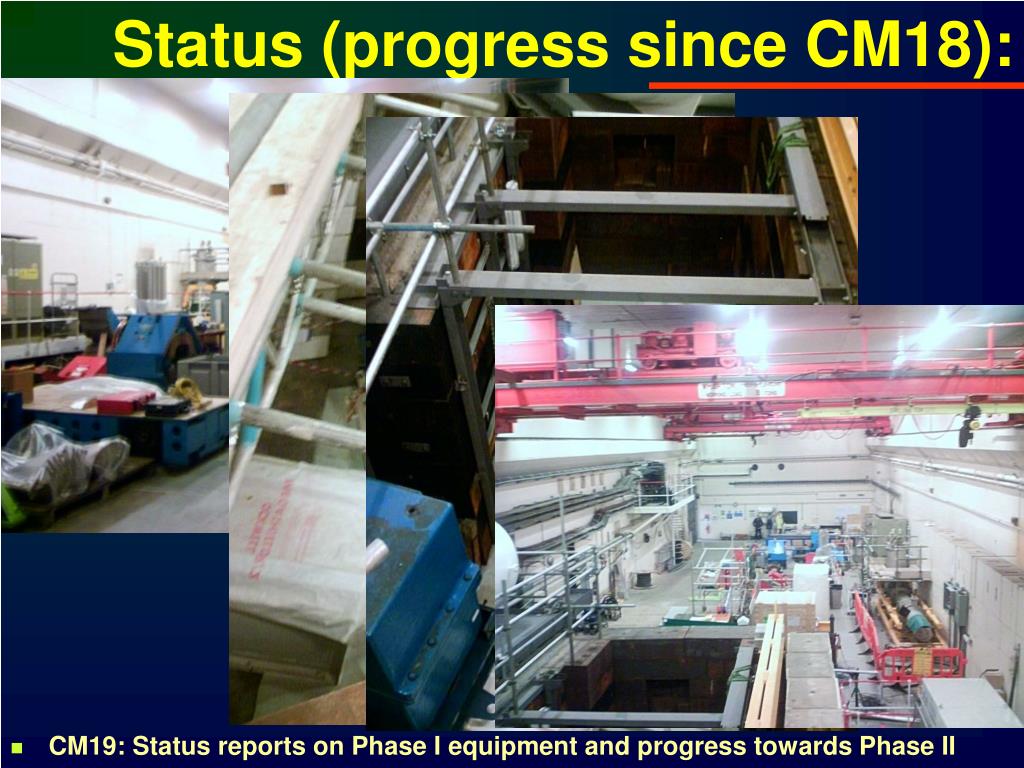

  2. Status (progress since CM18): CM18

  3. Status (progress since CM18): • CM19: Status reports on Phase I equipment and progress towards Phase II

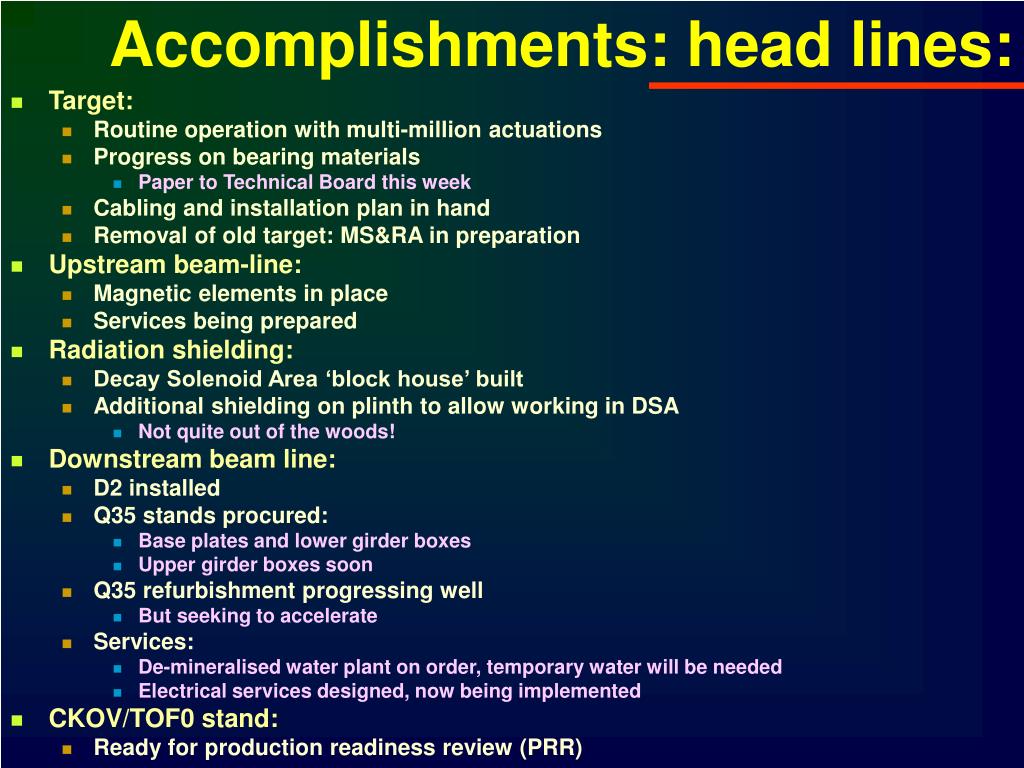

  4. Accomplishments: head lines: • Target: • Routine operation with multi-million actuations • Progress on bearing materials • Paper to Technical Board this week • Cabling and installation plan in hand • Removal of old target: MS&RA in preparation • Upstream beam-line: • Magnetic elements in place • Services being prepared • Radiation shielding: • Decay Solenoid Area ‘block house’ built • Additional shielding on plinth to allow working in DSA • Not quite out of the woods! • Downstream beam line: • D2 installed • Q35 stands procured: • Base plates and lower girder boxes • Upper girder boxes soon • Q35 refurbishment progressing well • But seeking to accelerate • Services: • De-mineralised water plant on order, temporary water will be needed • Electrical services designed, now being implemented • CKOV/TOF0 stand: • Ready for production readiness review (PRR)

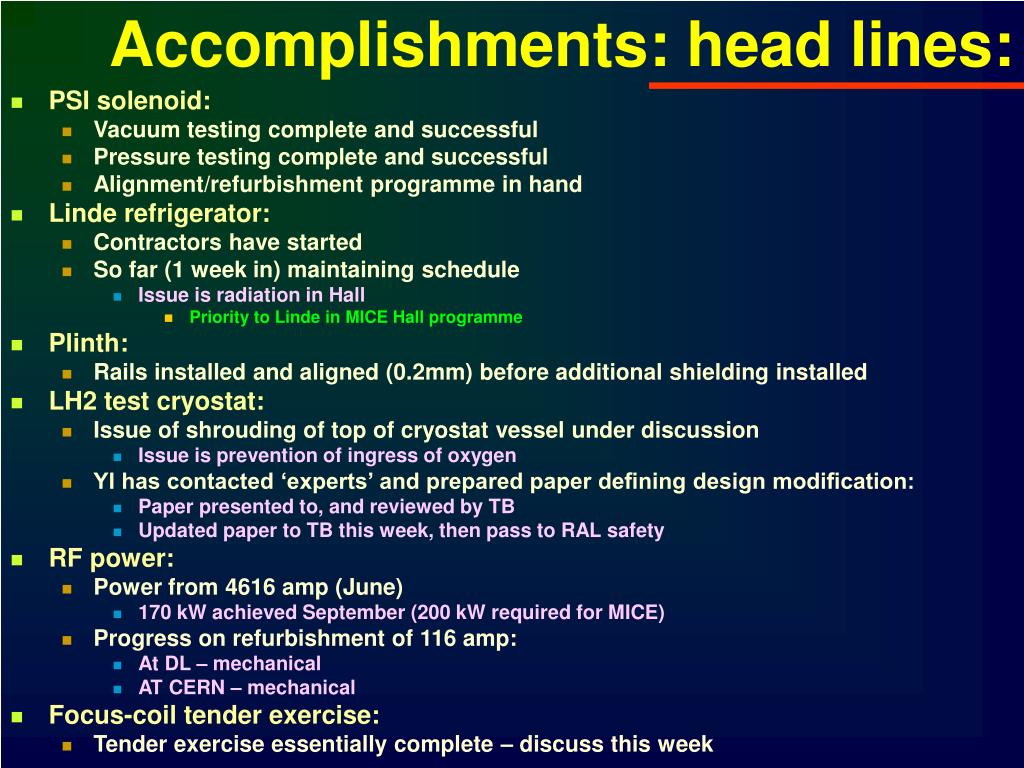

  5. Accomplishments: head lines: • PSI solenoid: • Vacuum testing complete and successful • Pressure testing complete and successful • Alignment/refurbishment programme in hand • Linde refrigerator: • Contractors have started • So far (1 week in) maintaining schedule • Issue is radiation in Hall • Priority to Linde in MICE Hall programme • Plinth: • Rails installed and aligned (0.2mm) before additional shielding installed • LH2 test cryostat: • Issue of shrouding of top of cryostat vessel under discussion • Issue is prevention of ingress of oxygen • YI has contacted ‘experts’ and prepared paper defining design modification: • Paper presented to, and reviewed by TB • Updated paper to TB this week, then pass to RAL safety • RF power: • Power from 4616 amp (June) • 170 kW achieved September (200 kW required for MICE) • Progress on refurbishment of 116 amp: • At DL – mechanical • AT CERN – mechanical • Focus-coil tender exercise: • Tender exercise essentially complete – discuss this week

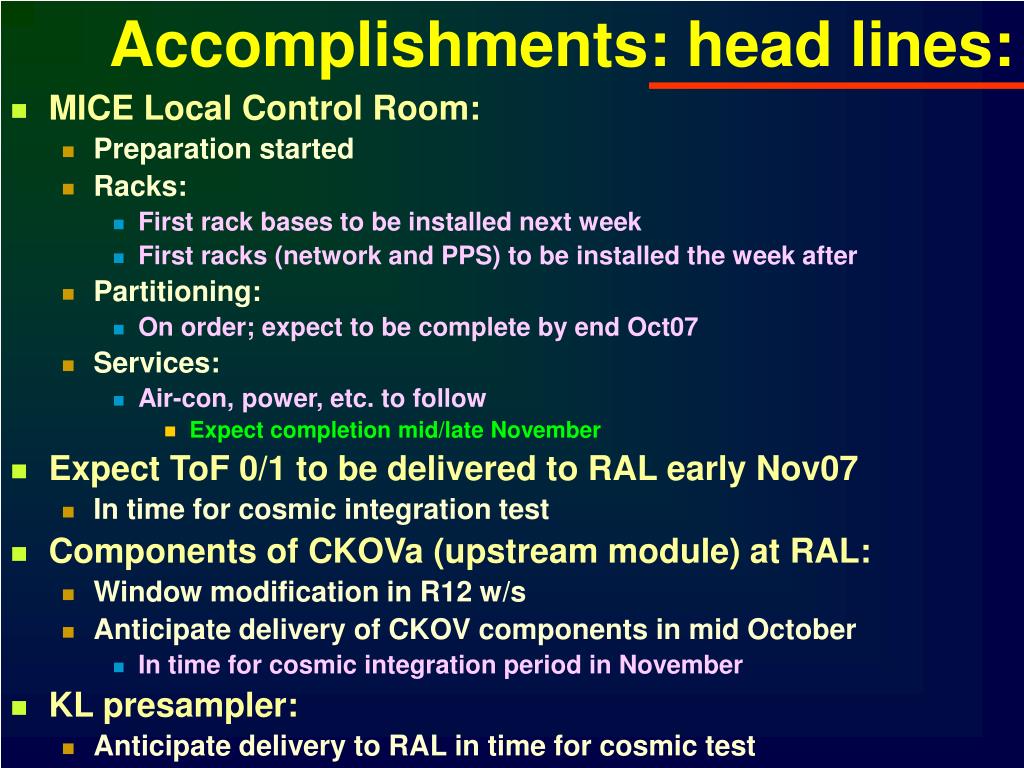

  6. Accomplishments: head lines: • MICE Local Control Room: • Preparation started • Racks: • First rack bases to be installed next week • First racks (network and PPS) to be installed the week after • Partitioning: • On order; expect to be complete by end Oct07 • Services: • Air-con, power, etc. to follow • Expect completion mid/late November • Expect ToF 0/1 to be delivered to RAL early Nov07 • In time for cosmic integration test • Components of CKOVa (upstream module) at RAL: • Window modification in R12 w/s • Anticipate delivery of CKOV components in mid October • In time for cosmic integration period in November • KL presampler: • Anticipate delivery to RAL in time for cosmic test

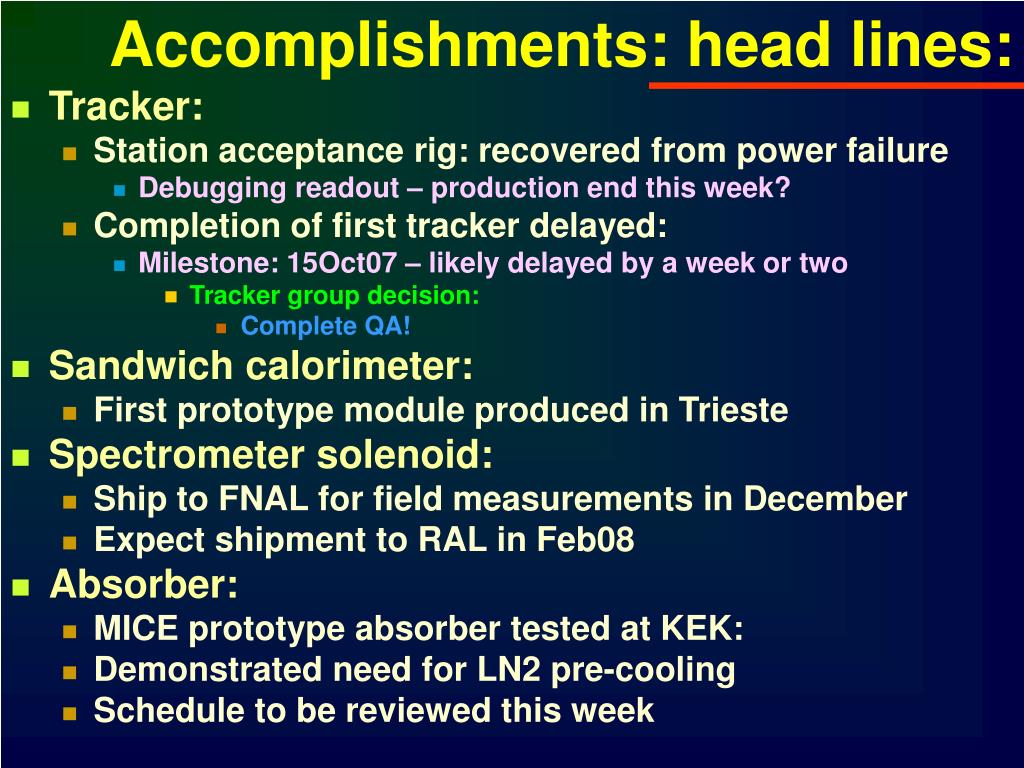

  7. Accomplishments: head lines: • Tracker: • Station acceptance rig: recovered from power failure • Debugging readout – production end this week? • Completion of first tracker delayed: • Milestone: 15Oct07 – likely delayed by a week or two • Tracker group decision: • Complete QA! • Sandwich calorimeter: • First prototype module produced in Trieste • Spectrometer solenoid: • Ship to FNAL for field measurements in December • Expect shipment to RAL in Feb08 • Absorber: • MICE prototype absorber tested at KEK: • Demonstrated need for LN2 pre-cooling • Schedule to be reviewed this week

  8. MICE instrumentation: • Detector integration using cosmic rays: • Cosmic test-stand to be set up in R12 • Schedule: • Tracker: • Tracker arrives in R12: 30Oct06 • VLPC system commissioned in R12: 02Nov07 • Trigger system commissioned in R12: 09Nov07 • DAQ: • Update DAQ system in R12: 09Nov07 • CKOV: • Commission CKOV in R12: 30Oct07 • To be confirmed with CKOV team • TOF: • Delivered to R12: 15Nov07 • Integrated into cosmic test 22Nov07 • Cosmic test starts: 09Nov07

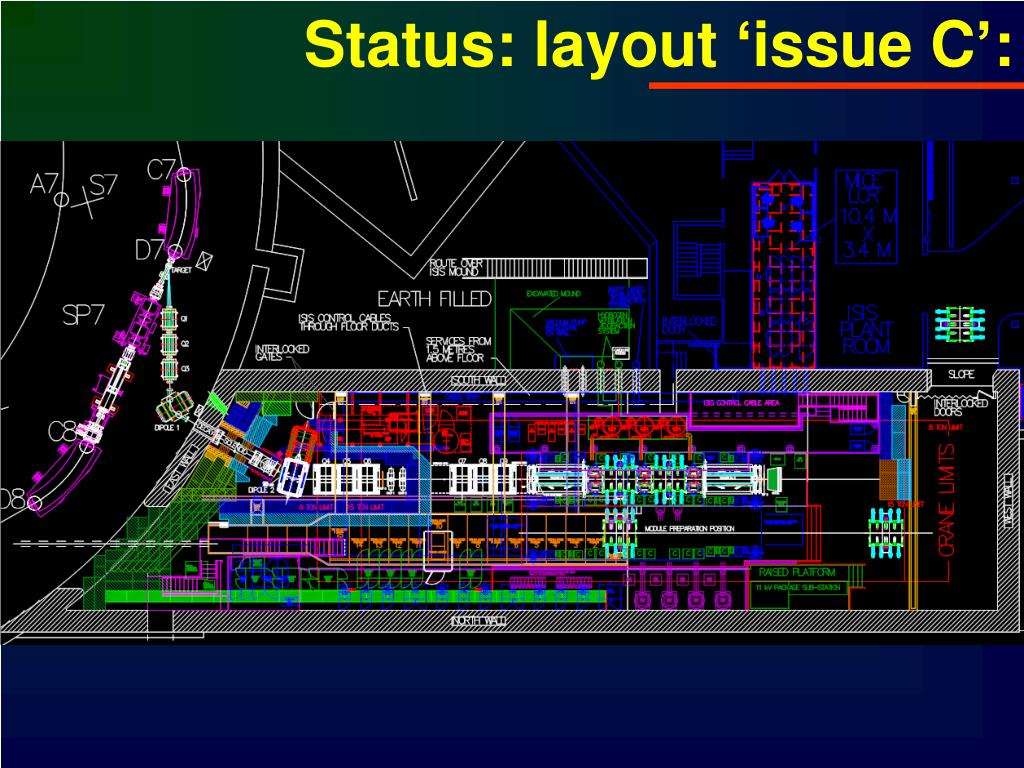

  9. Status: layout ‘issue C’:

  10. Looking forward: • Excellent progress, but, much to do • Need to plan and prepare carefully!

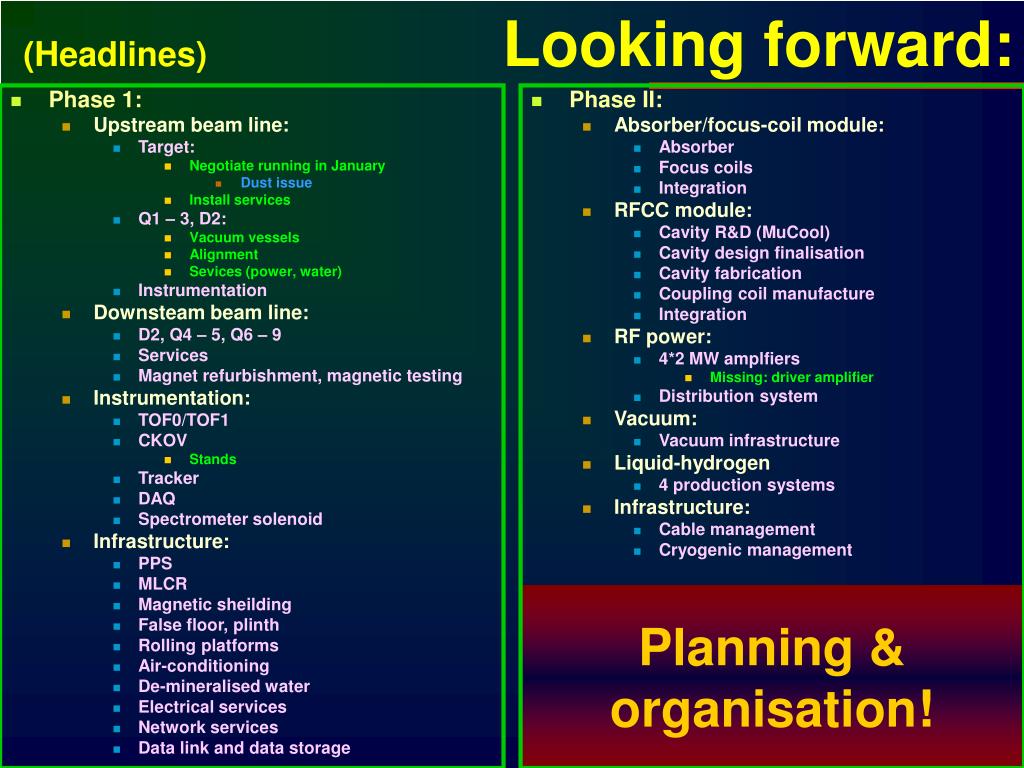

  11. (Headlines) Looking forward: Phase 1: Upstream beam line: Target: Negotiate running in January Dust issue Install services Q1 – 3, D2: Vacuum vessels Alignment Sevices (power, water) Instrumentation Downsteam beam line: D2, Q4 – 5, Q6 – 9 Services Magnet refurbishment, magnetic testing Instrumentation: TOF0/TOF1 CKOV Stands Tracker DAQ Spectrometer solenoid Infrastructure: PPS MLCR Magnetic sheilding False floor, plinth Rolling platforms Air-conditioning De-mineralised water Electrical services Network services Data link and data storage Phase II: Absorber/focus-coil module: Absorber Focus coils Integration RFCC module: Cavity R&D (MuCool) Cavity design finalisation Cavity fabrication Coupling coil manufacture Integration RF power: 4*2 MW amplfiers Missing: driver amplifier Distribution system Vacuum: Vacuum infrastructure Liquid-hydrogen 4 production systems Infrastructure: Cable management Cryogenic management Planning & organisation!

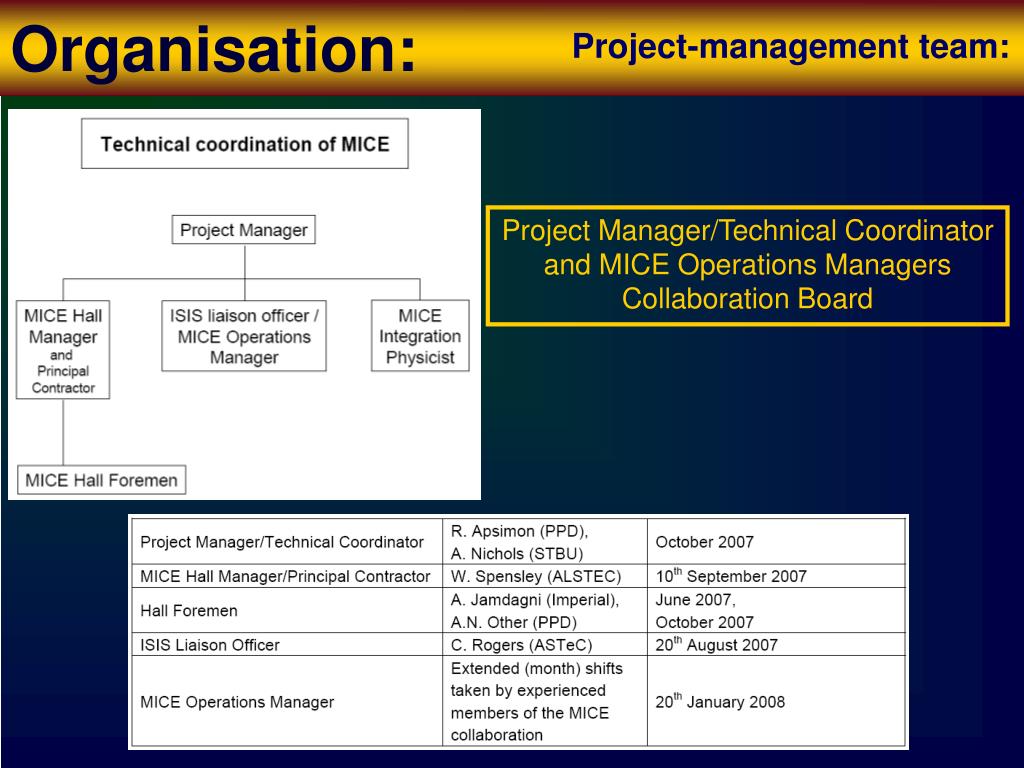

  12. Organisation: Project-management team: Project Manager/Technical Coordinatorand MICE Operations ManagersCollaboration Board

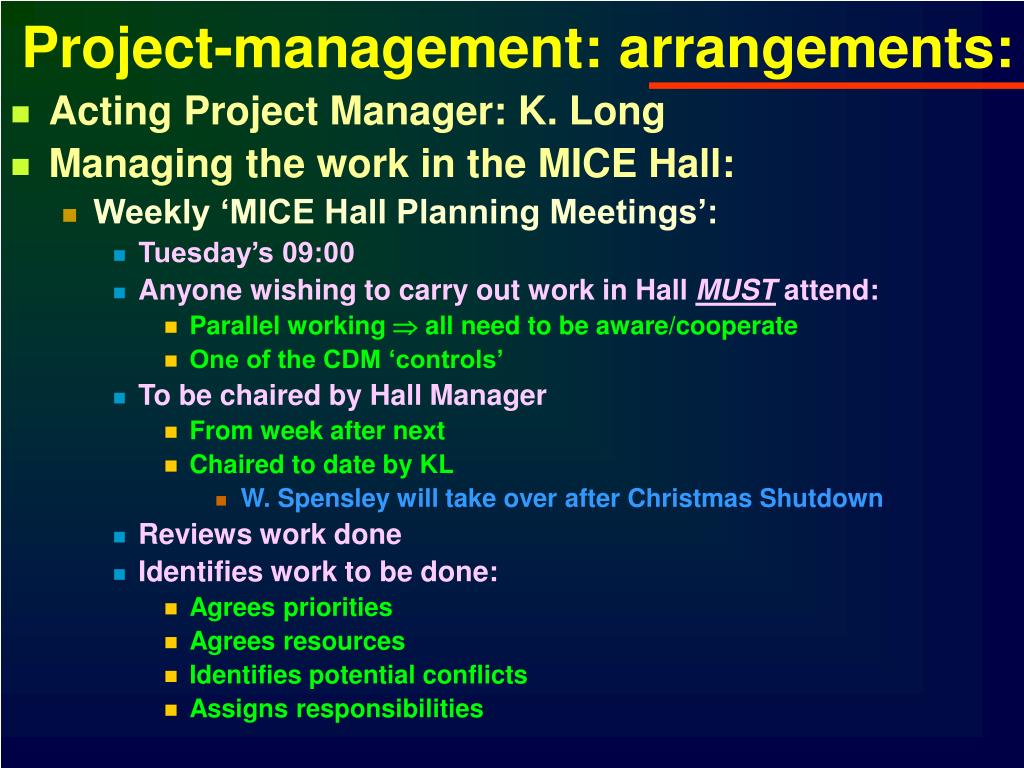

  13. Project-management: arrangements: • Acting Project Manager: K. Long • Managing the work in the MICE Hall: • Weekly ‘MICE Hall Planning Meetings’: • Tuesday’s 09:00 • Anyone wishing to carry out work in Hall MUST attend: • Parallel working  all need to be aware/cooperate • One of the CDM ‘controls’ • To be chaired by Hall Manager • From week after next • Chaired to date by KL • W. Spensley will take over after Christmas Shutdown • Reviews work done • Identifies work to be done: • Agrees priorities • Agrees resources • Identifies potential conflicts • Assigns responsibilities

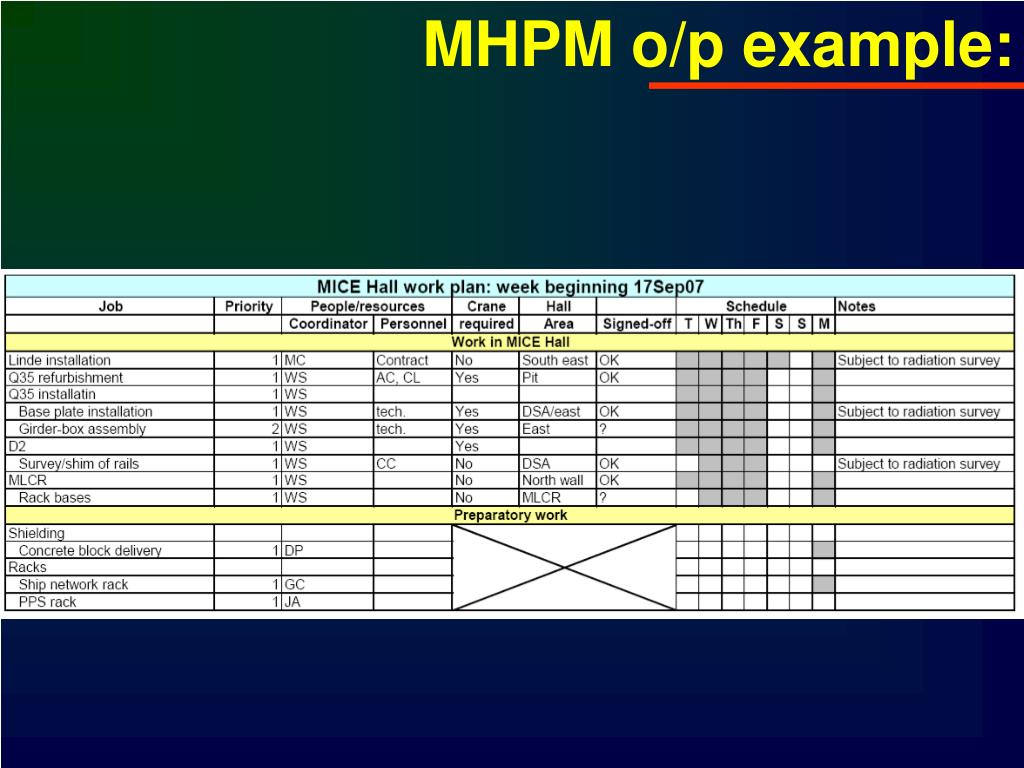

  14. MHPM o/p example:

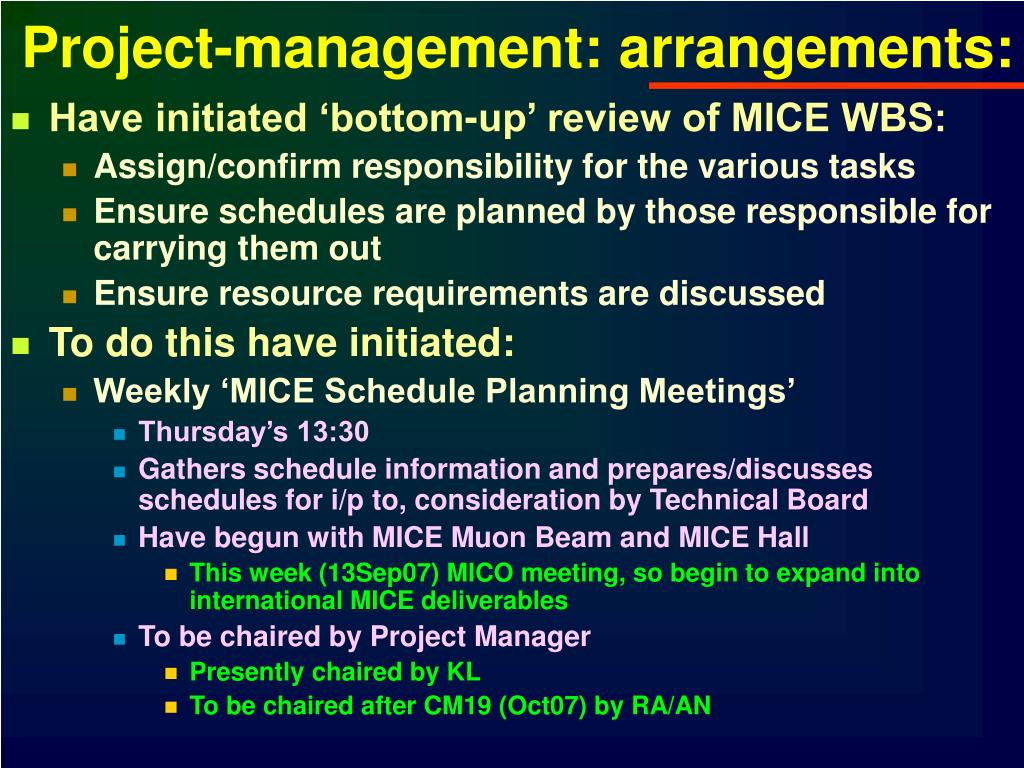

  15. Project-management: arrangements: • Have initiated ‘bottom-up’ review of MICE WBS: • Assign/confirm responsibility for the various tasks • Ensure schedules are planned by those responsible for carrying them out • Ensure resource requirements are discussed • To do this have initiated: • Weekly ‘MICE Schedule Planning Meetings’ • Thursday’s 13:30 • Gathers schedule information and prepares/discusses schedules for i/p to, consideration by Technical Board • Have begun with MICE Muon Beam and MICE Hall • This week (13Sep07) MICO meeting, so begin to expand into international MICE deliverables • To be chaired by Project Manager • Presently chaired by KL • To be chaired after CM19 (Oct07) by RA/AN

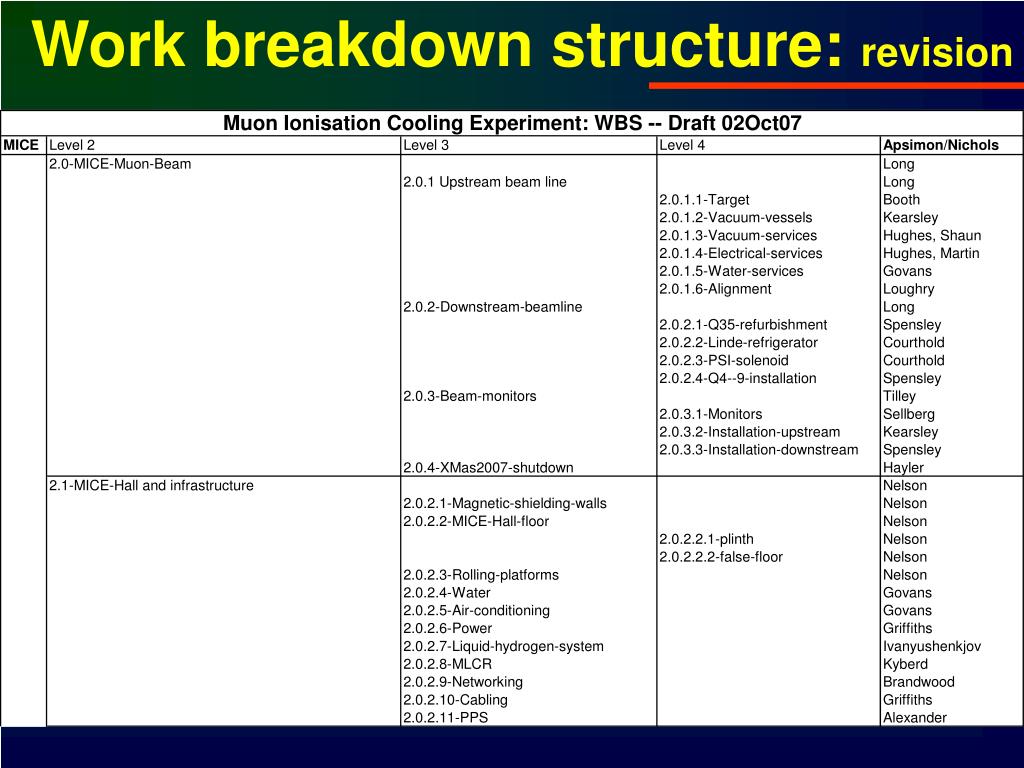

  16. Work breakdown structure: revision

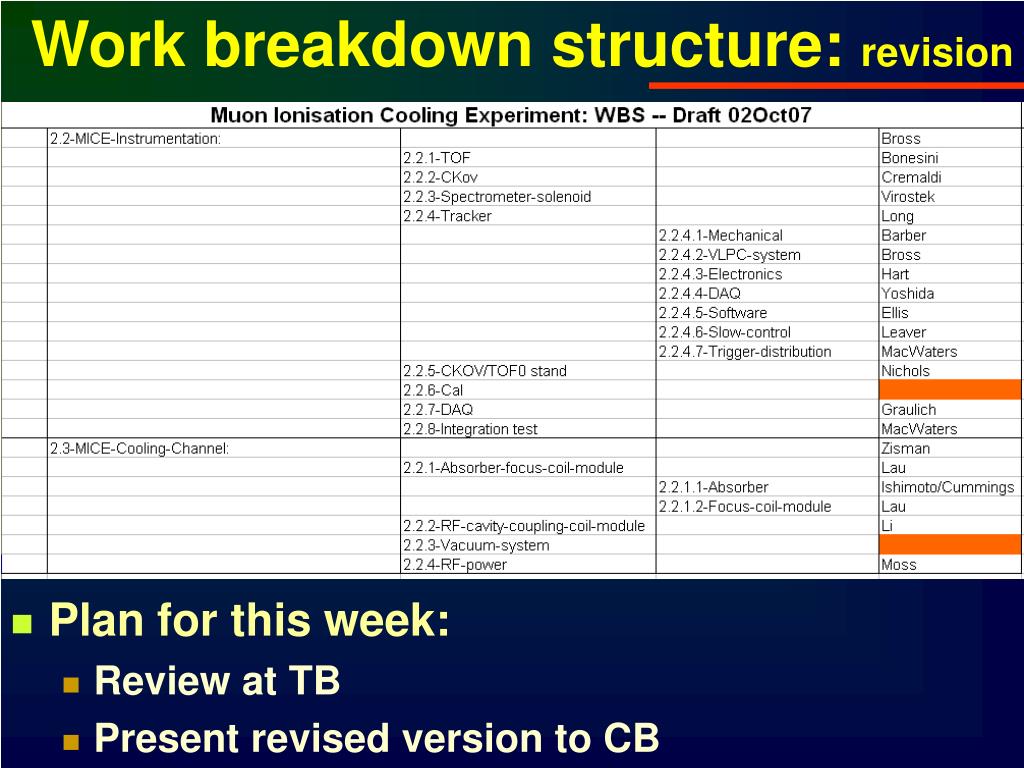

  17. Work breakdown structure: revision • Plan for this week: • Review at TB • Present revised version to CB

  18. Critical path & risk: Phase I: … getting it done Phase II: WORK SMART

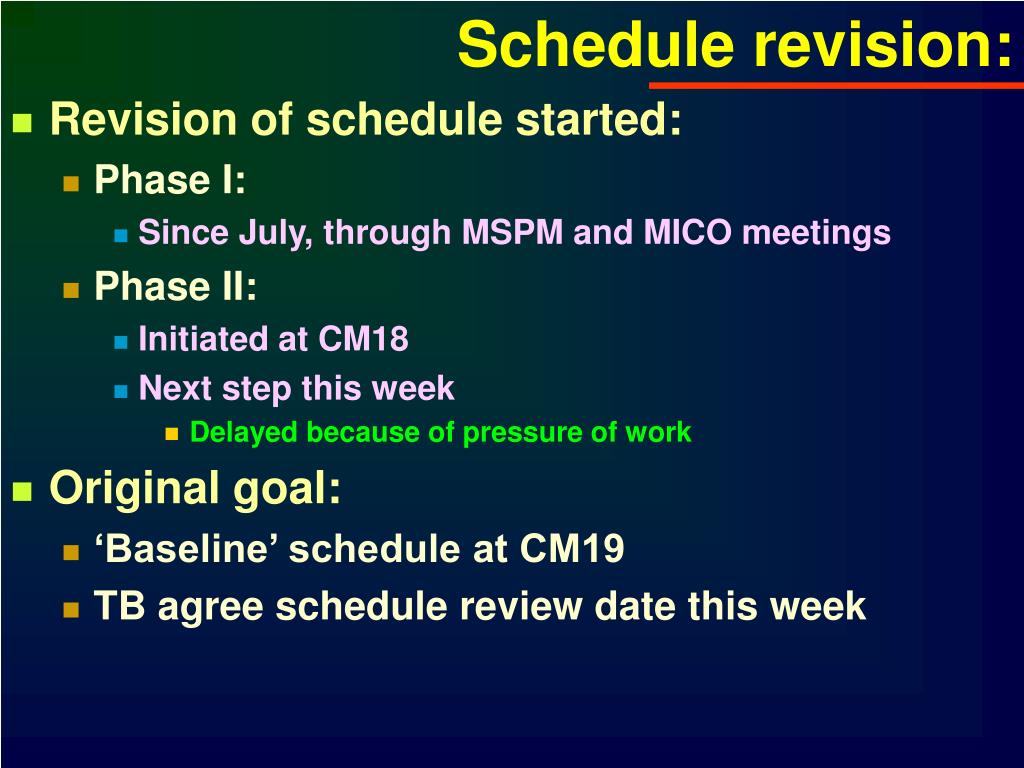

  19. Schedule revision: • Revision of schedule started: • Phase I: • Since July, through MSPM and MICO meetings • Phase II: • Initiated at CM18 • Next step this week • Delayed because of pressure of work • Original goal: • ‘Baseline’ schedule at CM19 • TB agree schedule review date this week

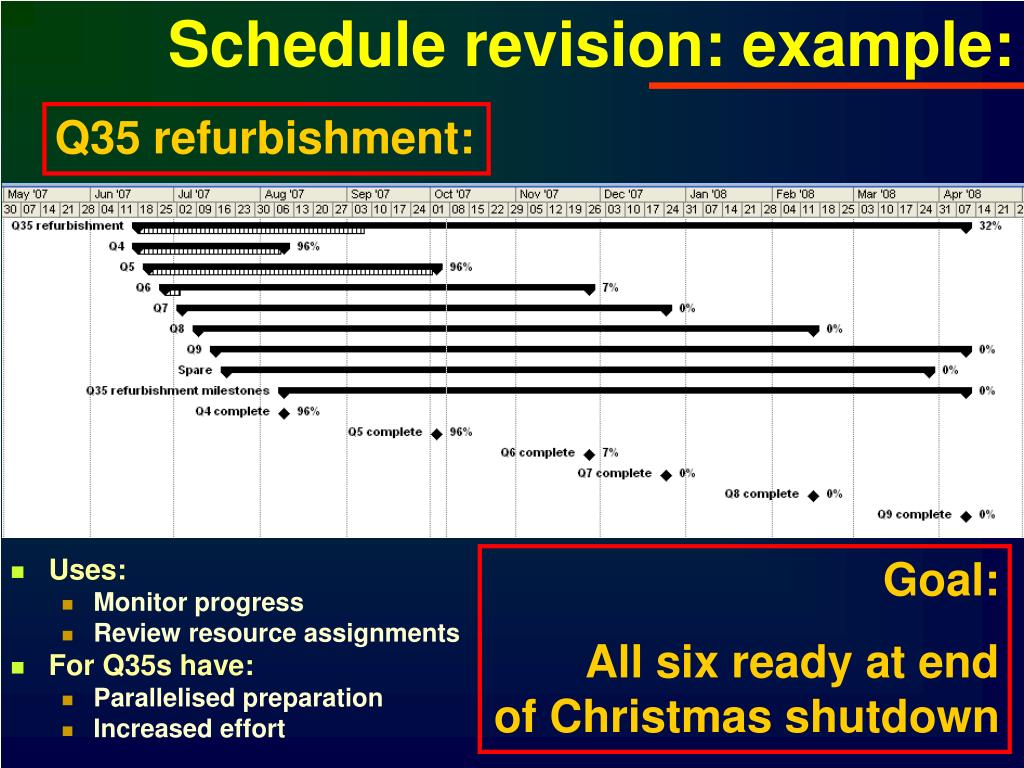

  20. Schedule revision: example: • Uses: • Monitor progress • Review resource assignments • For Q35s have: • Parallelised preparation • Increased effort Q35 refurbishment: Goal: All six ready at endof Christmas shutdown

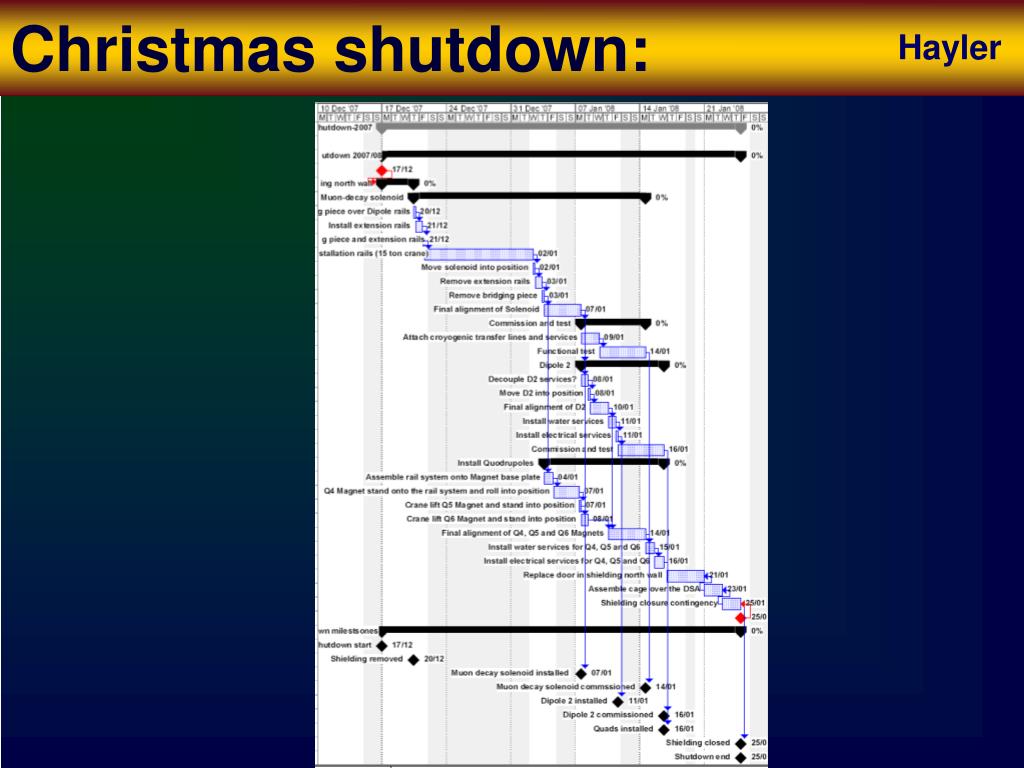

  21. Christmas shutdown: Hayler

  22. Technical Board: • After TB discussion → CB Review membership: TB meeting Review modus operandi: TB meeting

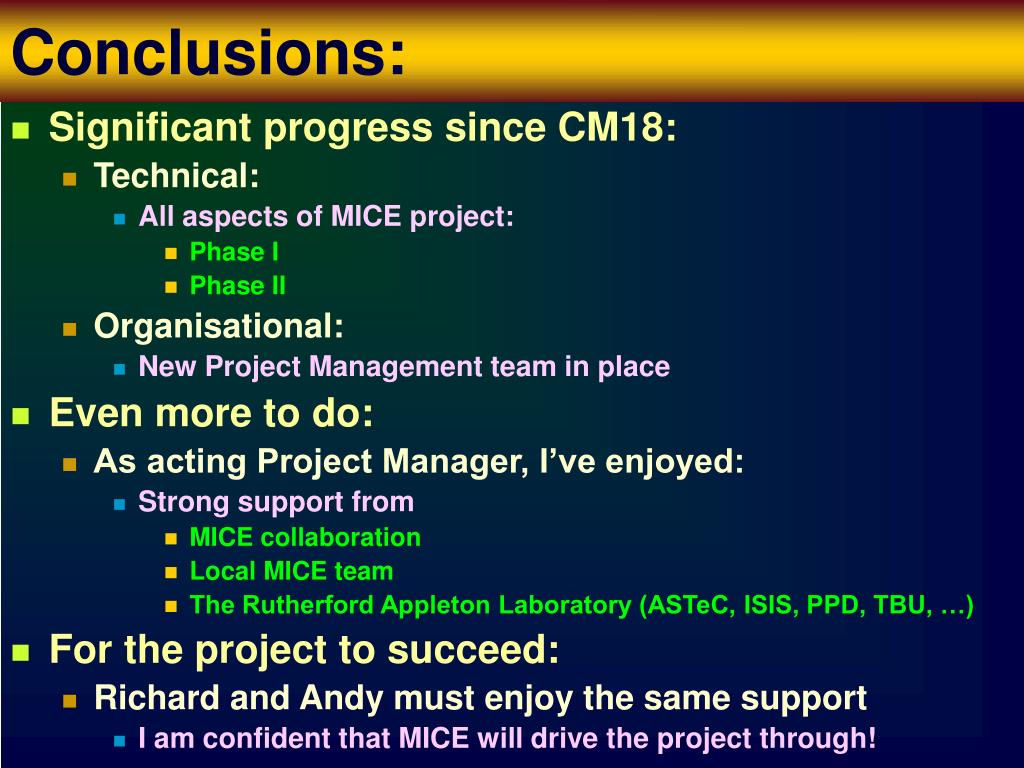

  23. Conclusions: • Significant progress since CM18: • Technical: • All aspects of MICE project: • Phase I • Phase II • Organisational: • New Project Management team in place • Even more to do: • As acting Project Manager, I’ve enjoyed: • Strong support from • MICE collaboration • Local MICE team • The Rutherford Appleton Laboratory (ASTeC, ISIS, PPD, TBU, …) • For the project to succeed: • Richard and Andy must enjoy the same support • I am confident that MICE will drive the project through!

More Related
