  1. Tender Requirements Expected Result ACE2010

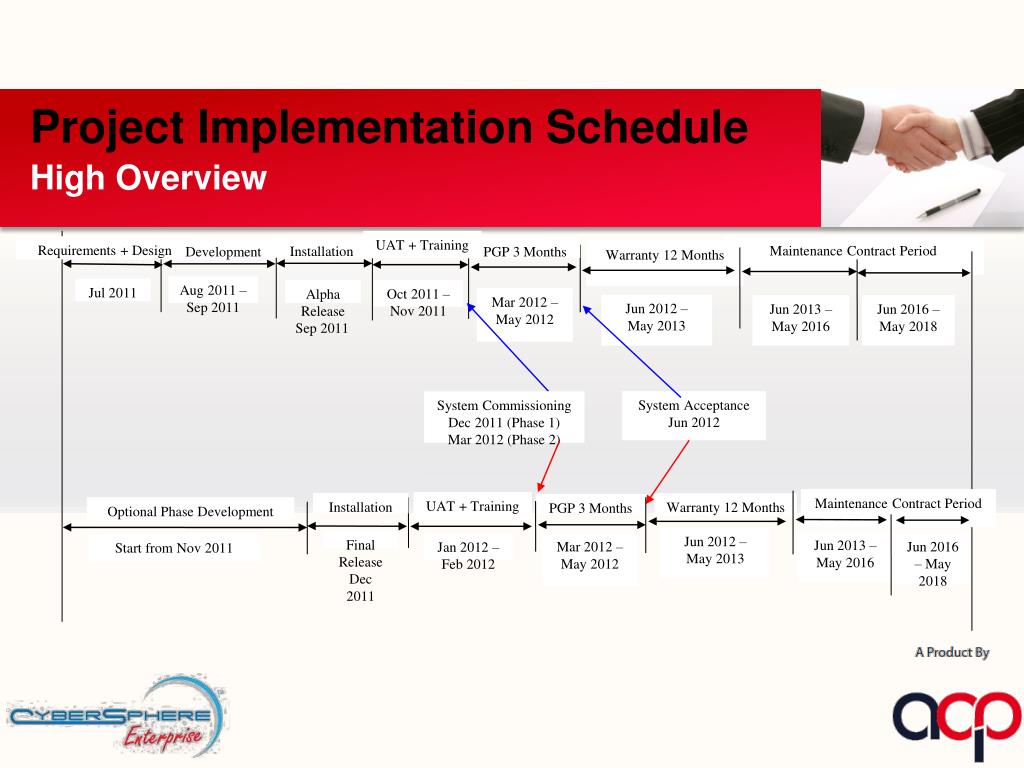

  2. Maintenance Contract Period Warranty 12 Months Jul 2011 Mar 2012 –May 2012 Jun 2012 – May 2013 Jun 2013 – May 2016 System Acceptance Jun 2012 System Commissioning Dec 2011 (Phase 1) Mar 2012 (Phase 2) Project Implementation Schedule Optional Phase Development Start from Nov 2011 High Overview UAT + Training Requirements + Design Installation PGP 3 Months Development Aug 2011 – Sep 2011 Oct 2011 – Nov 2011 Alpha Release Sep 2011 Jun 2016 – May 2018 Maintenance Contract Period UAT + Training Installation Warranty 12 Months PGP 3 Months Jun 2012 – May 2013 Final Release Dec 2011 Jun 2013 – May 2016 Jun 2016 – May 2018 Mar 2012 –May 2012 Jan 2012 – Feb 2012

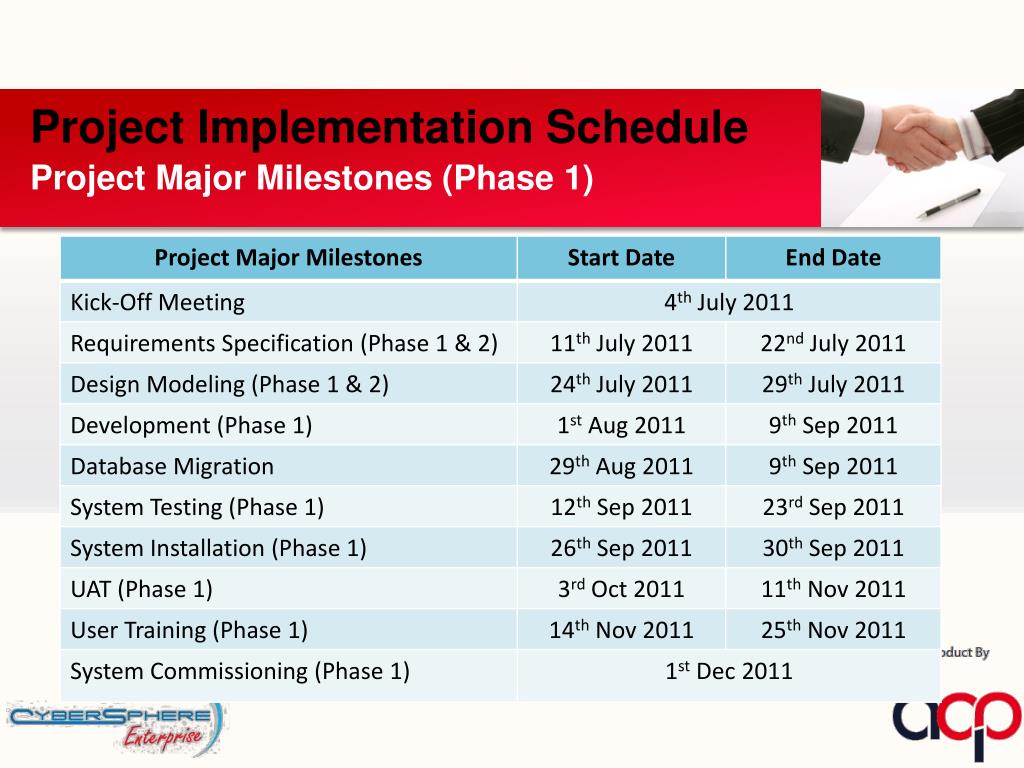

  3. Project Implementation Schedule Project Major Milestones (Phase 1)

  4. Project Implementation Schedule Project Major Milestones (Phase 2)

  5. Project Implementation Schedule Major Deliverables (Phase 1 &2)
