100 likes | 246 Views
New Mexico E-911 Network Project. New Mexico E-911 Program. Project Planning Certification. New Mexico E-911 Program DFA, Local Government Division Executive Sponsor – Rick Martinez Business Owner – Joyce Johnson Project Manager – Bill Range July 28, 2010. Project Overview. Nex Gen 911
E N D
New Mexico E-911 Network Project New Mexico E-911 Program
Project Planning Certification New Mexico E-911 Program DFA, Local Government Division Executive Sponsor – Rick Martinez Business Owner – Joyce Johnson Project Manager – Bill Range July 28, 2010

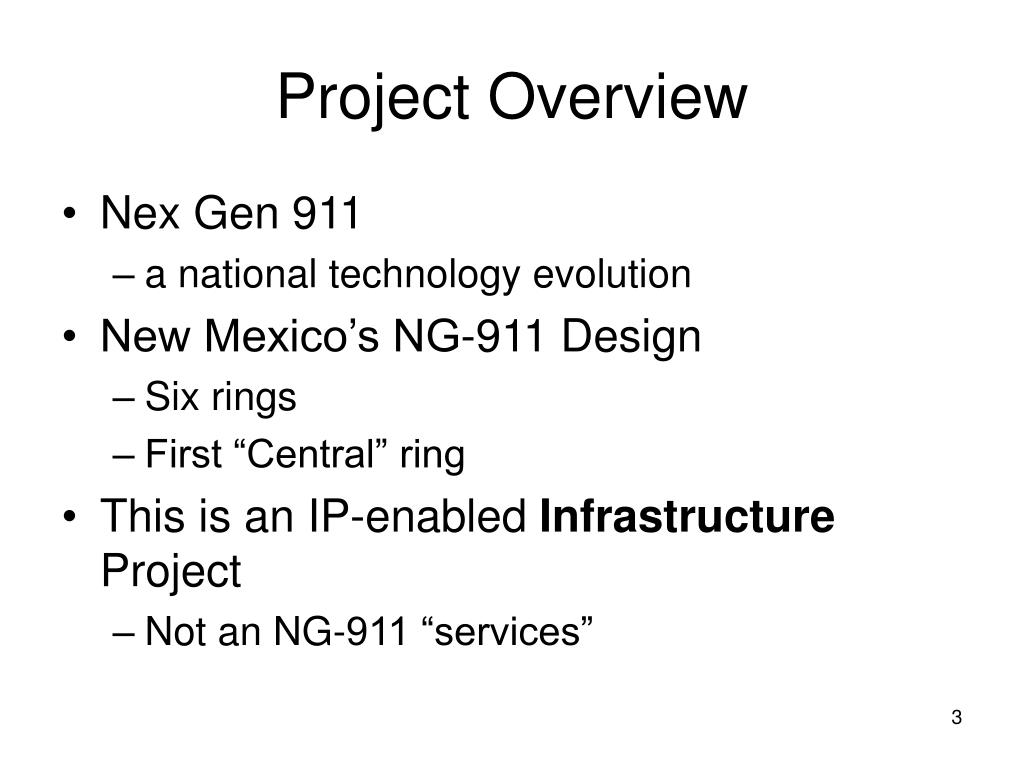

Project Overview • Nex Gen 911 • a national technology evolution • New Mexico’s NG-911 Design • Six rings • First “Central” ring • This is an IP-enabled Infrastructure Project • Not an NG-911 “services”

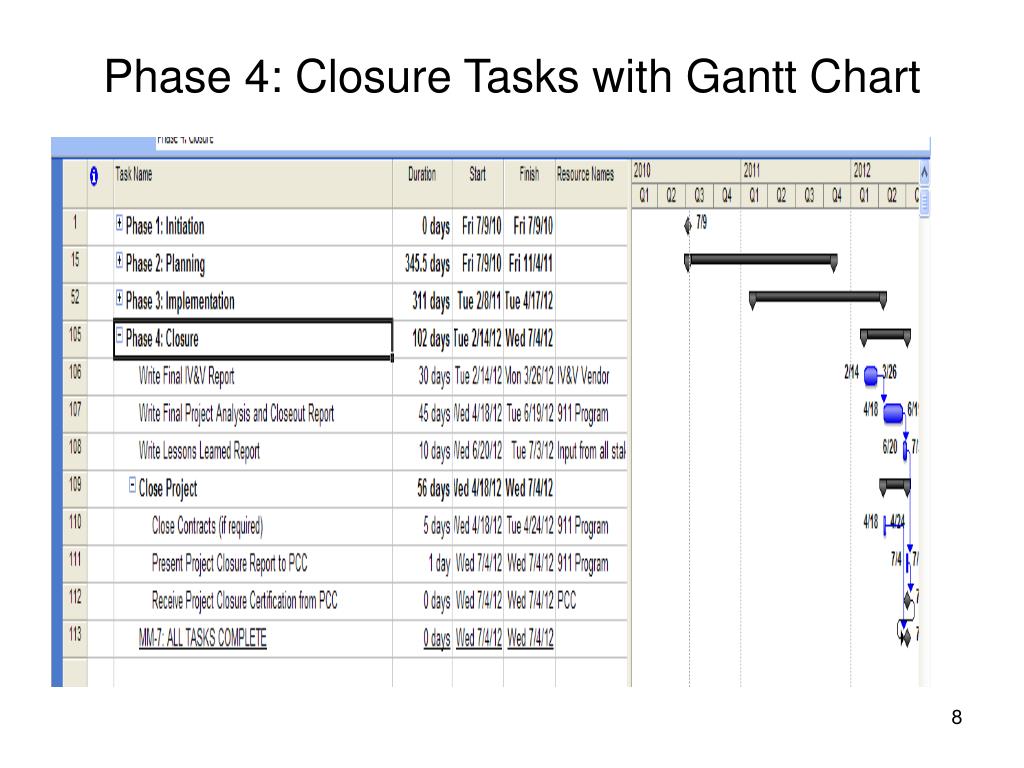

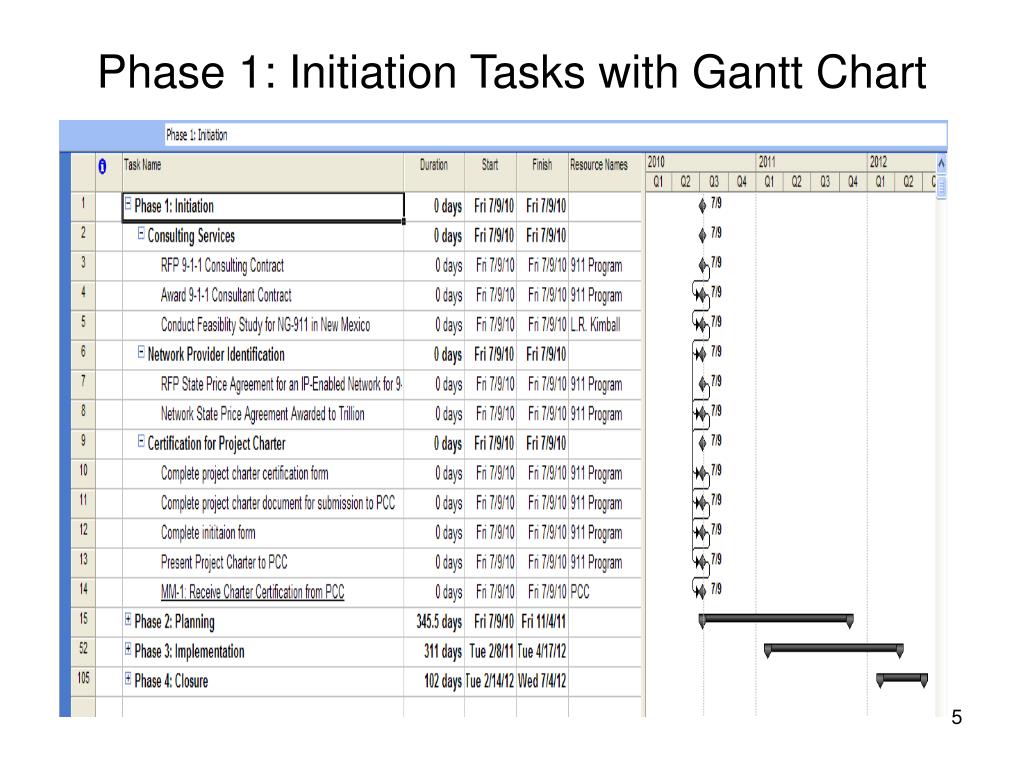

Project Status & Developments • Project Charter Certification April 1, 2010 • Planning Accomplishments • Initial Project Schedule completed July 2010 • Initial Project Management Plan completed July 2010 (32 page document) • Major Project Tasks Started • NG-SEC Assessments began July 2010
Next Steps….. • Planning Certification • $300K to cover anticipated expenditures • Regulatory Issues resolution • Consulting services • Conduct Security Assessments • Develop Initial Test Plans and Procedures • Develop Managed Services RFP draft • Managed Services • Identify Requirements • Procure services through RFP process • 911 switch and interfacing needs • Identify requirements • Evaluate contract options & potential vendors • IV&V Vendor • Requirements identification • Evaluate contract options & potential vendors
Conclusion • Planning Certification is requested
