1 / 9

New Mexico MVD Reengineering Project

New Mexico MVD Reengineering Project. Change Request August 24, 2011 Project Certification Committee. MVD Reengineering. Description Purchase COTS MVD Reengineering solution

carson
Download Presentation

New Mexico MVD Reengineering Project

An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript


  1. New Mexico MVD Reengineering Project Change Request August 24, 2011 Project Certification Committee

  2. MVD Reengineering • Description • Purchase COTS MVD Reengineering solution • Replace legacy MVD Driver and Vehicle and Distribution systems with new technology, improving efficiency, accuracy, and maintainability • Justification • Implement modern solution for system that is 30+ years old, resides on mainframe platform, and is increasingly hard to maintain

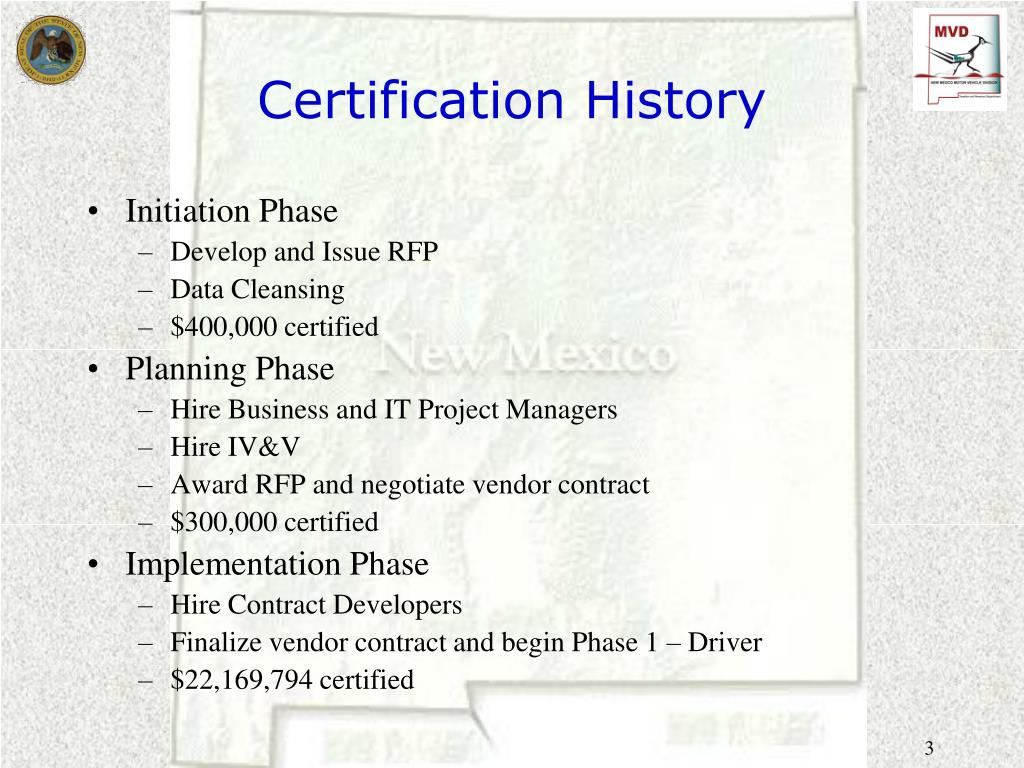

  3. Certification History Initiation Phase Develop and Issue RFP Data Cleansing $400,000 certified Planning Phase Hire Business and IT Project Managers Hire IV&V Award RFP and negotiate vendor contract $300,000 certified Implementation Phase Hire Contract Developers Finalize vendor contract and begin Phase 1 – Driver $22,169,794 certified

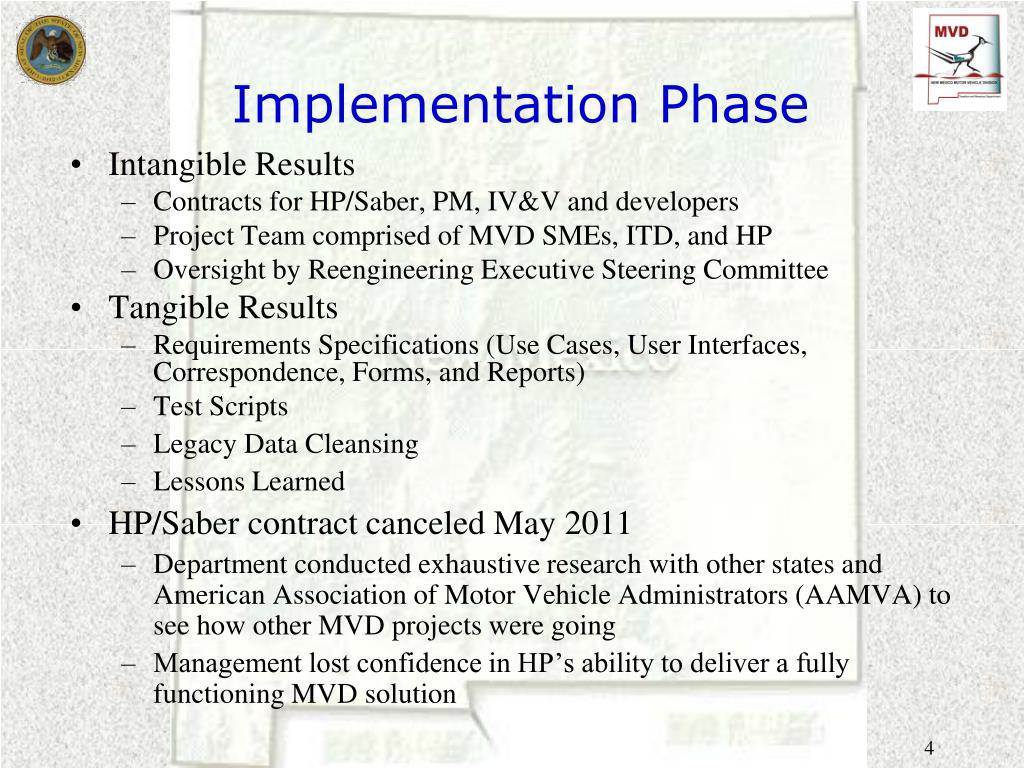

  4. Implementation Phase • Intangible Results • Contracts for HP/Saber, PM, IV&V and developers • Project Team comprised of MVD SMEs, ITD, and HP • Oversight by Reengineering Executive Steering Committee • Tangible Results • Requirements Specifications (Use Cases, User Interfaces, Correspondence, Forms, and Reports) • Test Scripts • Legacy Data Cleansing • Lessons Learned • HP/Saber contract canceled May 2011 • Department conducted exhaustive research with other states and American Association of Motor Vehicle Administrators (AAMVA) to see how other MVD projects were going • Management lost confidence in HP’s ability to deliver a fully functioning MVD solution

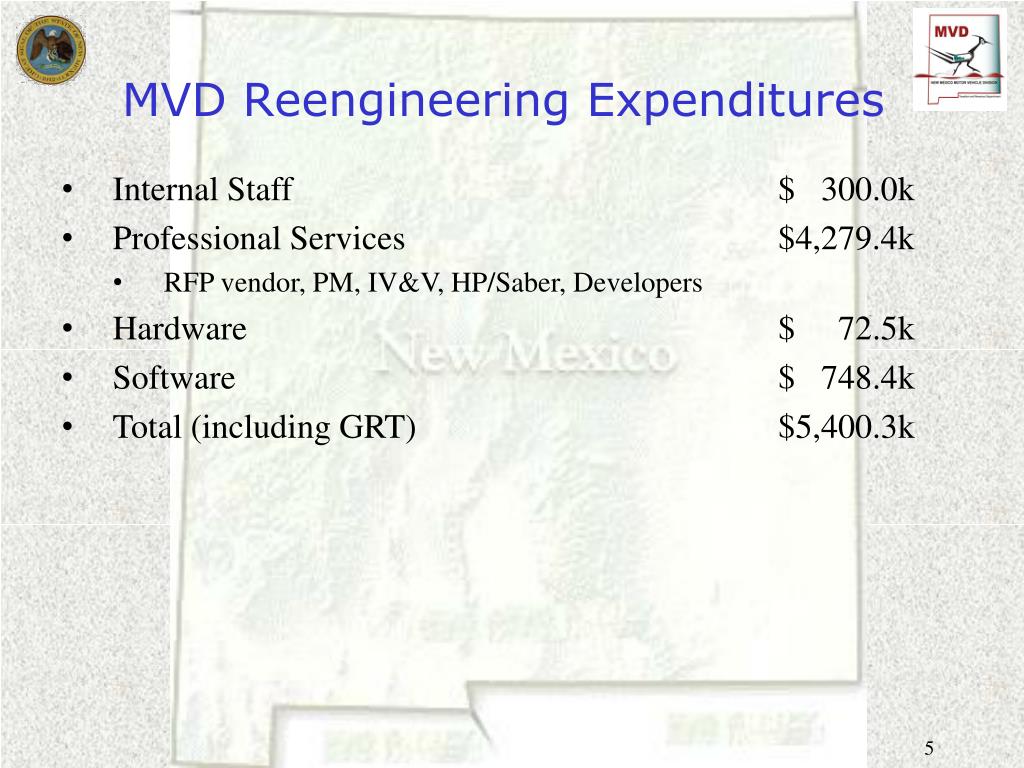

  5. MVD Reengineering Expenditures • Internal Staff $ 300.0k • Professional Services $4,279.4k • RFP vendor, PM, IV&V, HP/Saber, Developers • Hardware $ 72.5k • Software $ 748.4k • Total (including GRT) $5,400.3k

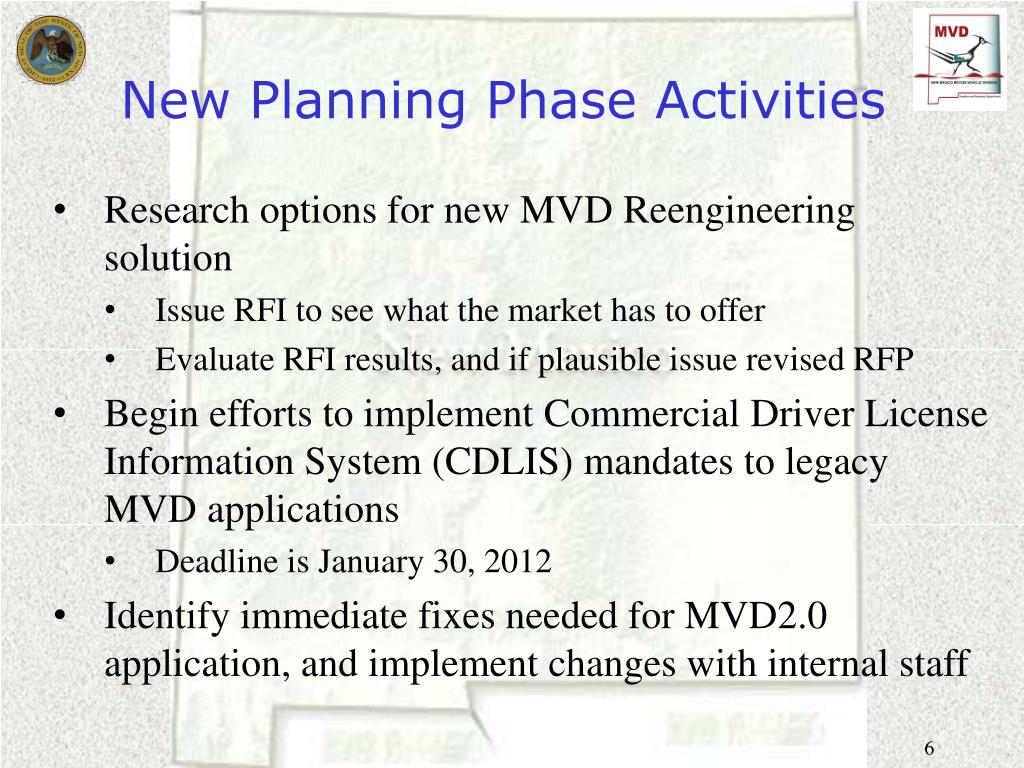

  6. New Planning Phase Activities • Research options for new MVD Reengineering solution • Issue RFI to see what the market has to offer • Evaluate RFI results, and if plausible issue revised RFP • Begin efforts to implement Commercial Driver License Information System (CDLIS) mandates to legacy MVD applications • Deadline is January 30, 2012 • Identify immediate fixes needed for MVD2.0 application, and implement changes with internal staff

  7. Appropriations • Part of DRIVE MVD – Complicated funding model • Developed detailed model of sources and uses • Driver Reengineering Special Appropriation • Federal Grants (CDL, DHS) • Non-recurring Fund Balances • MVD cash balances • Revenue (NMI Online Transactions, Cost Recovery) • Previously certified $22,869,794 • Transfer $1,473,430 to fund CDLIS Modernization project

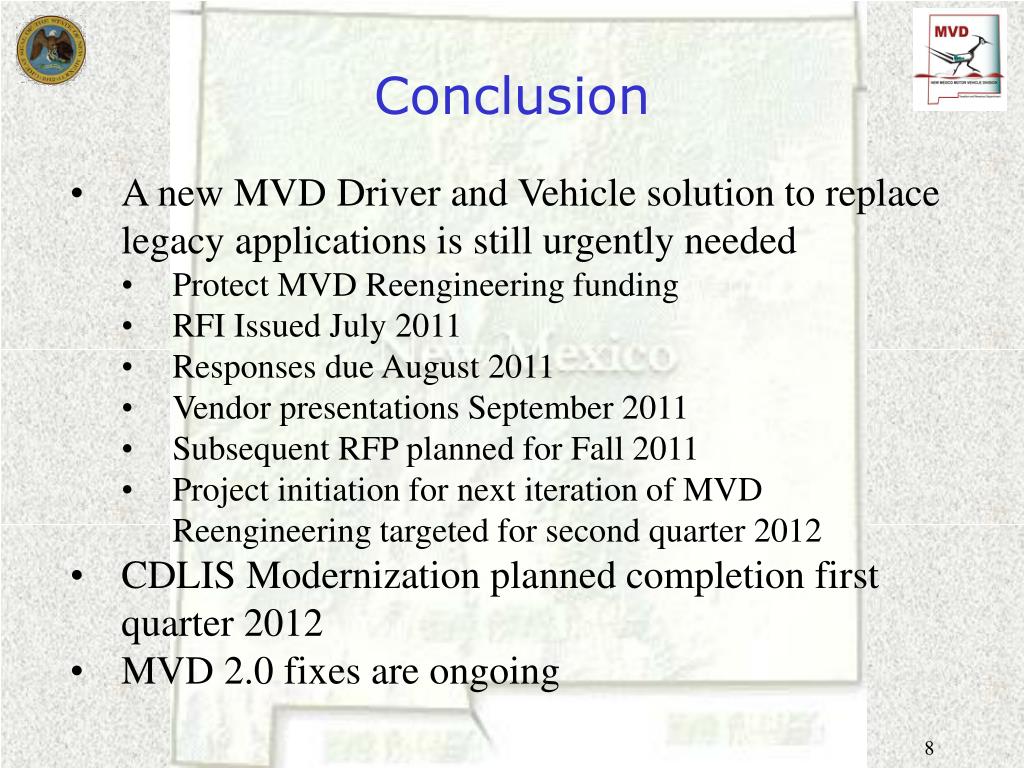

  8. Conclusion • A new MVD Driver and Vehicle solution to replace legacy applications is still urgently needed • Protect MVD Reengineering funding • RFI Issued July 2011 • Responses due August 2011 • Vendor presentations September 2011 • Subsequent RFP planned for Fall 2011 • Project initiation for next iteration of MVD Reengineering targeted for second quarter 2012 • CDLIS Modernization planned completion first quarter 2012 • MVD 2.0 fixes are ongoing 8

  9. MVD Reengineering Project Questions?
