WisDOT Mega & Major Project Update

WisDOT Mega & Major Project Update. 2013 WTBA/WisDOT Contractor – Engineer Conference Don Miller January 31, 2013. WisDOT Mega Project. Estimated cost of $500 million or more Projects currently under construction:

barr
Download Presentation

WisDOT Mega & Major Project Update

An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript


  1. WisDOT Mega & Major Project Update 2013 WTBA/WisDOT Contractor – Engineer Conference Don Miller January 31, 2013

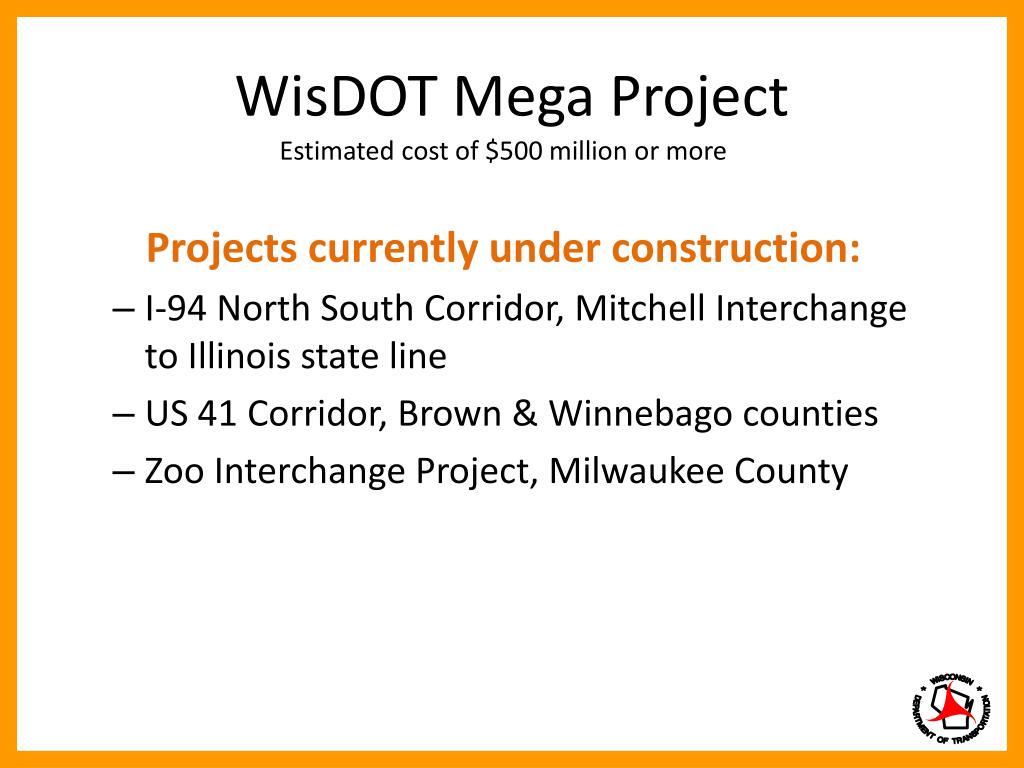

  2. WisDOT Mega Project Estimated cost of $500 million or more Projects currently under construction: • I-94 North South Corridor, Mitchell Interchange to Illinois state line • US 41 Corridor, Brown & Winnebago counties • Zoo Interchange Project, Milwaukee County

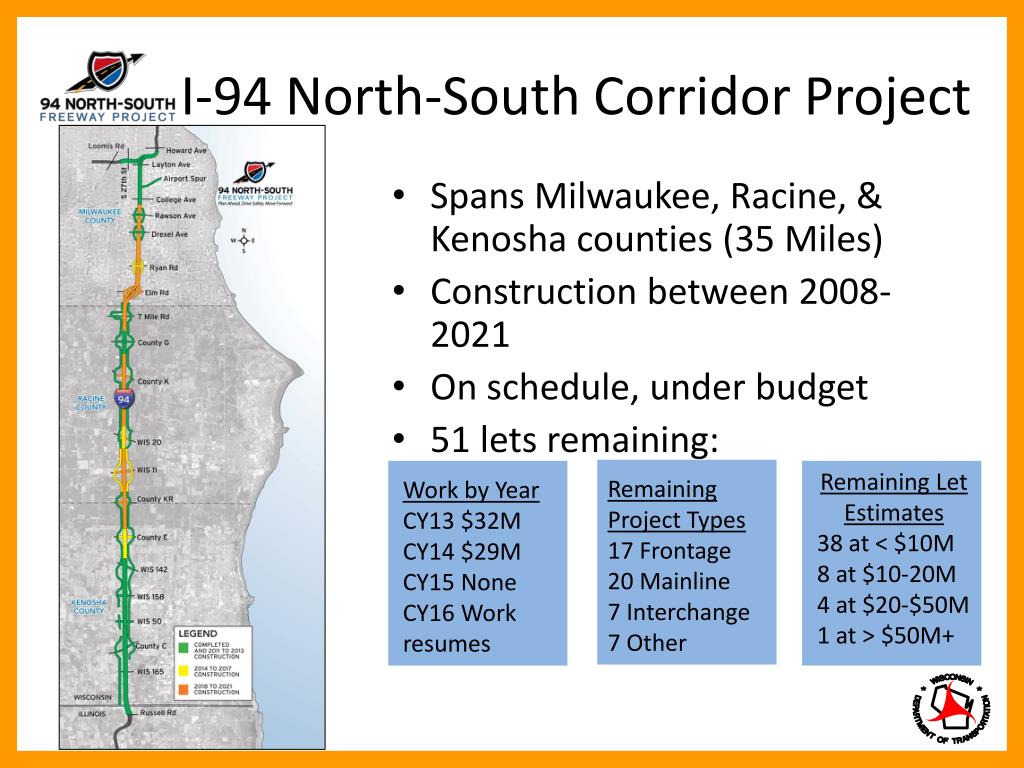

  3. I-94 North-South Corridor Project • Spans Milwaukee, Racine, & Kenosha counties (35 Miles) • Construction between 2008-2021 • On schedule, under budget • 51 lets remaining: Remaining Project Types 17 Frontage 20 Mainline 7 Interchange 7 Other Work by Year CY13 $32M CY14 $29M CY15 None CY16 Work resumes Remaining Let Estimates 38 at < $10M 8 at $10-20M 4 at $20-$50M 1 at > $50M+

  4. USH41 - Winnebago County • Work continues in 2013 on • Lake Butte des Morts Causeway • US 41 mainline from US 45 to Breezewood Lane • 2013 and beyond • 8 remaining contracts = $15M total • Planned completion - 2016

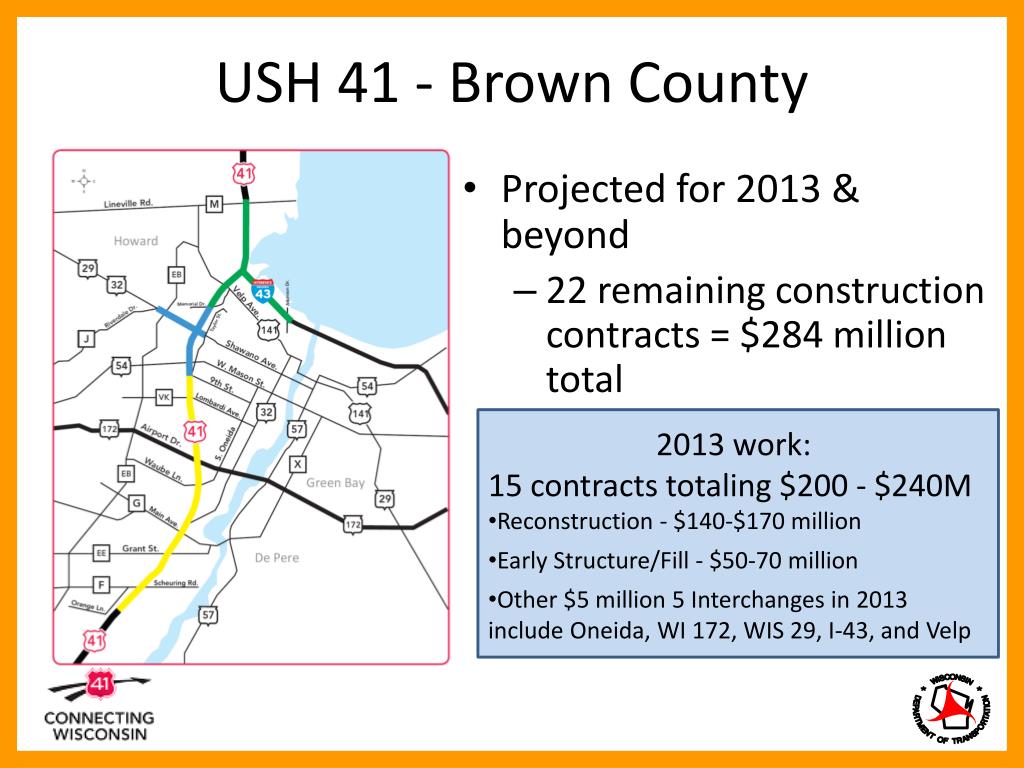

  5. USH 41 - Brown County • Projected for 2013 & beyond • 22 remaining construction contracts = $284 million total • 2013 work: • 15 contracts totaling $200 - $240M • Reconstruction - $140-$170 million • Early Structure/Fill - $50-70 million • Other $5 million 5 Interchanges in 2013 include Oneida, WI 172, WIS 29, I-43, and Velp

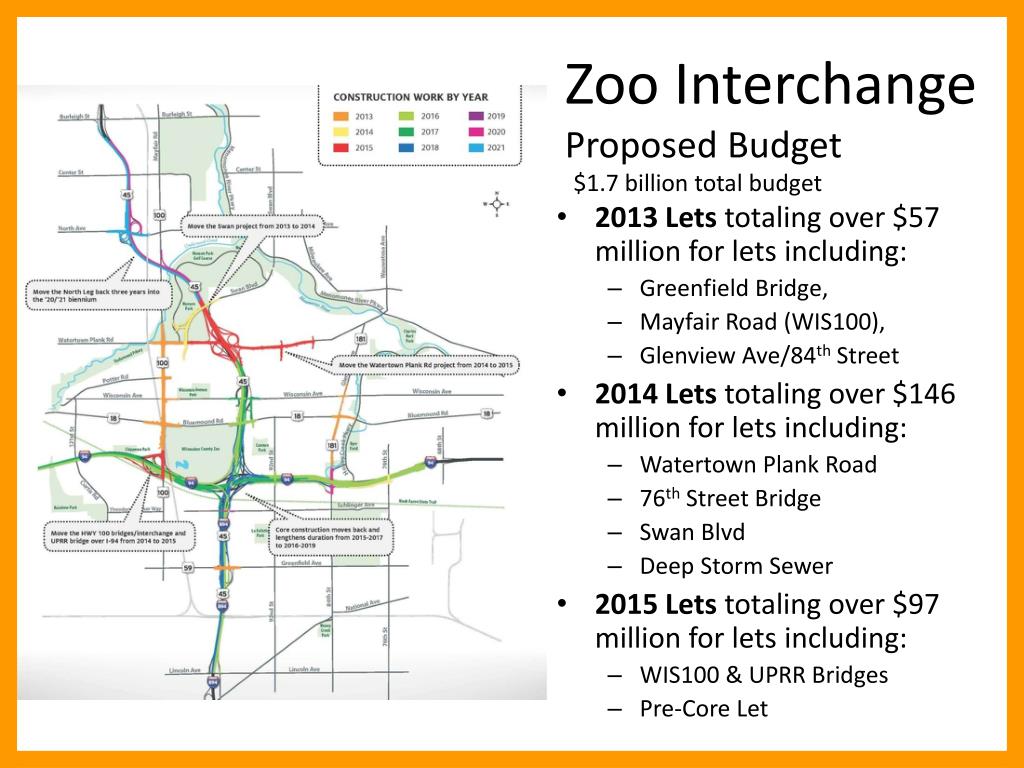

  6. Zoo InterchangeProposed Budget $1.7 billion total budget • 2013 Lets totaling over $57 million for lets including: • Greenfield Bridge, • Mayfair Road (WIS100), • Glenview Ave/84th Street • 2014 Lets totaling over $146 million for lets including: • Watertown Plank Road • 76th Street Bridge • Swan Blvd • Deep Storm Sewer • 2015 Lets totaling over $97 million for lets including: • WIS100 & UPRR Bridges • Pre-Core Let

  7. I-39/90 Expansion Project • Madison to Illinois state line, • Dane and Rock Counties (46 miles) • 2013 Lets - $15 million • 2014Lets - $56 million • 2015 Lets - $214 million $835.7 million total budget

  8. US 10/WIS 441 Tri-County Expansion • Cold Spring Road to Oneida Street • - 5-mile segment of Appleton Urban Area Beltline • Facility Reconstruction and 4 to 6 lanes expansion • $415 million current budget • Construction start planned in 2014 (16)* *Current 2011-13 Budget (Proposed 2013-15 Budget)

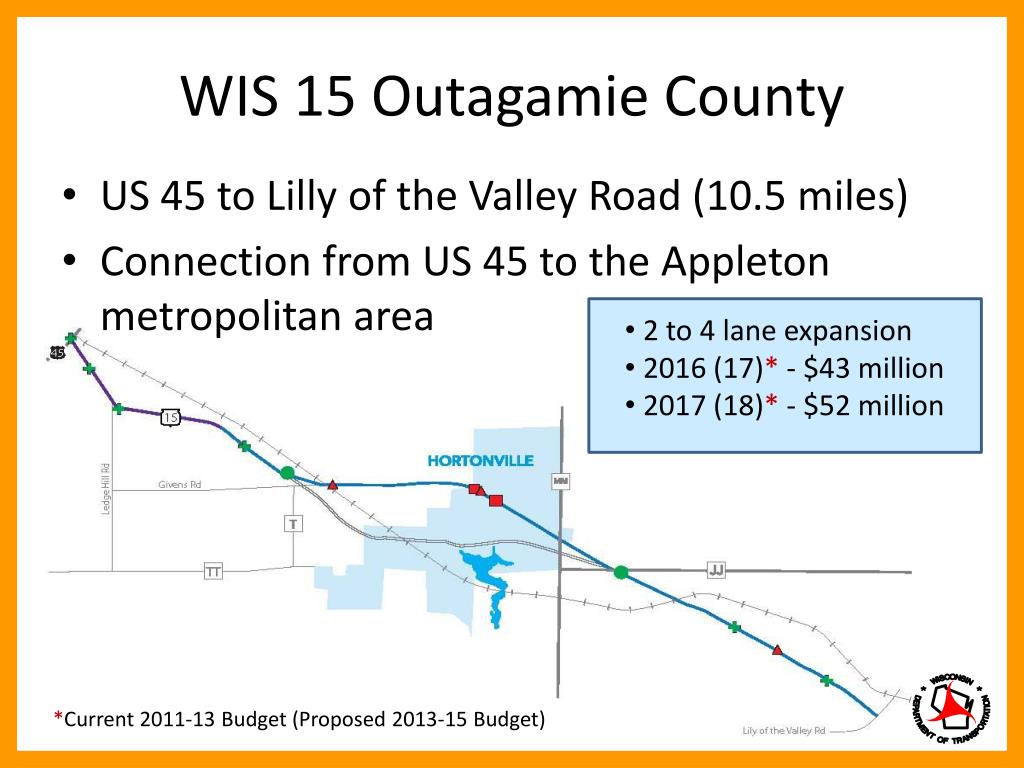

  9. WIS 15 Outagamie County • US 45 to Lilly of the Valley Road (10.5 miles) • Connection from US 45 to the Appleton metropolitan area • 2 to 4 lane expansion • 2016 (17)* - $43 million • 2017 (18)* - $52 million *Current 2011-13 Budget (Proposed 2013-15 Budget)

  10. WIS 38 (Howell Ave.) • Milwaukee & Racine Counties: Oakwood Rd. to CTH K (9.0 Miles) • Reconstruction: capacity expansion and realignment • Data gathering/investigation resulted in 34 different alternatives • Completed first screening to reduce down to 9 alternatives • PAC/PIMs with stakeholders and Public continue through Spring 2013 • Complete EA/FONSI - Summer 2013 • Right of Way Plat- FY2015 • Real Estate Acquisition-FY2015 -FY2017 • Utility Relocation- FY2018 - FY2019 • Construction-FY2020 -FY2022 $125 million total project budget (Design, R/E, Utilities, Construction)

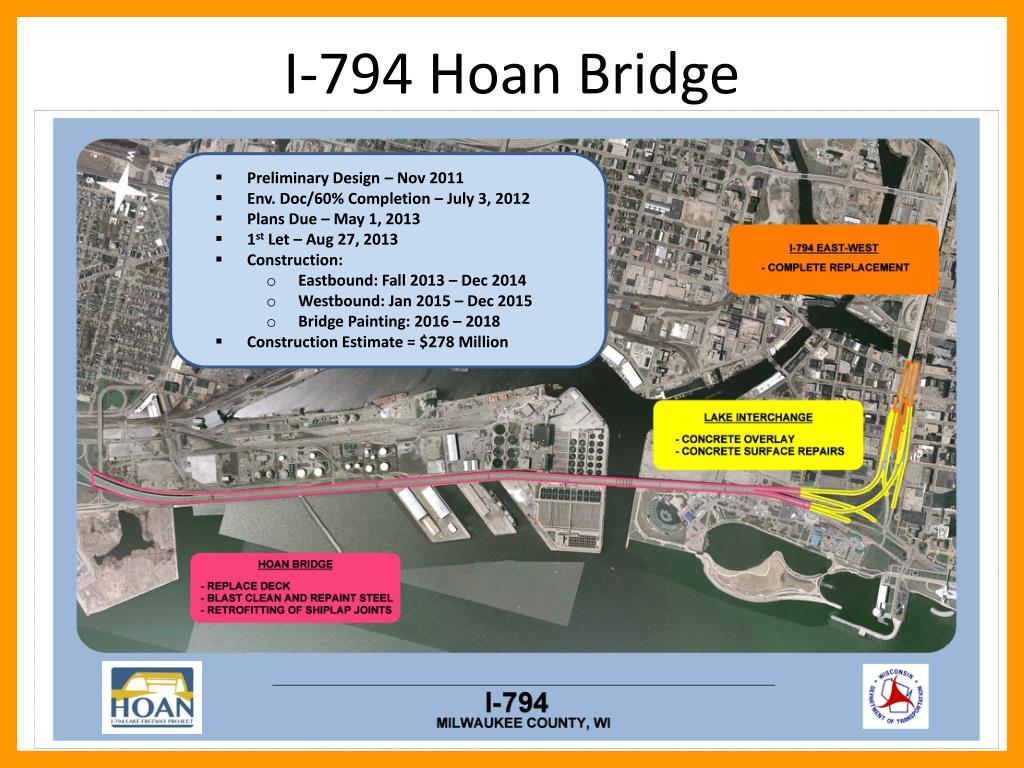

  11. I-794 Hoan Bridge • Preliminary Design – Nov 2011 • Env. Doc/60% Completion – July 3, 2012 • Plans Due – May 1, 2013 • 1st Let – Aug 27, 2013 • Construction: • Eastbound: Fall 2013 – Dec 2014 • Westbound: Jan 2015 – Dec 2015 • Bridge Painting: 2016 – 2018 • Construction Estimate = $278 Million

  12. Verona Road (US 18/151) reconstruction • County PD to Seminole Highway, Dane County • (3.0 miles) • Total Budget: $177 million • 2014 (15)* Lets • $ 65 million for Stage 1 Verona Road and Beltline • 2015 (16)* Lets • $1 million for Stage 1 Verona Road and Beltline • 2016 (17)* Lets • $10 million for Stage 2 Verona Road *Current 2011-13 Budget (Proposed 2013-15 Budget)

  13. I-94 NW Corridor Study Study Limits from USH 12 to STH 65 St. Croix County • Need and safety: • Replacedeteriorating pavement • Reduce congestion and high crash rates • Four to Six lane expansion • Replace 4 bridges: • East & west-bound Kinney Rd • East & west-bound Twin Lake Rd • Milestones: • Jan 2012 Solicitation & NOI Fed Register • Oct 2012 Initial LOM on alternatives • Jan 2013 Initial PIM on alternatives • Spring/Sumer 2013 Final PIMs • Fall 2013 Final ROD Note: STH 65 and USH12 Interchanges at project termini are or will be reconstructed to 6-lane configurations prior to completion of this study

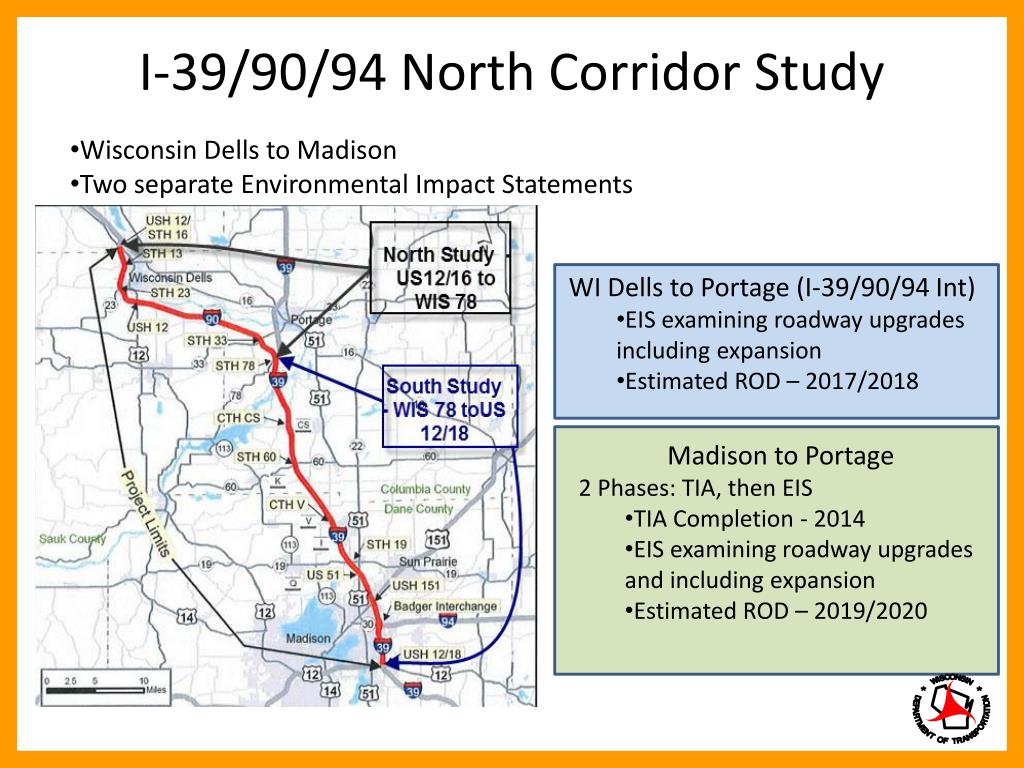

  14. I-39/90/94 North Corridor Study • Wisconsin Dells to Madison • Two separate Environmental Impact Statements • WI Dells to Portage (I-39/90/94 Int) • EIS examining roadway upgrades including expansion • Estimated ROD – 2017/2018 • Madison to Portage • 2 Phases: TIA, then EIS • TIA Completion - 2014 • EIS examining roadway upgrades and including expansion • Estimated ROD – 2019/2020

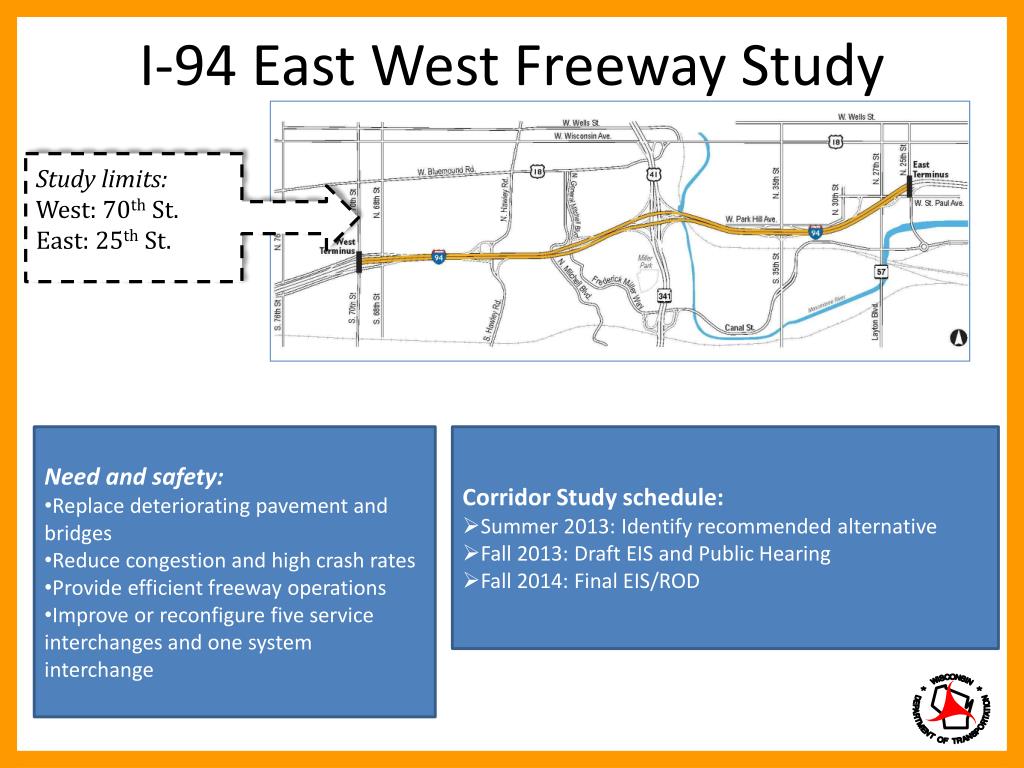

  15. I-94 East West Freeway Study Study limits: West: 70th St. East: 25th St. • Need and safety: • Replace deteriorating pavement and bridges • Reduce congestion and high crash rates • Provide efficient freeway operations • Improve or reconfigure five service interchanges and one system interchange • Corridor Study schedule: • Summer 2013: Identify recommended alternative • Fall 2013: Draft EIS and Public Hearing • Fall 2014: Final EIS/ROD

  16. USH 51 Stoughton Road Study • 11 Mile corridor from the Madison Beltline north to WIS 19, Deforest • EIS examines capacity expansion & intersection upgrades including new interchanges • DEIS-March,2013 • Replaces deteriorating pavement, address high crash rates, reduces significant congestion • Fall 2014 Final EIS/ROD

  17. I-43 N-S Freeway Corridor Study North Limit: STH 60 Silver Spring Dr. to STH 60, 14.1 Miles • Study to evaluate: • Replace deteriorating pavement and structures • Reduce congestion, improve freeway operations & safety • Improve or reconfigure 6 interchanges • Potential for new interchange at Highland Rd • Design alternatives wouldn’t preclude capacity expansion • Milestones: • Spring 2012 Publish Notice of Intent in Fed Register • February 2014 Public Hearing • August 2014 Final EIS/ROD • Construction 2 to 4 years depending on selected alternative South Limit: Silver Spring Dr.

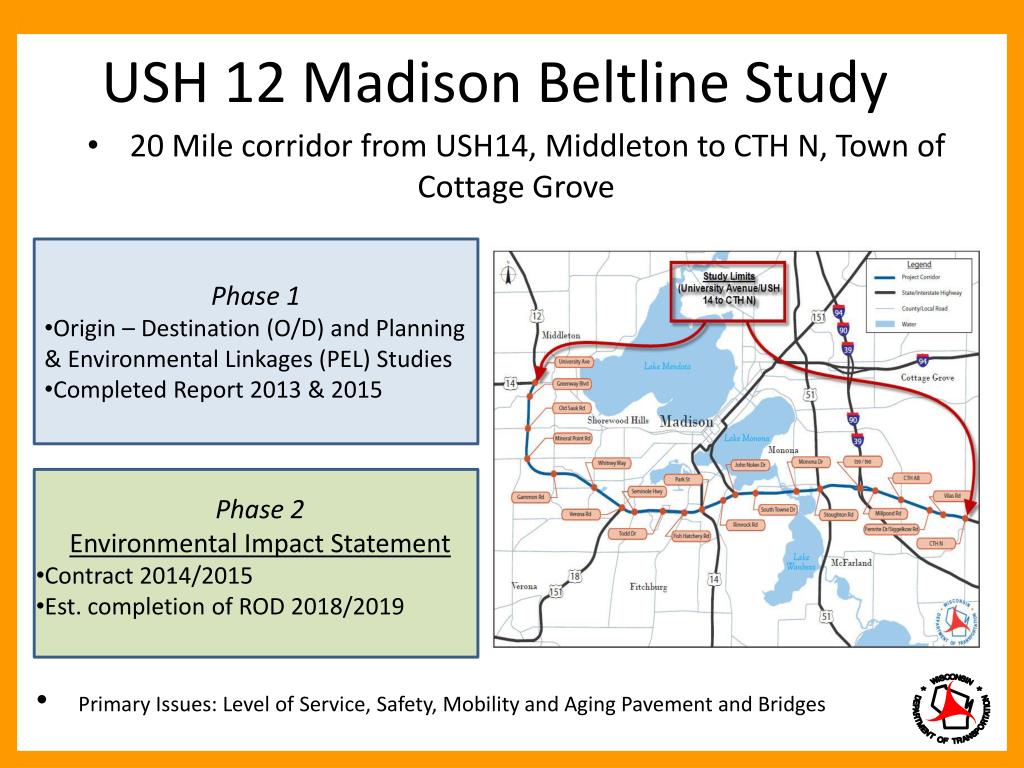

  18. USH 12 Madison Beltline Study • 20 Mile corridor from USH14, Middleton to CTH N, Town of Cottage Grove • Phase 1 • Origin – Destination (O/D) and Planning & Environmental Linkages (PEL) Studies • Completed Report 2013 & 2015 • Phase 2 • Environmental Impact Statement • Contract 2014/2015 • Est. completion of ROD 2018/2019 • Primary Issues: Level of Service, Safety, Mobility and Aging Pavement and Bridges

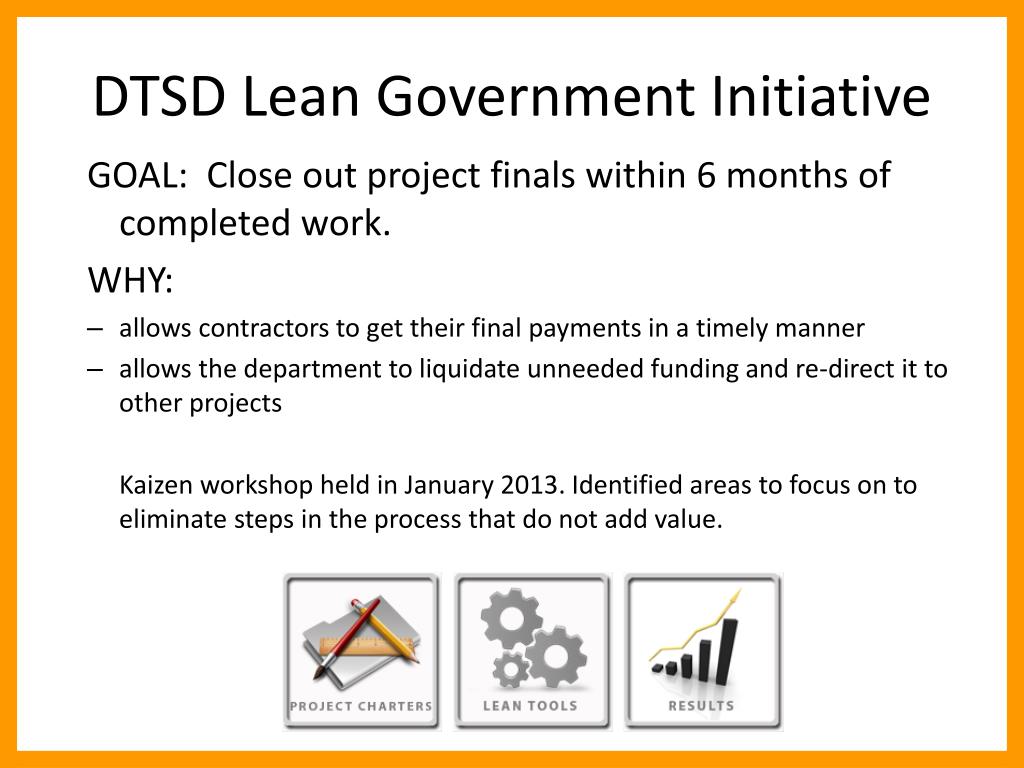

  19. DTSD Lean Government Initiative GOAL: Close out project finals within 6 months of completed work. WHY: • allows contractors to get their final payments in a timely manner • allows the department to liquidate unneeded funding and re-direct it to other projects Kaizen workshop held in January 2013. Identified areas to focus on to eliminate steps in the process that do not add value.

  20. Questions?
