  1. Main Building Utility PlanPhase 1 - Study PRE-SUBMITTAL CONFERENCE May 14, 2008, 9:00 AM

  2. Topics • Project Intent • Project Scope of Services • Project Milestone Schedule • Tour of Project Site

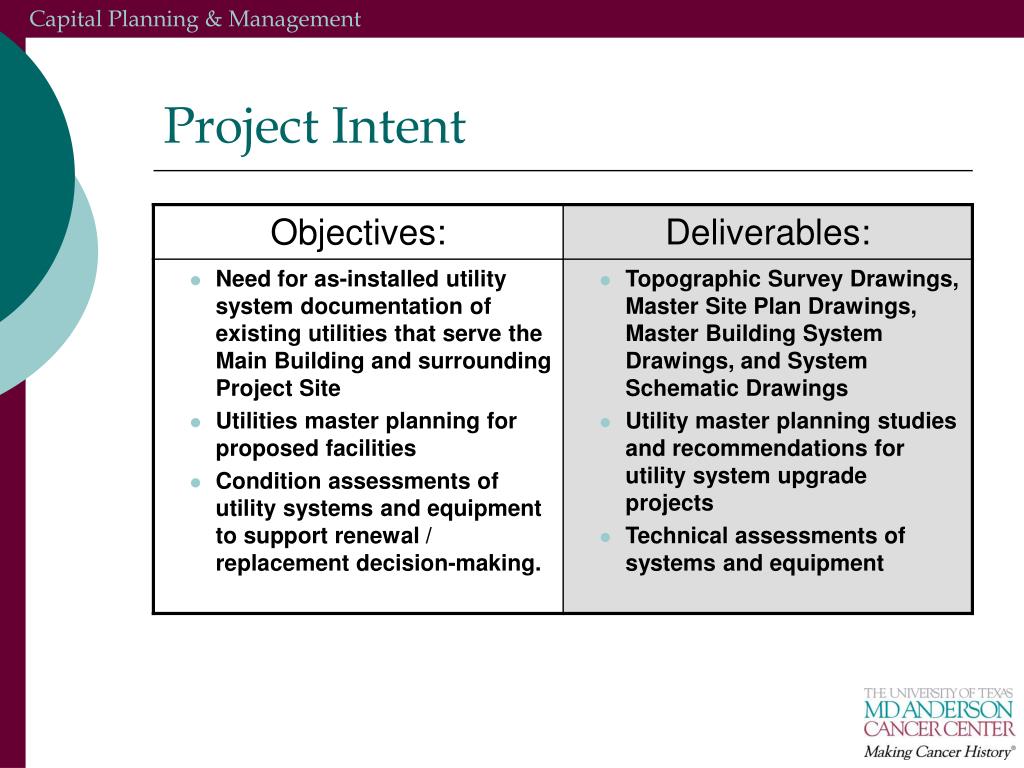

  3. Project Intent

  4. Project Site

  5. Proposed Buildings

  6. Project Scope of Services – Basic Services • Stage 1 - Documentation • Site documentation • Main Building documentation • Charles A. LeMaistre Clinic • R. Lee Clark Clinic (Old Clark) • R. Lee Clark Clinic (New Clark) • Margaret and Ben Love Clinic

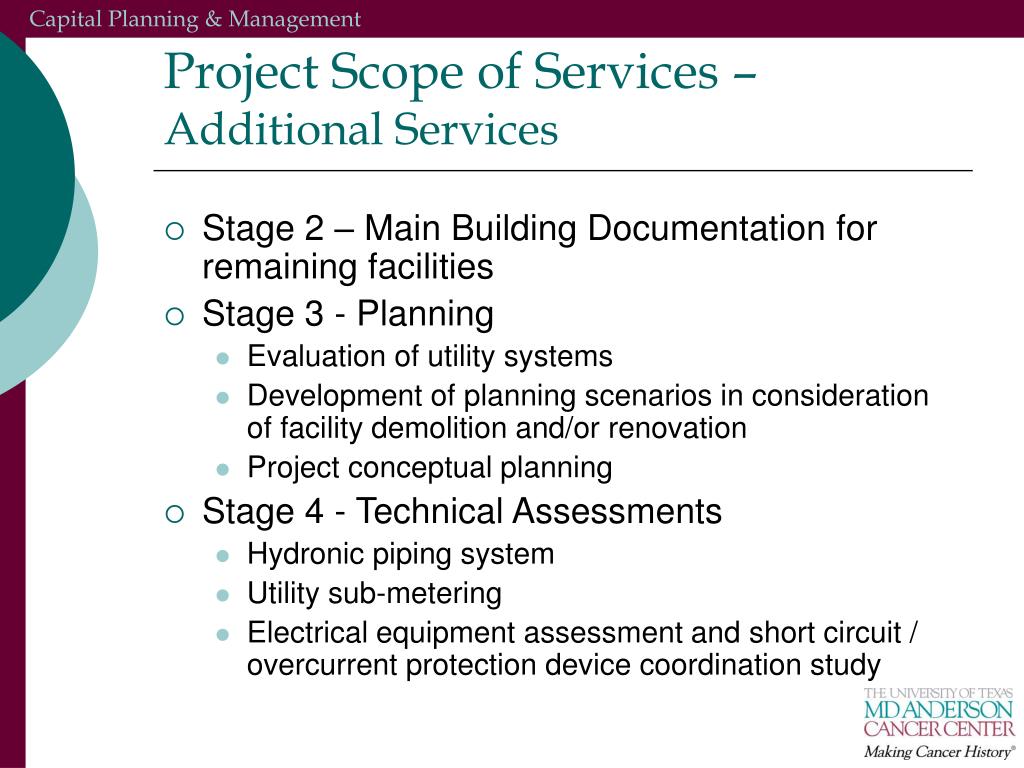

  7. Project Scope of Services – Additional Services • Stage 2 – Main Building Documentation for remaining facilities • Stage 3 - Planning • Evaluation of utility systems • Development of planning scenarios in consideration of facility demolition and/or renovation • Project conceptual planning • Stage 4 - Technical Assessments • Hydronic piping system • Utility sub-metering • Electrical equipment assessment and short circuit / overcurrent protection device coordination study

  8. Investigate, document, and create drawings per system using M. D. Anderson AutoCAD standard Add confirmed project as-built information Field verify installation of main utilities and equipment Update drawings and distribute for M. D. Anderson review Produce final master system drawings based on review comments Building Utilities DocumentationMaster System Drawings M. D. Anderson will maintain drawings with current system information as renovation projects are completed

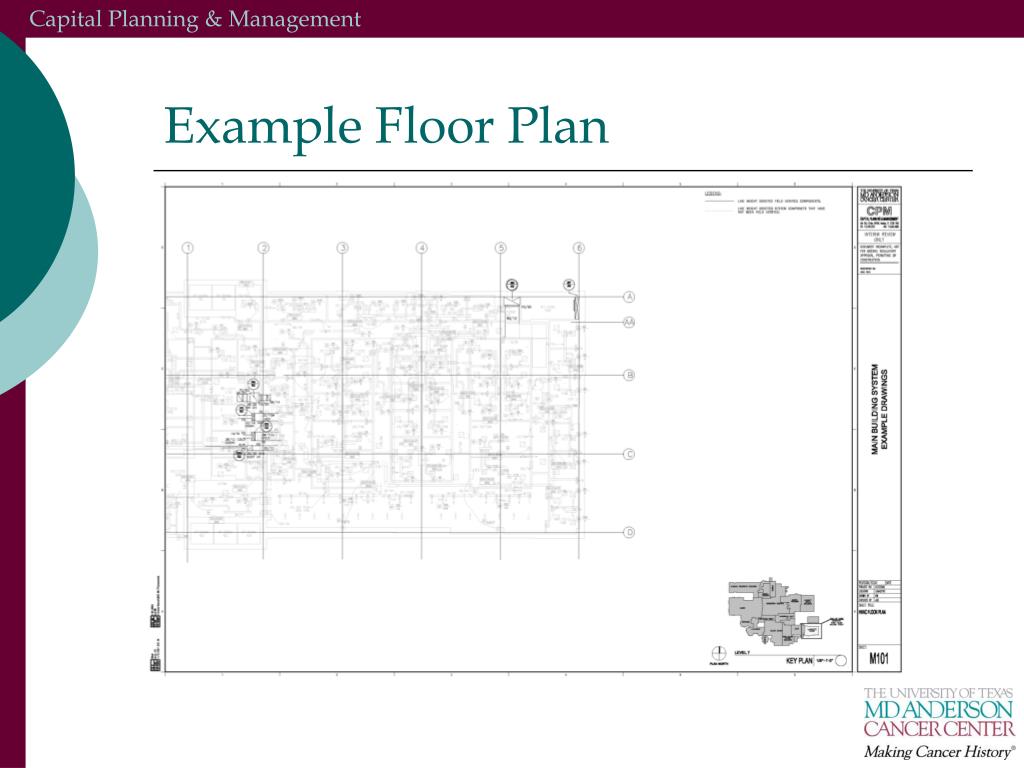

  9. Example Floor Plan

  10. Example Riser Diagram

  11. Project Milestone Schedule

  12. Tour of Project Site • Equipment Rooms • Old Clark / New Clark / LeMaistre Clinics • Site • Service Corridor / Receiving Dock • Electrical Transformer Vault
