Ercot pmo update

ERCOT PMO Update

Robert Connell

Director Program Management

March Board of Directors

March 8, 2005 (Through 2/28/05)


Ercot pmo update

2005 YTD Project Performance

First Quarter Results (to 2/28)

Project Process Improvements In 2005

  • 4 completed, 4 YTD

  • 9 in Initiation

  • 20 in Planning

  • 21 in Execution

  • Institute Managed Time Periods

  • Establish sound schedule management

  • Expand on Project Metrics – EVM

  • Establish Risk Management Methodology

Project Performance

Project Activity


Major ercot projects summary

Major ERCOT Projects Summary


Projects completed 1 st quarter

Projects Completed in January

40102 REC Enhancements

30099 Taylor Expansion

Projects Completed in February

40042_01 EDW EMMS RSS

30144 EMP 2.2 Upgrade

Projects Completed 1st Quarter

  • Projects Completed in March

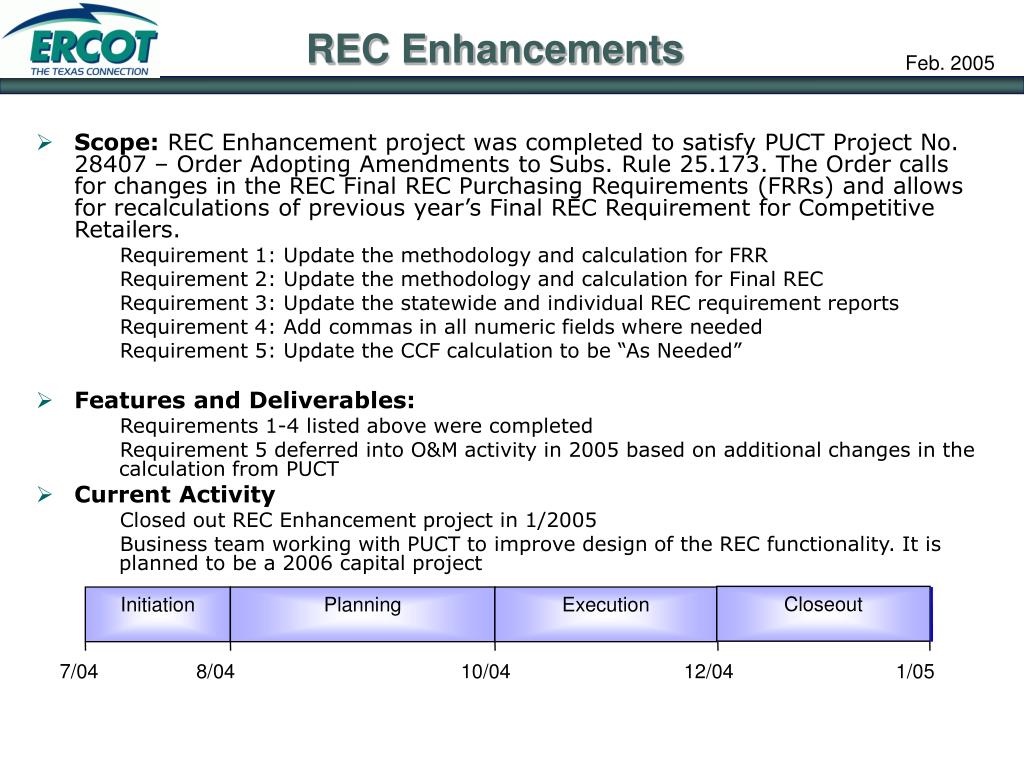

Rec enhancements

8/04

10/04

12/04

1/05

REC Enhancements

  • Scope: REC Enhancement project was completed to satisfy PUCT Project No. 28407 – Order Adopting Amendments to Subs. Rule 25.173. The Order calls for changes in the REC Final REC Purchasing Requirements (FRRs) and allows for recalculations of previous year’s Final REC Requirement for Competitive Retailers.

    Requirement 1: Update the methodology and calculation for FRR

    Requirement 2: Update the methodology and calculation for Final REC

    Requirement 3: Update the statewide and individual REC requirement reports

    Requirement 4: Add commas in all numeric fields where needed

    Requirement 5: Update the CCF calculation to be “As Needed”

  • Features and Deliverables:

    Requirements 1-4 listed above were completed

    Requirement 5 deferred into O&M activity in 2005 based on additional changes in the calculation from PUCT

  • Current Activity

    Closed out REC Enhancement project in 1/2005

    Business team working with PUCT to improve design of the REC functionality. It is planned to be a 2006 capital project

Closeout

Initiation

Planning

Execution

7/04


Pr 30099 taylor expansion

PR-30099 Taylor Expansion

  • Scope:

    • Design facilities for short-term, mid-term and long term growth needs. Construct Short-term and mid-term facilities.

  • Features and Deliverables:

    • Construct a facility of similar quality and appearance to the MET center and the TCC located in close proximity to the TCC.

    • Construction of mobile units which will accommodate expected short term growth in 2003 and also provide a buffer prior to building of phase III when and if it becomes necessary.

    • The relocation of employees, contractors and vendors from outlying areas by 2004

    • Design Plans which take into account a longer projected growth rate

    • Design plans which accommodate both security factors and human factors Ensure availability of reliable, accurate and timely information

  • Current Activity

    In Closure

Planning

5 Months

Execution

12 months

Close

1.5 months

9/2003 – 2/2004

2/2004 -2/2005

2/2005 – 3/2005


Pr 40042 01 edw emms rss

PR-40042_01 EDW EMMS RSS

  • Scope:

    Implementation of the EDW EMMS RSS (Replicated Source System) to support the ability to capture intra-day transactions from the EMMS source databases, as well as support the ability to capture information to support point-in-time reporting. The EMMS RSS is a replicated database copy of the source system that will be used to transfer information into the EDW EMMS ODS (Operational Data Store). The EDW EMMS ODS is a separate subproject – 40042_07.

  • Features and Deliverables:

    Ensure availability of reliable, accurate and timely information

    Provide the ability to capture intra-day transactions that will ensure all EMMS data is being captured (and not just a snapshot of data at the end of the day), as well as near real-time data that can then be used to support market monitoring reporting

    Store the data using point-in-time fields that will allow reporting of historical periods.

  • Current Activity

    In production

Planning

4 Months

Server/Environment Setup - 4 Months

Development

2 Months

Int & Test

1 Month

Production Go-Live and Stabilization

5/19/04-9/8/04

9/8/04-10/27/04

10/27/04-12/3/04

12/3/04-2/16/05

1/5/04-5/19/04


Implement smp emp2 2 for emms

Implement SMP/EMP2.2 for EMMS

  • Scope:

    Implement the SCADA Management Platform and Energy Management Platform 2.2 from AREVA. Scope includes the following set of approved deliverables:

    • PR20159 Load Rollover

    • PR30050 EMS Front-End Replacements (Replace obsolete technology)

    • PR30074 Enhance STNET Multiple Selected Time Ranges

    • PR30094 DCP Enhancement (VSAT/TSAT Enhancements)

    • PR30096 Move PTI Bus Translation to Genesys

    • PR30170 Implement a selected contingency into Power Flow

    • PR40099 CTGS Import/Export Dump Utility (ERCOT development)

    • PR40094 Constraint Activity Manager (CAM v2.2 – ERCOT development)

  • Features and Deliverables:

    The SMP product allows ERCOT to retire obsolete technology that is no longer supported by the manufacturer of key communications software that is used to control Frequency. The EMP2.2 product implements new AREVA software releases that includes enhancements in EMS Network Applications that help ERCOT improve reliable grid operations. The ERCOT developed deliverables provides features that help reduce congestion costs.

  • Current Activity

    Fully in production as of 2/10/05. Seeking funding approval for missed closing requirements such as retirement of obsolete technology and software issues identified during final User Acceptance Testing.

  • Development

    8 Months

    Planning

    8 Months

    Int & Testing

    4 Months

    Go-Live and Stabilization

    4/1/03-11/30/03

    12/1/03-8/20/04

    9/23/04-1/13/05

    1/24/05-Present


  • Login
