Addressing Challenges in 33% RPS Implementation: Solutions and Insights
140 likes | 256 Views
The paper explores the implementation challenges faced in achieving a 33% Renewable Portfolio Standard (RPS). Key issues identified include environmental reviews, supply chain adequacy, and regulatory hurdles that can delay project timelines. Specific case studies, such as the DPV2 and Sunrise Powerlink Transmission Lines, illustrate the complexities of permitting on tribal and protected lands. The study emphasizes the need for thorough planning using RETI metrics while proposing solutions to streamline regulatory processes and mitigate environmental impacts.
Addressing Challenges in 33% RPS Implementation: Solutions and Insights
E N D
Presentation Transcript
33% RPS Implementation and Barrier Analysis August 26, 2008 Susan Lee & Carl Linvill Aspen Environmental Group
Purpose: 33% RPS ImplementationChallenges Will Be Examined And Solutions Proposed Resource planning in the regulatory arena often fails to assess implementation challenges Environmental Review, Supply Chain Adequacy, and Contracting and Regulatory Issues each have implementation consequences The 33% RPS examples are an opportunity to present the Commission with the challenges and propose potential solutions

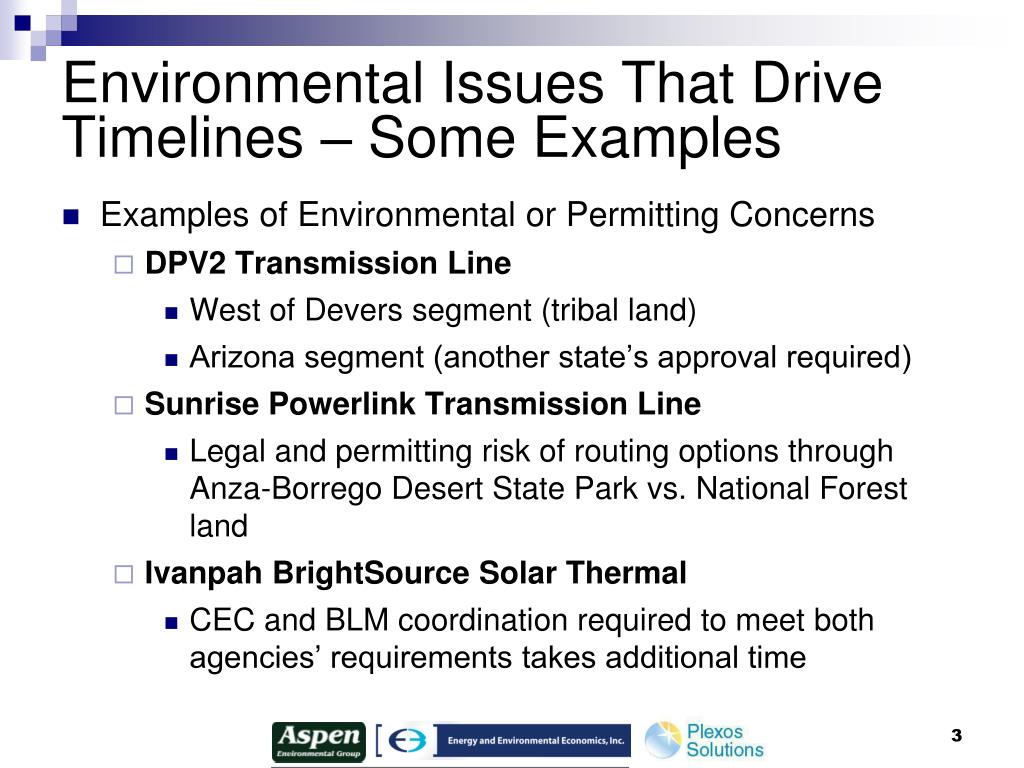

Environmental Issues That Drive Timelines – Some Examples Examples of Environmental or Permitting Concerns DPV2 Transmission Line West of Devers segment (tribal land) Arizona segment (another state’s approval required) Sunrise Powerlink Transmission Line Legal and permitting risk of routing options through Anza-Borrego Desert State Park vs. National Forest land Ivanpah BrightSource Solar Thermal CEC and BLM coordination required to meet both agencies’ requirements takes additional time
Environmental Issues Considered at Three Points – Initial Buildout
Environmental Screen Will Affect Initial Buildout • RETI metrics by CREZ offer values that can influence initial buildout choices • RETI metrics include: • Footprint within CREZ and transmission ROW • Category 1 and Category 2 lands • Significant species & wildlife corridors
Environmental Issues Considered at Three Points – Final Buildout
Implementation Screen Will Support Final Buildout • Use RETI as a foundation • Support RETI with supplemental qualitative information, e.g. – • Cumulative impacts (agricultural land, specific habitat types, cultural resources) • Land uses adjacent to transmission corridors requiring expansion
Environmental Issues Considered at Three Points – Implementation Analysis

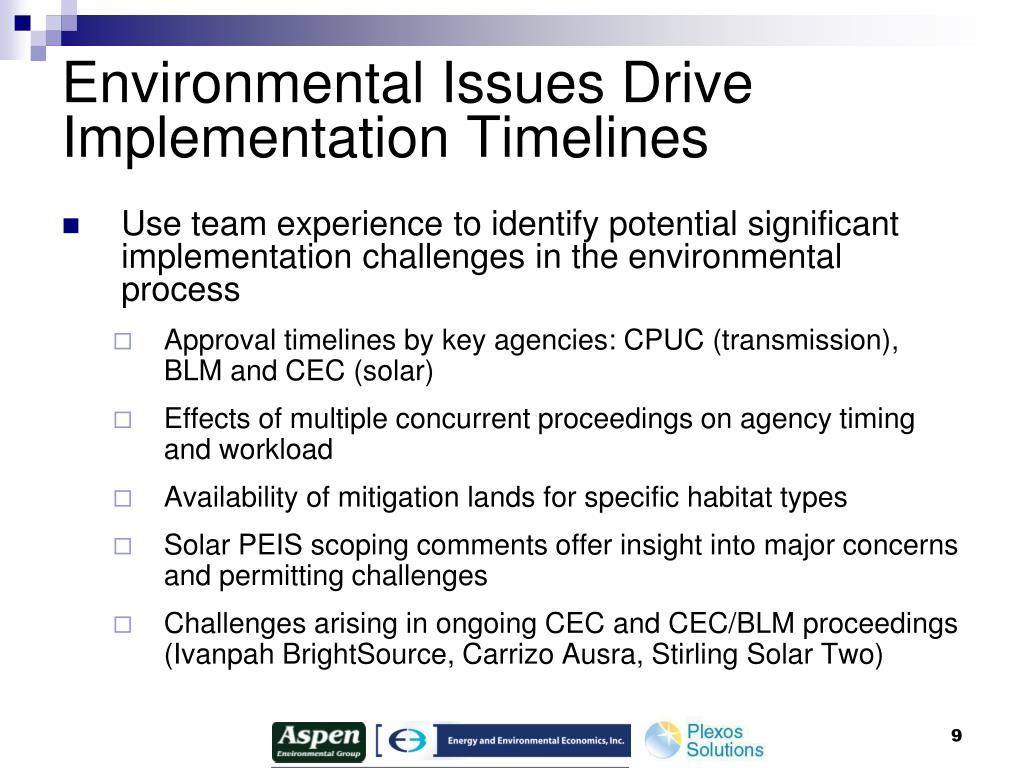

Environmental Issues Drive Implementation Timelines Use team experience to identify potential significant implementation challenges in the environmental process Approval timelines by key agencies: CPUC (transmission), BLM and CEC (solar) Effects of multiple concurrent proceedings on agency timing and workload Availability of mitigation lands for specific habitat types Solar PEIS scoping comments offer insight into major concerns and permitting challenges Challenges arising in ongoing CEC and CEC/BLM proceedings (Ivanpah BrightSource, Carrizo Ausra, Stirling Solar Two)
Implementation Challenges Arise From Other Sources As Well • Supply Chain Challenges • Contracting and Regulatory Challenges • Others?
Supply Chain Issues Introduce Implementation Challenges Manufacturing capacity of renewable technologies will require expansion Manufacturing capacity for major transmission construction may be limited Some transmission system equipment needs to be specifically ordered with long lead time Delays in delivery of capital in rapid expansion phases is common
Contracting and Regulatory Issues Introduce Challenges The chicken and egg problem of T and G contracting, financing and construction High contract failure rate creates planning difficulties LTPP determination of need and other regulatory changes may increase long term contracting certainty
Contact Information: Susan Lee slee@aspeneg.com 415.955.4775 Carl Linvill clinvill@aspeneg.com 916.379.0350
