二電 2012 年 11 月效率分析

二電 2012 年 11 月效率分析. 主要內部異常說明 :1. 制程問題 : API6OT22-660G: H/P 測試 Arcing 不良重工 , 工時 : 32,470 分鐘 ; 支援 TE 制作治具及 技修回 線 工時 : 8,813 分鐘 ; 2. 生產管理 : 晨訓及新進人員培訓 , 工時 :421,276 分鐘. 二電 2012 年 11 月效率分析 - 除外工時.

oren-ochoa
Download Presentation

二電 2012 年 11 月效率分析

An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript

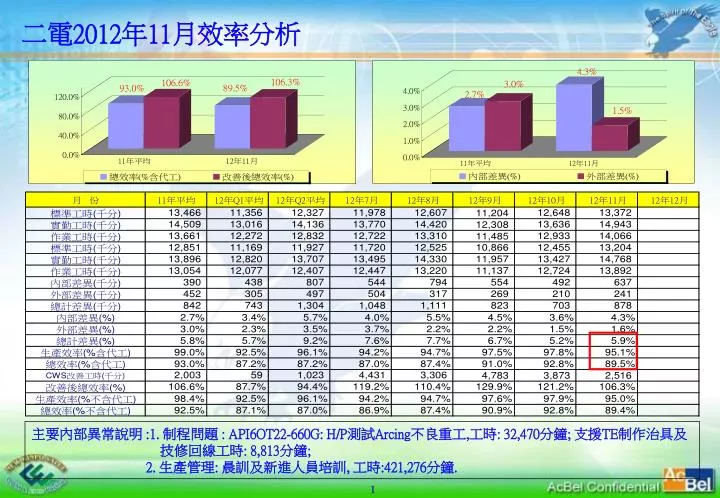

  1. 二電2012年11月效率分析 主要內部異常說明 :1. 制程問題 : API6OT22-660G: H/P測試Arcing不良重工,工時: 32,470分鐘; 支援TE制作治具及 技修回線工時: 8,813分鐘; 2. 生產管理: 晨訓及新進人員培訓, 工時:421,276分鐘.

  2. 二電2012年11月效率分析-除外工時
