1 / 21

Chapter 13

Fall 2011. Chapter 13. Software Project Management. Project Management Process. Why do we need project management? Why can’t we just follow one of the software development process and be left alone?. All projects – small and large – need project management

kent
Download Presentation

Chapter 13

An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript


  1. Fall 2011 Chapter 13 Software Project Management

  2. Project Management Process • Why do we need project management? • Why can’t we just follow one of the software development process and be left alone? All projects – small and large – need project management because all projects need some degree of : - planning - organizing - status monitoring - adjustment

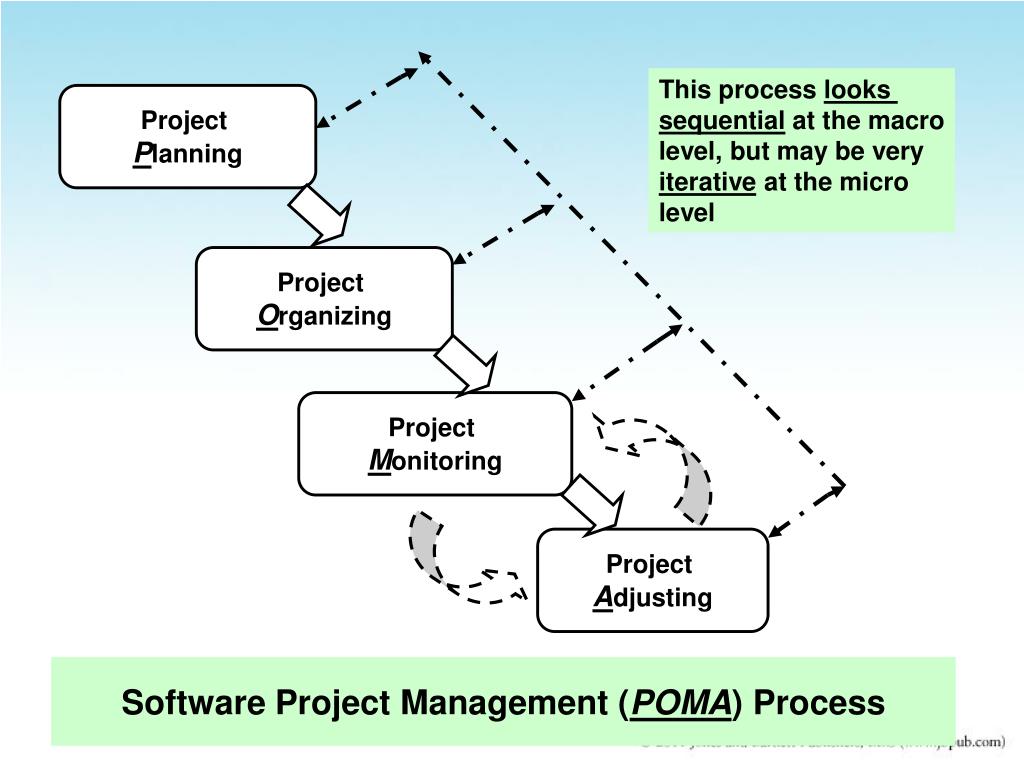

  3. Software Project Management (POMA) Process This process looks sequential at the macro level, but may be very iterative at the micro level Project Planning Project Organizing Project Monitoring Project Adjusting

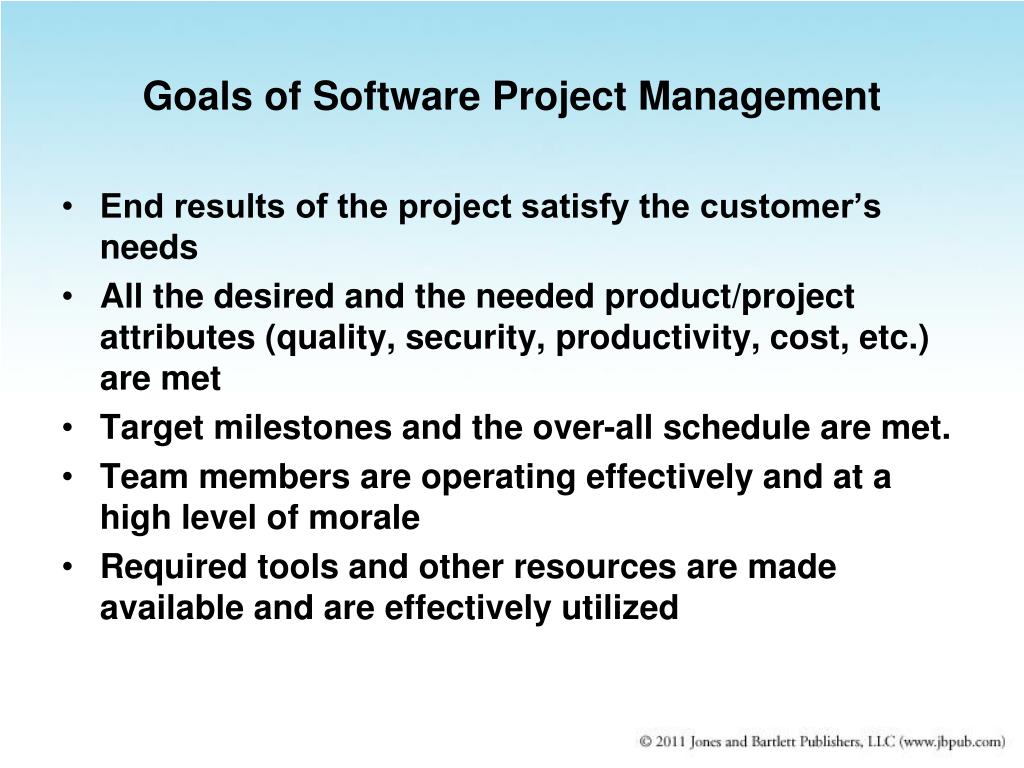

  4. Goals of Software Project Management • End results of the project satisfy the customer’s needs • All the desired and the needed product/project attributes (quality, security, productivity, cost, etc.) are met • Target milestones and the over-all schedule are met. • Team members are operating effectively and at a high level of morale • Required tools and other resources are made available and are effectively utilized

  5. Planning (POMA) • The 1st step of project planning is to understand the requirements of the project. • This step itself may be a mini-project • Then the following 4 steps are included in the rest of project planning: • Estimate • the work effort, • the schedule, and • the needed resources • Clearly define and establish measurable goals for the project • Determine the project resource allocations of • people, • process, • tools, and • facilities • Identify and analyze the project risks

  6. Organizing (POMA) • Once a project plan is formulated or partially formulated, organizing may start • Organization structure needs to be designed • Human resource hiring needs to start and be completed along with acquisition of other resources • Any required education and training have to be completed • Mechanisms for tracking must be established • Risk tracking and mitigation • Project goal monitoring

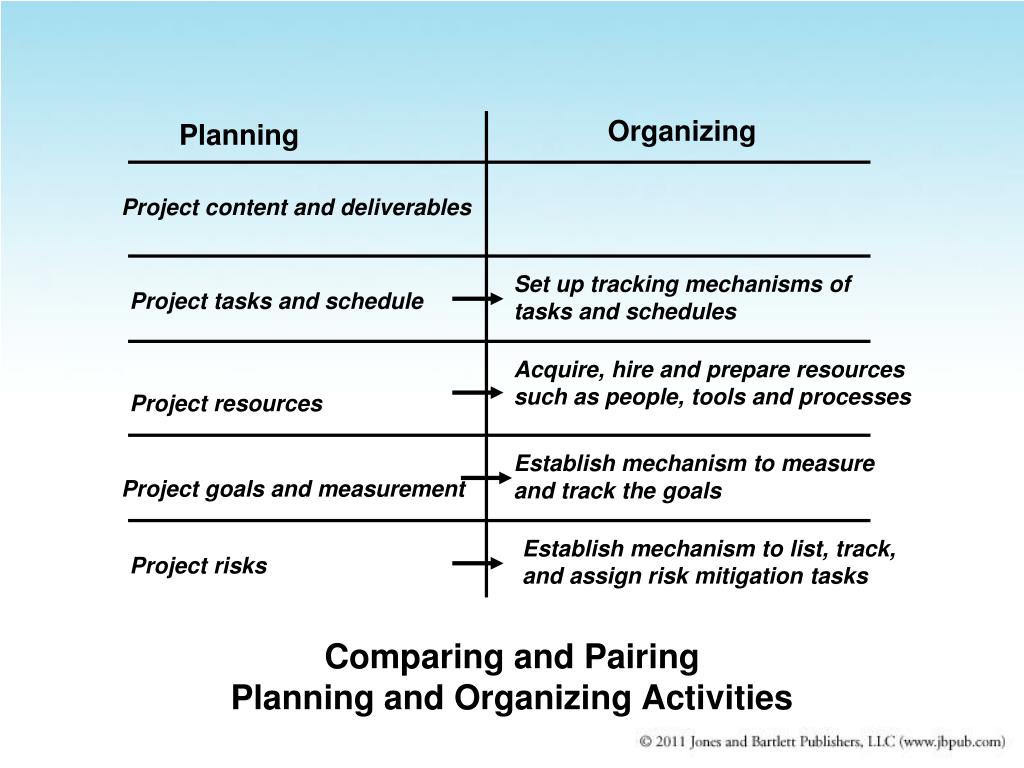

  7. Comparing and Pairing Planning and Organizing Activities Organizing Planning Project content and deliverables Set up tracking mechanisms of tasks and schedules Project tasks and schedule Acquire, hire and prepare resources such as people, tools and processes Project resources Establish mechanism to measure and track the goals Project goals and measurement Establish mechanism to list, track, and assign risk mitigation tasks Project risks

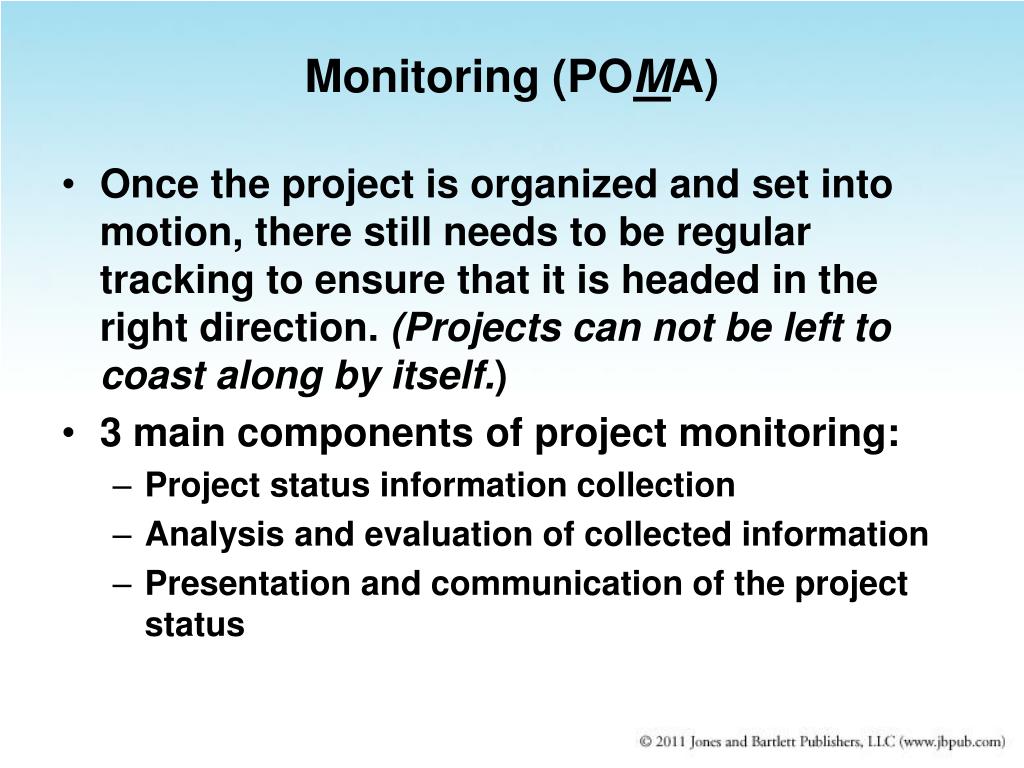

  8. Monitoring (POMA) • Once the project is organized and set into motion, there still needs to be regular tracking to ensure that it is headed in the right direction. (Projects can not be left to coast along by itself.) • 3 main components of project monitoring: • Project status information collection • Analysis and evaluation of collected information • Presentation and communication of the project status

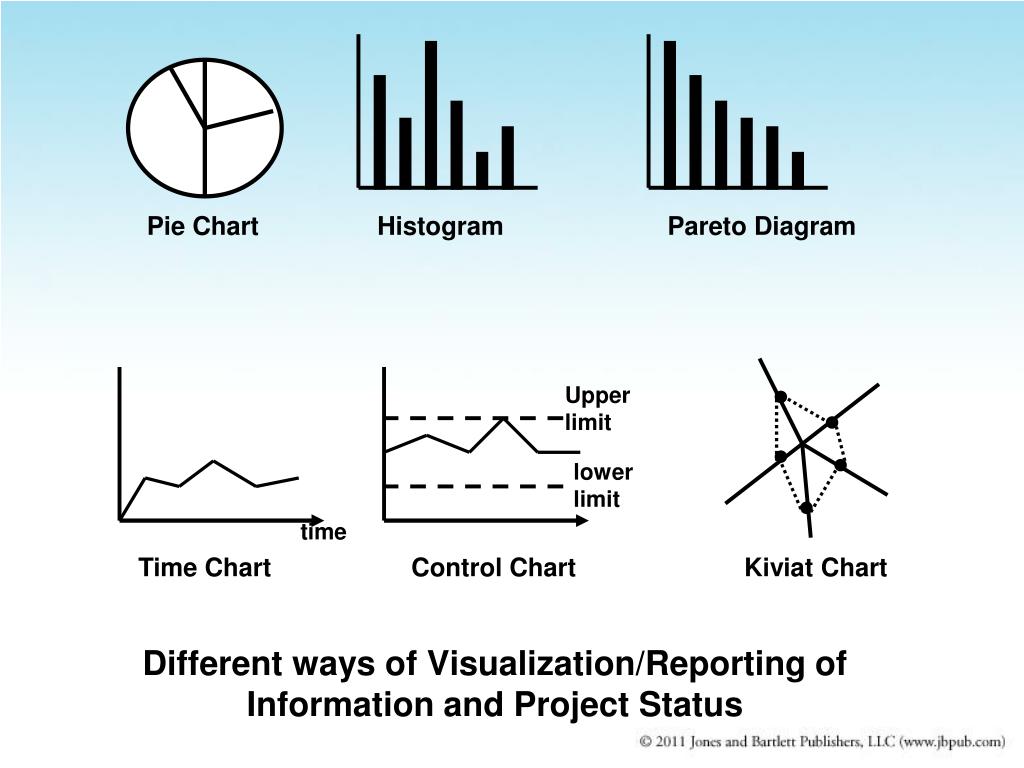

  9. Different ways of Visualization/Reporting of Information and Project Status Pie Chart Histogram Pareto Diagram Upper limit lower limit time Time Chart Control Chart Kiviat Chart

  10. Adjusting (POMA) • It is highly unlikely that a software project progresses with no problem. As soon as the project status suggests potential problem, we must not be afraid to make changes. • 3 main areas of adjustments are (or combinations of) : • Resources • Schedule • Project content

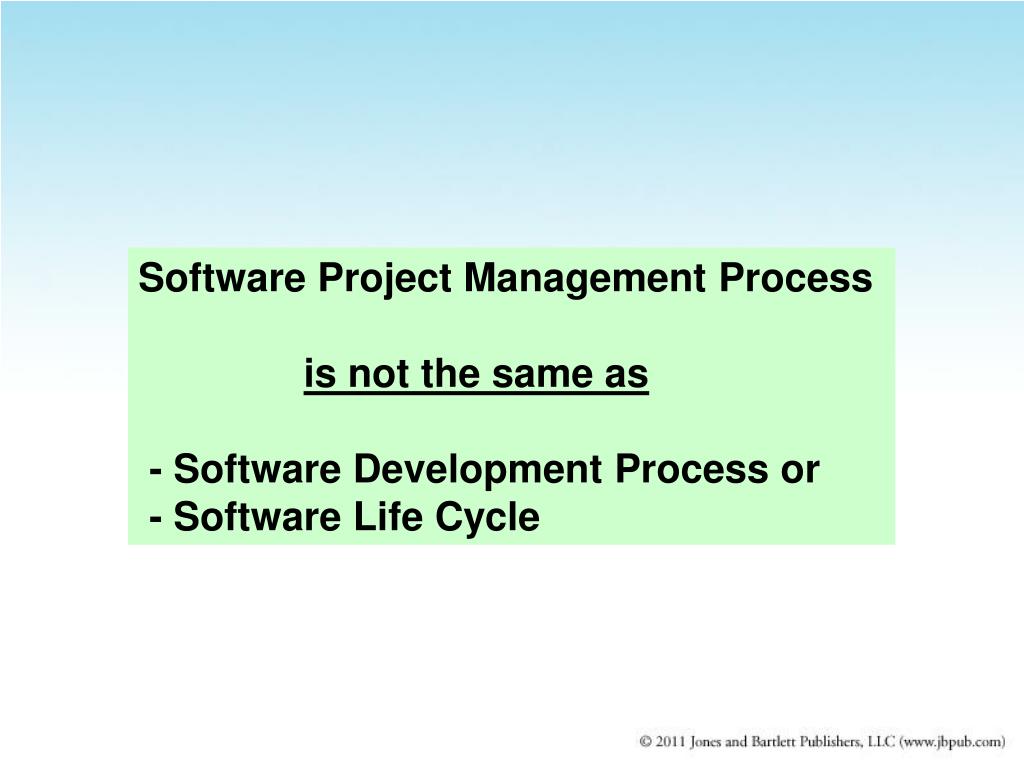

  11. Software Project Management Process is not the same as - Software Development Process or - Software Life Cycle

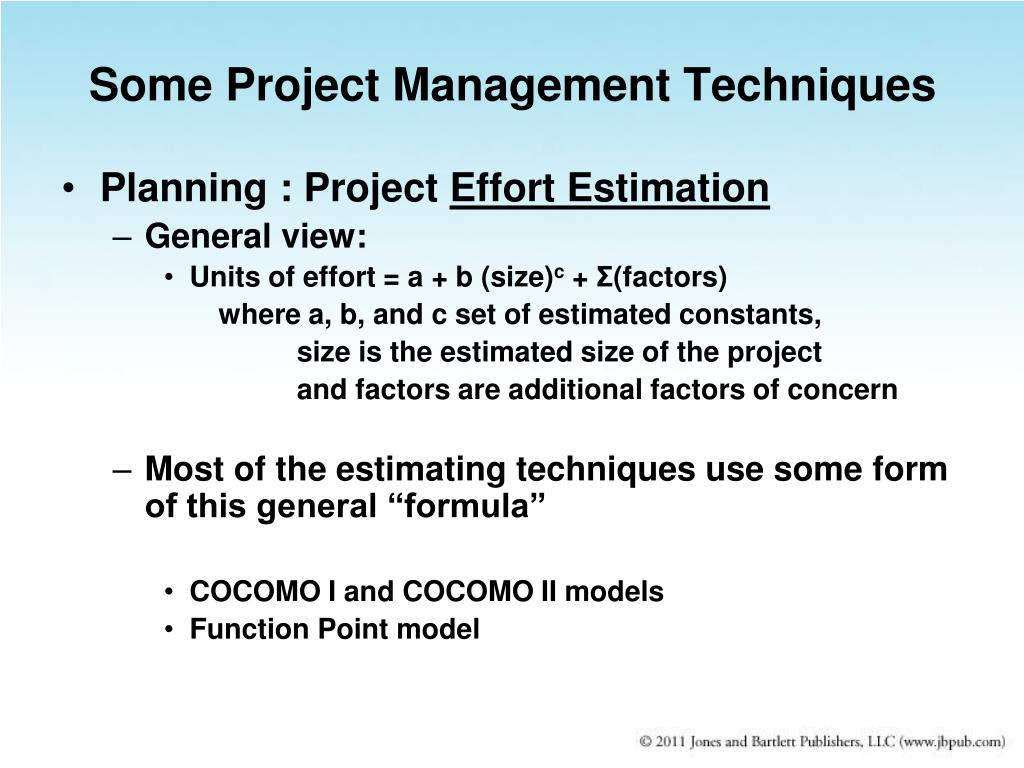

  12. Some Project Management Techniques • Planning : Project Effort Estimation • General view: • Units of effort = a + b (size)c + Σ(factors) where a, b, and c set of estimated constants, size is the estimated size of the project and factors are additional factors of concern • Most of the estimating techniques use some form of this general “formula” • COCOMO I and COCOMO II models • Function Point model

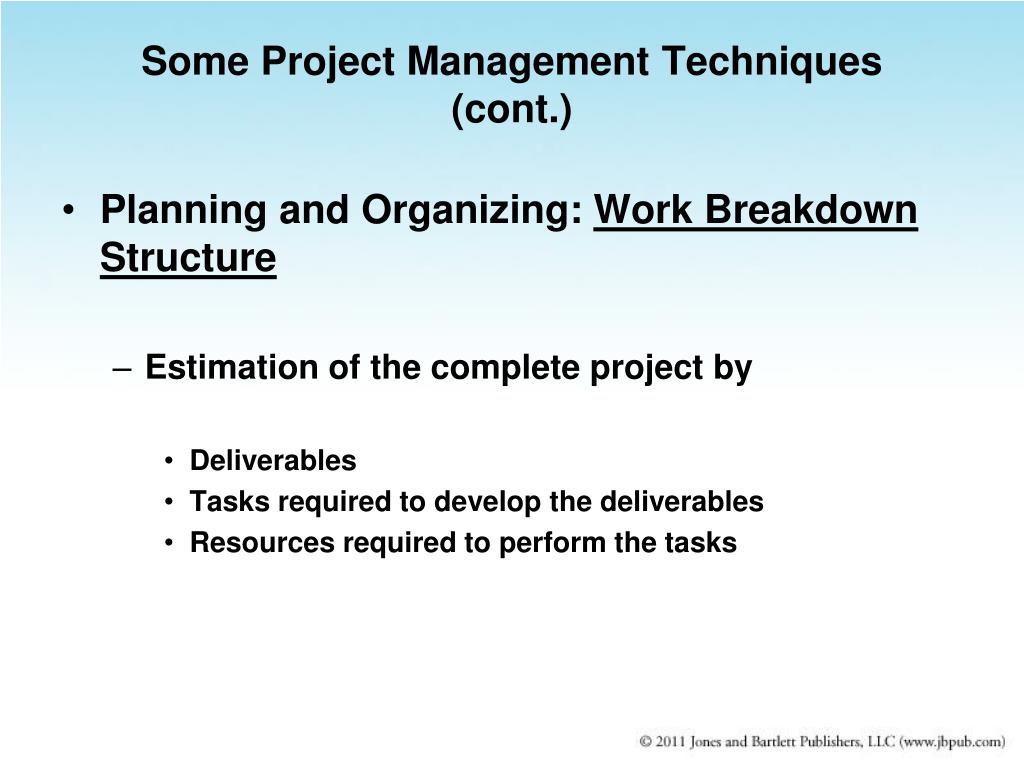

  13. Some Project Management Techniques(cont.) • Planning and Organizing: Work Breakdown Structure • Estimation of the complete project by • Deliverables • Tasks required to develop the deliverables • Resources required to perform the tasks

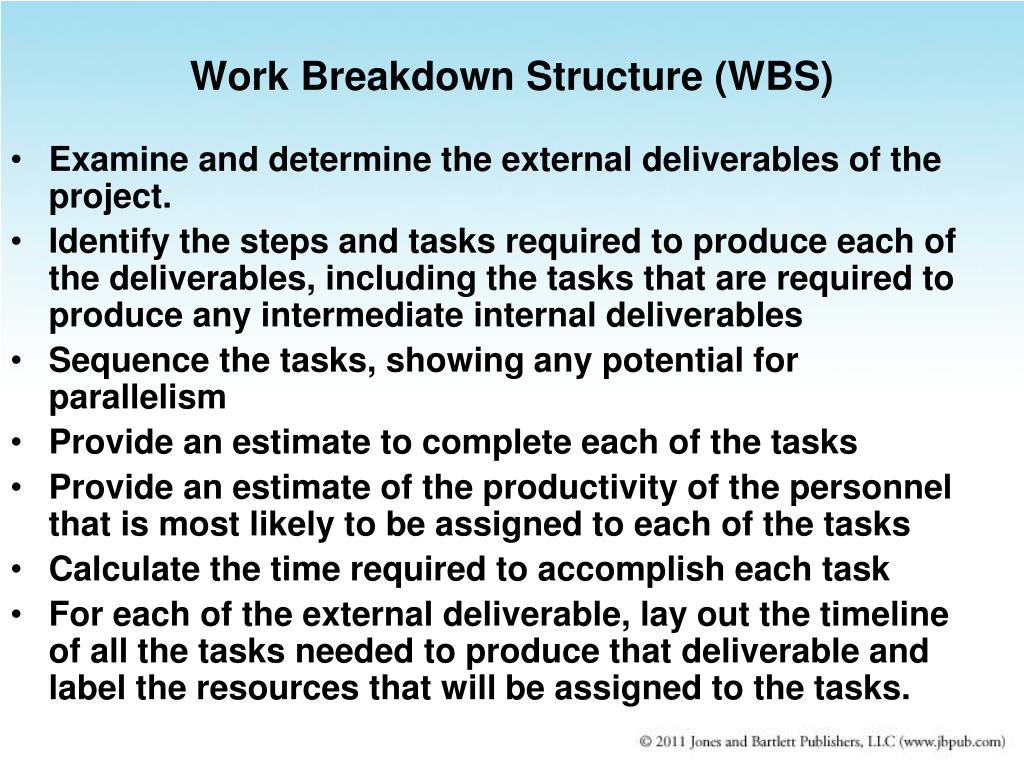

  14. Work Breakdown Structure (WBS) • Examine and determine the external deliverables of the project. • Identify the steps and tasks required to produce each of the deliverables, including the tasks that are required to produce any intermediate internal deliverables • Sequence the tasks, showing any potential for parallelism • Provide an estimate to complete each of the tasks • Provide an estimate of the productivity of the personnel that is most likely to be assigned to each of the tasks • Calculate the time required to accomplish each task • For each of the external deliverable, lay out the timeline of all the tasks needed to produce that deliverable and label the resources that will be assigned to the tasks.

  15. Example of: Task Network with Estimated Time Units Task-4a 2 Task-5a 1 Task-3a 6 End Task-4b 2 Task-5b 1 Task-3b 6 Task 1 12 Task 2 2 Task-4c 2 Task-5c 1 Task-3c 6

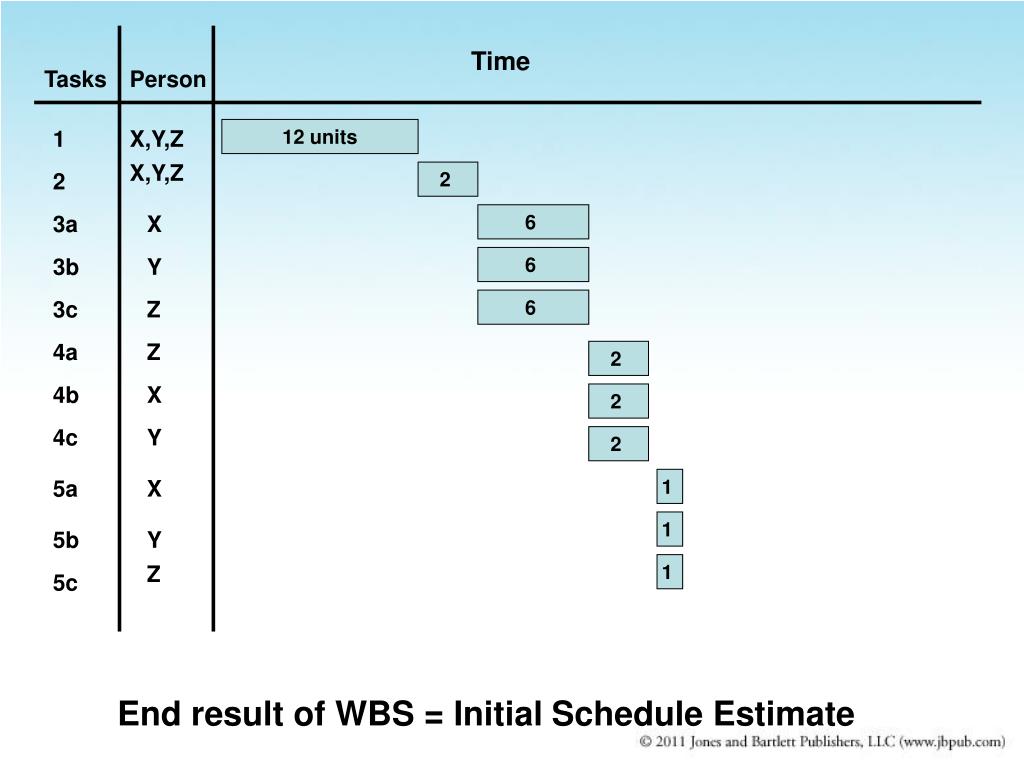

  16. End result of WBS = Initial Schedule Estimate Time Tasks Person 1 X,Y,Z 12 units X,Y,Z 2 2 3a X 6 3b Y 6 3c Z 6 4a Z 2 4b X 2 4c Y 2 5a X 1 1 5b Y Z 1 5c

  17. Some Project Management Techniques(cont.) • Monitoring: Earned Value • A technique to track the project status by comparing (at some specific time): • How much effort has been expended versus • How much effort was planned to have been expended

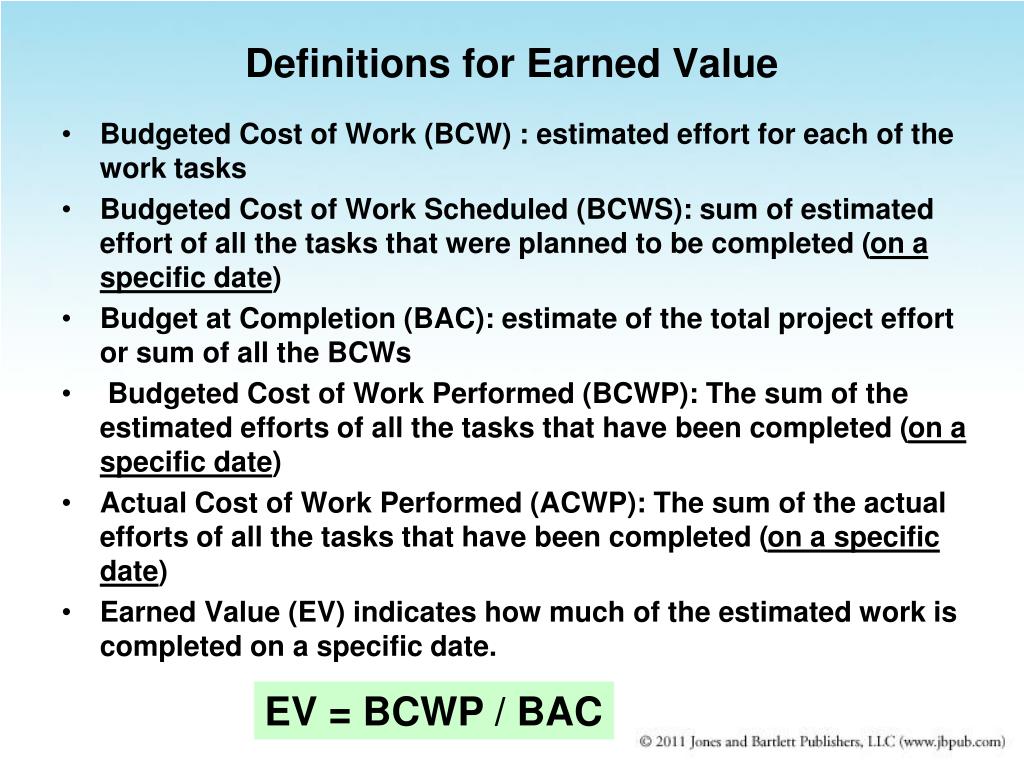

  18. Definitions for Earned Value • Budgeted Cost of Work (BCW) : estimated effort for each of the work tasks • Budgeted Cost of Work Scheduled (BCWS): sum of estimated effort of all the tasks that were planned to be completed (on aspecific date) • Budget at Completion (BAC): estimate of the total project effort or sum of all the BCWs • Budgeted Cost of Work Performed (BCWP): The sum of the estimated efforts of all the tasks that have been completed (on a specific date) • Actual Cost of Work Performed (ACWP): The sum of the actual efforts of all the tasks that have been completed (on a specificdate) • Earned Value (EV) indicates how much of the estimated work is completed on a specific date. EV = BCWP / BAC

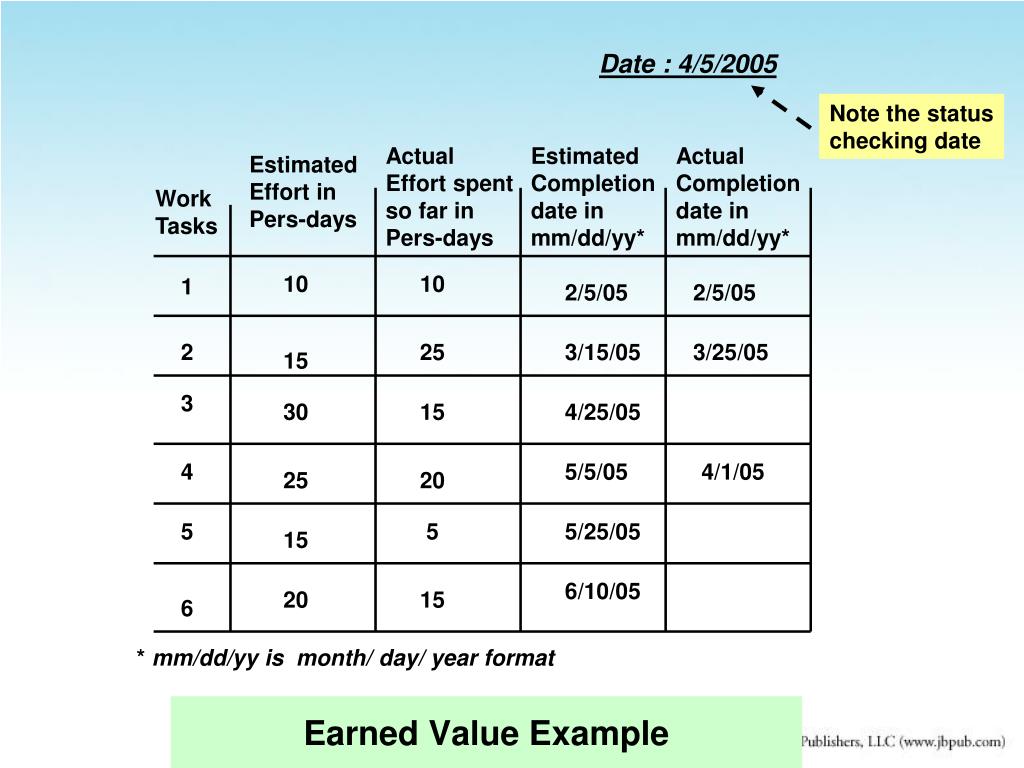

  19. Earned Value Example Date : 4/5/2005 Note the status checking date Actual Effort spent so far in Pers-days Estimated Completion date in mm/dd/yy* Actual Completion date in mm/dd/yy* Estimated Effort in Pers-days Work Tasks 10 10 1 2/5/05 2/5/05 2 25 3/15/05 3/25/05 15 3 30 15 4/25/05 4 5/5/05 4/1/05 25 20 5 5 5/25/05 15 6/10/05 20 15 6 * mm/dd/yy is month/ day/ year format

  20. Earned Value Example (cont.) • For work task 4, BCW is 25 person-days; for task 6, BCW is 20 person-days. • BAC is the sum of the estimated efforts for all the tasks or BAC = (10+15+30+25+15+20 = 115 person-days) • BCWS for the date 4/5/06 is the sum of the estimated effort of all the tasks which were schedule to be completed on or before 4/5/06 or BCWS = ( 10 + 15 = 25 person days) • BCWP for the date 4/5/06 is the sum of the estimated effort of all the tasks which were actually completed on or before 4/5/06 or BCWP = (10 + 15 + 25 = 50 person-days) • ACWP for the date 4/5/06 is the sum of the actual efforts expended for all the tasks that have been completed on or before 4/5/06 or ACWP = ( 10 + 25 + 20 = 55 person-days) - EV = BCWP / BAC = 50/115 = .434 or the project is estimated to be 43% complete as of 4/5/06

  21. Applying GQM • In order to apply the GQM methodology one needs to spent some time at the “Conceptual Level”: • Conceptualize the property of interest • Develop clear definitions of possible sub-attributes related to the conceptualized property • Determine if these sub-attributes can take on any numeric values --- if not then it would be difficult to get to the Quantitative Level ---- may need to re-look at the definitions and/or reconsider the sub-attributes

More Related
