Update on UAT and Parallel System Test. 10 December 2002. Contents. System Test II Timeline for setup of secondary environments Constraints and likely date for availability of environments Actions required to progress Execution plan and resource requirements for System Test II

loader
I am the owner, or an agent authorized to act on behalf of the owner, of the copyrighted work described.
capcha
Download Presentation

PowerPoint Slideshow about 'Update on UAT and Parallel System Test' - jaime-tillman


Download Now An Image/Link below is provided (as is) to download presentation

Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author.While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server.


- - - - - - - - - - - - - - - - - - - - - - - - - - E N D - - - - - - - - - - - - - - - - - - - - - - - - - -
Presentation Transcript

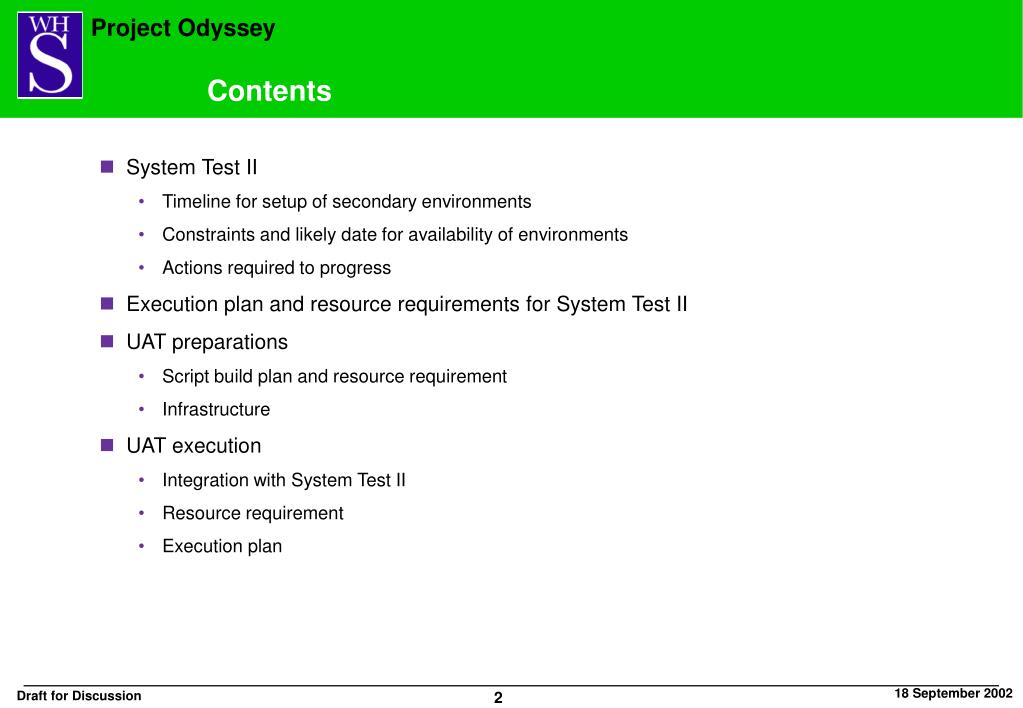

contents
Contents
  • System Test II
    • Timeline for setup of secondary environments
    • Constraints and likely date for availability of environments
    • Actions required to progress
  • Execution plan and resource requirements for System Test II
  • UAT preparations
    • Script build plan and resource requirement
    • Infrastructure
  • UAT execution
    • Integration with System Test II
    • Resource requirement
    • Execution plan

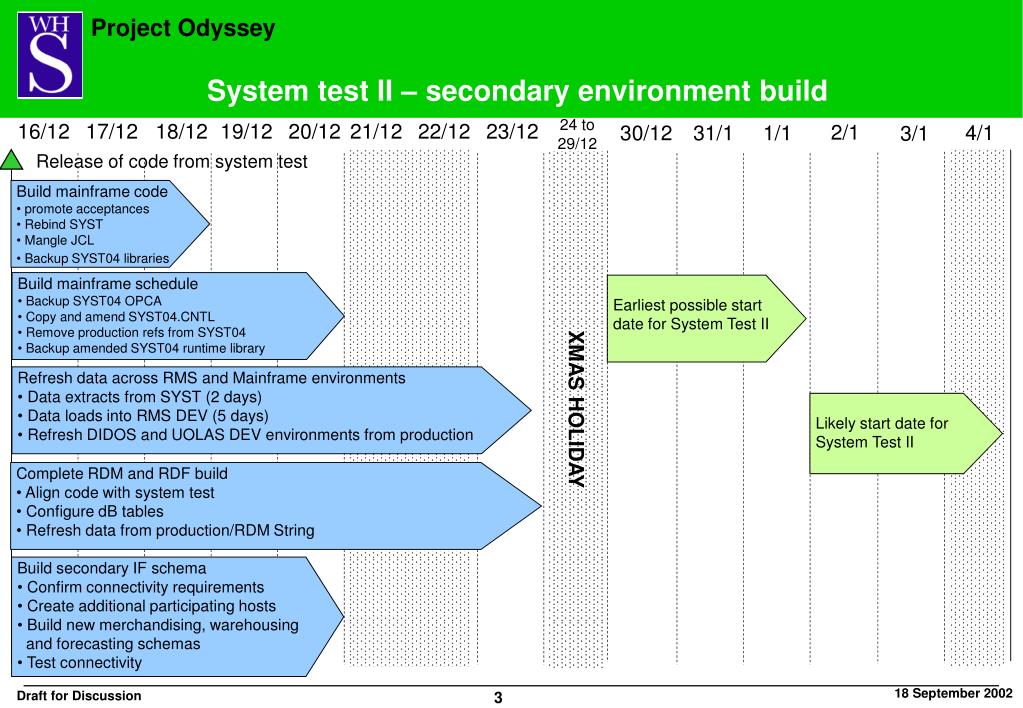

system test ii secondary environment build
System test II – secondary environment build

24 to

29/12

16/12

17/12

18/12

19/12

20/12

21/12

22/12

23/12

2/1

4/1

30/12

31/1

1/1

3/1

Release of code from system test

XMAS HOLIDAY

  • Build mainframe code
  • promote acceptances
  • Rebind SYST
  • Mangle JCL
  • Backup SYST04 libraries
  • Build mainframe schedule
  • Backup SYST04 OPCA
  • Copy and amend SYST04.CNTL
  • Remove production refs from SYST04
  • Backup amended SYST04 runtime library

Earliest possible start

date for System Test II

  • Refresh data across RMS and Mainframe environments
  • Data extracts from SYST (2 days)
  • Data loads into RMS DEV (5 days)
  • Refresh DIDOS and UOLAS DEV environments from production

Likely start date for

System Test II

  • Complete RDM and RDF build
  • Align code with system test
  • Configure dB tables
  • Refresh data from production/RDM String
  • Build secondary IF schema
  • Confirm connectivity requirements
  • Create additional participating hosts
  • Build new merchandising, warehousing
  • and forecasting schemas
  • Test connectivity

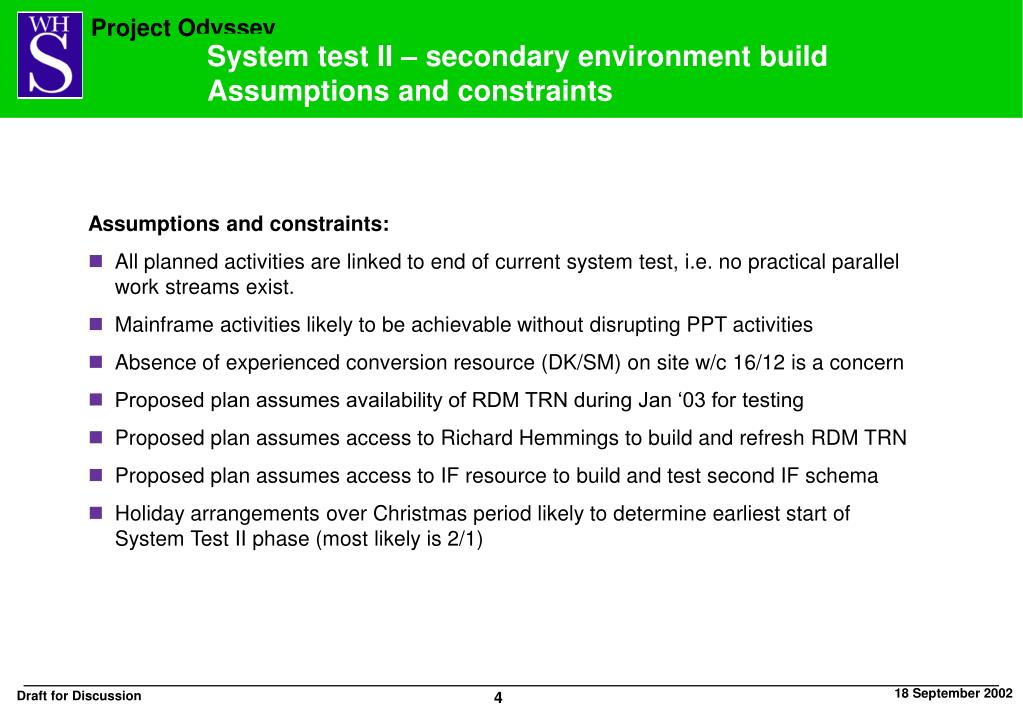

system test ii secondary environment build assumptions and constraints
System test II – secondary environment buildAssumptions and constraints

Assumptions and constraints:

  • All planned activities are linked to end of current system test, i.e. no practical parallel work streams exist.
  • Mainframe activities likely to be achievable without disrupting PPT activities
  • Absence of experienced conversion resource (DK/SM) on site w/c 16/12 is a concern
  • Proposed plan assumes availability of RDM TRN during Jan ‘03 for testing
  • Proposed plan assumes access to Richard Hemmings to build and refresh RDM TRN
  • Proposed plan assumes access to IF resource to build and test second IF schema
  • Holiday arrangements over Christmas period likely to determine earliest start of System Test II phase (most likely is 2/1)

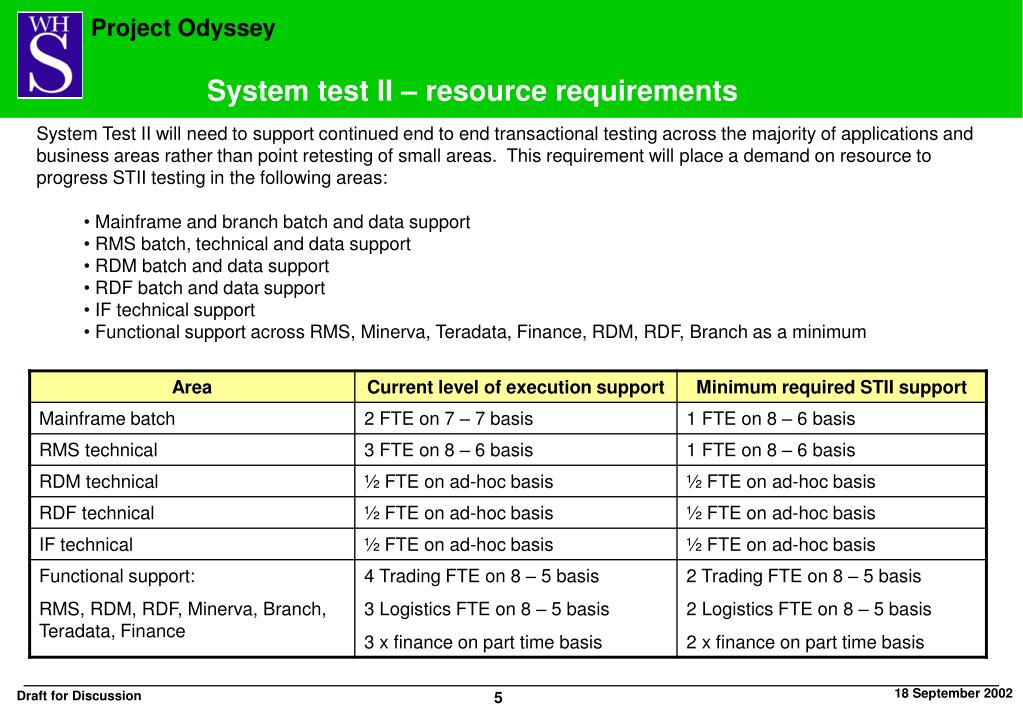

system test ii resource requirements
System test II – resource requirements
  • System Test II will need to support continued end to end transactional testing across the majority of applications and business areas rather than point retesting of small areas. This requirement will place a demand on resource to progress STII testing in the following areas:
    • Mainframe and branch batch and data support
    • RMS batch, technical and data support
    • RDM batch and data support
    • RDF batch and data support
    • IF technical support
    • Functional support across RMS, Minerva, Teradata, Finance, RDM, RDF, Branch as a minimum

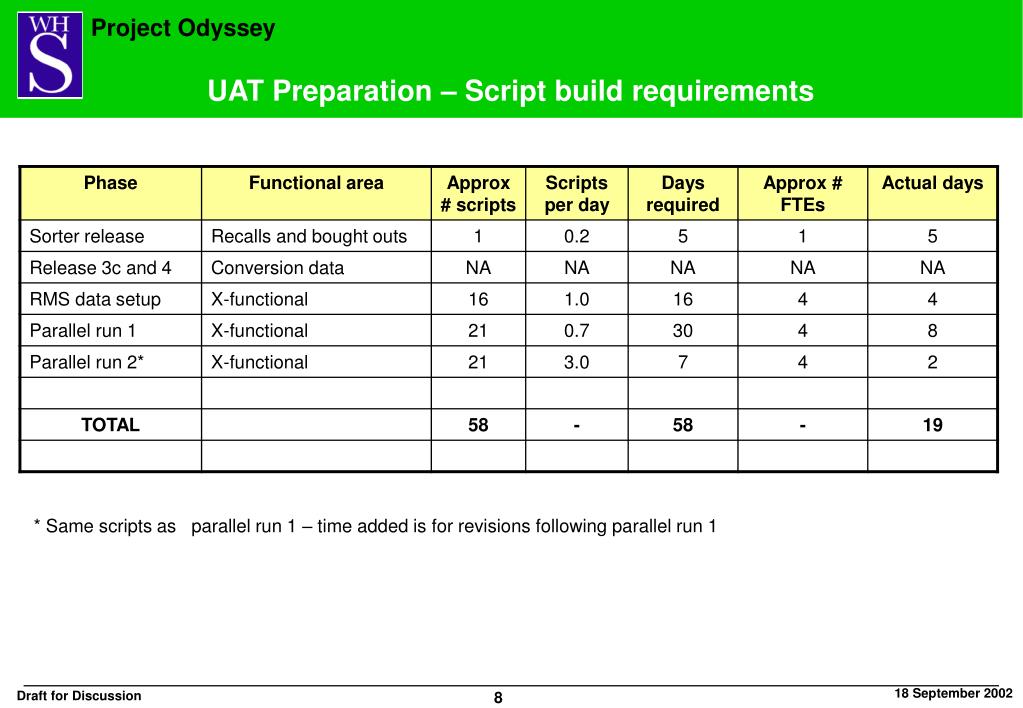

uat preparation script build requirements
UAT Preparation – Script build requirements

* Same scripts as parallel run 1 – time added is for revisions following parallel run 1

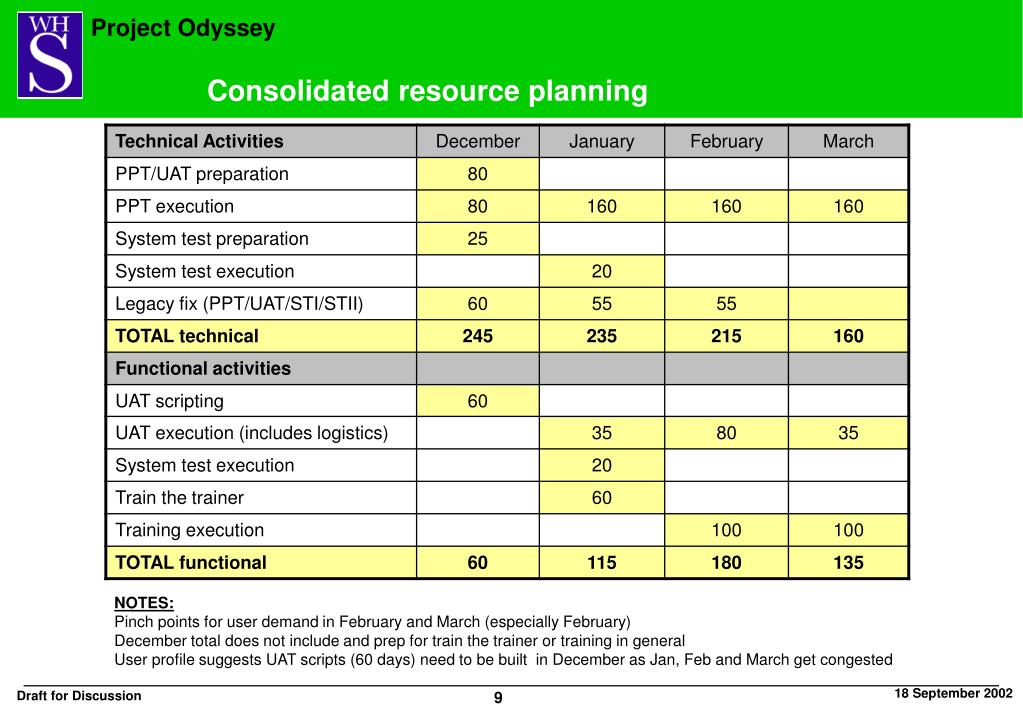

consolidated resource planning
Consolidated resource planning

NOTES:

Pinch points for user demand in February and March (especially February)

December total does not include and prep for train the trainer or training in general

User profile suggests UAT scripts (60 days) need to be built in December as Jan, Feb and March get congested
