Policy Frameworks for Shared Print Collections

The 2007 North American Storage Trust (NAST) Planning Meeting in Seattle focused on enhancing collaborative collection management among research libraries. Attendees explored strategies for developing cost-effective solutions, shared print initiatives, and new models for resource sharing. Discussions highlighted the importance of establishing policy frameworks, ensuring persistent access to materials, and addressing the challenges of de-duplication and bibliographic data. Key insights included the need for a "last copy" registry, the role of e-journals in collection management, and the importance of community partnerships.

happy
Download Presentation

Policy Frameworks for Shared Print Collections

An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript


  1. Policy Frameworks for Shared Print Collections Constance Malpas OCLC Programs & Research North American Storage Trust Planning Meeting Seattle, Washington 21 January 2007 malpasc@oclc.org

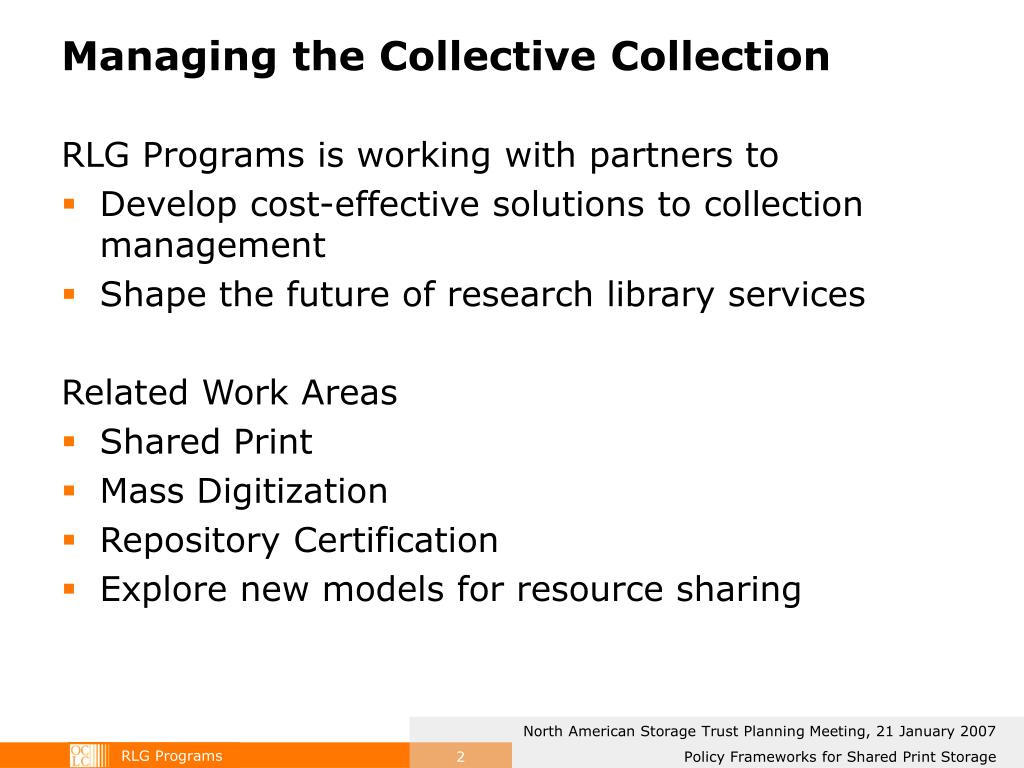

  2. Managing the Collective Collection RLG Programs is working with partners to • Develop cost-effective solutions to collection management • Shape the future of research library services Related Work Areas • Shared Print • Mass Digitization • Repository Certification • Explore new models for resource sharing

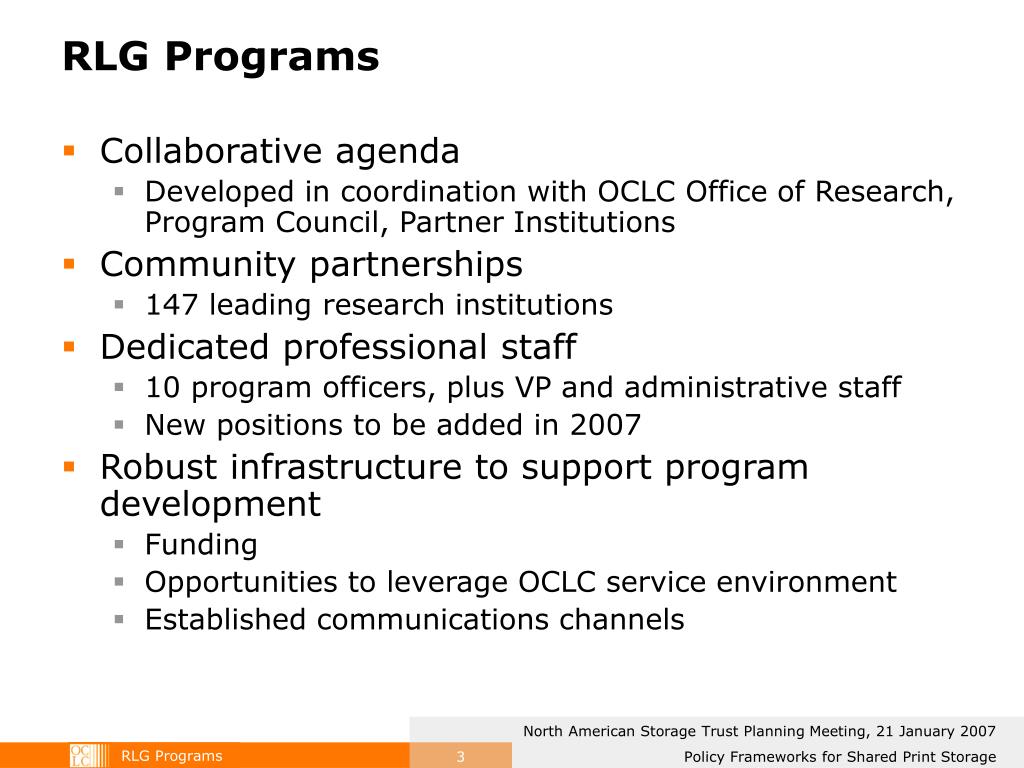

  3. RLG Programs • Collaborative agenda • Developed in coordination with OCLC Office of Research, Program Council, Partner Institutions • Community partnerships • 147 leading research institutions • Dedicated professional staff • 10 program officers, plus VP and administrative staff • New positions to be added in 2007 • Robust infrastructure to support program development • Funding • Opportunities to leverage OCLC service environment • Established communications channels

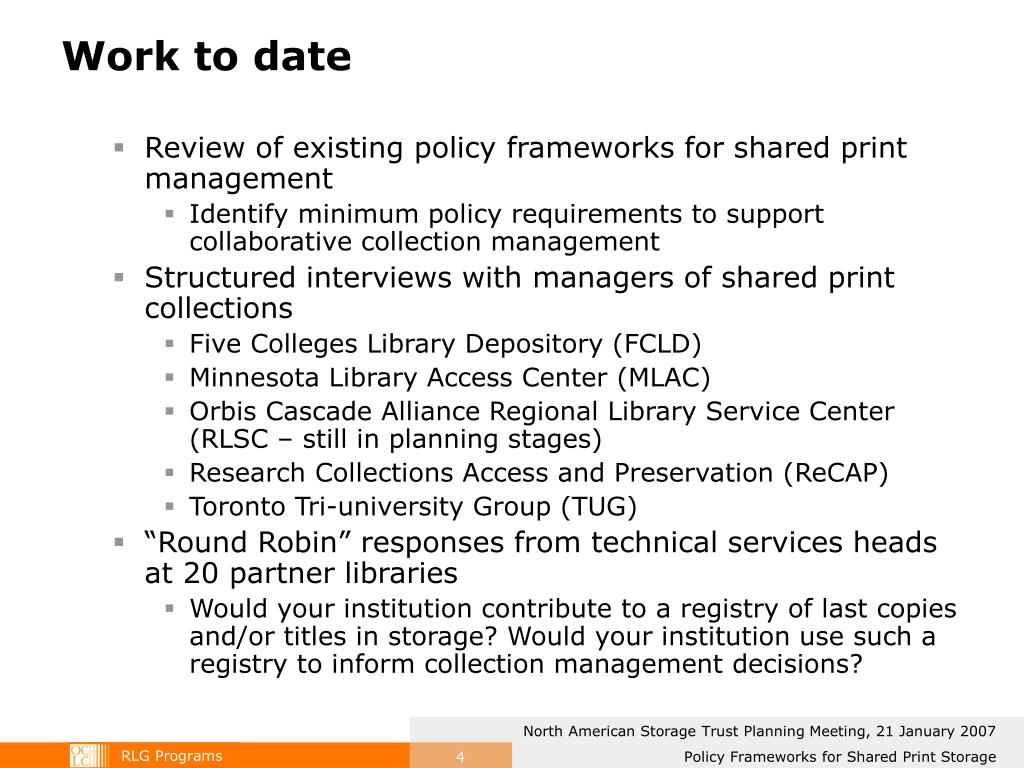

  4. Work to date • Review of existing policy frameworks for shared print management • Identify minimum policy requirements to support collaborative collection management • Structured interviews with managers of shared print collections • Five Colleges Library Depository (FCLD) • Minnesota Library Access Center (MLAC) • Orbis Cascade Alliance Regional Library Service Center (RLSC – still in planning stages) • Research Collections Access and Preservation (ReCAP) • Toronto Tri-university Group (TUG) • “Round Robin” responses from technical services heads at 20 partner libraries • Would your institution contribute to a registry of last copies and/or titles in storage? Would your institution use such a registry to inform collection management decisions?

  5. Preliminary Findings • Overwhelming support for “last copy” registry • Opportunity costs of maintaining institutional print collections are prohibitive • E-journals and JSTOR have fundamentally altered value proposition of collaborative collection management • Concerns about costs/benefits of de-duplication, especially for monographic titles • Sparse bibliographic data  spurious measure of uniqueness • Differing definitions of core collection • Ownership vs. access • Robust discovery/delivery system with high level of patron satisfaction are a critical component: need to overcome faculty and selector inhibitions to de-accession • Title counts are a “red herring” – but still a persistent concern for institutions large and small

  6. Are Research Libraries Ready to Share? • “We are very interested in the concept of coordination of efforts around shared storage” (University of Michigan) • “We are concerned that libraries may decide to withdraw local copies unless there is a “persistence” policy so that we can really depend upon one another. Another concern is that larger libraries will bear most of the burden” (UC Berkeley) • “We would be interested in exploring this; need a tool to evaluate collection strengths of various institutions by subject area, language, date and place of publication” (University of Pennsylvania) • “We would certainly want access to information about the condition of the materials, assurance of long-term access, availability of ILL services” (University of Chicago) • “We are interested to explore this idea … might choose to de-dup (or even retain multiple copies) if usage data were available; might make joint decisions about digitization based on shared collection strengths” (NYPL)

  7. Current Policy Frameworks • Documentation to support collaborative management is relatively sparse • Collection development and retention policies • Model workflows • Best practices • Tacit agreements prevail • Provide desired flexibility in an uncertain environment • “Last Copy” agreements are the exception • JSTOR archives • Gov’t docs • Competing institutional interests thwart policy formulation • Provosts and access managers see benefits of institutional collection sharing • Collection development managers less sanguine – professional self-preservation, faculty reprisals • Need to quantify benefits of collection sharing, create new incentives

  8. Initial Recommendations • Build on existing frameworks • CRL Distributed Print Archive • UK Research Reserve • Embrace acceptable minimums: inspire confidence in collective management without imposing onerous participation requirements • Data contribution: maximize return on existing data sources and workflows • Preservation commitments: realistic and transparent • Lending agreements: leverage existing networks • Seek continuing community input & participation • NAST Advisory Board • Working Groups • Early Implementers

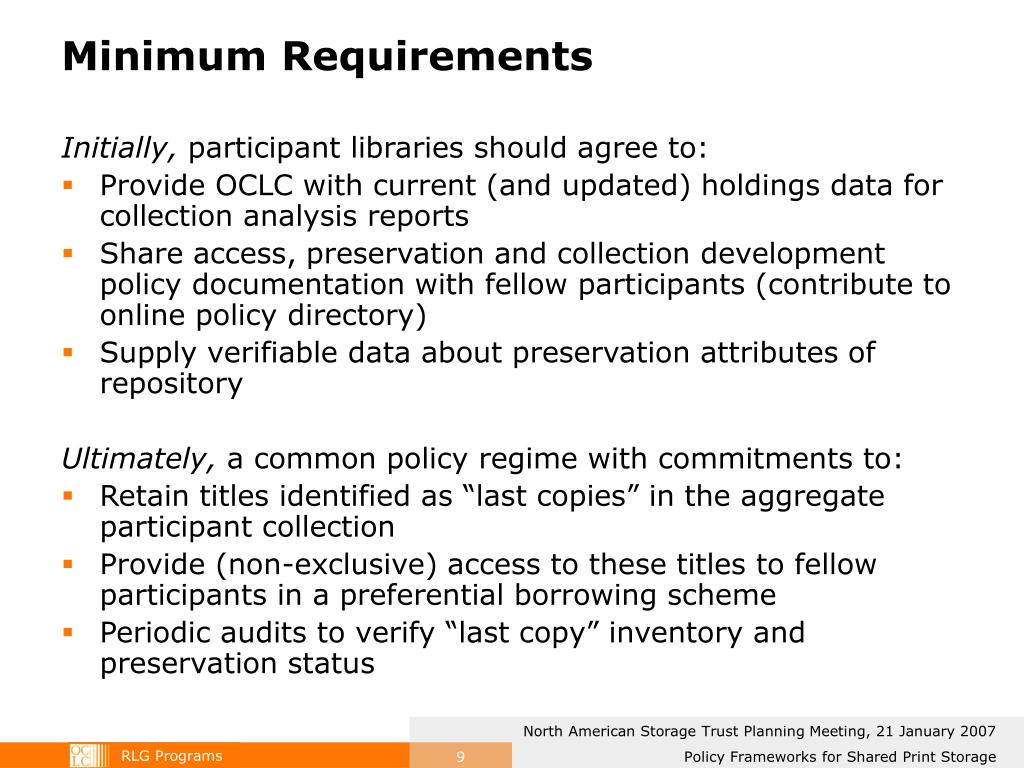

  9. Minimum Requirements Initially, participant libraries should agree to: • Provide OCLC with current (and updated) holdings data for collection analysis reports • Share access, preservation and collection development policy documentation with fellow participants (contribute to online policy directory) • Supply verifiable data about preservation attributes of repository Ultimately, a common policy regime with commitments to: • Retain titles identified as “last copies” in the aggregate participant collection • Provide (non-exclusive) access to these titles to fellow participants in a preferential borrowing scheme • Periodic audits to verify “last copy” inventory and preservation status

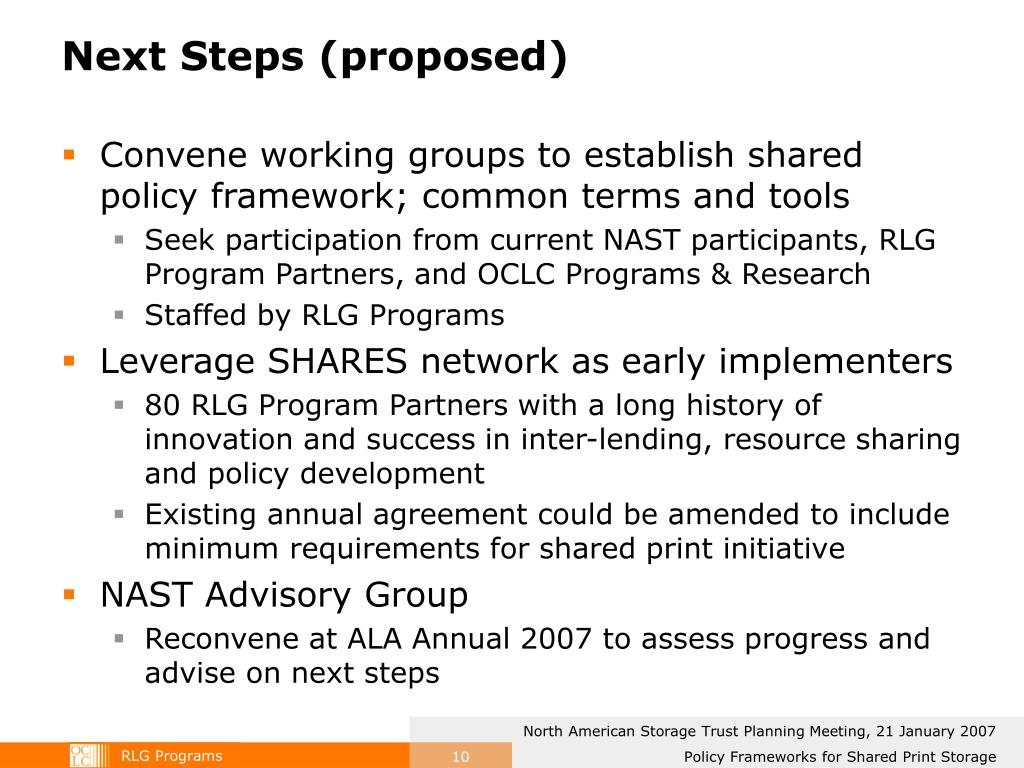

  10. Next Steps (proposed) • Convene working groups to establish shared policy framework; common terms and tools • Seek participation from current NAST participants, RLG Program Partners, and OCLC Programs & Research • Staffed by RLG Programs • Leverage SHARES network as early implementers • 80 RLG Program Partners with a long history of innovation and success in inter-lending, resource sharing and policy development • Existing annual agreement could be amended to include minimum requirements for shared print initiative • NAST Advisory Group • Reconvene at ALA Annual 2007 to assess progress and advise on next steps

  11. Working Groups (proposed) • Model documents - policies and workflows • Collate existing policy documentation; identify gaps • Model “best practice” workflows for de-duplication of shared print collections; collaborative collection development (selection/acquisition of local holdings) • Terminology • Establish shared vocabulary for shared print management (last copies, etc) • Registry data requirements • Identify existing sources (LHRs etc); opportunities to leverage existing data-loading workflows • Quantify benefits of collection sharing • Work with ARL New Measures to promote alternative indicators of library leadership; draft statement for community endorsement

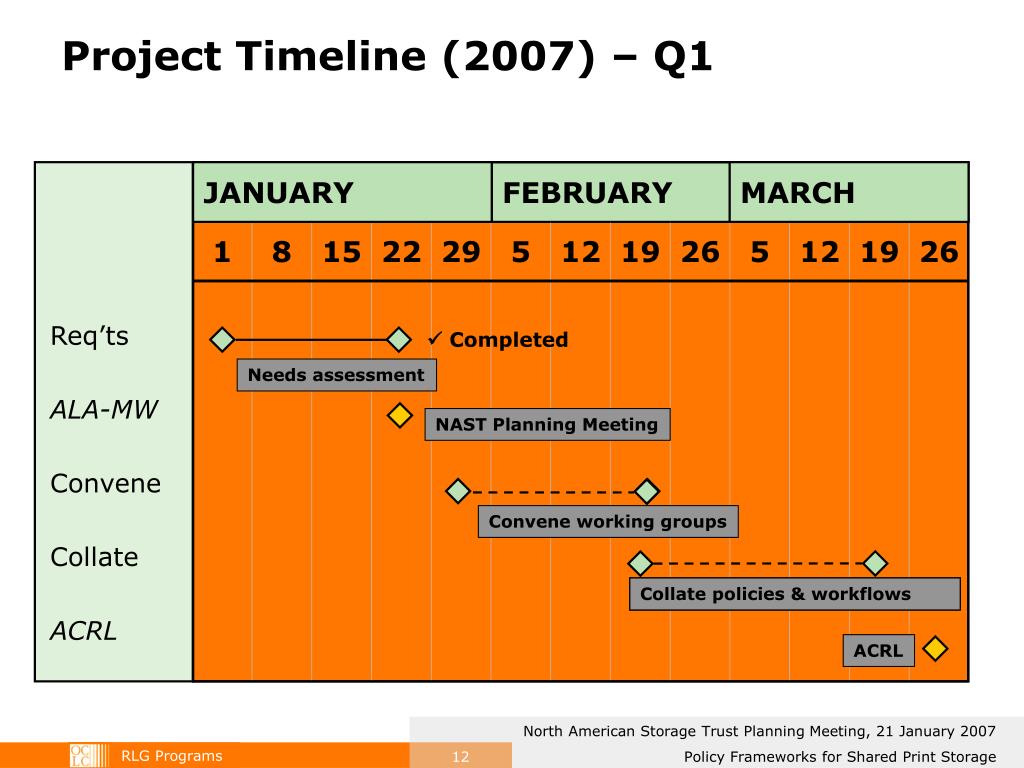

  12. Project Timeline (2007) – Q1 Req’ts ALA-MW Convene Collate ACRL JANUARY FEBRUARY MARCH 1 8 15 22 29 5 12 19 26 5 12 19 26  Completed Needs assessment NAST Planning Meeting Convene working groups Collate policies & workflows ACRL

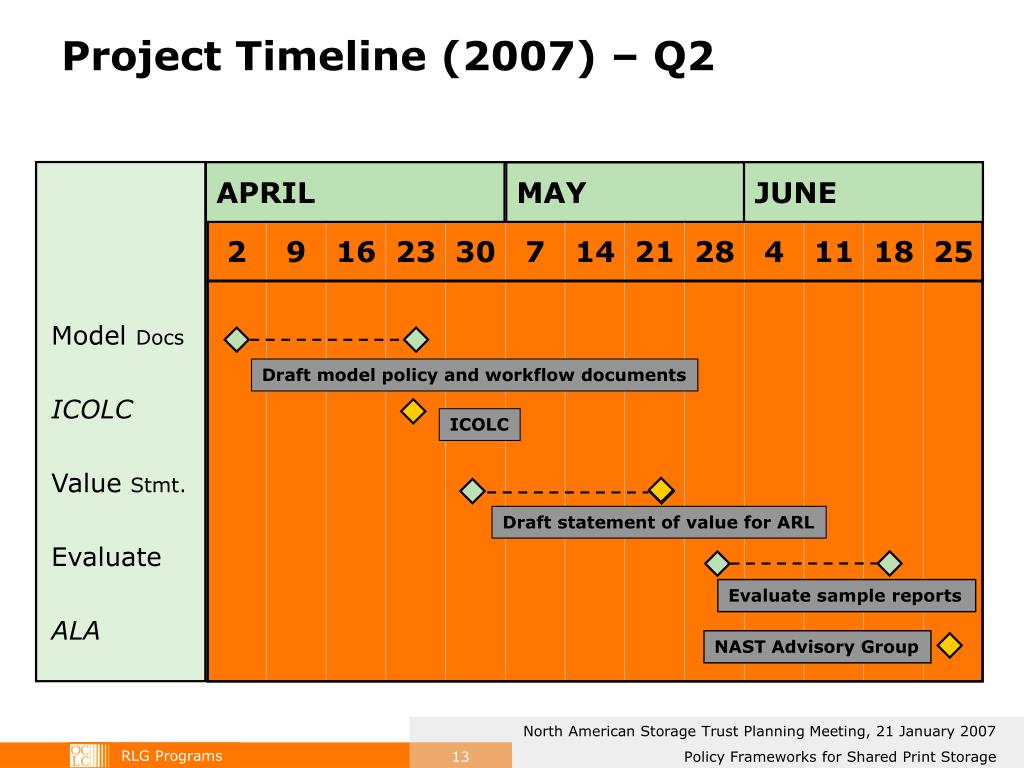

  13. Project Timeline (2007) – Q2 Model Docs ICOLC Value Stmt. Evaluate ALA APRIL MAY JUNE 2 9 16 23 30 7 14 21 28 4 11 18 25 Draft model policy and workflow documents ICOLC Draft statement of value for ARL Evaluate sample reports NAST Advisory Group

  14. Questions? Comments? Constance Malpas malpasc@oclc.org 650-691-2207
