Task 2.3 Operations Report . Pedro Henrique Rausch Bello Leader of Task 2.3 Instituto de Física - UFRJ Second Latin American EELA Workshop Itacuruçá, 24.06.2006. Task 2.3 Status – WS1. Pilot Testbed Operational (7 sites) Started implementation of User Support System UFRJ Roc Site

loader
I am the owner, or an agent authorized to act on behalf of the owner, of the copyrighted work described.
capcha
Download Presentation

PowerPoint Slideshow about 'Task 2.3 Operations Report' - barbra


An Image/Link below is provided (as is) to download presentation

Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author.While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server.


- - - - - - - - - - - - - - - - - - - - - - - - - - E N D - - - - - - - - - - - - - - - - - - - - - - - - - -
Presentation Transcript
task 2 3 operations report

Task 2.3 Operations Report

Pedro Henrique Rausch Bello

Leader of Task 2.3

Instituto de Física - UFRJ

Second Latin American EELA Workshop

Itacuruçá, 24.06.2006

task 2 3 status ws1

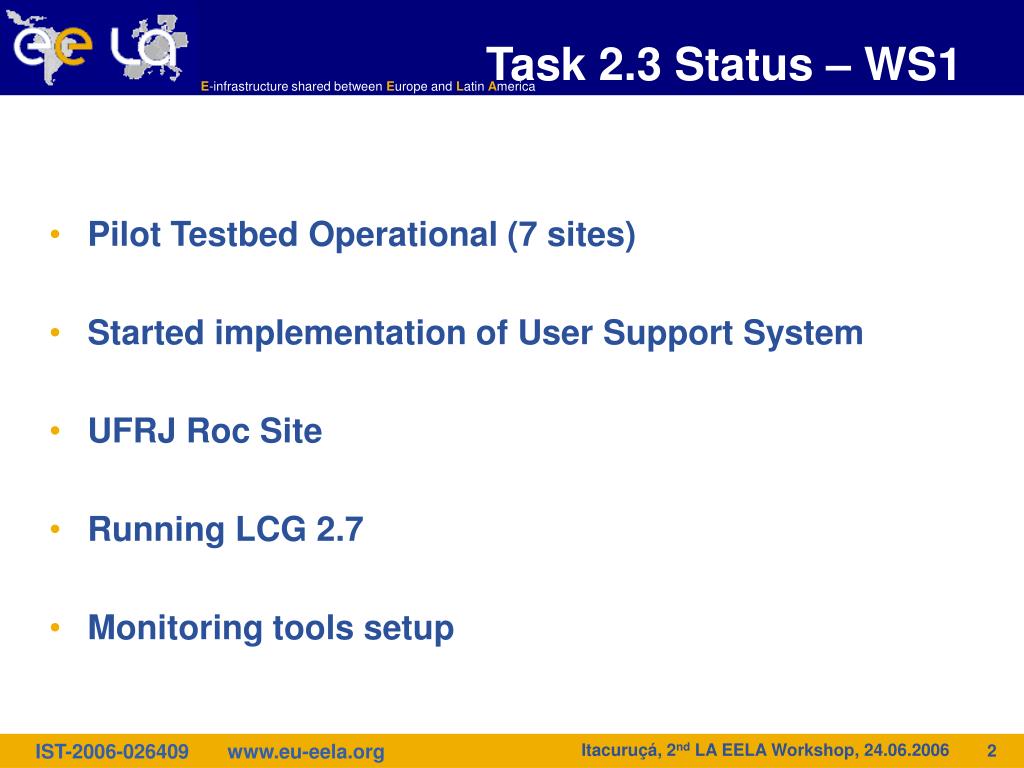

Task 2.3 Status – WS1
  • Pilot Testbed Operational (7 sites)
  • Started implementation of User Support System
  • UFRJ Roc Site
  • Running LCG 2.7
  • Monitoring tools setup

Itacuruçá, 2nd LA EELA Workshop, 24.06.2006

eu lac meeting

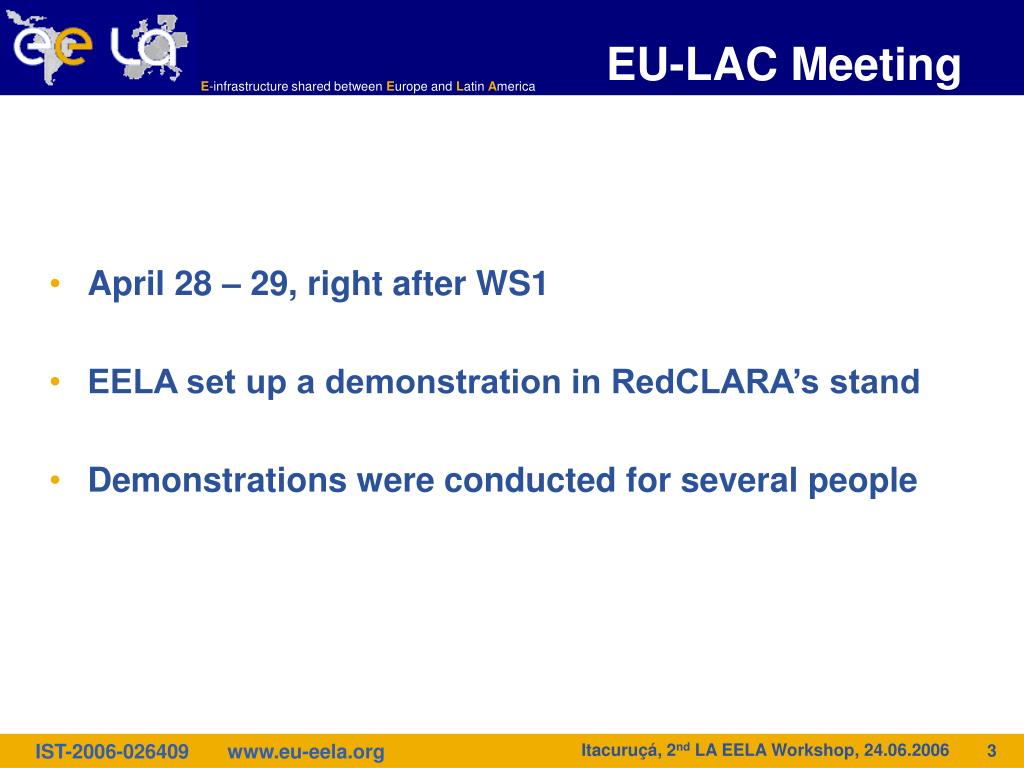

EU-LAC Meeting
  • April 28 – 29, right after WS1
  • EELA set up a demonstration in RedCLARA’s stand
  • Demonstrations were conducted for several people

Itacuruçá, 2nd LA EELA Workshop, 24.06.2006

pilot testbed status during ws1

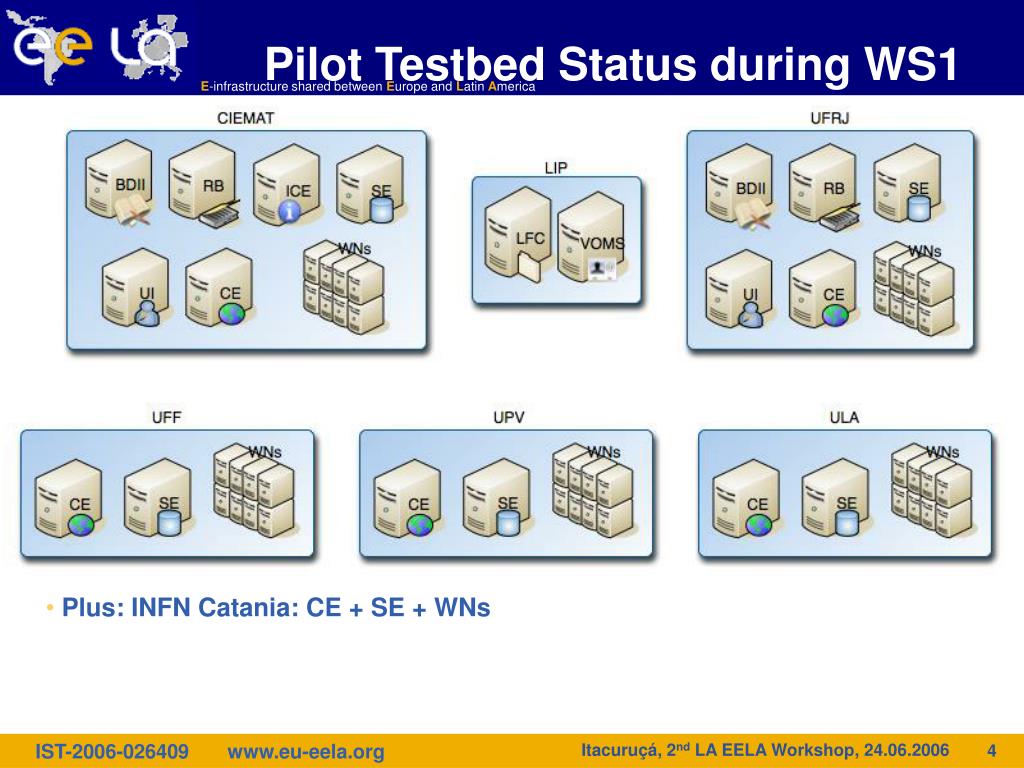

Pilot Testbed Status during WS1

Plus: INFN Catania: CE + SE + WNs

Itacuruçá, 2nd LA EELA Workshop, 24.06.2006

pilot testbed present status 1

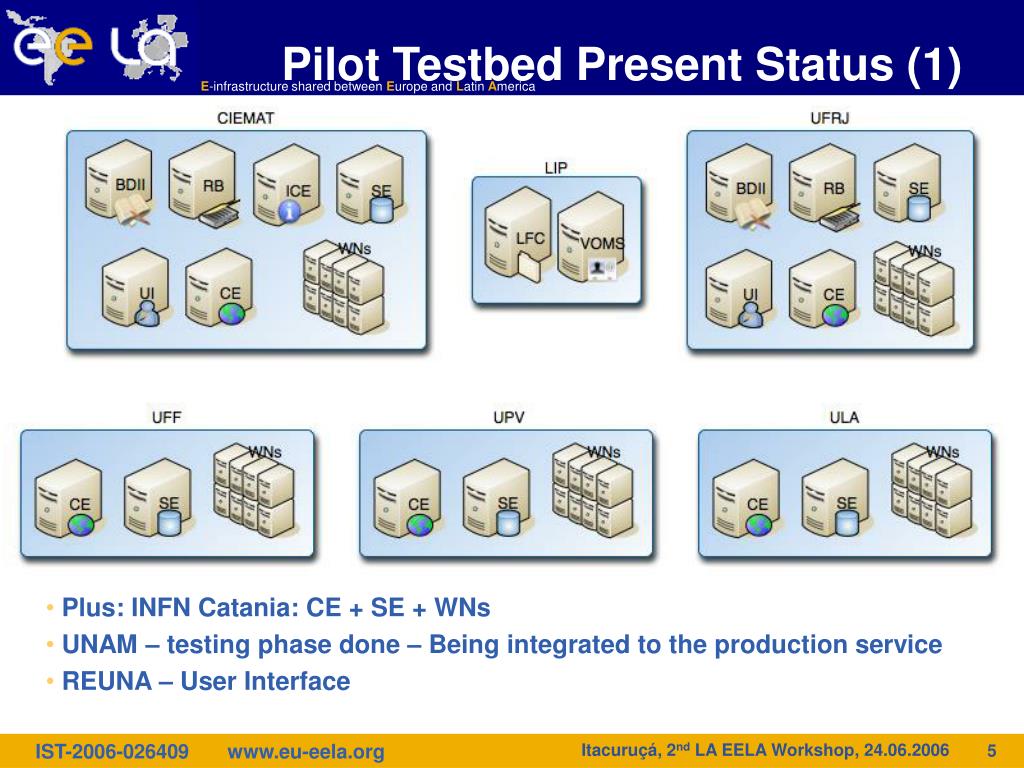

Pilot Testbed Present Status (1)

Plus: INFN Catania: CE + SE + WNs

UNAM – testing phase done – Being integrated to the production service

REUNA – User Interface

Itacuruçá, 2nd LA EELA Workshop, 24.06.2006

pilot testbed present status 2

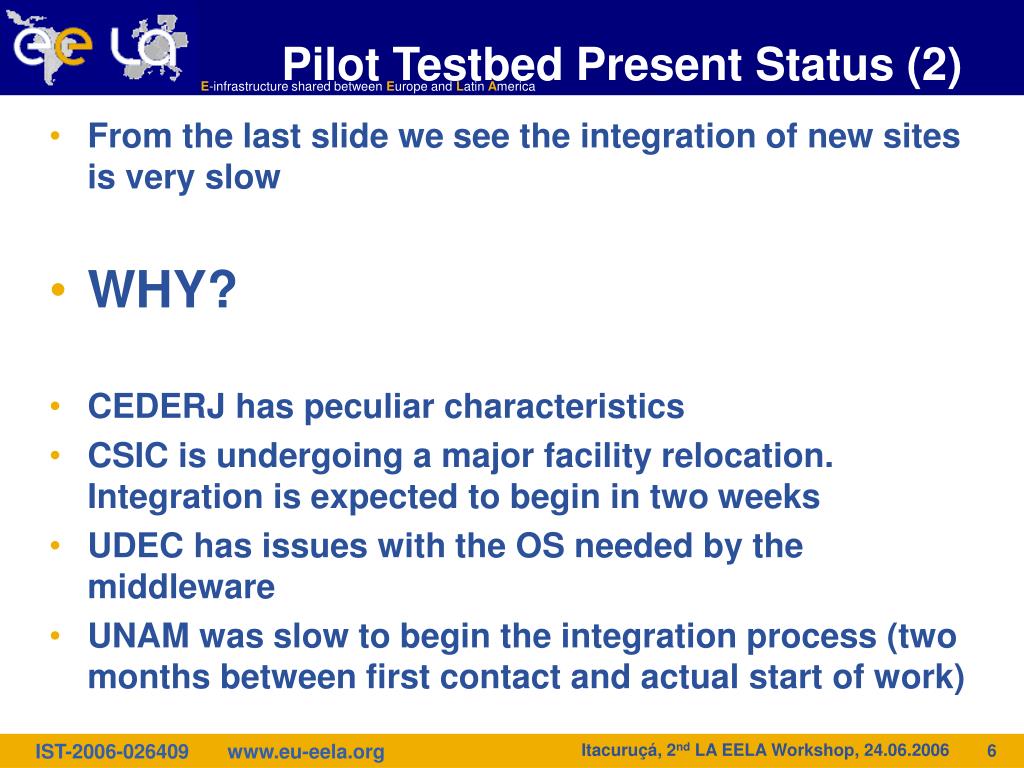

Pilot Testbed Present Status (2)
  • From the last slide we see the integration of new sites is very slow
  • WHY?
  • CEDERJ has peculiar characteristics
  • CSIC is undergoing a major facility relocation. Integration is expected to begin in two weeks
  • UDEC has issues with the OS needed by the middleware
  • UNAM was slow to begin the integration process (two months between first contact and actual start of work)

Itacuruçá, 2nd LA EELA Workshop, 24.06.2006

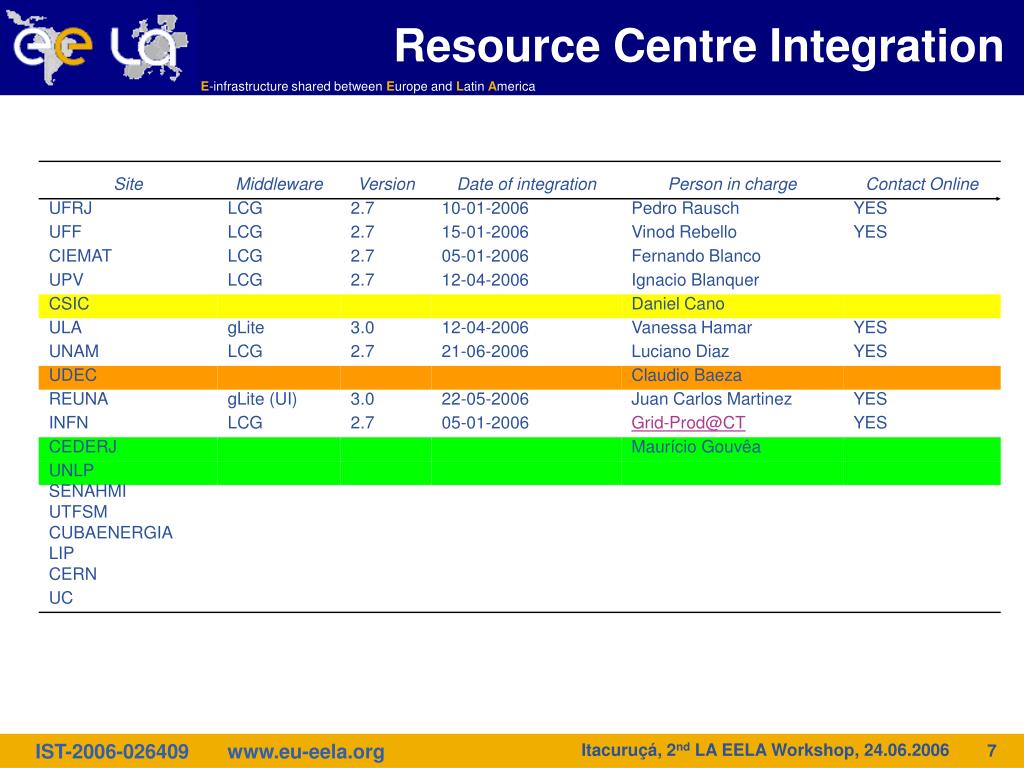

resource centre integration
Resource Centre Integration

Itacuruçá, 2nd LA EELA Workshop, 24.06.2006

rc integration process 1
RC Integration Process (1)
  • The Procedure for integration of a new RC is simple:
  • The Site manager contacts the Task 2.3 Leader (Pedro Rausch – rausch@if.ufrj.br) announcing the desire to integrate his resources:
  • The following information MUST be sent:
    • Description of Hardware Resources
    • Network Address (not individual hosts!!)
    • If the site is willing to run jobs from VOs other than EELA (such as HEP and BIOMED)
  • T2.3 Leader sends a proposed installation plan – in the case of new sites, or an acceptance notice for inclusion in the case of already running sites

Itacuruçá, 2nd LA EELA Workshop, 24.06.2006

rc integration process 2

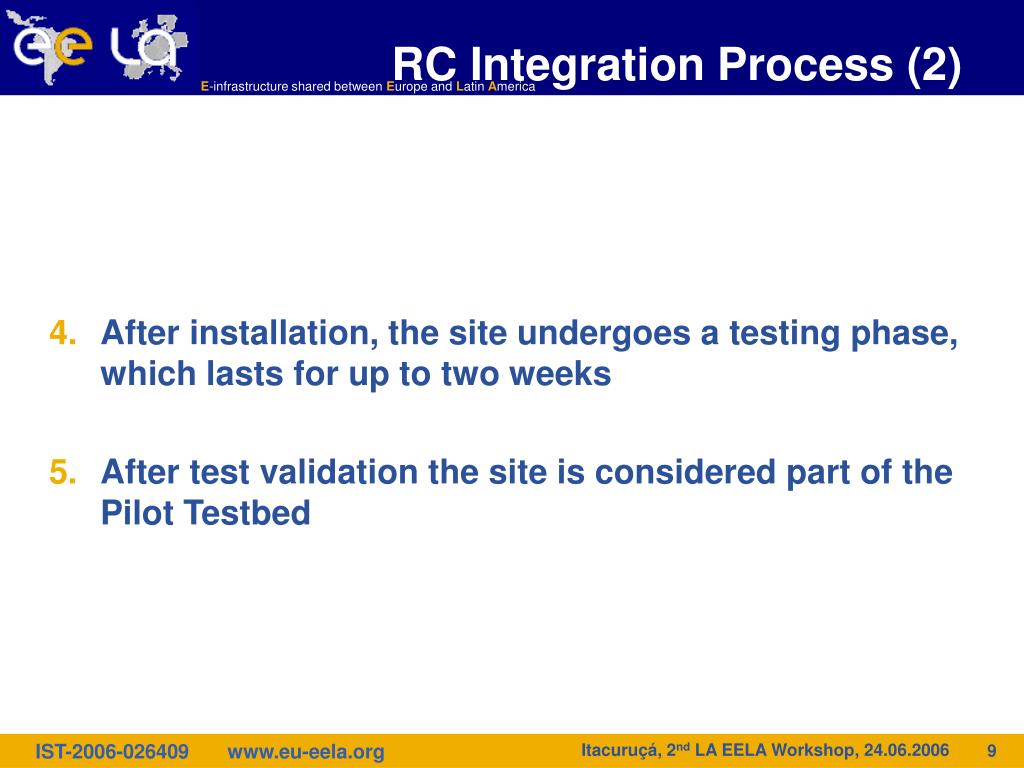

RC Integration Process (2)
  • After installation, the site undergoes a testing phase, which lasts for up to two weeks
  • After test validation the site is considered part of the Pilot Testbed

Itacuruçá, 2nd LA EELA Workshop, 24.06.2006

user support system
User Support System
  • Fully operational – http://support.eu-eela.org/
  • Enlisted support personnel is urged to check it regularly

Itacuruçá, 2nd LA EELA Workshop, 24.06.2006

middleware upgrade plan

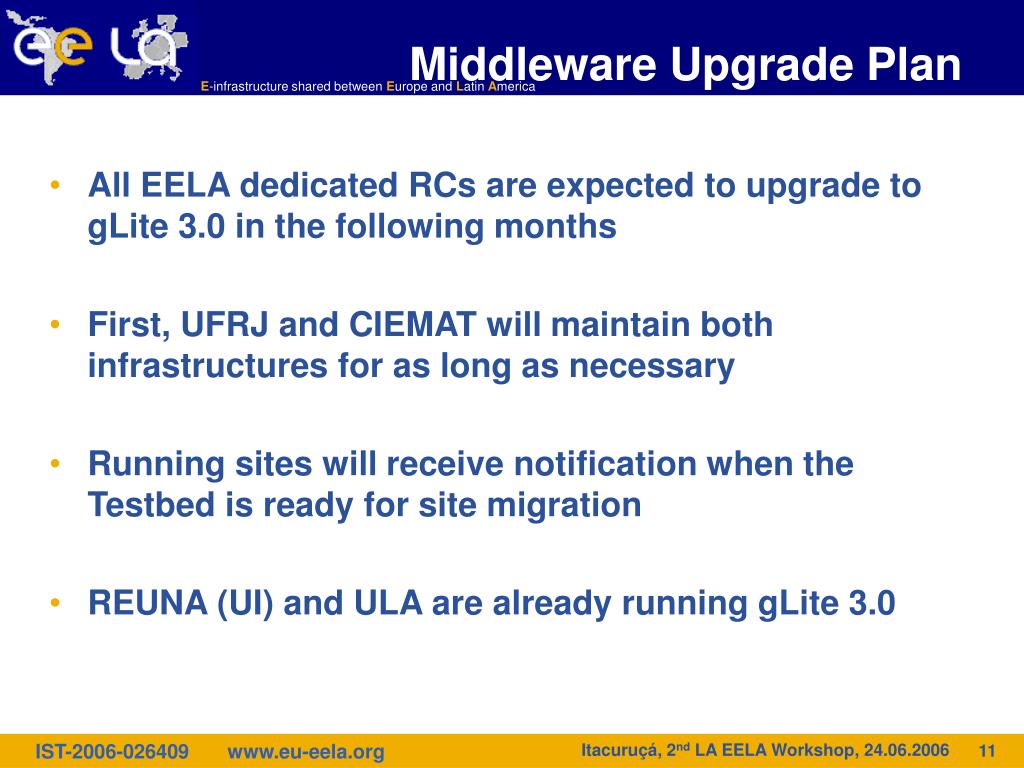

Middleware Upgrade Plan
  • All EELA dedicated RCs are expected to upgrade to gLite 3.0 in the following months
  • First, UFRJ and CIEMAT will maintain both infrastructures for as long as necessary
  • Running sites will receive notification when the Testbed is ready for site migration
  • REUNA (UI) and ULA are already running gLite 3.0

Itacuruçá, 2nd LA EELA Workshop, 24.06.2006

lhcb integration status

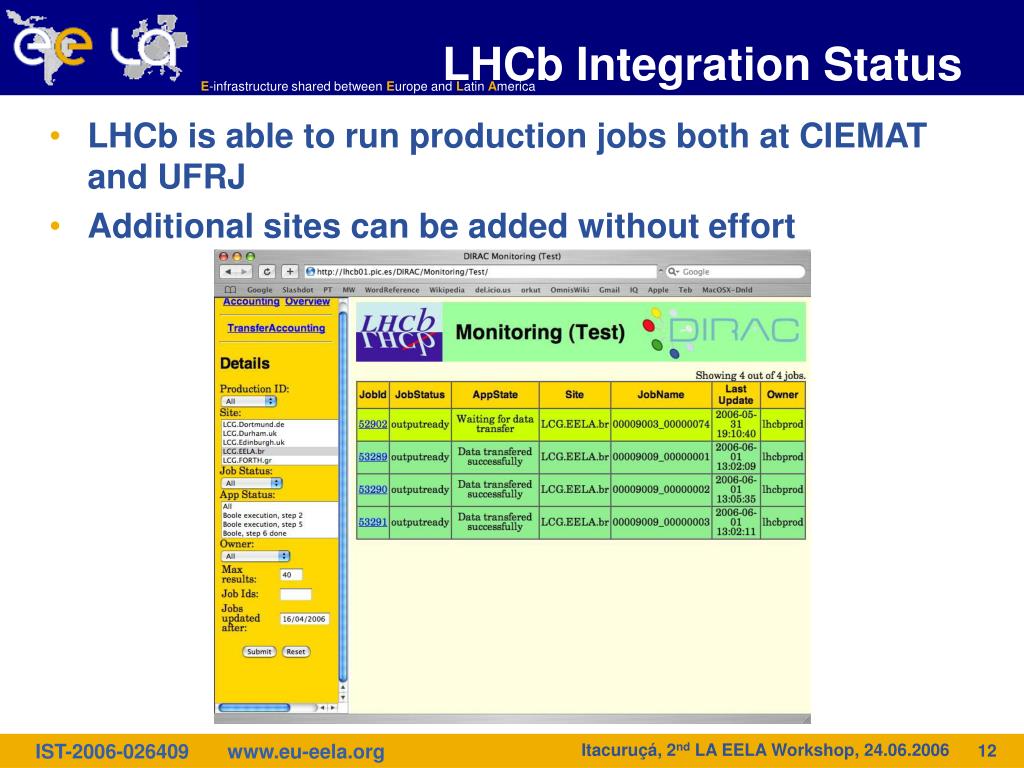

LHCb Integration Status
  • LHCb is able to run production jobs both at CIEMAT and UFRJ
  • Additional sites can be added without effort

Itacuruçá, 2nd LA EELA Workshop, 24.06.2006

alice integration status

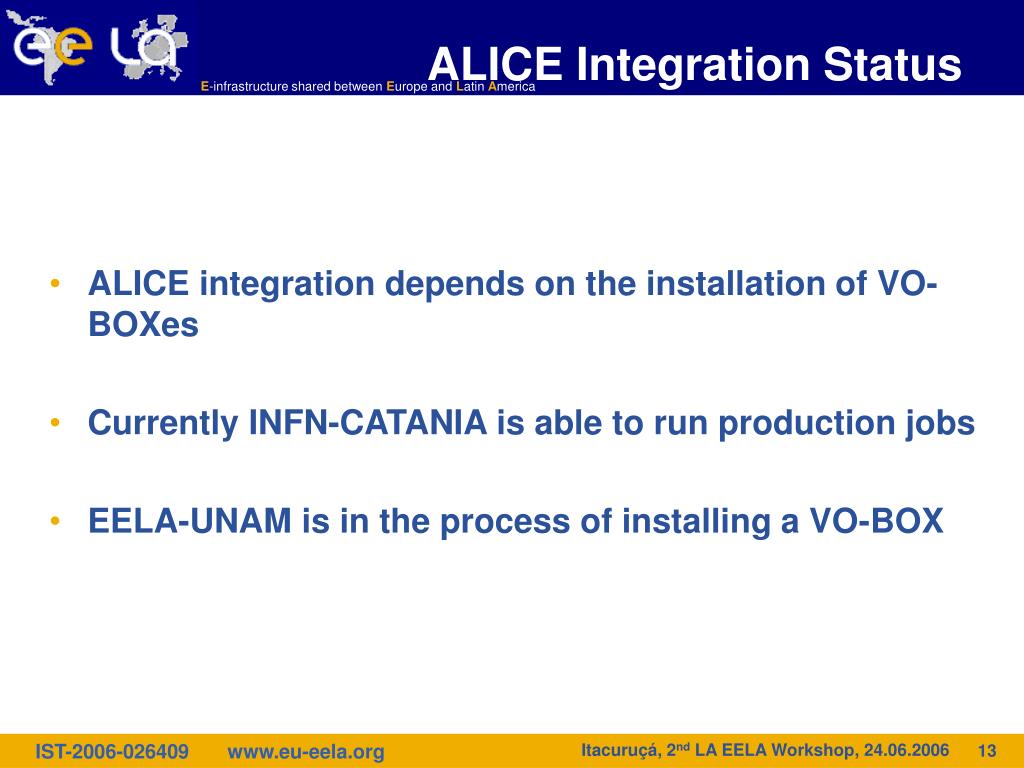

ALICE Integration Status
  • ALICE integration depends on the installation of VO-BOXes
  • Currently INFN-CATANIA is able to run production jobs
  • EELA-UNAM is in the process of installing a VO-BOX

Itacuruçá, 2nd LA EELA Workshop, 24.06.2006

security 1

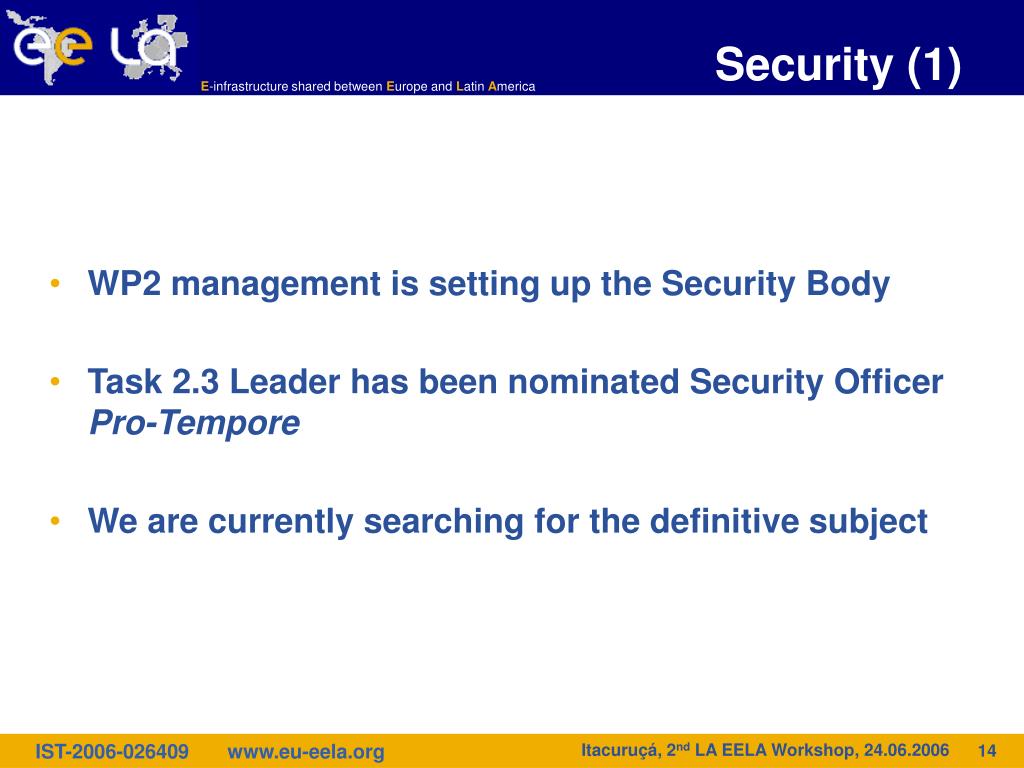

Security (1)
  • WP2 management is setting up the Security Body
  • Task 2.3 Leader has been nominated Security Officer Pro-Tempore
  • We are currently searching for the definitive subject

Itacuruçá, 2nd LA EELA Workshop, 24.06.2006

security 2
Security (2)
  • Site level security is a difficult subject
  • Trying to define a minimum denominator
  • We have to profit from the size of the pilot Testbed, and the well known relationship between sites
  • Some sort of automation is in the works

Itacuruçá, 2nd LA EELA Workshop, 24.06.2006

monitoring 1
Monitoring (1)
  • Currently running tools:
    • GridICE
    • GSTAT
    • Real Time Monitor
  • Waiting deployment:
    • Site Functional Tests

Itacuruçá, 2nd LA EELA Workshop, 24.06.2006

monitoring 2
Monitoring (2)
  • WP2 needs to set up a distributed monitoring team in order to alleviate some sites and provide a larger time coverage – Grid Operator on Duty
  • Will begin searching for candidates soon

Itacuruçá, 2nd LA EELA Workshop, 24.06.2006

eela middleware description
EELA Middleware – Description
  • Consists of all additions to standard middleware + EELA specific applications
  • Provides a well defined release schedule, facilitating RC planning
  • Assures that software installed is installed on sites in a homogeneous manner

Itacuruçá, 2nd LA EELA Workshop, 24.06.2006

eela middleware planning

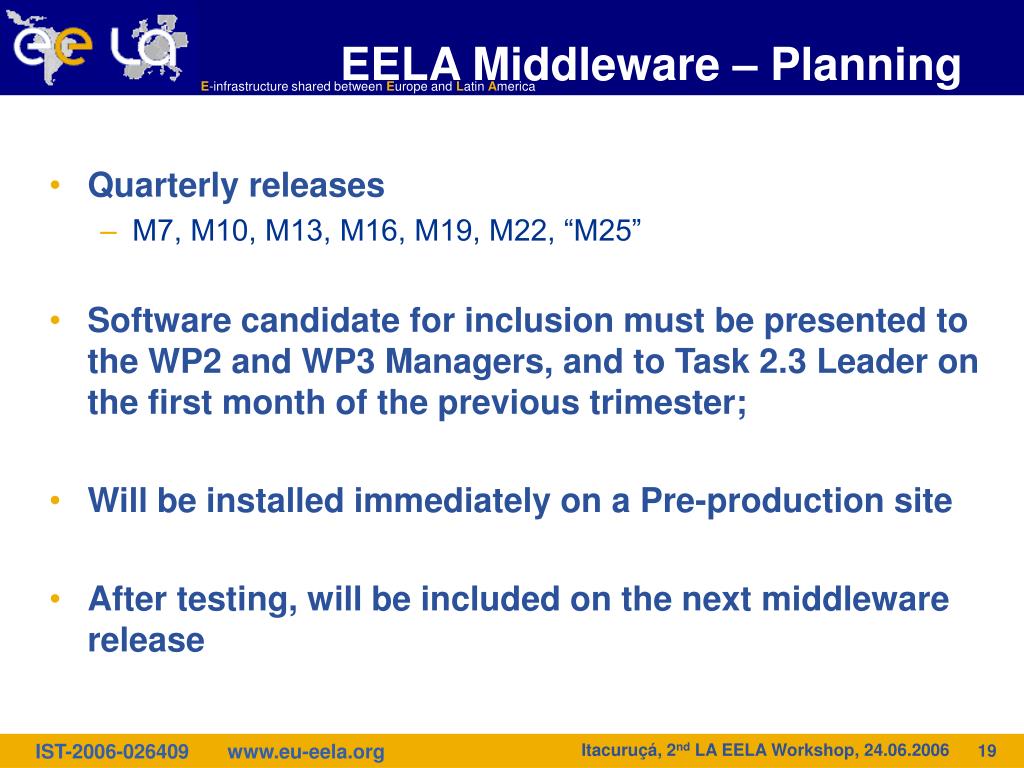

EELA Middleware – Planning
  • Quarterly releases
    • M7, M10, M13, M16, M19, M22, “M25”
  • Software candidate for inclusion must be presented to the WP2 and WP3 Managers, and to Task 2.3 Leader on the first month of the previous trimester;
  • Will be installed immediately on a Pre-production site
  • After testing, will be included on the next middleware release

Itacuruçá, 2nd LA EELA Workshop, 24.06.2006

eela pre production testbed
EELA Pre-Production Testbed
  • A pre-production service will be deployed on selected sites
  • This service will be used for the testing of applications candidate for inclusion on EELA’s middleware releases

Itacuruçá, 2nd LA EELA Workshop, 24.06.2006

operations meeting
Operations Meeting
  • Task 2.3 needs to set up an operations meeting with ALL personnel responsible for the running of EELA Resource Centres
  • SKYPE will be used as communication media
  • Small individual meetings every other week
  • Group meetings as needs dictate

Itacuruçá, 2nd LA EELA Workshop, 24.06.2006

mailing lists
Mailing Lists
  • Resource Centre personnel must subscribe to:
  • allmembers;
  • wp2;
  • task2.3;
  • grid-prod;  Do’t forget this one!!!!

Itacuruçá, 2nd LA EELA Workshop, 24.06.2006

task 2 3 action review 1

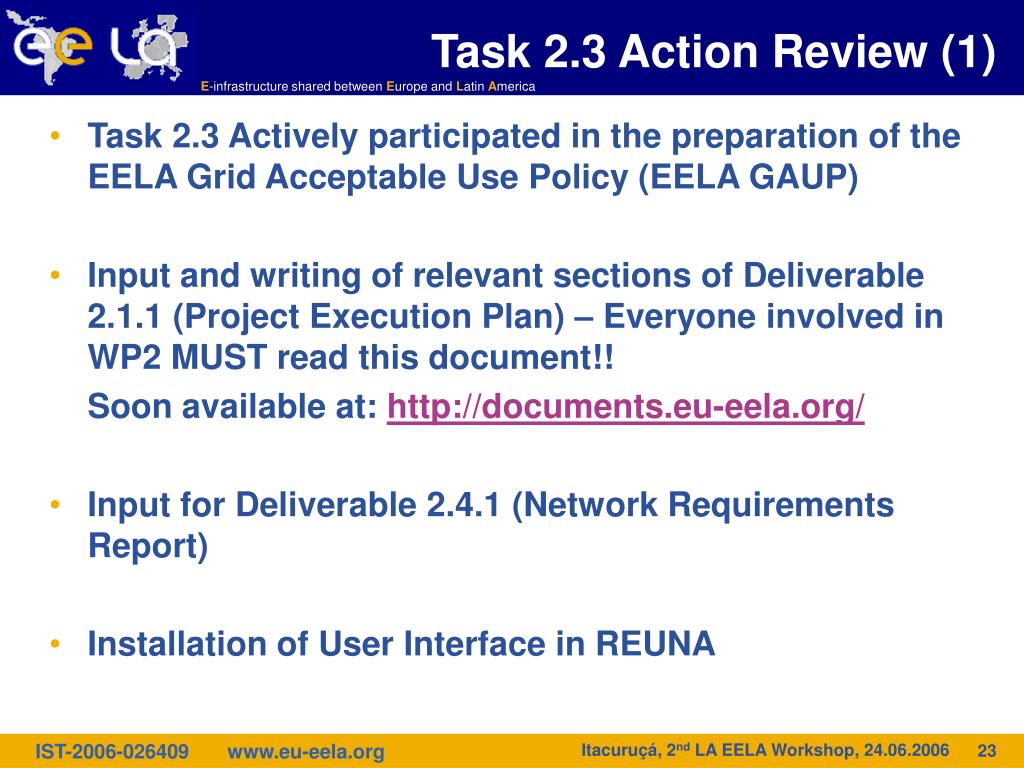

Task 2.3 Action Review (1)
  • Task 2.3 Actively participated in the preparation of the EELA Grid Acceptable Use Policy (EELA GAUP)
  • Input and writing of relevant sections of Deliverable 2.1.1 (Project Execution Plan) – Everyone involved in WP2 MUST read this document!!

Soon available at: http://documents.eu-eela.org/

  • Input for Deliverable 2.4.1 (Network Requirements Report)
  • Installation of User Interface in REUNA

Itacuruçá, 2nd LA EELA Workshop, 24.06.2006

task 2 3 action review 2

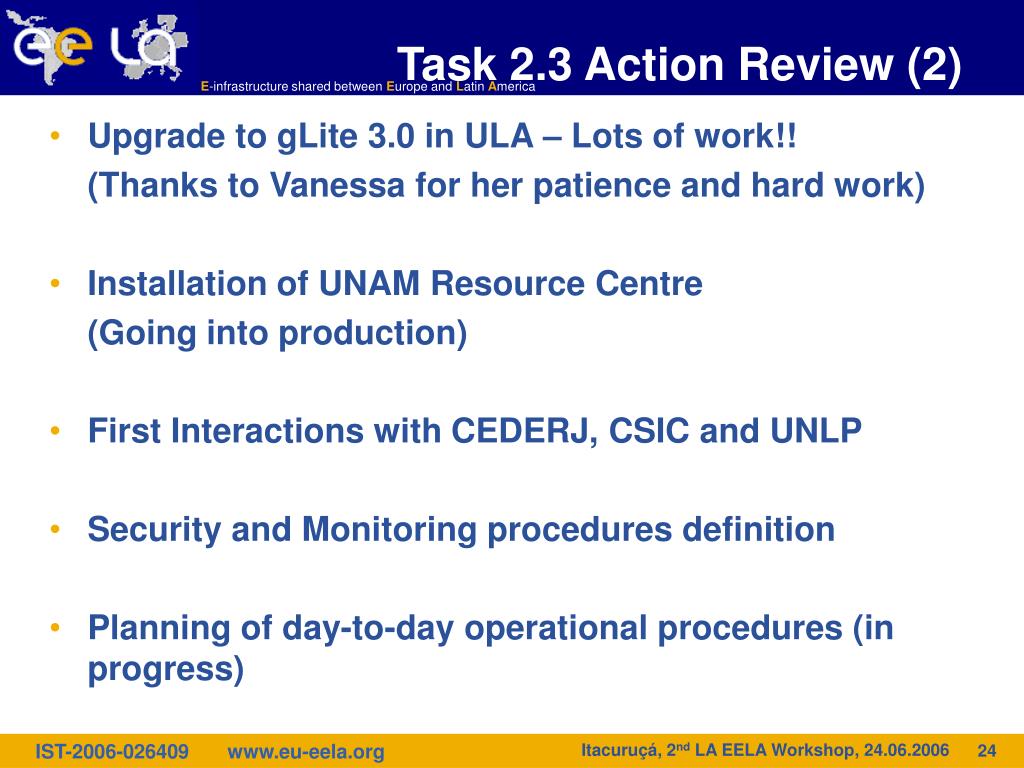

Task 2.3 Action Review (2)
  • Upgrade to gLite 3.0 in ULA – Lots of work!!

(Thanks to Vanessa for her patience and hard work)

  • Installation of UNAM Resource Centre

(Going into production)

  • First Interactions with CEDERJ, CSIC and UNLP
  • Security and Monitoring procedures definition
  • Planning of day-to-day operational procedures (in progress)

Itacuruçá, 2nd LA EELA Workshop, 24.06.2006

open issues in task 2 3

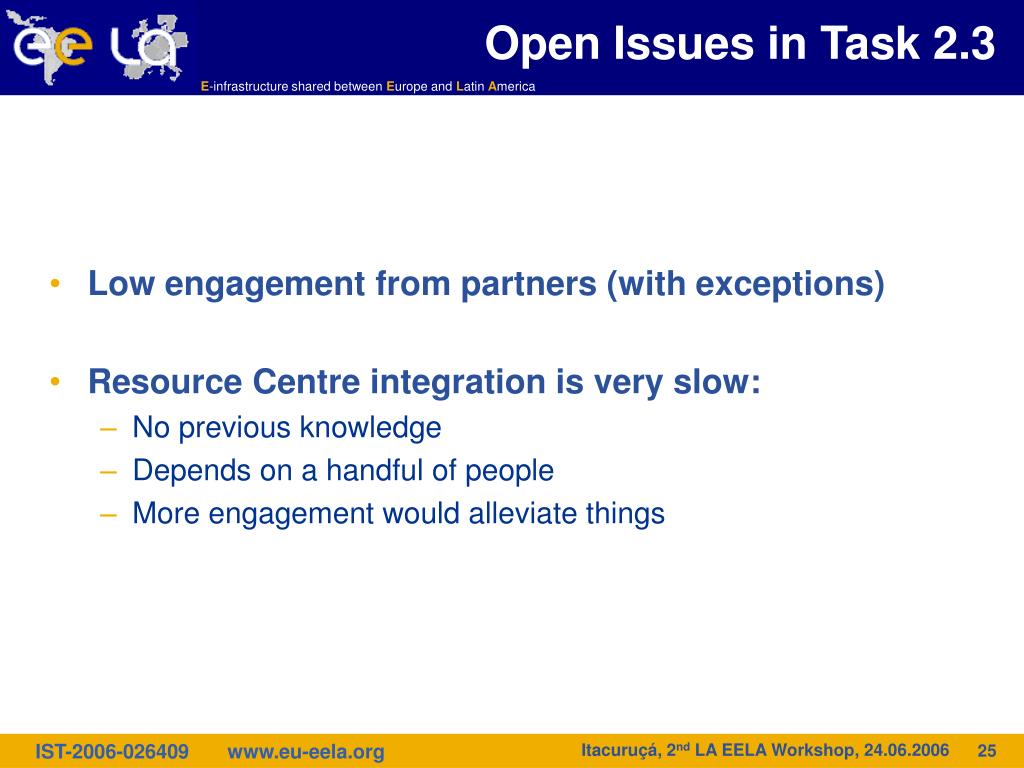

Open Issues in Task 2.3
  • Low engagement from partners (with exceptions)
  • Resource Centre integration is very slow:
    • No previous knowledge
    • Depends on a handful of people
    • More engagement would alleviate things

Itacuruçá, 2nd LA EELA Workshop, 24.06.2006

partner resource commitment
Partner Resource Commitment
  • As stated by Roberto Barbera and Diego Carvalho, we are still a long way from the promised Testbed commitment
  • A stronger engagement is needed in order to achieve what’s promised in the Technical Annex

Itacuruçá, 2nd LA EELA Workshop, 24.06.2006

work plan until ws3
Work plan until WS3
  • Integration of resource centres will continue
  • Security
    • Deployment of Security Staff
    • Definition of security procedures
  • Monitoring
    • Definition of monitoring team
    • Deployment of Site Functional Tests
  • First release of EELA middleware

Itacuruçá, 2nd LA EELA Workshop, 24.06.2006

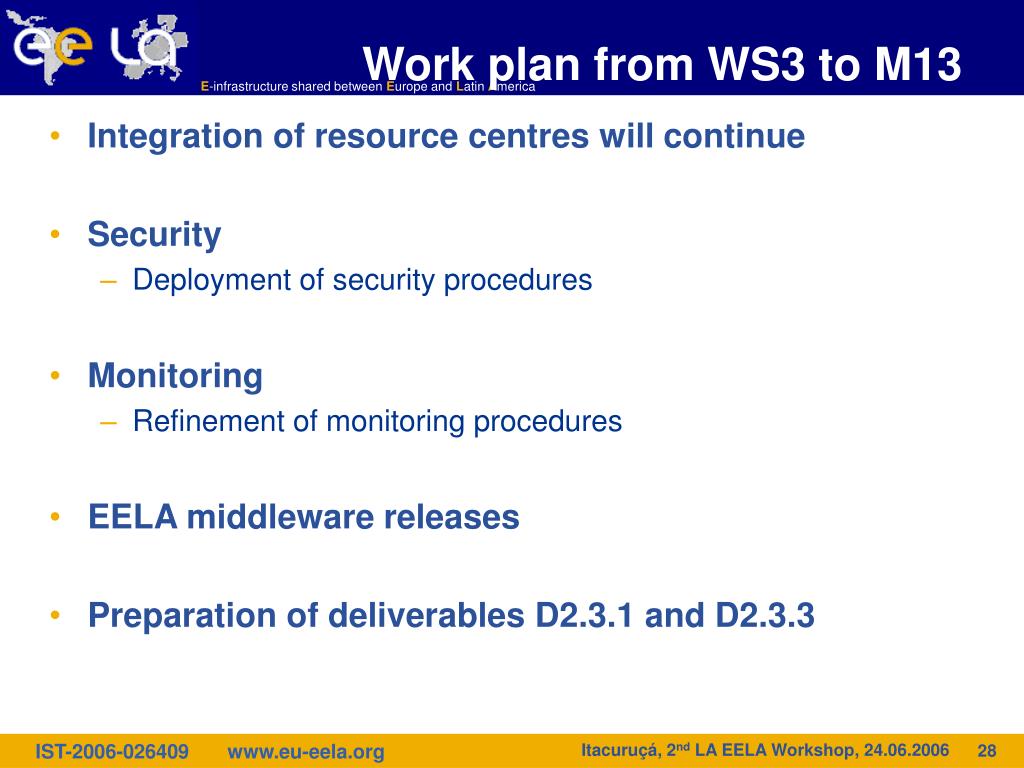

work plan from ws3 to m13
Work plan from WS3 to M13
  • Integration of resource centres will continue
  • Security
    • Deployment of security procedures
  • Monitoring
    • Refinement of monitoring procedures
  • EELA middleware releases
  • Preparation of deliverables D2.3.1 and D2.3.3

Itacuruçá, 2nd LA EELA Workshop, 24.06.2006

thanks

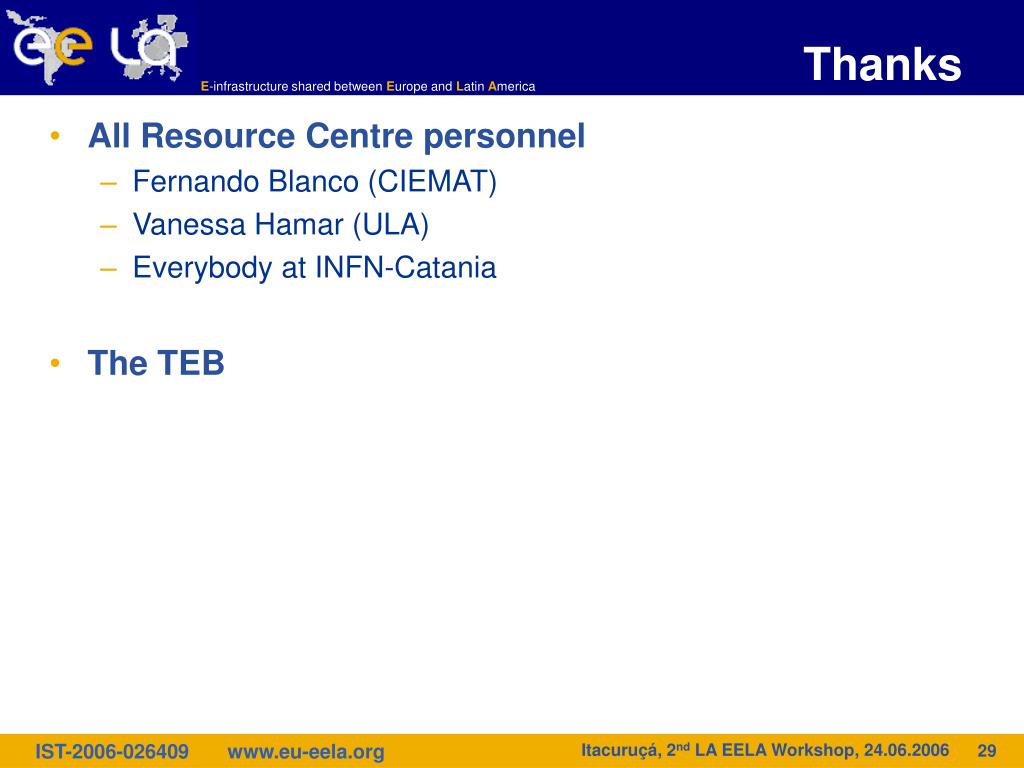

Thanks
  • All Resource Centre personnel
    • Fernando Blanco (CIEMAT)
    • Vanessa Hamar (ULA)
    • Everybody at INFN-Catania
  • The TEB
