  1. ADJUSTMENTS FOR CHANGES IN COST IN CONSTRUCTION CONTRACTS (CALCULATION OF INPUT PROPORTIONS) CIDA/SBD/02 B.M.I.Kumaranayake – P/21/PP 4575/020 IQSSL College of Quantity Surveying (Guarantee) Limited PL3111 Contract Management - Course Work

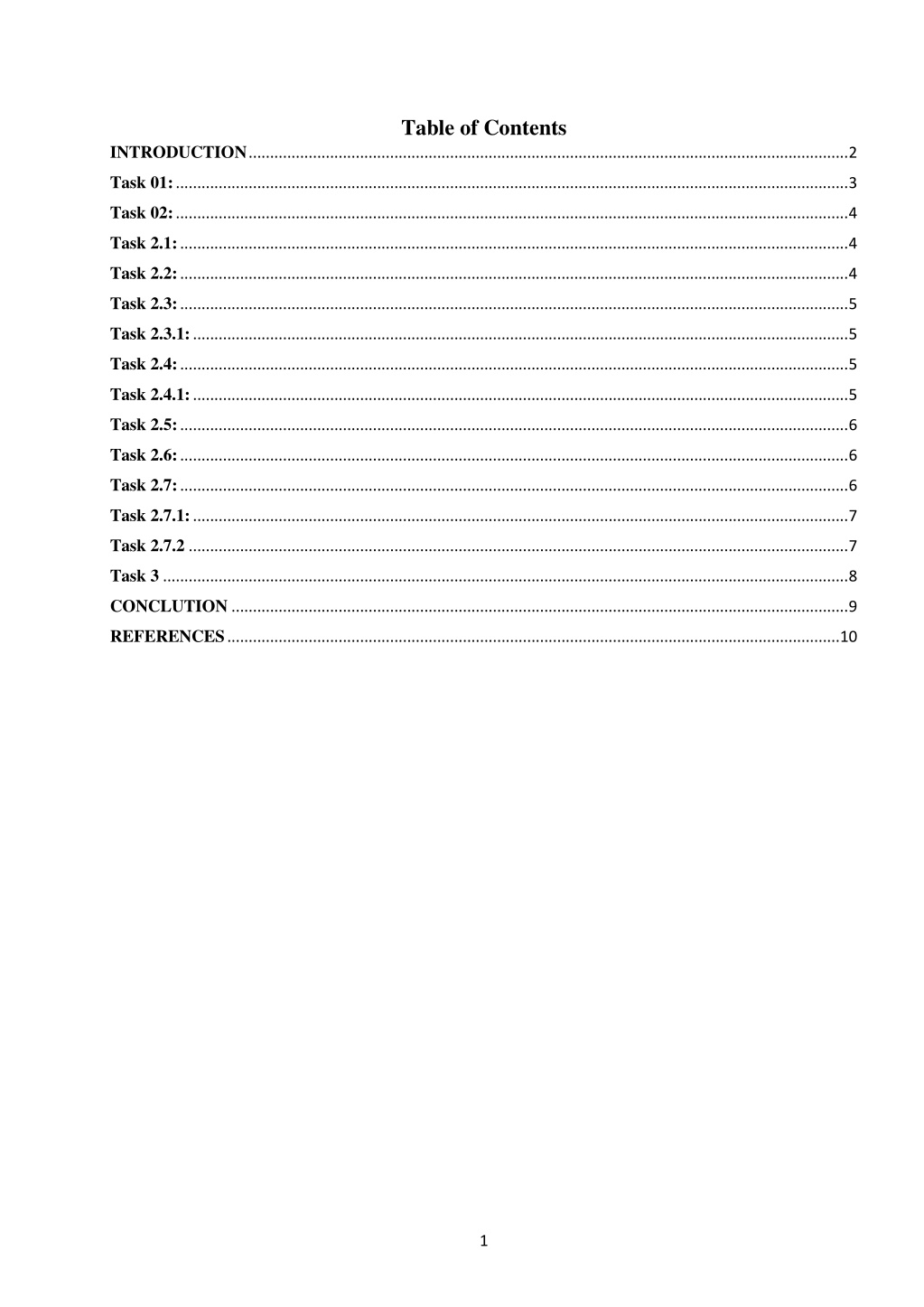

  2. Table of Contents INTRODUCTION ............................................................................................................................................ 2 Task 01: ............................................................................................................................................................. 3 Task 02: ............................................................................................................................................................. 4 Task 2.1: ............................................................................................................................................................ 4 Task 2.2: ............................................................................................................................................................ 4 Task 2.3: ............................................................................................................................................................ 5 Task 2.3.1: ......................................................................................................................................................... 5 Task 2.4: ............................................................................................................................................................ 5 Task 2.4.1: ......................................................................................................................................................... 5 Task 2.5: ............................................................................................................................................................ 6 Task 2.6: ............................................................................................................................................................ 6 Task 2.7: ............................................................................................................................................................ 6 Task 2.7.1: ......................................................................................................................................................... 7 Task 2.7.2 .......................................................................................................................................................... 7 Task 3 ................................................................................................................................................................ 8 CONCLUTION ................................................................................................................................................ 9 REFERENCES ............................................................................................................................................... 10 1

  3. INTRODUCTION Due to major characteristics; large, heavy and expensive products of the construction industry differ in many ways from other industries. As a result, the higher involvement of many types of inputs is essential for the substantial completion of projects. The gradual increase in the price indices expos a rising cost of construction inputs in the domestic industry mainly, due to inflation. There are two broad ways of calculating price fluctuation that compensate the parties to the contract in fluctuation; namely the traditional method and formula method. The traditional method is a full reimbursement method and on the other formula method is a partial reimbursement method However, it is often argued that Sri Lankan contractors are not satisfied with the way price fluctuation is paid with the formula method and the way of calculating methods of input percentages used by Sri Lankan professionals due to the difference of actual price fluctuation and the amount reimbursed from formula method . 2

  4. Task 01: F = Price adjustment for the period V = Valuation of work done during the period concerned (work done + 80% materials at site) {from the interim statement} Vna = Value of non – adjustable element for the period {from the interim statement} Px = Percentage cost contribution of input X {from the tender document/contract document} Ixc = Current index for input X {from ICTAD statistical Bulletin} Ixb = Base index for input X {from ICTAD statistical Bulletin} 3

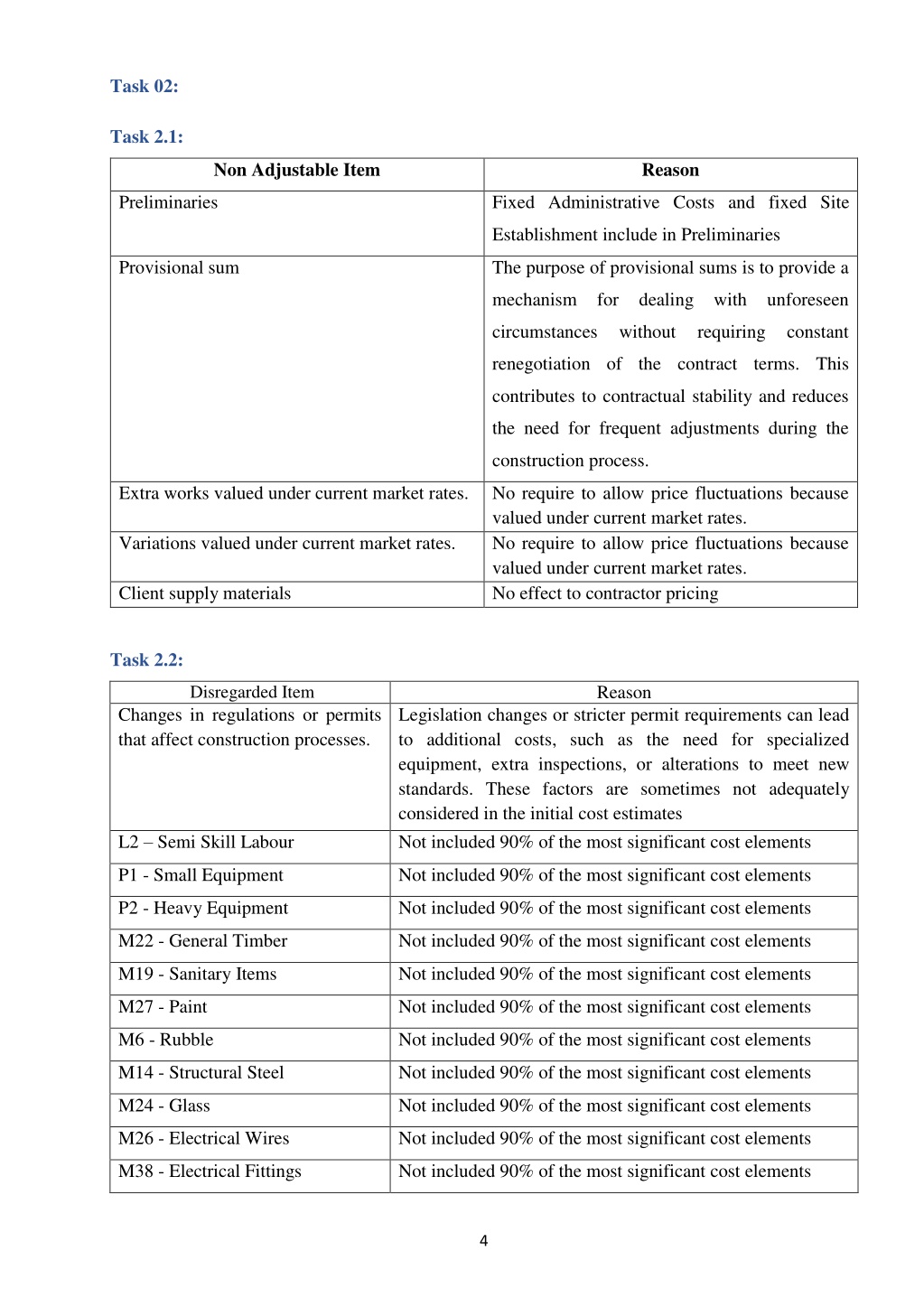

  5. Task 02: Task 2.1: Non Adjustable Item Reason Preliminaries Fixed Administrative Costs and fixed Site Establishment include in Preliminaries Provisional sum The purpose of provisional sums is to provide a mechanism for dealing with unforeseen circumstances without requiring constant renegotiation of the contract terms. This contributes to contractual stability and reduces the need for frequent adjustments during the construction process. Extra works valued under current market rates. No require to allow price fluctuations because valued under current market rates. No require to allow price fluctuations because valued under current market rates. No effect to contractor pricing Variations valued under current market rates. Client supply materials Task 2.2: Disregarded Item Changes in regulations or permits that affect construction processes. Reason Legislation changes or stricter permit requirements can lead to additional costs, such as the need for specialized equipment, extra inspections, or alterations to meet new standards. These factors are sometimes not adequately considered in the initial cost estimates Not included 90% of the most significant cost elements L2 – Semi Skill Labour P1 - Small Equipment Not included 90% of the most significant cost elements P2 - Heavy Equipment Not included 90% of the most significant cost elements M22 - General Timber Not included 90% of the most significant cost elements M19 - Sanitary Items Not included 90% of the most significant cost elements M27 - Paint Not included 90% of the most significant cost elements M6 - Rubble Not included 90% of the most significant cost elements M14 - Structural Steel Not included 90% of the most significant cost elements M24 - Glass Not included 90% of the most significant cost elements M26 - Electrical Wires Not included 90% of the most significant cost elements M38 - Electrical Fittings Not included 90% of the most significant cost elements 4

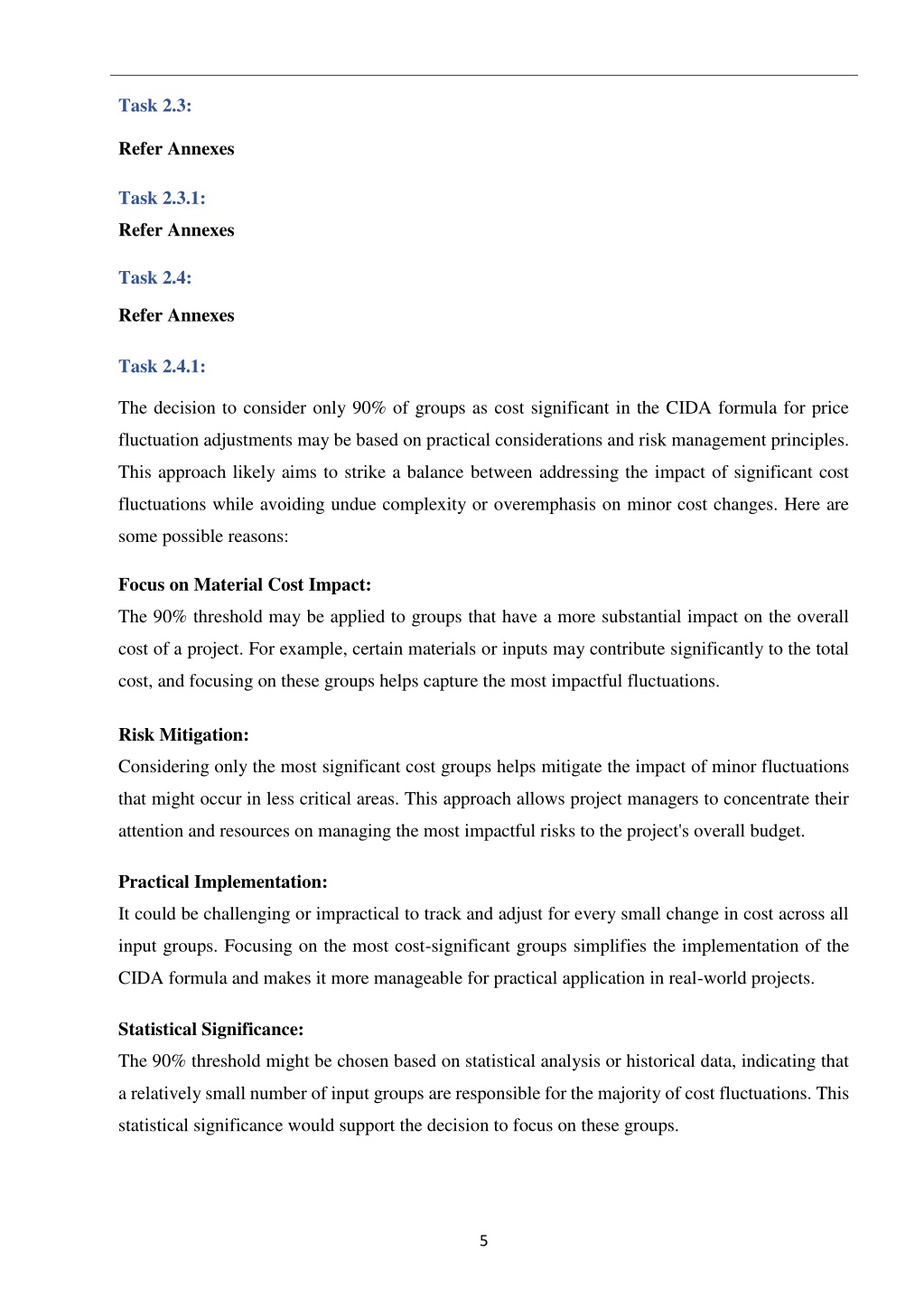

  6. Task 2.3: Refer Annexes Task 2.3.1: Refer Annexes Task 2.4: Refer Annexes Task 2.4.1: The decision to consider only 90% of groups as cost significant in the CIDA formula for price fluctuation adjustments may be based on practical considerations and risk management principles. This approach likely aims to strike a balance between addressing the impact of significant cost fluctuations while avoiding undue complexity or overemphasis on minor cost changes. Here are some possible reasons: Focus on Material Cost Impact: The 90% threshold may be applied to groups that have a more substantial impact on the overall cost of a project. For example, certain materials or inputs may contribute significantly to the total cost, and focusing on these groups helps capture the most impactful fluctuations. Risk Mitigation: Considering only the most significant cost groups helps mitigate the impact of minor fluctuations that might occur in less critical areas. This approach allows project managers to concentrate their attention and resources on managing the most impactful risks to the project's overall budget. Practical Implementation: It could be challenging or impractical to track and adjust for every small change in cost across all input groups. Focusing on the most cost-significant groups simplifies the implementation of the CIDA formula and makes it more manageable for practical application in real-world projects. Statistical Significance: The 90% threshold might be chosen based on statistical analysis or historical data, indicating that a relatively small number of input groups are responsible for the majority of cost fluctuations. This statistical significance would support the decision to focus on these groups. 5

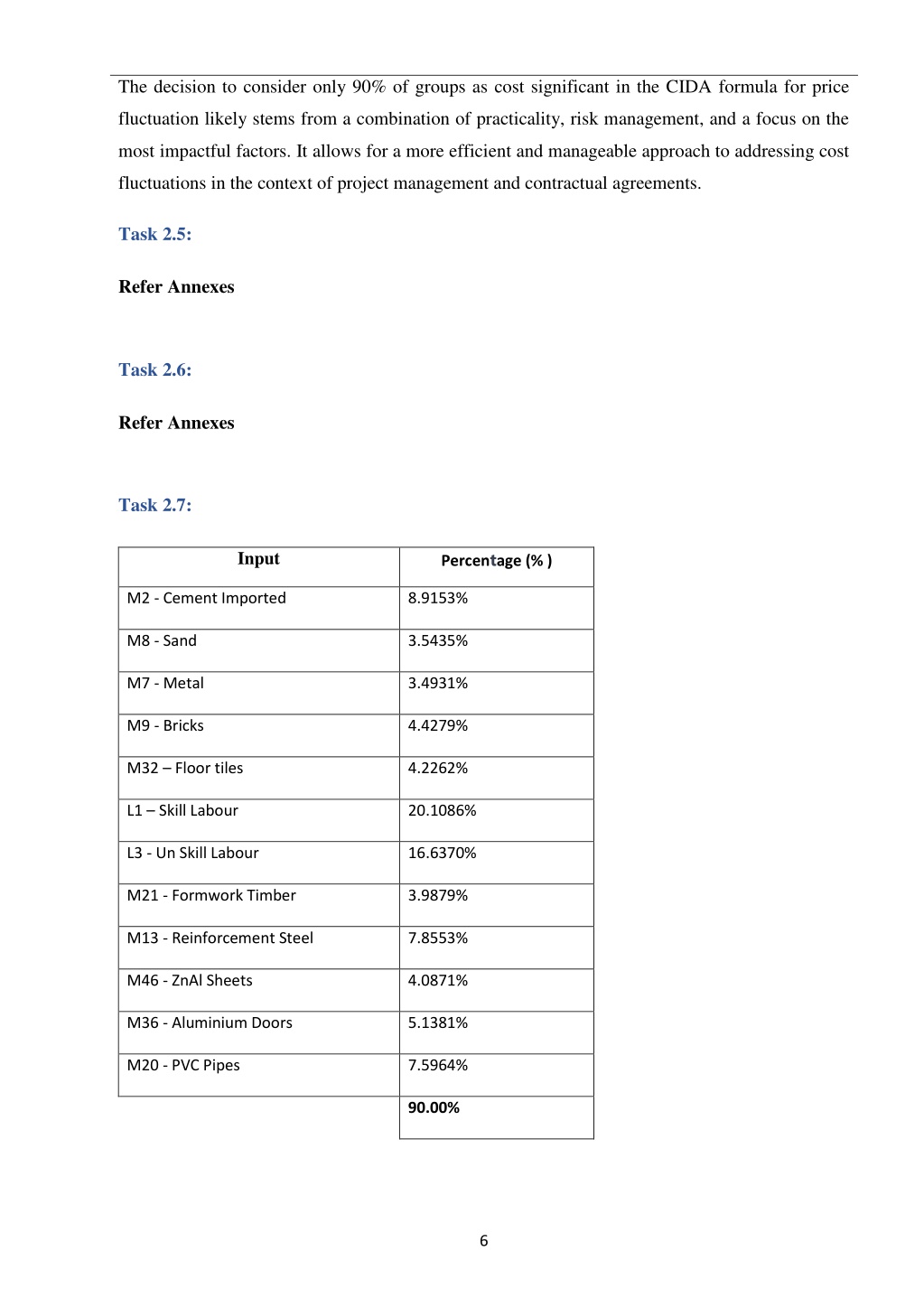

  7. The decision to consider only 90% of groups as cost significant in the CIDA formula for price fluctuation likely stems from a combination of practicality, risk management, and a focus on the most impactful factors. It allows for a more efficient and manageable approach to addressing cost fluctuations in the context of project management and contractual agreements. Task 2.5: Refer Annexes Task 2.6: Refer Annexes Task 2.7: Input Percentage (% ) M2 - Cement Imported M8 - Sand 8.9153% 3.5435% 3.4931% 4.4279% 4.2262% 20.1086% 16.6370% 3.9879% 7.8553% 4.0871% 5.1381% 7.5964% 90.00% M7 - Metal M9 - Bricks M32 – Floor tiles L1 – Skill Labour L3 - Un Skill Labour M21 - Formwork Timber M13 - Reinforcement Steel M46 - ZnAl Sheets M36 - Aluminium Doors M20 - PVC Pipes 6

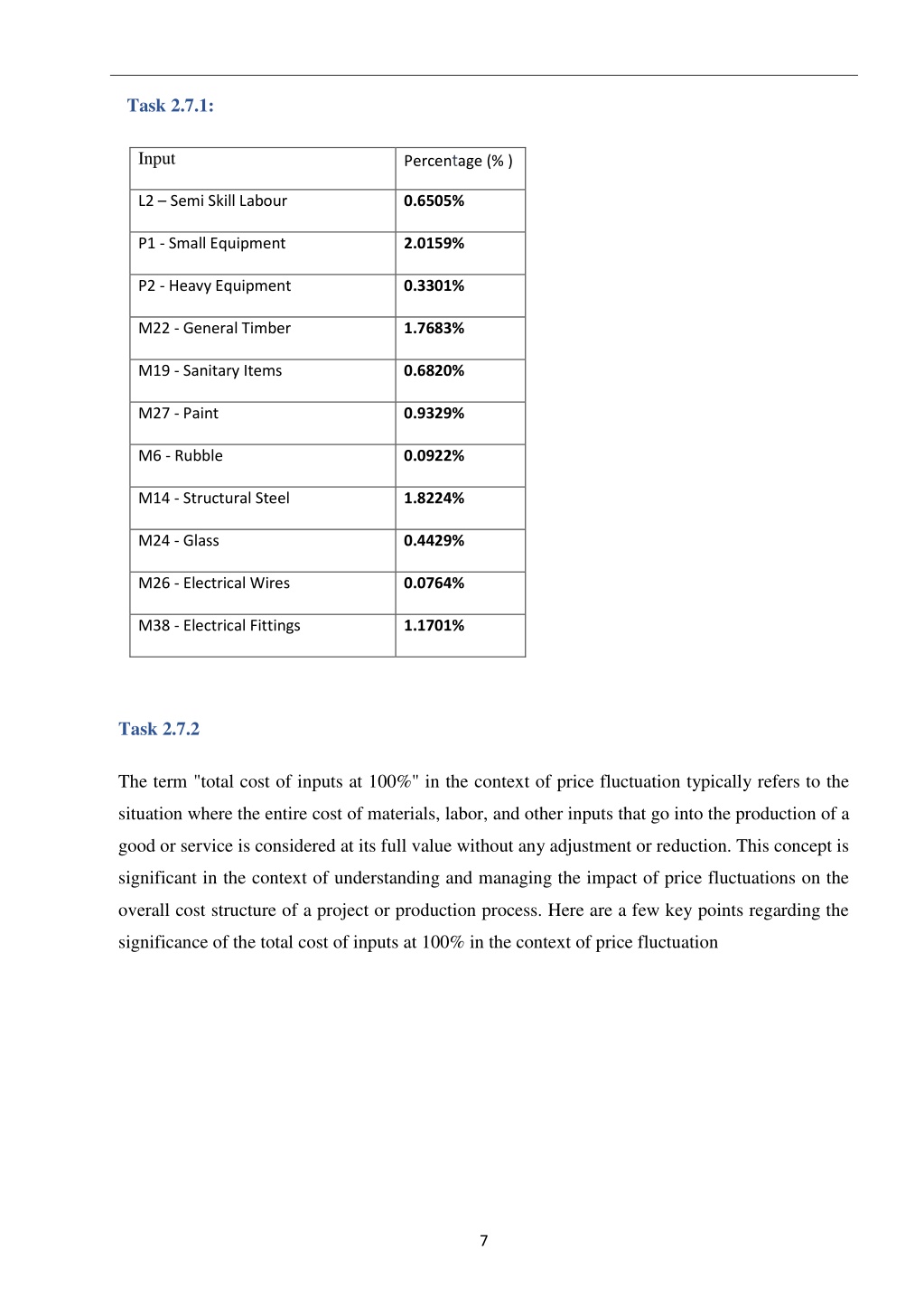

  8. Task 2.7.1: Percentage (% ) Input L2 – Semi Skill Labour 0.6505% 2.0159% 0.3301% 1.7683% 0.6820% 0.9329% 0.0922% 1.8224% 0.4429% 0.0764% 1.1701% P1 - Small Equipment P2 - Heavy Equipment M22 - General Timber M19 - Sanitary Items M27 - Paint M6 - Rubble M14 - Structural Steel M24 - Glass M26 - Electrical Wires M38 - Electrical Fittings Task 2.7.2 The term "total cost of inputs at 100%" in the context of price fluctuation typically refers to the situation where the entire cost of materials, labor, and other inputs that go into the production of a good or service is considered at its full value without any adjustment or reduction. This concept is significant in the context of understanding and managing the impact of price fluctuations on the overall cost structure of a project or production process. Here are a few key points regarding the significance of the total cost of inputs at 100% in the context of price fluctuation 7

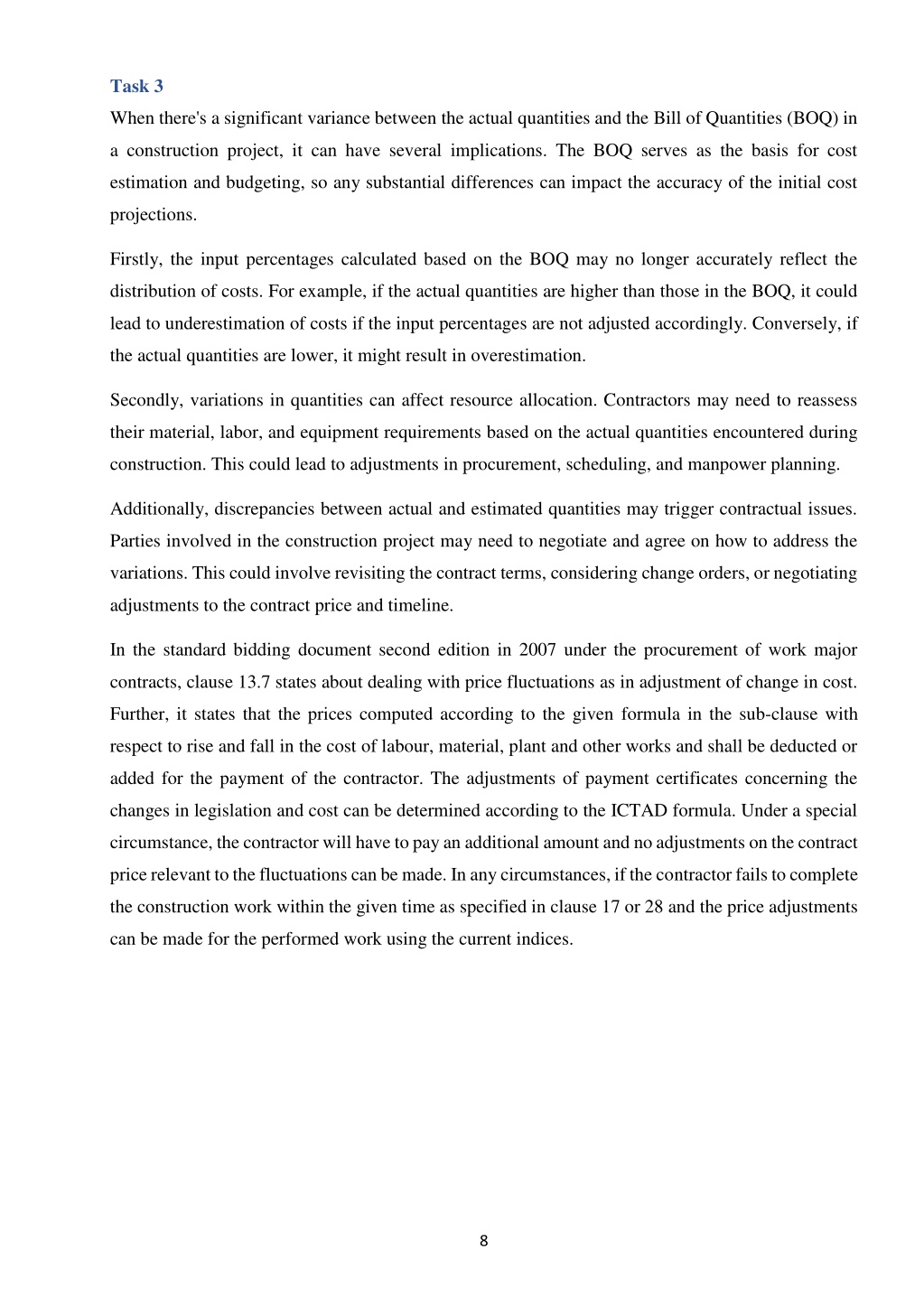

  9. Task 3 When there's a significant variance between the actual quantities and the Bill of Quantities (BOQ) in a construction project, it can have several implications. The BOQ serves as the basis for cost estimation and budgeting, so any substantial differences can impact the accuracy of the initial cost projections. Firstly, the input percentages calculated based on the BOQ may no longer accurately reflect the distribution of costs. For example, if the actual quantities are higher than those in the BOQ, it could lead to underestimation of costs if the input percentages are not adjusted accordingly. Conversely, if the actual quantities are lower, it might result in overestimation. Secondly, variations in quantities can affect resource allocation. Contractors may need to reassess their material, labor, and equipment requirements based on the actual quantities encountered during construction. This could lead to adjustments in procurement, scheduling, and manpower planning. Additionally, discrepancies between actual and estimated quantities may trigger contractual issues. Parties involved in the construction project may need to negotiate and agree on how to address the variations. This could involve revisiting the contract terms, considering change orders, or negotiating adjustments to the contract price and timeline. In the standard bidding document second edition in 2007 under the procurement of work major contracts, clause 13.7 states about dealing with price fluctuations as in adjustment of change in cost. Further, it states that the prices computed according to the given formula in the sub-clause with respect to rise and fall in the cost of labour, material, plant and other works and shall be deducted or added for the payment of the contractor. The adjustments of payment certificates concerning the changes in legislation and cost can be determined according to the ICTAD formula. Under a special circumstance, the contractor will have to pay an additional amount and no adjustments on the contract price relevant to the fluctuations can be made. In any circumstances, if the contractor fails to complete the construction work within the given time as specified in clause 17 or 28 and the price adjustments can be made for the performed work using the current indices. 8

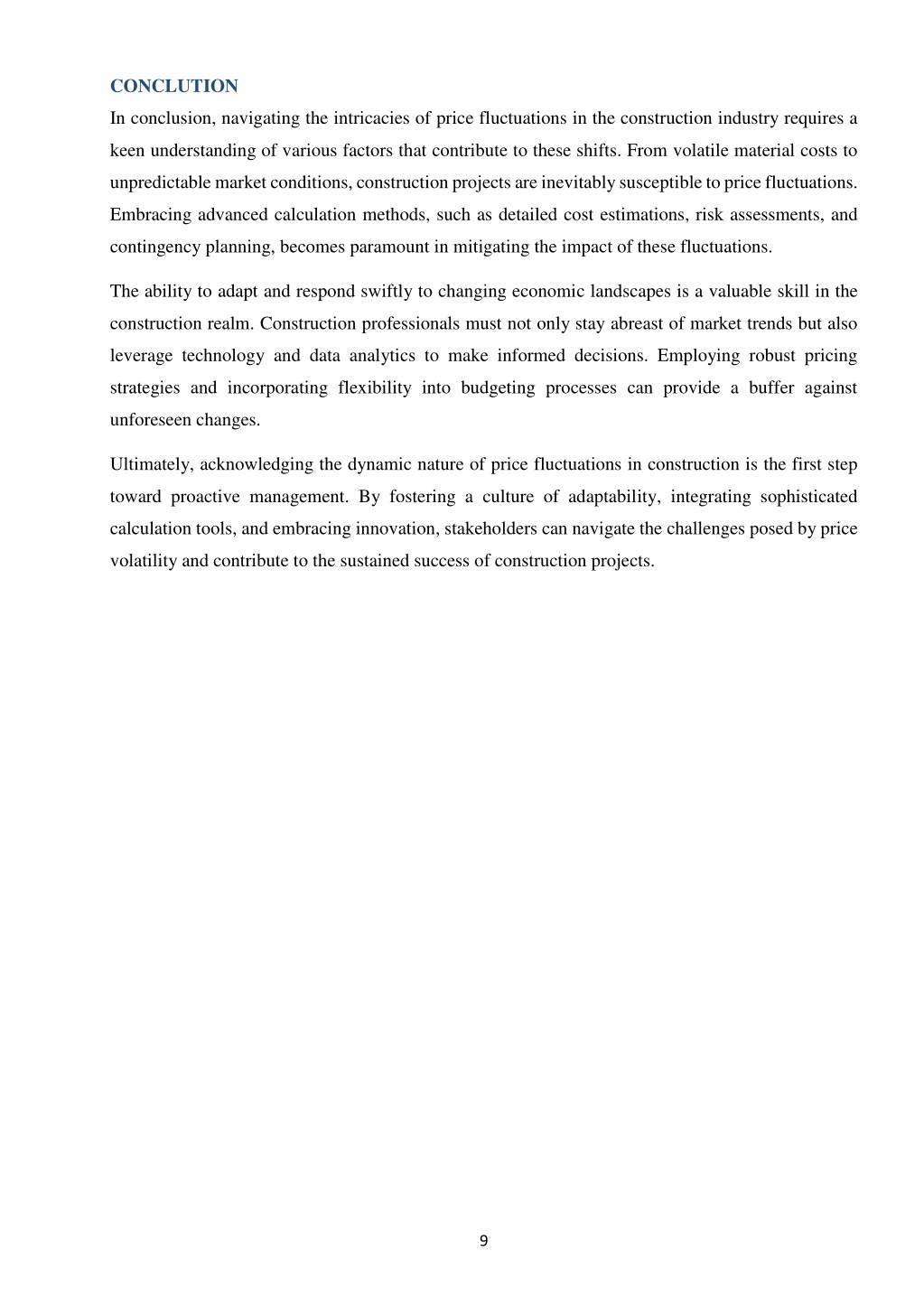

  10. CONCLUTION In conclusion, navigating the intricacies of price fluctuations in the construction industry requires a keen understanding of various factors that contribute to these shifts. From volatile material costs to unpredictable market conditions, construction projects are inevitably susceptible to price fluctuations. Embracing advanced calculation methods, such as detailed cost estimations, risk assessments, and contingency planning, becomes paramount in mitigating the impact of these fluctuations. The ability to adapt and respond swiftly to changing economic landscapes is a valuable skill in the construction realm. Construction professionals must not only stay abreast of market trends but also leverage technology and data analytics to make informed decisions. Employing robust pricing strategies and incorporating flexibility into budgeting processes can provide a buffer against unforeseen changes. Ultimately, acknowledging the dynamic nature of price fluctuations in construction is the first step toward proactive management. By fostering a culture of adaptability, integrating sophisticated calculation tools, and embracing innovation, stakeholders can navigate the challenges posed by price volatility and contribute to the sustained success of construction projects. 9

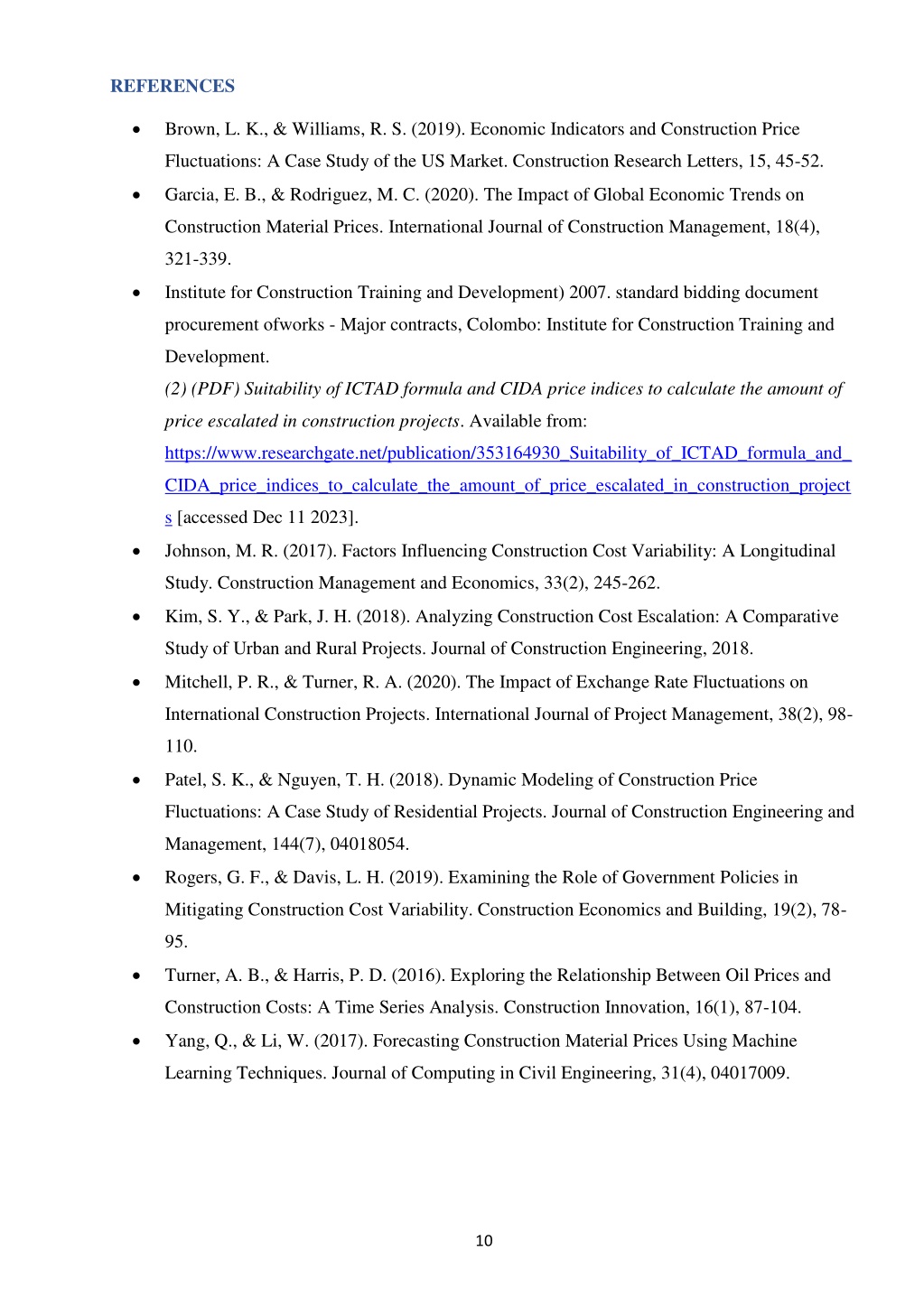

  11. REFERENCES  Brown, L. K., & Williams, R. S. (2019). Economic Indicators and Construction Price Fluctuations: A Case Study of the US Market. Construction Research Letters, 15, 45-52.  Garcia, E. B., & Rodriguez, M. C. (2020). The Impact of Global Economic Trends on Construction Material Prices. International Journal of Construction Management, 18(4), 321-339.  Institute for Construction Training and Development) 2007. standard bidding document procurement ofworks - Major contracts, Colombo: Institute for Construction Training and Development. (2) (PDF) Suitability of ICTAD formula and CIDA price indices to calculate the amount of price escalated in construction projects. Available from: https://www.researchgate.net/publication/353164930_Suitability_of_ICTAD_formula_and_ CIDA_price_indices_to_calculate_the_amount_of_price_escalated_in_construction_project s [accessed Dec 11 2023].  Johnson, M. R. (2017). Factors Influencing Construction Cost Variability: A Longitudinal Study. Construction Management and Economics, 33(2), 245-262.  Kim, S. Y., & Park, J. H. (2018). Analyzing Construction Cost Escalation: A Comparative Study of Urban and Rural Projects. Journal of Construction Engineering, 2018.  Mitchell, P. R., & Turner, R. A. (2020). The Impact of Exchange Rate Fluctuations on International Construction Projects. International Journal of Project Management, 38(2), 98- 110.  Patel, S. K., & Nguyen, T. H. (2018). Dynamic Modeling of Construction Price Fluctuations: A Case Study of Residential Projects. Journal of Construction Engineering and Management, 144(7), 04018054.  Rogers, G. F., & Davis, L. H. (2019). Examining the Role of Government Policies in Mitigating Construction Cost Variability. Construction Economics and Building, 19(2), 78- 95.  Turner, A. B., & Harris, P. D. (2016). Exploring the Relationship Between Oil Prices and Construction Costs: A Time Series Analysis. Construction Innovation, 16(1), 87-104.  Yang, Q., & Li, W. (2017). Forecasting Construction Material Prices Using Machine Learning Techniques. Journal of Computing in Civil Engineering, 31(4), 04017009. 10

  12. Contract Name: Contract No : Name of the Contractor : Period : Item No. Construction of Stores & Office Building - Water Supply Scheme Contract Number :- Engineering (PVT) LTD. As Per BOQ Unit Qty. Rate (Rs) Amount (Rs) Description M2 M8 M7 M9 M32 L1 L2 L3 P1 Small Equipme nt Remark s Cement Imported Floor Tile Skill Labour Semiskill Labour Unskill Labour Input % Sand Input % Metal Input % Bricks Input % Input % Input % Input % Input % Site preparation Clearing site vegetation including ( bushes,shrubs , under growth hedges & trees & stumps not exceeding 300 mm girths ) and carting away debris from site. Rate to include for leveling the site . 1 m2 160.30 40.00 6,412.00 100.00% 0.0505% Excavation Excavating trenches for random rubble foundation in first floor areas in any material other than rock with width exceeding 300 mm and depth not exceeding 1.0 m from ground level . Excavating trenches for concrete retaining wall base in ground floor areas in any material other than rock with width exceeding 1.0 m - 2.0 m from ground level . 2 m3 10.82 1,000.00 10,820.00 40.00% 0.0341% 3 m3 29.60 1,600.00 47,360.00 40.00% 0.1493% Excavating pit for column bases commencing from ground level including compacting bottom and depth exceeding 1.0 m- 2.0 m 4 m3 10.40 1,600.00 16,640.00 30.00% 0.0393% 70.00% 0.0918% 5 Excavation of embankment to construct the concrete retaining wall m3 66.40 1,600.00 106,240.00 30.00% 0.2512% 70.00% 0.5861% Surface Treatment Applying insecticides , pre construction soil treatment against subterranean termites to the building using approved termiticide . 9 m2 113.40 350.00 39,690.00 30.00% 0.0938% 30.00% 0.0938% Filling Filling to make up levels up to 500mm with excavated material on site laid in 150 mm layer well rammed watered and consolidated .selected soil . 10 m3 73.25 730 53,472.50 100.00% 0.4214% Filling to make up levels up to 500mm with excavated material off site laid in 150 mm layer well rammed watered and consolidated .selected soil . 11 m3 30.50 3000 91,500.00 100.00% 0.7211% Concrete work Insitu concrete G15 In foundation 150 mm thk screed for random rubble foundation poured into ground 12 m3 0.90 20,000.00 18,000.00 37.86% 0.0537% 13.38% 0.0190% 17.82% 0.0253% 4.84% 0.0069% 19.57% 0.0278% 6.13% In foundation 50 mm thick screed for column bases & concrete R/W base m2 13 34.34 1,000.00 34,340.00 37.86% 0.1025% 13.38% 0.0362% 17.82% 0.0482% 4.84% 0.0131% 19.57% 0.0530% 6.13% Insitu concrete G 20 44.16% 0.1876% 11.35% 0.0482% 16.27% 0.0691% 4.41% 0.0187% 17.86% 0.0759% 5.42% 14 Ramp area concreate in to front side of the ground floor m3 2.45 22,000.00 53,900.00 In 1 st floor bed concrete thickness not exceeding 75 mm thick . 44.16% 0.3177% 11.35% 0.0817% 16.27% 0.1171% 4.41% 0.0317% 17.86% 0.1285% 5.42% 15 m3 4.15 22,000.00 91,300.00 In ground floor bed concrete thickness not exceeding 100 mm thick . 44.16% 0.5183% 11.35% 0.1332% 16.27% 0.1910% 4.41% 0.0518% 17.86% 0.2096% 5.42% 16 m3 6.77 22,000.00 148,940.00 Reinforced concrete G25 In column base 37.86% 0.0892% 13.38% 0.0315% 17.82% 0.0420% 4.84% 0.0114% 19.57% 0.0461% 5.94% 17 m3 1.30 23,000.00 29,900.00 In Retaining wall base 37.86% 0.3953% 13.38% 0.1397% 17.82% 0.1861% 4.84% 0.0505% 19.57% 0.2043% 5.94% 18 m3 5.76 23,000.00 132,480.00 For retaining wall (200 mm) 37.86% 1.1858% 13.38% 0.4191% 17.82% 0.5582% 4.84% 0.1516% 19.57% 0.6130% 5.94% 19 m3 17.28 23,000.00 397,440.00 In columns with sectional area not exceeding 0.1 m2 up to roof level . 37.86% 0.3575% 13.38% 0.1264% 17.82% 0.1683% 4.84% 0.0457% 19.57% 0.1848% 5.94% 20 m3 5.21 23,000.00 119,830.00 8.31 23,000.00 In first floor rcc slab 125 mm thick 37.86% 0.5703% 13.38% 0.2015% 17.82% 0.2684% 4.84% 0.0729% 19.57% 0.2948% 5.94% 21 m3 191,130.00 In beams, Where necessary, In ground floor Tie beam 2.41 23,000.00 37.86% 0.1654% 13.38% 0.0584% 17.82% 0.0778% 4.84% 0.0211% 19.57% 0.0855% 5.94% 22 m3 55,430.00 5.34 23,000.00 In 1 st floor beams 37.86% 0.3665% 13.38% 0.1295% 17.82% 0.1725% 4.84% 0.0468% 19.57% 0.1894% 5.94% 23 m3 122,820.00

  13. In 225 * 150 mm lintels 37.86% 1.5097% 13.38% 0.5336% 17.82% 0.7106% 4.84% 0.1930% 19.57% 0.7804% 5.94% 24 m 22.00 23,000.00 506,000.00 For staircase step & waist 37.86% 0.0913% 13.38% 0.0323% 17.82% 0.0430% 4.84% 0.0117% 19.57% 0.0472% 5.94% 25 m3 1.33 23,000.00 30,590.00 For staircase base foundation 37.86% 0.0192% 13.38% 0.0068% 17.82% 0.0090% 4.84% 0.0025% 19.57% 0.0099% 5.94% 26 m3 0.28 23,000.00 6,440.00 For staircase Landing 37.86% 0.0206% 13.38% 0.0073% 17.82% 0.0097% 4.84% 0.0026% 19.57% 0.0106% 5.94% 27 m3 0.30 23,000.00 6,900.00 Form work To concrete Retaining wall D-09 36.84% 0.5536% 24.85% 0.3734% 28 m2 105.93 1,800.00 190,674.00 To side & soffits of lintels . D-09 36.84% 0.3684% 24.85% 0.2485% 29 m 70.50 1,800.00 126,900.00 30 To sides of columns in 1 st floor level D-09 36.84% 0.3374% 24.85% 0.2276% m2 64.56 1,800.00 116,208.00 31 To sides of column bases & retaining wall base . D-09 36.84% 0.3374% 24.85% 0.2276% m 52.80 1,800.00 116,208.00 32 m2 To soffit of 1 st floor slab D-11 12.54% 0.0915% 25.37% 0.1850% 51.41 1,800.00 92,538.00 33 m To edges of 1 st floor slab .(Height _< 300mm ) D-11 12.54% 0.0623% 25.37% 0.1260% 35.00 1,800.00 63,000.00 34 m2 43.18 1,800.00 Sides & soffits of floor beams D-09 18.78% 0.1150% 12.66% 0.0775% 77,724.00 m 16.59 1,800.00 To edges of stair case.Including Landing (Height _< 300mm) D-10 13.98% 0.0329% 28.29% 0.0666% 35 29,862.00 m 31.37 1,800.00 To side of risers D-10 13.98% 0.0622% 28.29% 0.1259% 36 56,466.00 m2 9.66 1,800.00 To soffit of staircase. Including Landing D-10 13.98% 0.0192% 28.29% 0.0388% 37 17,388.00 Reinforcement in insitu Concrete Mild steel 6 mm dia .mild steel bars E-01 18.89% 0.1648% 12.74% 0.1111% 38 t 0.41 270,000.00 110,700.00 Tor steel 10 mm dia .Tor steel bars E-02 18.63% 0.2656% 12.56% 0.1791% 39 t 0.67 270,000.00 180,900.00 12 mm dia .Tor steel bars E-02 18.63% 0.7809% 12.56% 0.5265% 40 t 1.97 270,000.00 531,900.00 16 mm dia .Tor steel bars E-02 18.63% 0.4202% 12.56% 0.2833% 41 t 1.06 270,000.00 286,200.00 Brick work 225 mm thick solid common bricks build in cement mortar 1:5 4.77% 0.2260% 3.13% 0.1483% 65.92% 3.1230% 8.99% 0.4259% 9.99% 0.4733% 43 m2 139.80 4,300.00 601,140.00 112.5 mm thick solid common bricks build in cement mortar 1:5 6.97% 0.0920% 5.21% 0.0688% 42.95% 0.5669% 20.02% 0.2643% 18.90% 0.2495% 44 m2 69.79 2,400.00 167,496.00 Stone work 300 mm thick Vertical rubble stone work walls built in cement sand mortar 1:5 21.97% 0.0394% 14.41% 0.0258% 18.56% 0.0333% 25.03% 0.0449% 45 m2 4.55 5,000.00 22,750.00 450 mm thick Vertical rubble stone work walls built in cement sand mortar 1:5 21.97% 0.0711% 14.41% 0.0466% 18.56% 0.0600% 25.03% 0.0810% 46 m2 5.70 7,200.00 41,040.00 Water proofing 12 mm thick horizontal DPC width not exceeding 300 mm in cement sand 1:3 20.00% 0.0091% 30.00% 0.0137% 47 m 13.80 420.00 5,796.00 On top of first floor slab ( floor of the bathroom area & walls up to 1.5 m 20.00% 0.0149% 30.00% 0.0224% 48 m2 7.28 1300 9,464.00 m2 Back side of concrete retaining wall 20.00% 0.1633% 30.00% 0.2450% 49 51.81 2,000.00 103,620.00 Metal work Steel roller shutter door type 2700 * 3300 mm complte as shown in details on N-05 24.31% 0.1916% 8.20% 0.0646% 12.44% 50 nr 1.00 100,000.00 100,000.00 Supply & fabricate 40 mm dia stainless steel balustrade & handrail 1000 mm 24.31% 0.5901% 8.20% 0.1990% 12.44% 51 m 30.80 10,000.00 308,000.00 Wood work Roof Framing 100 * 75 mm Wall plate . 40.00% 0.2845% 10.00% 0.0711% 10.00% 52 m 41.40 2,180.00 90,252.00 Roof Framing 50 * 100 mm Rafters . 40.00% 0.9194% 10.00% 0.2298% 10.00% 53 m 198.40 1,470.00 291,648.00 Roof Framing 50 * 50 mm Runners . 40.00% 0.2697% 10.00% 0.0674% 10.00% 54 m 138.00 620.00 85,560.00 Doors & Windows Doors Glazed Aluminium door (type D 1 ) as Shown on drawing having overall p-38 7.03% 0.0288% 4.74% 0.0194% 55 nr 1.00 52,000.00 52,000.00

  14. Glazed Aluminium door (type D 2 ) as Shown on drawing having overall p-38 7.03% 0.0997% 4.74% 0.0672% 56 nr 5.00 36,000.00 180,000.00 PVC door for wash rooms of size 750 * 2100 mm (type D 3) hinged on L-16 15.40% 0.0728% 10.38% 0.0491% 57 nr 3.00 20,000.00 60,000.00 Windows Glazed Aluminum paneled window (type FW ) as Shown on drawing 2400 * p-04 10.56% 0.1919% 7.12% 0.1294% 58 nr 2.00 115,300.00 230,600.00 Glazed Aluminum paneled window (type W ) as Shown on drawing 1200 * p-04 10.56% 0.1001% 7.12% 0.0675% 59 nr 3.00 40,100.00 120,300.00 Glazed Aluminum paneled window (type W 1 ) as Shown on drawing 1800 * p-04 10.56% 0.1015% 7.12% 0.0685% 60 nr 2.00 61,000.00 122,000.00 Windows Glazed Aluminum fanlight (type F ) as Shown on drawing 600 * 450 mm with p-04 10.56% 0.0150% 7.12% 0.0101% 61 nr 3.00 6,000.00 18,000.00 Glazed Aluminum fanlight (type F 1 ) as Shown on drawing 1200 * 450 mm p-04 10.56% 0.0200% 7.12% 0.0135% 62 nr 2.00 12,000.00 24,000.00 0.47 mm thick Zink aluminum colour bonded sheet flashing one end tuck into 40.00% 0.0274% 63 m 5.80 1,500.00 8,700.00 Zink Aluminum coated colour bonded profile sheet roof covering including 40.00% 1.6758% 64 m2 177.20 3,000.00 531,600.00 Zink Aluminum coated colour bonded pain sheet eave gutter 470 mm girth 40.00% 0.5674% 65 m 14.20 1,280.00 180,000.00 Nozzle to suit 100 * 100 mm square type down pipe 40.00% 0.0126% 66 nr 2.00 2,000.00 4,000.00 Gutter end caps 40.00% 0.0126% 67 nr 2.00 2,000.00 4,000.00 Gutter bends 40.00% 0.0504% 68 nr 8.00 2,000.00 16,000.00 Plumbing / Sanitary Installation 20 mm dia pipe 40.00% 0.0340% 70 m 18.00 600.00 10,800.00 25 mm dia pipe 40.00% 0.0473% 71 m 25.00 600.00 15,000.00 Extra over for 20 mm dia 90 degree bends 40.00% 0.0101% 72 nr 8.00 400 3,200.00 Extra over for 25 mm dia 90 degree bends 40.00% 0.0202% 73 nr 16.00 400 6,400.00 Extra over for 25 * 20 mm dia .reducing socket . Waste water Installation ( Type 1000 ) 50 mm dia . Pipe in walls 40.00% 0.0101% 74 nr 8.00 400 3,200.00 40.00% 0.0567% 75 m 18.00 1,000.00 18,000.00 63 mm dia pipe in trenches 40.00% 0.0605% 76 m 16.00 1,200.00 19,200.00 50 mm dia. 90 degree bends 40.00% 0.0126% 77 nr 4.00 1,000.00 4,000.00 Waste water Installation Pvc Pipe Type 1000 63 mm dia. 90 degree bends 78 nr 5.00 1,000.00 5,000.00 50 mm dia Elbows 79 nr 4.00 1,000.00 4,000.00 63 mm dia Elbows 80 nr 4.00 1,000.00 4,000.00 Partitions & Suspended Ceiling 3.0 m height embossed PVC board partition ( using 75 * 30 mm powder 15.00% 0.7041% 10.00% 0.4694% 81 m2 62.70 9,500.00 595,650.00 Suspended type ipenel ( 600*600 mm ) slope ceiling ( outside the building ) 60.00% 0.0457% 10.00% 0.0076% 82 m2 46.00 210 9,660.00 Suspended type gypsum board ( 600*600 mm ) Horizontal ceiling ( inside the 60.00% 0.0752% 10.00% 0.0125% 83 m2 75.75 210.00 15,907.50 Sanitary fittings Low level water closet suite with 9 liter cistern overflow connection , brackets 40.00% 0.1639% 20.00% 0.0820% 84 nr 2.00 26,000.00 52,000.00 Supply & Fixing of 33'' * 22 '' Double - Basin Stainless Steel Drop in 2 hole T-16 31.42% 0.0495% 21.19% 0.0334% 85 nr 1.00 20,000.00 20,000.00 Ceramic corner wash basin with tap , waste plug & chain complete . T-04 18.81% 0.0593% 12.69% 0.0400% 86 nr 2.00 20,000.00 40,000.00 Supply & fixing of wall mounted urinal with top inlet water connection 40.00% 0.2207% 87 nr 2.00 35,000.00 70,000.00 600 * 700 mm mirror of approved quality complete with fittings . T-19 14.65% 0.0115% 9.88% 0.0078% 88 nr 2.00 5,000.00 10,000.00 Chromium plated towel rail T-29 9.35% 0.0052% 6.30% 0.0035% 89 nr 2.00 3,500.00 7,000.00

  15. Hand bidet with angle valves 100.00% 0.0654% 90 nr 2.00 4,150.00 8,300.00 Chromium plated paper roll holder 100% 0.0236% 91 nr 2.00 1,500.00 3,000.00 Chromium plated soap tray 100.00% 0.0355% 92 nr 3.00 1,500.00 4,500.00 Sanitary fittings Chromium plated 12 mm dia Garden tap for frist floor area & ground floor area 18.81% 0.0089% 12.69% 0.0060% 93 nr 2.00 3,000.00 6,000.00 25 mm dia Brass stop valve 18.81% 0.0037% 12.69% 0.0025% 94 nr 1.00 2,500.00 2,500.00 Electrical installation Single phase 30 amp main circuit breakers & 30 amp RCCB with 10 way 40.00% 0.0158% 95 nr 1.00 5,000.00 5,000.00 Main electric cables (7/044 ) to main distribution board 40.00% 0.0410% 96 m 20.00 650.00 13,000.00 One way one gang switch . 30.33% 0.0249% 97 nr 16.00 650 10,400.00 One way four gang switch . 30.33% 0.0335% 98 nr 7.00 2,000.00 14,000.00 Ceiling mounted 9 W * 3 2' * 2 ' LED lamp with polished parabolic reflector . Y-05 18.70% 0.1400% 99 nr 19.00 5,000.00 95,000.00 Down lamp Polished ( 12 W) Aluminum reflector type LED lamp . Y-06 18.14% 0.1029% 100 nr 18.00 4,000.00 72,000.00 Electrical installation 5 amp switched socket outlet flushed type . 24.60% 0.1086% 101 nr 14.00 4,000.00 56,000.00 15 amp switched socket outlet flushed type . 24.60% 0.0388% 102 nr 4.00 5,000.00 20,000.00 Supply & installation of approved Quality ceiling fan 1400 mm dia .( 5 speed 8.82% 0.0605% 103 nr 6.00 14,500.00 87,000.00 Earth electrode complete with 50 mm dia 2.00 mm long GI pipe driven in to 60.00% 0.0946% 104 nr 2.00 10,000.00 20,000.00 Floor / Wall Finishing Floor finishes Frist floor finishes ceramic floor tiles size of 600 * 600 mm approved colour 4.64% 0.1718% 1.51% 0.0559% 63.90% 2.3658% 13.89% 0.5143% 9.37% 0.3469% 106 m2 81.00 5,800.00 469,800.00 Frist floor washroom finishes ceramic floor tiles size of 300 * 300 mm 5.89% 0.0117% 1.92% 0.0038% 56.58% 0.1127% 17.66% 0.0352% 11.91% 0.0237% 107 m2 6.02 4,200.00 25,284.00 Stair case non slip tiling ( Tiling colour should be match to first floor tiles ) 4.64% 0.0285% 1.51% 0.0093% 63.90% 0.3928% 13.89% 0.0854% 9.37% 0.0576% 108 m2 13.00 6,000.00 78,000.00 Ceramic tile skirting finished with cement slurry & joints finished with 4.64% 0.0097% 1.51% 0.0032% 63.90% 0.1341% 13.89% 0.0291% 9.37% 0.0197% 109 m 48.40 550.00 26,620.00 Wall Finishes Wall finishes width exceeding 300 mm cement : sand (1:5) plaster to internal 13.82% 0.1614% 12.90% 0.1507% 29.71% 0.3470% 40.07% 0.4680% 110 m2 148.19 1000 148,190.00 Column finishes width exceeding 300 mm cement : sand (1:5) plaster to 8.57% 0.0298% 5.61% 0.0195% 49.25% 0.1714% 33.21% 0.1156% 111 m2 36.80 1200 44,160.00 Wall finishes width exceeding 300 mm cement : sand (1:5) plaster to external 13.82% 0.1445% 12.90% 0.1349% 29.71% 0.3106% 40.07% 0.4189% 112 m2 165.81 800 132,648.00 Wall finishes width not exceeding 300 mm cement : sand (1:5) plaster 16 mm 13.82% 0.0279% 12.90% 0.0260% 29.71% 0.0599% 40.07% 0.0808% 113 m 32.00 800 25,600.00 Wall finishes width not exceeding 300 mm cement : sand (1:5) plaster 12 mm 13.82% 0.0185% 12.90% 0.0172% 29.71% 0.0397% 40.07% 0.0536% 114 m 32.00 530 16,960.00 Wall finishes 12 mm thk cement :sand (1 :3) width not exceeding 300 mm to 7.50% 0.0695% 3.25% 0.0301% 55.72% 0.5164% 19.34% 0.1792% 8.69% 0.0805% 115 m2 24.50 4,800.00 117,600.00 12 mm thick plastering to soffit of slab / beams in cement and sand mortar R-01 13.82% 0.0849% 12.90% 0.0793% 29.71% 0.1826% 40.07% 0.2462% 116 m2 68.40 1,140.00 77,976.00 Painting Painting plastered work general surface girth exceeding 300 mm plain 62.92% 0.4409% 117 m2 148.19 600.00 88,914.00 Painting plastered work general surface girth exceeding 300 mm plain 62.92% 0.5344% 118 m2 165.81 650.00 107,776.50 Drainage system 110 mm dia . Pipes in trenches . 120 m 15.00 2700.00 40,500.00 121 Extra over for 110 mm dia Elbows nr 2.00 1000.00 2,000.00 122 Extra over for 110 mm dia Bends nr 4.00 1000.00 4,000.00 Construction of 450 x 450 x 550 mm internal size concrete man hole 4.00% 0.0120% 1.50% 0.0045% 2.50% 0.0075% 20.00% 0.0599% 70.00% 0.2096% 123 nr 2.00 19,000.00 38,000.00

  16. Construction of 600 x 600 x 600 mm internal size concrete man hole 4.50% 0.0085% 2.00% 0.0038% 3.50% 0.0066% 20.00% 0.0378% 60.00% 0.1135% 124 nr 1.00 24000.00 24,000.00 Drainage system Supply & fixing pre- cast septic tank & soakage pits ( for 9 to 15 person ) as 12.50% 0.1970% 6.00% 0.0946% 10.50% 0.1655% 31.00% 0.4886% 40.00% 0.6305% 125 nr 1.00 200000.00 200,000.00 Miscellaneous work 1500 * 1200 * 275 mm size back door concrete ramp ( G 25 concrete & 37.86% 0.0746% 13.38% 0.0264% 17.82% 0.0351% 4.84% 0.0095% 19.75% 0.0389% 6.13% 126 nr 1 25000.00 25,000.00 Supply & Laying of 160 mm dia u.PVC (G 1000) perforated pipe as per the 60.00% 0.5840% 127 m 19 6500.00 123,500.00 Laying of G 1000 Polythene cover to protect the waterproofing layer in back 100.00% 0.0788% 128 Item 1.00 10,000.00 10,000.00 12,688,998.00 8.9153% 3.5435% 3.4931% 4.4279% 4.2262% 20.1086% 0.6505% 16.6370%

  17. Price Indices Category M22 P1 P2 M21 M13 M19 M27 M6 M14 M24 M46 M36 M20 M26 M38 Heavy Equipme nt Formwork Timber General Timber Reinforceme nt Steel Sanitary Items Structura l Steel ZnAl Sheets PVC Pipes Electrical Wires Electrical Fittings Input % Input % Input % Input % Input % Input % Paint Input % Rubble Input % Input % Glass Input % Input % Input % Input % Input % Input % Aluminiu m Doors 1.00 60.00% 0.0512% 100.00% 60.00% 0.2239% 100.00% 100.00% 100.00% 60.00% 100.00% 100.00% 0.0087% 99.60% 0.0166% 99.60% 0.0230% 99.47% 0.0390% 99.47% 0.0636% 99.47% 0.0140% 99.41% 0.0620% 99.41% 0.1861% 99.41% 0.0561% 99.41% 0.0895% 99.41% 0.0259% 99.41% 0.0575% 99.41%

  18. 0.2369% 99.41% 0.0143% 99.41% 0.0030% 99.41% 0.0032% 99.41% 38.31% 0.5757% 100.00% 38.31% 0.3831% 100.00% 38.31% 0.3508% 100.00% 38.31% 0.3508% 100.00% 62.09% 0.4528% 100.00% 62.09% 0.3083% 100.00% 68.55% 0.4199% 99.99% 57.63% 0.1356% 99.90% 57.63% 0.2565% 99.90% 57.63% 0.0790% 99.90% 68.37% 0.5965% 100.00% 75.57% 1.0774% 106.76% 75.57% 3.1678% 106.76% 75.57% 1.7045% 106.76% 92.80% 94.05% 15.28% 0.0274% 95.25% 15.28% 0.0494% 95.25% 50.00% 50.00% 50.00% 0.0980% 7.82% 0.0616% 47.23% 0.3722% 100.00% 0.3020% 7.82% 0.1898% 47.23% 1.1464% 100.00% 0.0711% 40.00% 0.2845% 100.00% 0.2298% 40.00% 0.9194% 100.00% 0.0674% 40.00% 0.2697% 100.00% 5.03% 0.0206% 82.91% 0.3398% 99.71%

  19. 5.03% 0.0714% 82.91% 1.1761% 99.71% 73.26% 0.3464% 99.04% 6.83% 0.1241% 68.16% 1.2387% 92.67% 6.83% 0.0648% 68.16% 0.6462% 92.67% 6.83% 0.0657% 68.16% 0.6553% 92.67% 6.83% 0.0097% 68.16% 0.0967% 92.67% 6.83% 0.0129% 68.16% 0.1289% 92.67% 60.00% 0.0411% 100.00% 60.00% 2.5137% 100.00% 60.00% 0.8511% 100.00% 60.00% 0.0189% 100.00% 60.00% 0.0189% 100.00% 60.00% 0.0757% 100.00% 60.00% 0.0511% 100.00% 60.00% 0.0709% 100.00% 60.00% 0.0151% 100.00% 60.00% 0.0303% 100.00% 60.00% 0.0151% 100.00% 60.00% 0.0851% 100.00% 60.00% 0.0908% 100.00% 60.00% 0.0189% 100.00% 100.00% 0.0394% 100.00% 100.00% 0.0315% 100.00% 100.00% 0.0315% 100.00% 75.00% 3.5207% 100.00% 70.00% 70.00% 40.00% 0.1639% 100.00% 47.38% 0.0747% 99.99% 58.69% 0.1850% 90.19% 60.00% 0.3310% 100.00% 75.48% 0.0595% 100.01% 84.35% 0.0465% 100.00%

  20. 100.00% 100.00% 100.00% 57.73% 0.0273% 89.23% 57.73% 0.0114% 89.23% 40.00% 0.0158% 10.00% 0.0039% 10.00% 0.0039% 100.00% 20.00% 0.0205% 40.00% 0.0410% 100.00% 69.67% 0.0571% 100.00% 69.67% 0.0769% 100.00% 30.30% 0.2269% 34.89% 0.2612% 83.89% 29.38% 0.1667% 36.37% 0.2064% 83.89% 72.04% 0.3179% 3.36% 0.0148% 100.00% 72.04% 0.1135% 3.36% 0.0053% 100.00% 15.01% 0.1029% 74.81% 0.5129% 98.64% 20.00% 0.0315% 20.00% 0.0315% 100.00% 93.31% 93.96% 93.31% 93.31% 96.50% 96.64% 96.50% 96.50% 96.50% 94.50% 96.50% 33.93% 0.2378% 96.85% 33.93% 0.2882% 96.85% 100.00% 0.3192% 100.00% 100.00% 0.0158% 100.00% 100.00% 0.0315% 100.00% 2.00% 0.0060% 100.00%

  21. 2.50% 0.0047% 92.50% 100.00% 0.0121% 99.78% 40.00% 0.3893% 100.00% 100.00% 2.0159% 0.3301% 3.9879% 1.7683% 7.8553% 0.6820% 0.9329% 0.0922% 1.8224% 0.4429% 4.0871% 5.1381% 7.5964% 0.0764% 1.1701% 100.0000% WaSSIP Staff
