SOROCA PROJECT LAUNCH WORKSHOP

SOROCA PROJECT LAUNCH WORKSHOP. Soroca WWTP Project - Constructed Wetlands as a Locally Appropriate Technology Dr. Konrad Buchauer 10.12.2007 Soroca, Moldova. Table of Contents. Reasons for choosing Constructed Wetlands Constructed Wetlands – Technology and Construction

nerea-case
Download Presentation

SOROCA PROJECT LAUNCH WORKSHOP

An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript

  1. SOROCA PROJECT LAUNCH WORKSHOP Soroca WWTP Project - Constructed Wetlands as a Locally Appropriate Technology Dr. Konrad Buchauer 10.12.2007 Soroca, Moldova

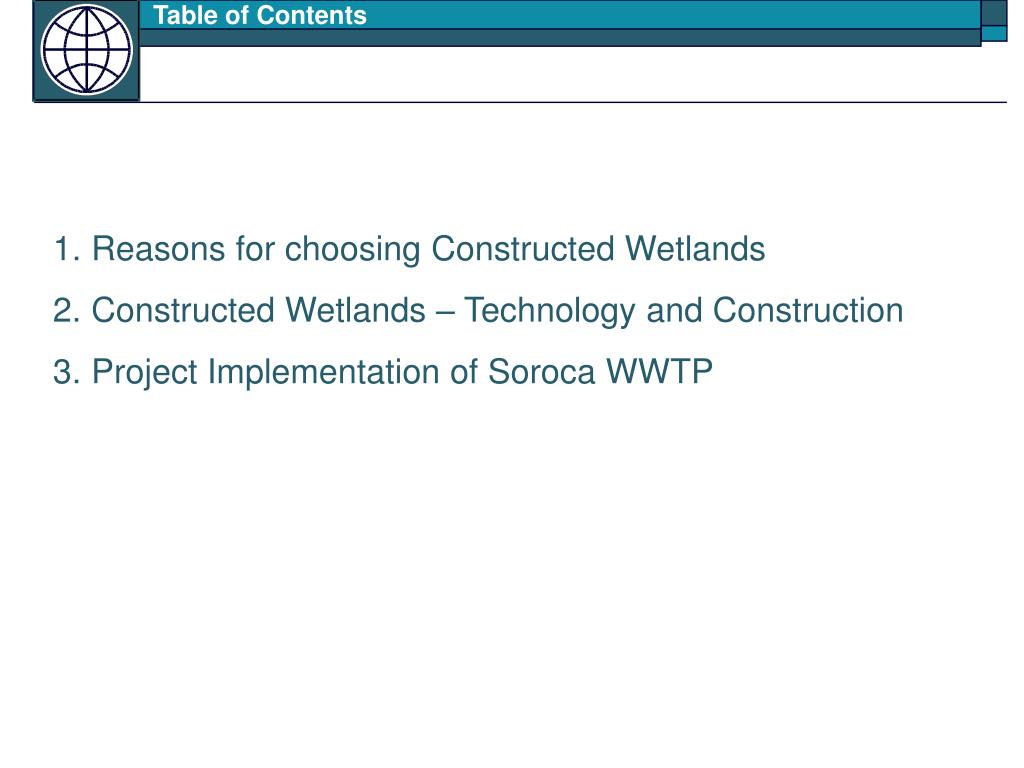

  2. Table of Contents Reasons for choosing Constructed Wetlands Constructed Wetlands– Technology and Construction Project Implementation of Soroca WWTP

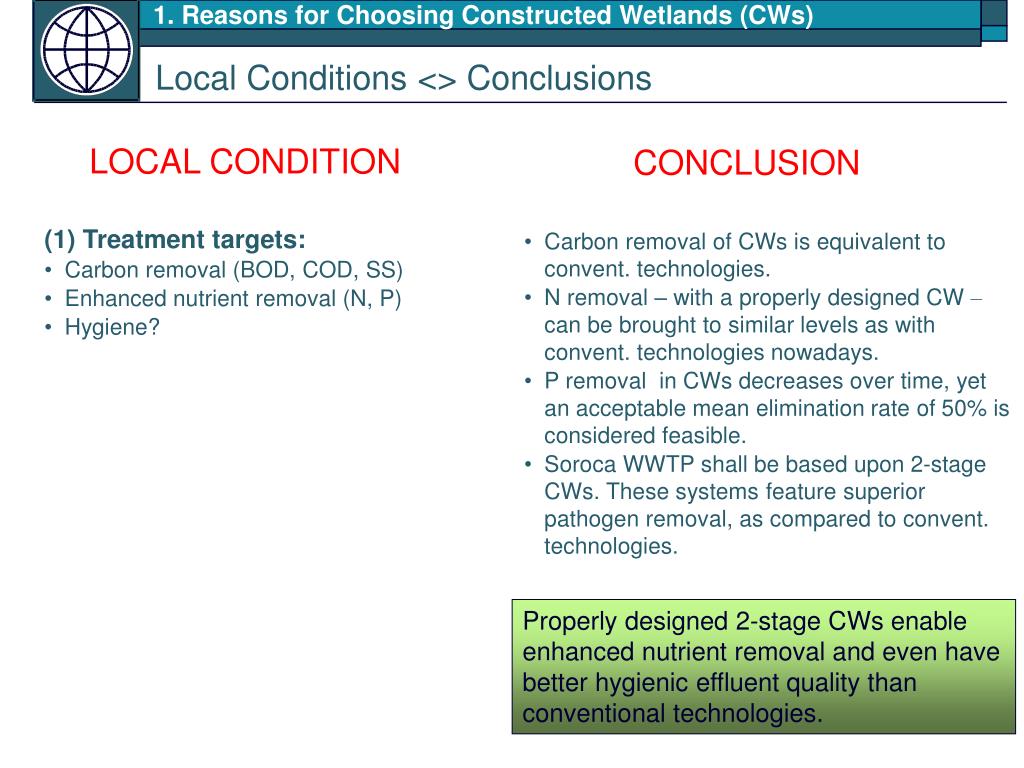

  3. 1. Reasons for Choosing Constructed Wetlands (CWs) Local Conditions <> Conclusions LOCAL CONDITION CONCLUSION • (1) Treatment targets: • Carbon removal (BOD, COD, SS) • Enhanced nutrient removal (N, P) • Hygiene? • Carbon removal of CWs is equivalent to convent. technologies. • N removal – with a properly designed CW – can be brought to similar levels as with convent. technologies nowadays. • P removal in CWs decreases over time, yet an acceptable mean elimination rate of 50% is considered feasible. • Soroca WWTP shall be based upon 2-stage CWs. These systems feature superior pathogen removal, as compared to convent. technologies. Properly designed 2-stage CWs enable enhanced nutrient removal and even have better hygienic effluent quality than conventional technologies.

  4. 1. Reasons for Choosing Constructed Wetlands (CWs) summer winter Local Conditions <> Conclusions CONCLUSION LOCAL CONDITION (2) Cold winter temperatures and snowfall • Latest design criteria take due consideration of cold temperatures. • There exist about 20 years of practical experience with CWs in Central Europe under climate zones comparable to Moldova (France, Austria, Germany, Switzerland, etc.). • CWs, of course, look different in winter time, but nonetheless work satisfactorily. Properly designed 2-stage CWs will continue working properly in winter time.

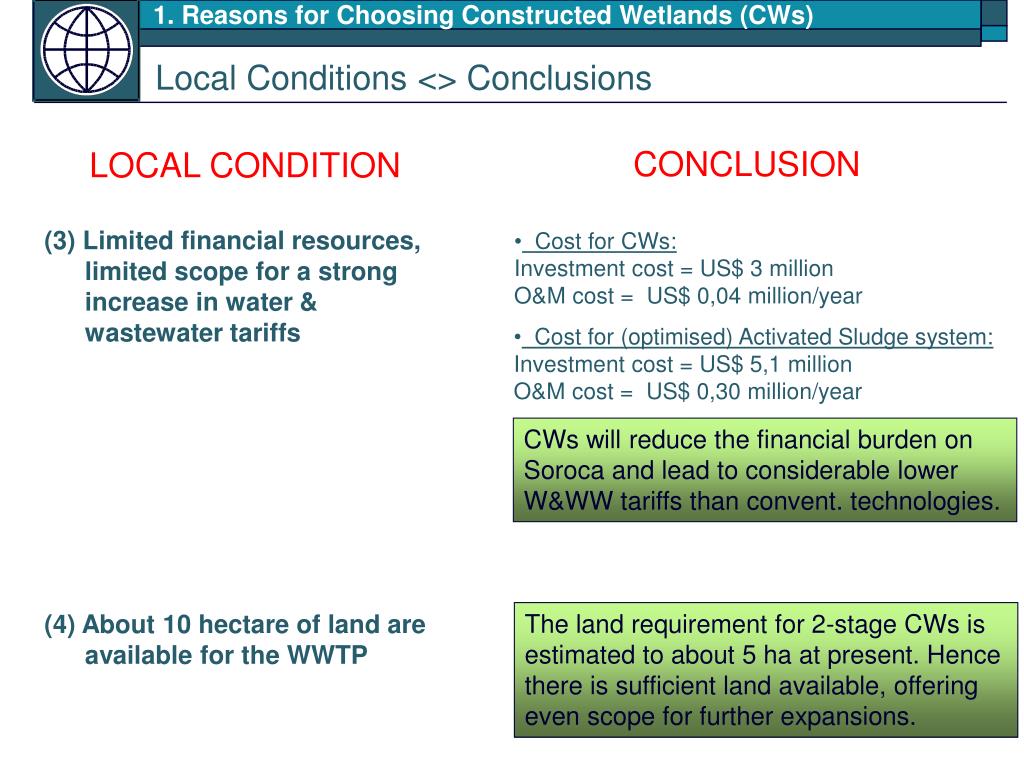

  5. 1. Reasons for Choosing Constructed Wetlands (CWs) Local Conditions <> Conclusions CONCLUSION LOCAL CONDITION (3) Limited financial resources, limited scope for a strong increase in water & wastewater tariffs • Cost for CWs: • Investment cost = US$ 3 million • O&M cost = US$ 0,04 million/year • Cost for (optimised) Activated Sludge system: • Investment cost = US$ 5,1 million • O&M cost = US$ 0,30 million/year CWs will reduce the financial burden on Soroca and lead to considerable lower W&WW tariffs than convent. technologies. The land requirement for 2-stage CWs is estimated to about 5 ha at present. Hence there is sufficient land available, offering even scope for further expansions. (4) About 10 hectare of land are available for the WWTP

  6. 1. Reasons for Choosing Constructed Wetlands (CWs) Local Conditions <> Conclusions CONCLUSION LOCAL CONDITION (5) Lack of skilled operators • The Soroca WWTP project will include staff training. Even though CWs are easy to operate, this is considered indispensable and will safeguard proper operation practices according to the latest know-how. • By contrast, the operation of convent. techn., such as AS, poses much higher challenges to operators. The difficulties not only relate to compliance with effluent criteria, but also to human safety. A relatively short training would not be sufficient for such a task. Typical WWTP operator training programmes in Central Europe take years, and are targeting professionals only (electrician, etc.). CWs can be satisfactorily operated by local staff after appropriate training.

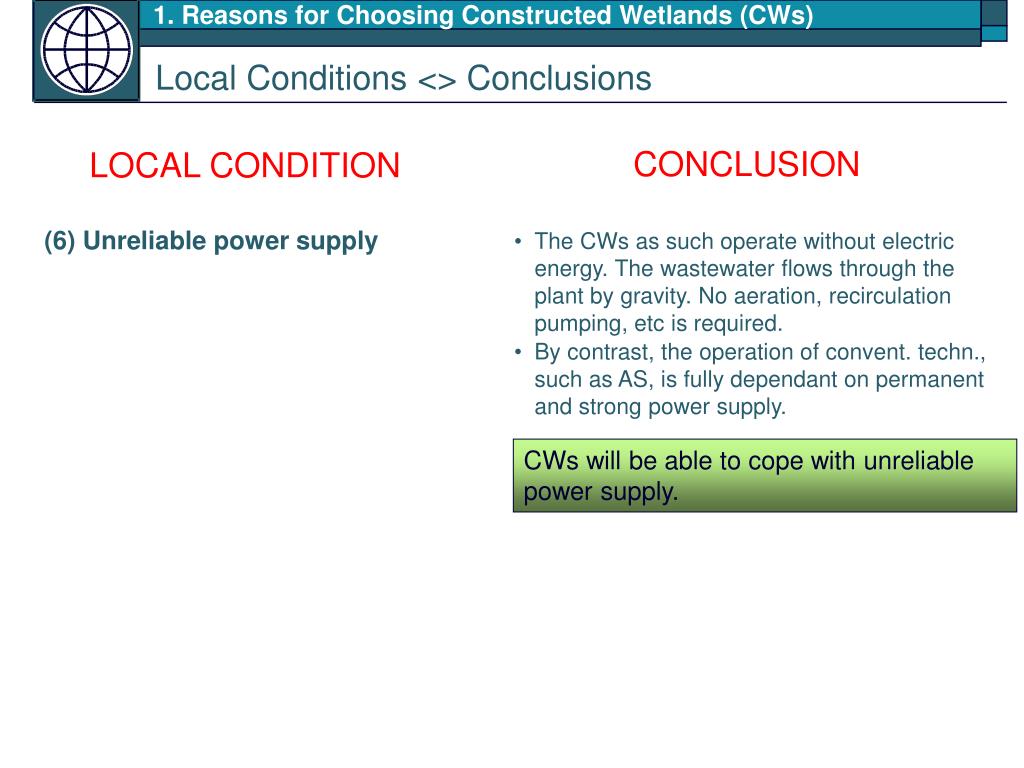

  7. 1. Reasons for Choosing Constructed Wetlands (CWs) Local Conditions <> Conclusions CONCLUSION LOCAL CONDITION (6) Unreliable power supply • The CWs as such operate without electric energy. The wastewater flows through the plant by gravity. No aeration, recirculation pumping, etc is required. • By contrast, the operation of convent. techn., such as AS, is fully dependant on permanent and strong power supply. CWs will be able to cope with unreliable power supply.

  8. 1. Reasons for Choosing Constructed Wetlands (CWs) Summary: Technol. Appropriateness under Local Cond. ● favourable-- unfavorable

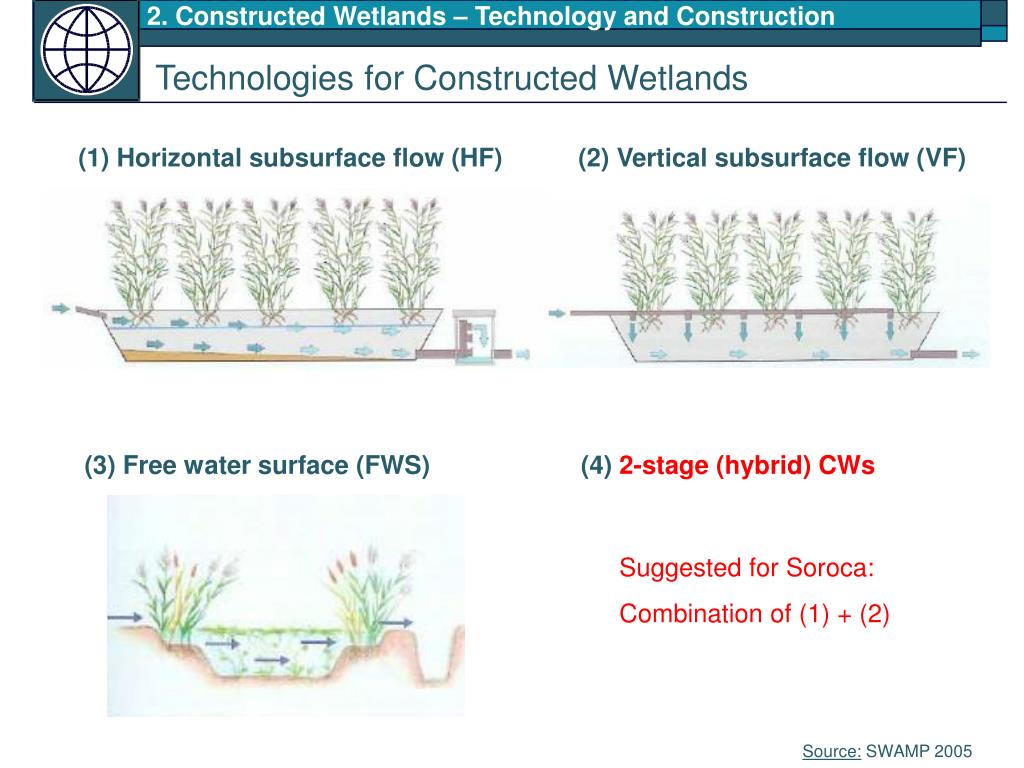

  9. 2. Constructed Wetlands – Technology and Construction Technologies for Constructed Wetlands (1) Horizontal subsurface flow (HF) (2) Vertical subsurface flow (VF) (3) Free water surface (FWS) (4) 2-stage (hybrid) CWs Suggested for Soroca: Combination of (1) + (2) Source: SWAMP 2005

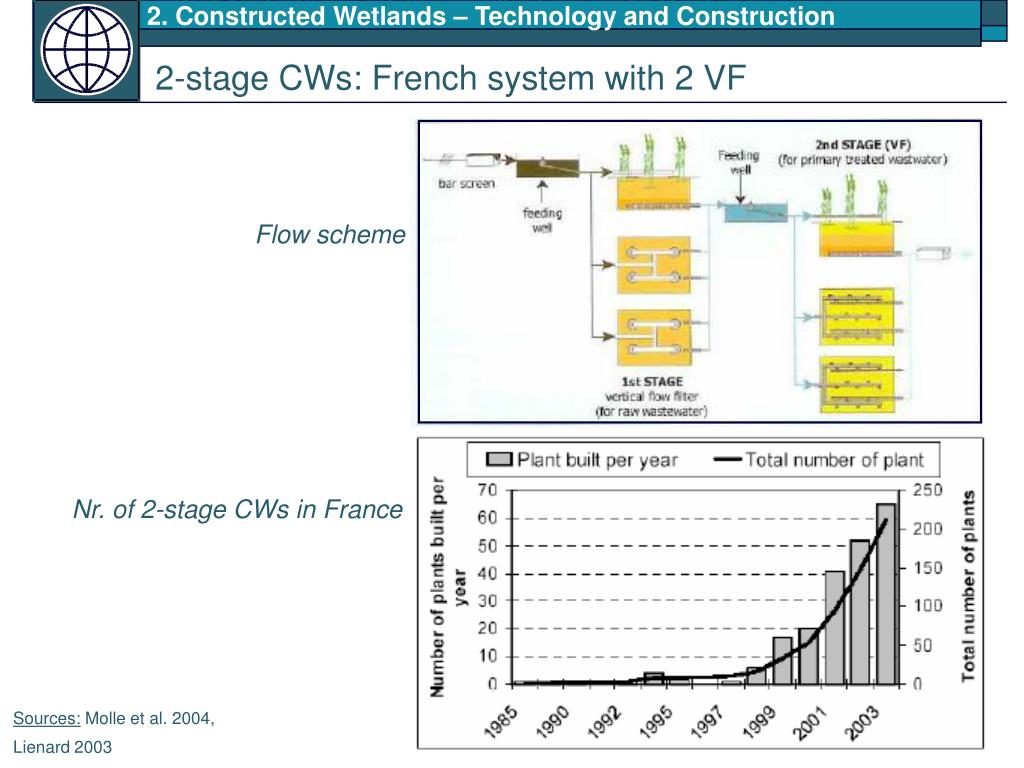

  10. 2. Constructed Wetlands – Technology and Construction 2-stage CWs: French system with 2 VF Flow scheme Nr. of 2-stage CWs in France Sources: Molle et al. 2004, Lienard 2003

  11. 2. Constructed Wetlands – Technology and Construction 2-stage CWs as compared to 1-stage CWs: Advantages • Approximately 50% of land requirement, as compared to 1–stage CWs. • Better treatment efficiency, particularly better nutrient and pathogen removal. • 20 years of practical experience. • No pre-treatment required, apart from screening (French system). • No need for separate sludge treatment ( French system).

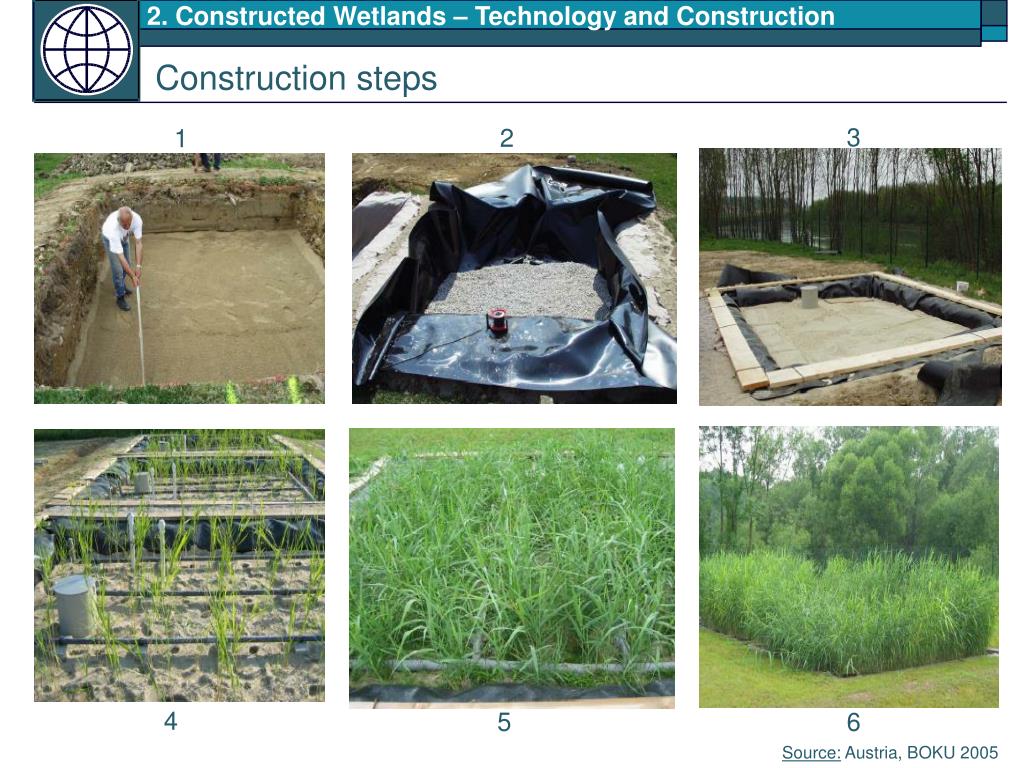

  12. 2. Constructed Wetlands – Technology and Construction 3 2 1 4 5 6 Construction steps Source: Austria, BOKU 2005

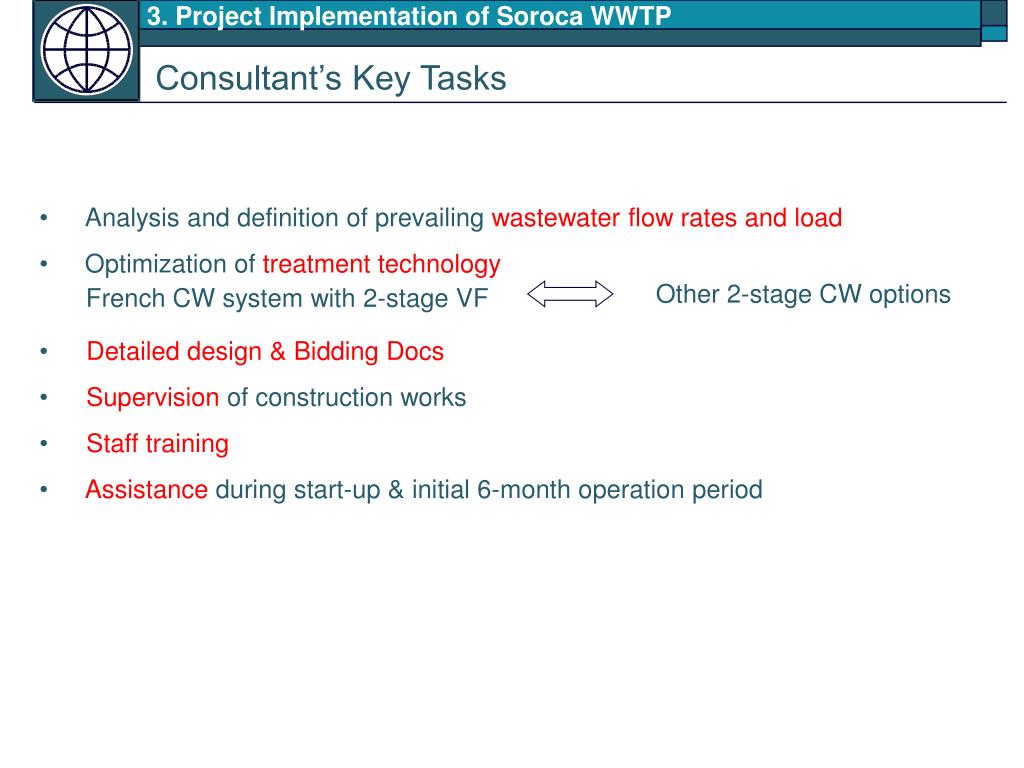

  13. 3. Project Implementation of Soroca WWTP • Analysis and definition of prevailing wastewater flow rates and load • Optimization of treatment technology Other 2-stage CW options French CW system with 2-stage VF • Detailed design & Bidding Docs • Supervision of construction works • Staff training • Assistance during start-up & initial 6-month operation period Consultant’s Key Tasks

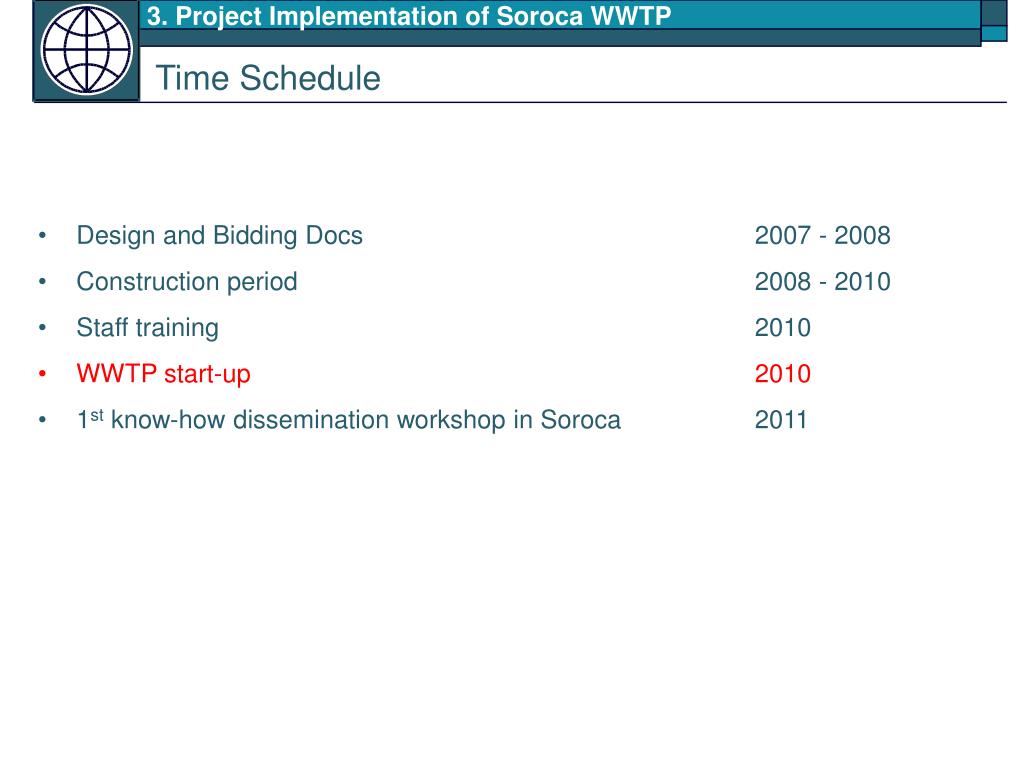

  14. 3. Project Implementation of Soroca WWTP Time Schedule • Design and Bidding Docs 2007 - 2008 • Construction period 2008 - 2010 • Staff training 2010 • WWTP start-up2010 • 1st know-how dissemination workshop in Soroca 2011
