An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript


  1. NEPOOL Reliability Committee MPRP TCA Application StatusCMP-09-TCA-01May 19th, 2009 Dave Conroy, Central Maine Power Company

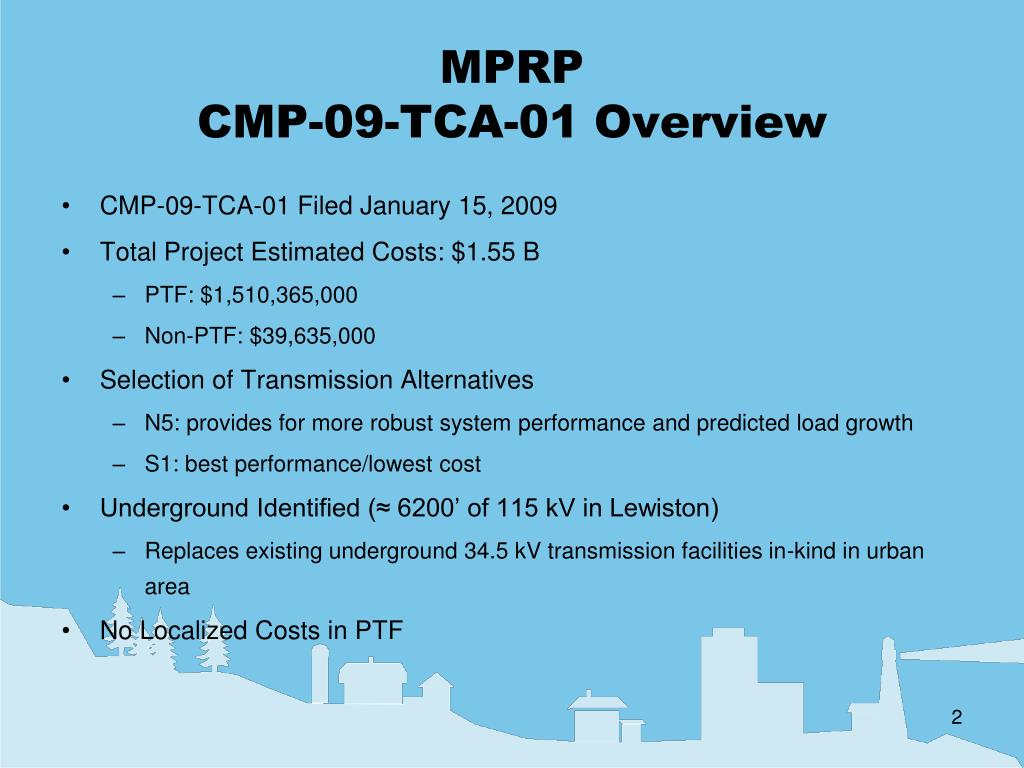

  2. MPRPCMP-09-TCA-01 Overview • CMP-09-TCA-01 Filed January 15, 2009 • Total Project Estimated Costs: $1.55 B • PTF: $1,510,365,000 • Non-PTF: $39,635,000 • Selection of Transmission Alternatives • N5: provides for more robust system performance and predicted load growth • S1: best performance/lowest cost • Underground Identified (≈ 6200’ of 115 kV in Lewiston) • Replaces existing underground 34.5 kV transmission facilities in-kind in urban area • No Localized Costs in PTF

  3. MPRP Overview Continued • Needs Assessment Published June 2007 • Included in ISO RSP 2007 • Transmission Alternatives Assessment Published May 2008 • 5 Northern Alternatives Studied • 3 Southern Alternatives Studied • NERC Mandatory Reliability Criteria • Loss Analysis • Transfer Capability • PPA Report Published June 2008 • Included in ISO RSP 2008 • Maine Public Utilities Commission Certificate of Public Convenience & Necessity filed July 2008 • PPA Addendum Analyses for scope changes, Published Jan 2009 • Longevity of Upgrades • Special Protection Systems • Sensitivity to Wind Power • Sensitivity to Greenline project • Year of Need Analysis

  4. MPRPCMP-09-TCA-01 Next Steps • Awaiting ISO recommendation on construction of Section 254, Orrington-Coopers Mills (345 kV or 115 kV)[Cost in TCA = $134M, page 19 of Attachment N] • Seeking Reliability Committee recommendation vote at this meeting, except for Section 254, leaving that vote for a later date [TCA PTF Cost of $1,510M less Section 254 = $1,376M]
