1 / 22

TAC Report to the ERCOT Board

TAC Report to the ERCOT Board. April 15, 2003. Summary. PRRs 377, 379, 381 , 383 and 387 - vote RMR update 2003 Test Flight Dates OGRRs WMS work on PUCT #26376 - Market Design questions Future Items. PRR 377 – Canceled RMR Unit Start.

Download Presentation

TAC Report to the ERCOT Board

An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript


  1. TAC Report to the ERCOT Board April 15, 2003

  2. Summary • PRRs 377, 379, 381, 383 and 387 - vote • RMR update • 2003 Test Flight Dates • OGRRs • WMS work on PUCT #26376 - Market Design questions • Future Items

  3. PRR 377 – Canceled RMR Unit Start • Allows for partial compensation of RMR units if start ordered, then cancelled • If cancelled, ERCOT to post cost • No computer system impact; manual process • May 1, 2003 Effective Date • Approved by TAC with a 28-2 vote.

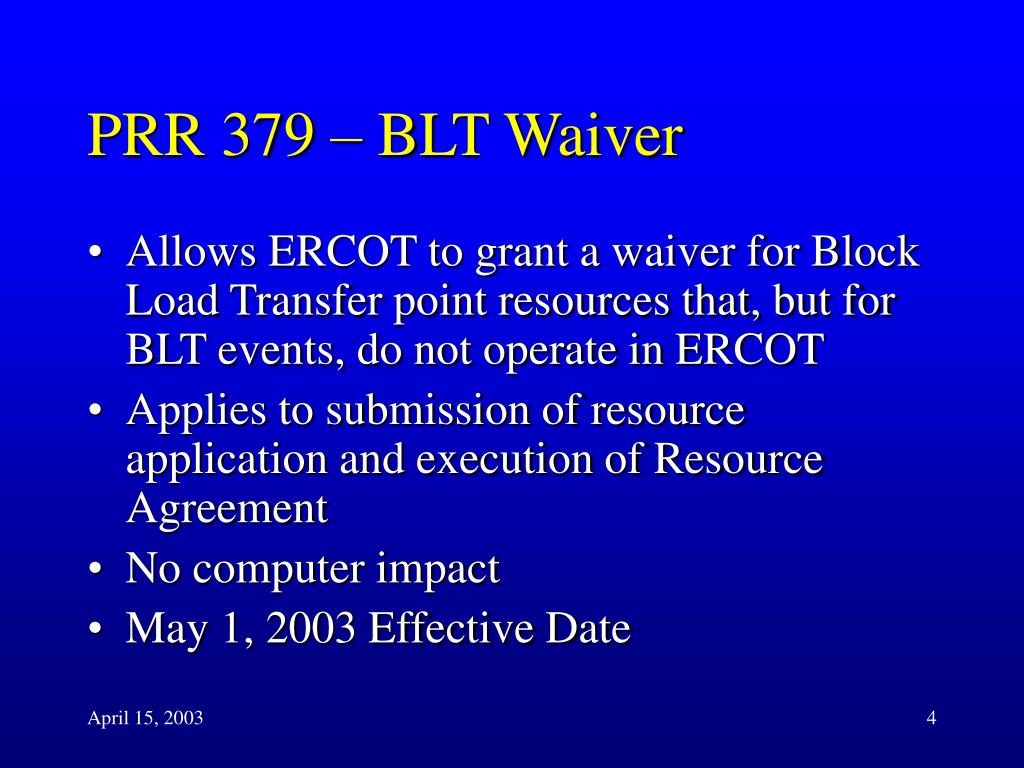

  4. PRR 379 – BLT Waiver • Allows ERCOT to grant a waiver for Block Load Transfer point resources that, but for BLT events, do not operate in ERCOT • Applies to submission of resource application and execution of Resource Agreement • No computer impact • May 1, 2003 Effective Date

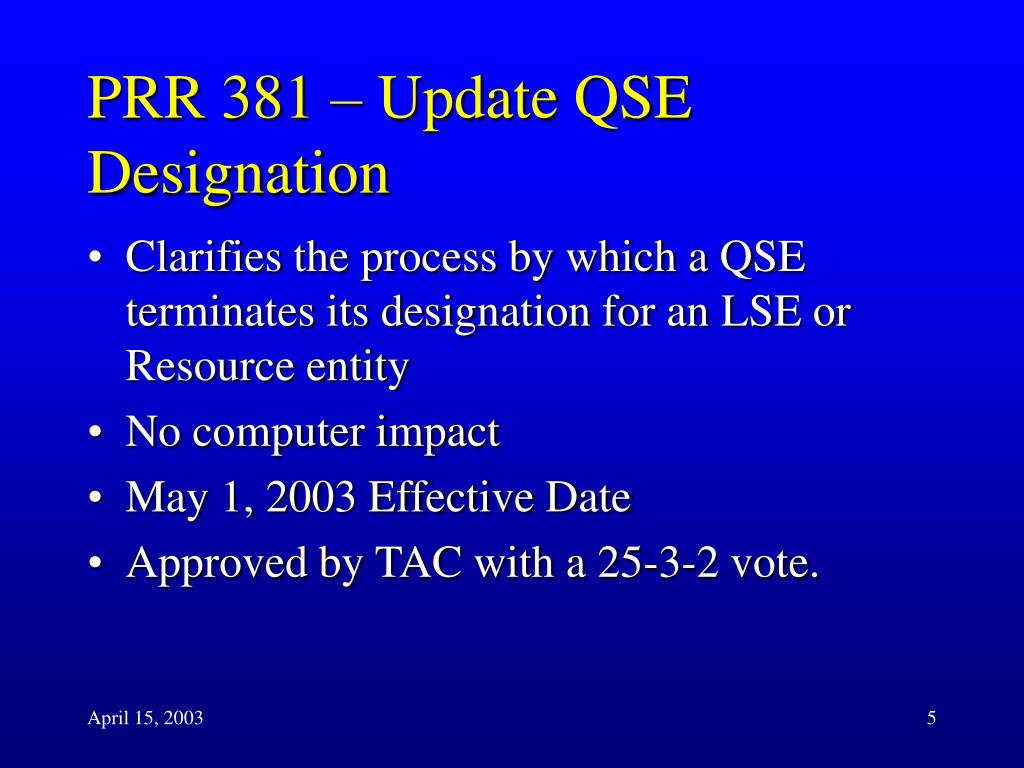

  5. PRR 381 – Update QSE Designation • Clarifies the process by which a QSE terminates its designation for an LSE or Resource entity • No computer impact • May 1, 2003 Effective Date • Approved by TAC with a 25-3-2 vote.

  6. PRR 383 – RMR Resource Maintenance Outage Approval • Provides a timeline for the approval of RMR unit outage requests • No computer impact • May 1, 2003 Effective Date

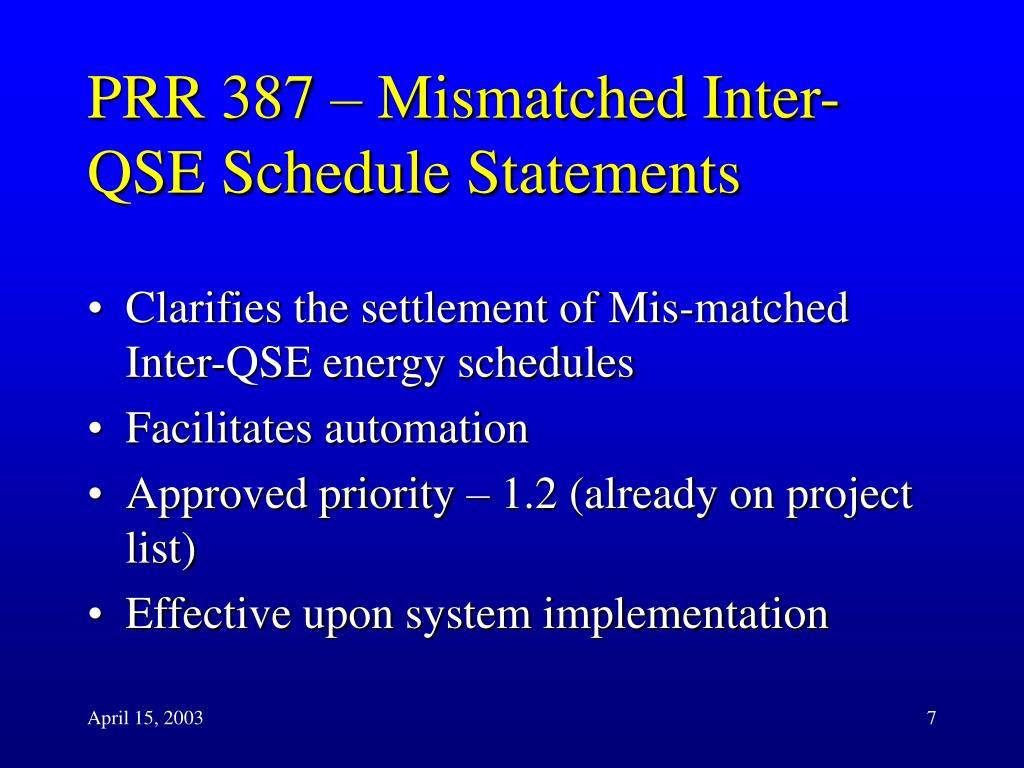

  7. PRR 387 – Mismatched Inter-QSE Schedule Statements • Clarifies the settlement of Mis-matched Inter-QSE energy schedules • Facilitates automation • Approved priority – 1.2 (already on project list) • Effective upon system implementation

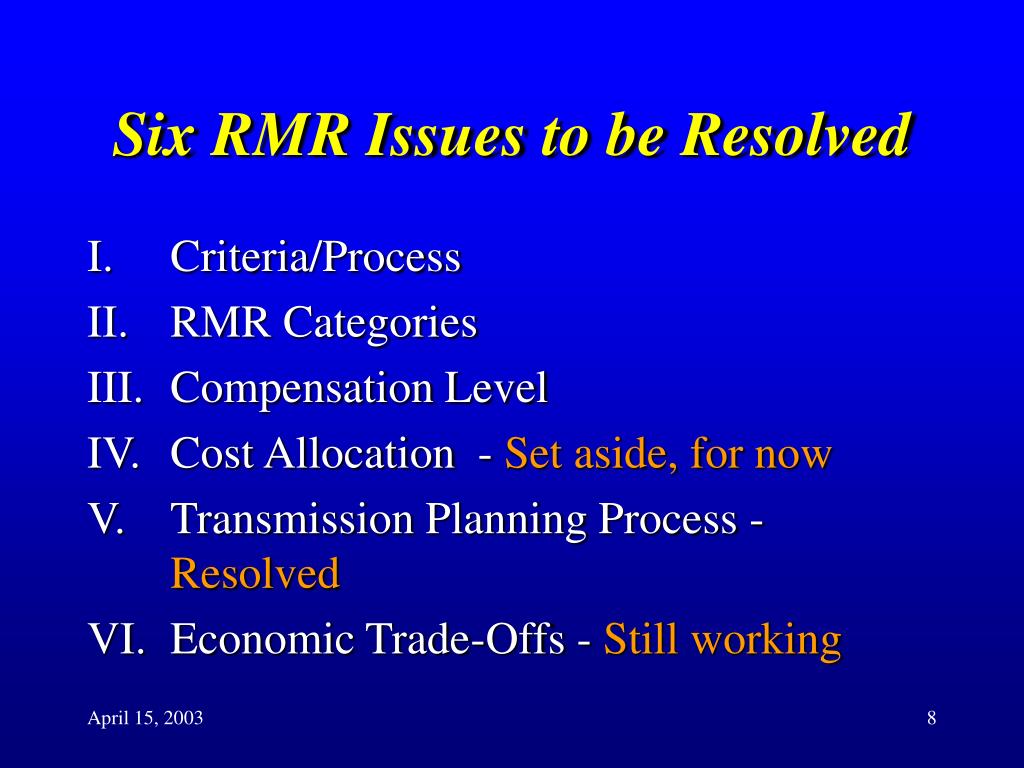

  8. Six RMR Issues to be Resolved I. Criteria/Process II. RMR Categories III. Compensation Level IV. Cost Allocation - Set aside, for now V. Transmission Planning Process - Resolved VI. Economic Trade-Offs - Still working

  9. Process • RMR TF provided options for the six concerns to PRS • PRS reviewed and made recommendations • TAC considered PRS recommendations and decided on high level options for the open issues (Decision Points) • TAC decisions guide language finalization • PRR returns for TAC/BOD approval in May

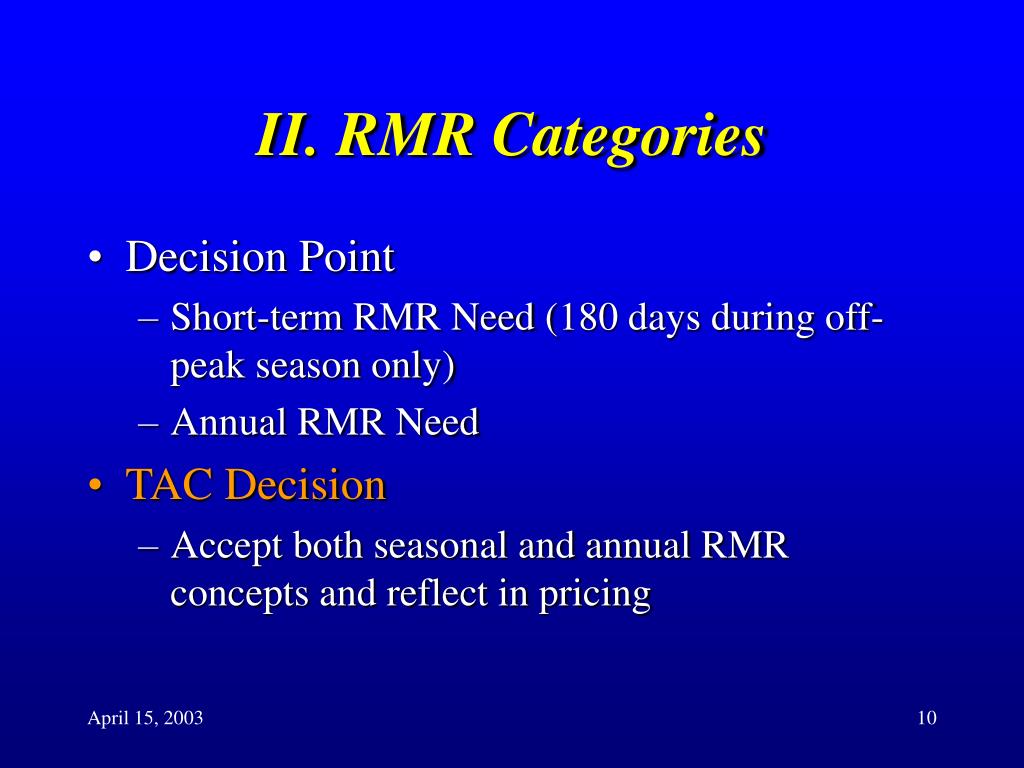

  10. II. RMR Categories • Decision Point • Short-term RMR Need (180 days during off-peak season only) • Annual RMR Need • TAC Decision • Accept both seasonal and annual RMR concepts and reflect in pricing

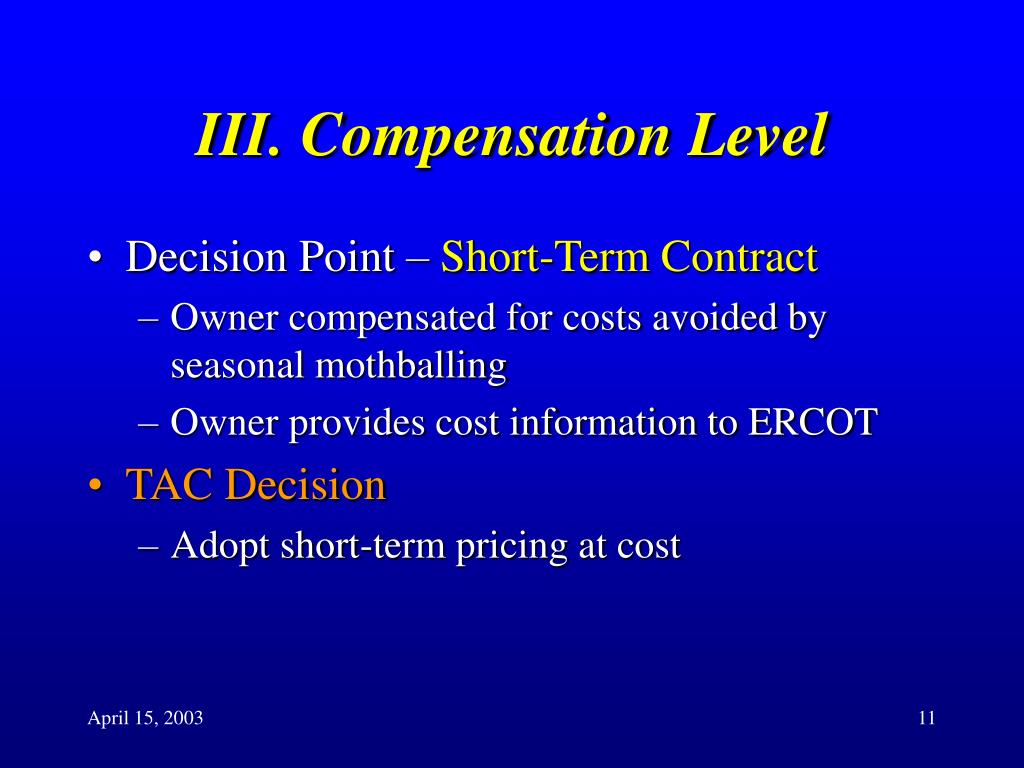

  11. III. Compensation Level • Decision Point – Short-Term Contract • Owner compensated for costs avoided by seasonal mothballing • Owner provides cost information to ERCOT • TAC Decision • Adopt short-term pricing at cost

  12. III. Compensation Level • Decision Point – Annual Contract • Proxy Price • Uses existing structure with lower payment components (Standby Price at 55% of SCGT; Change in fuel heat rate calculation) • “Cost Plus”

  13. “Cost Plus” • Initial monthly payments based on estimate of eligible costs then adjusted to actual • Incentive Factor (x% or flat rate?) applied to non-fuel eligible costs • Eligible Costs include labor, materials and supplies to operate the unit • Eligible Costs do not include return on equity, G&A, allocated general plant, taxes, interest expense, etc. • Fuel also based on estimate of cost with true-up • Eliminates start-up payment • TAC Decision • Adopt “cost plus” methodology

  14. I. Criteria / Process • Allows for multi-year contracts if significant capital expenditures required • CCGTs treated as a single unit unless separate operation possible • Qualification for RMR Applicant • Applicant attestation that resource is uneconomic to remain in service • Unavailable at least 180 days

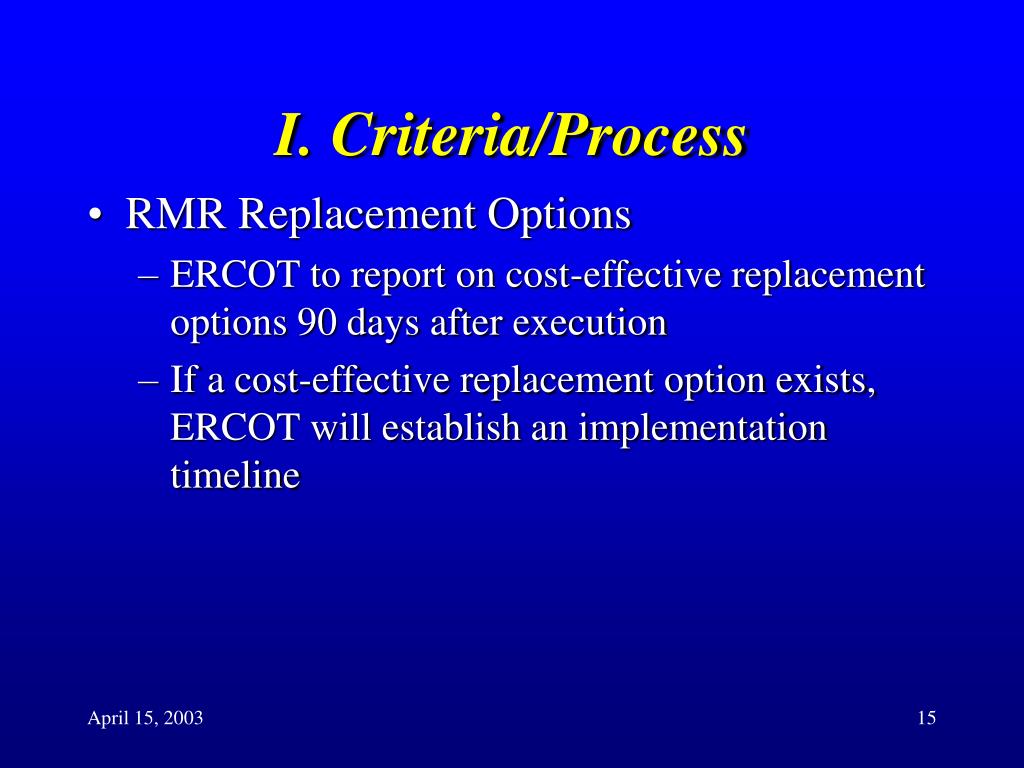

  15. I. Criteria/Process • RMR Replacement Options • ERCOT to report on cost-effective replacement options 90 days after execution • If a cost-effective replacement option exists, ERCOT will establish an implementation timeline

  16. I. Criteria/Process • Treatment of RMR Applicant • Non-selected applicant prohibited from future use unless reinstated during suspension period • ERCOT not accept schedules or bids during suspension period • ERCOT may reinstate under certain circumstances • Owner may petition PUC for reinstatement

  17. PRS Recommendation • TAC Decision • Non-selected RMR applicant would not be prohibited from operating in the market after ERCOT rejects the application • Fits with the “Cost Plus” methodology • Accept other provisions

  18. Test Plan Flight Dates • RMS approves the dates for future testing flights. This enables new market entries, TDSPs and ERCOT to plan when key deliverables are required and the key testing dates. • Failure to supply required documentation for a new test flight can result in a market participant being delayed until the next test flight before entering the retail market.

  19. New 2003 Test Plan FlightsAffirmed by TAC • Flight 0703 for New Market Participants testing under TX SET Version 1.5 • Flight will begin pre-test activities on April 8, 2003 • Deadline to Join Flight May 22, 2003 • First transactions July 14, 2003 • Flight Scheduled to End September 5, 2003 • Flight 1003 for New Market Participants testing under TX SET Version 1.5 and Possible Transaction Changes from COMET WG • Flight will begin pre-test activities on July 23, 2003 • Deadline to Join Flight September 4, 2003 • First transactions October 13, 2003 • Flight Scheduled to End December 5, 2003 • Another Flight is possible because of anticipated functionality changes from MIMO task force.

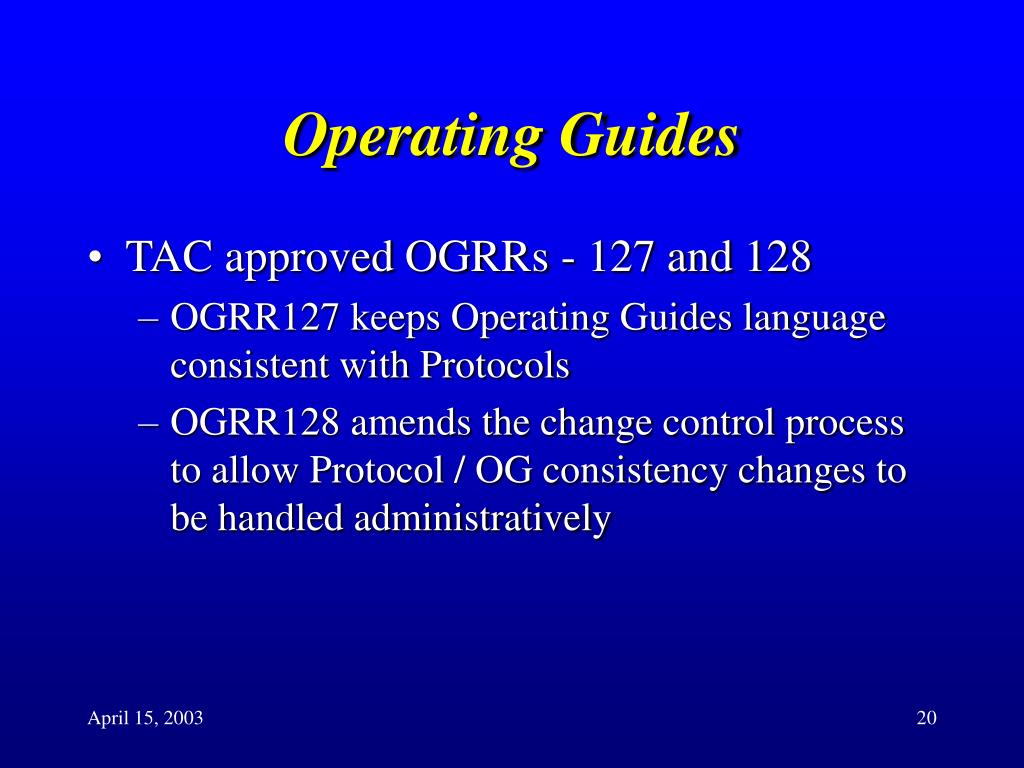

  20. Operating Guides • TAC approved OGRRs - 127 and 128 • OGRR127 keeps Operating Guides language consistent with Protocols • OGRR128 amends the change control process to allow Protocol / OG consistency changes to be handled administratively

  21. Advance Notice • WMS has accelerated the process to determine 2004 CSCs and resulting zonal definitions. • Recommendation to the Board for approval in June. • ROS finalizing work on new Reactive Power Standard
