  1. Progress Report Reverse Engineering of a Radio Controlled Car Team The C.O.R.E Presenters:MoemenTaha Ranuk de Silva The Petroleum Institute Abu Dhabi, United Arab Emirates

  2. Outline • Introduction • Work Completed • Work In Progress • Work Remaining

  3. Introduction • Purpose: The project is about improving the radio controlled car’s performance by enhancing its aerodynamics, decreasing its weight and increasing battery life. • This presentation will give an outline of the total project including the key milestones and the budget

  4. Work Completed • Around 80% of the project • Product dissection with documentation • COSMOSFloWorks analysis • Speed test • Battery life test • Sustainability test • The CAD design for the prototype created • Budget accumulated: AED 33,120

  5. COSMOSFloWorks analysis

  6. Conceptual designs Design 1 Design 2

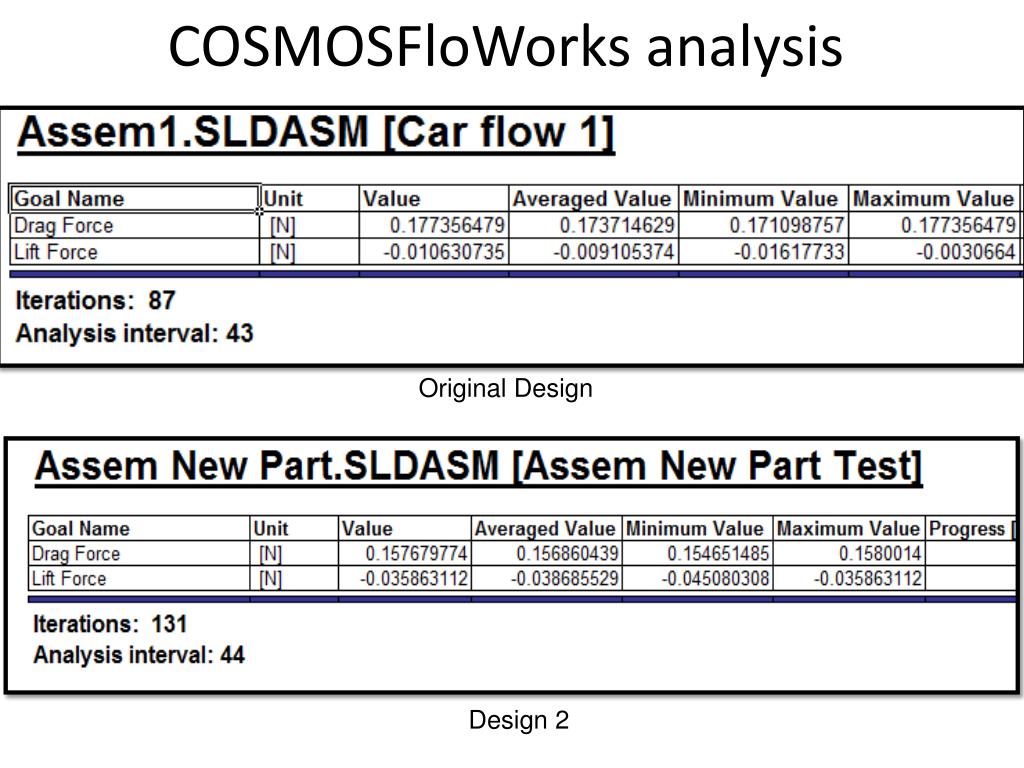

  7. COSMOSFloWorksanalysis Design 1 Design 2

  8. COSMOSFloWorksanalysis Original Design Design 2

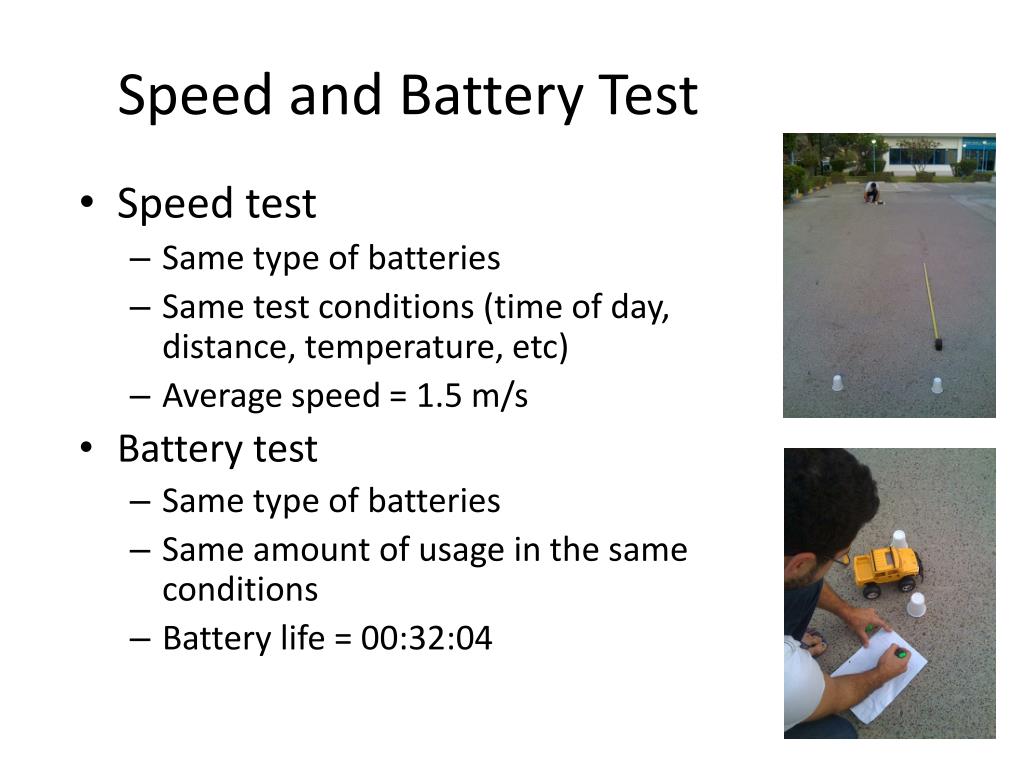

  9. Speed and Battery Test • Speed test • Same type of batteries • Same test conditions (time of day, distance, temperature, etc) • Average speed = 1.5 m/s • Battery test • Same type of batteries • Same amount of usage in the same conditions • Battery life = 00:32:04

  10. Sustainability test

  11. Sustainability test

  12. Sustainability test

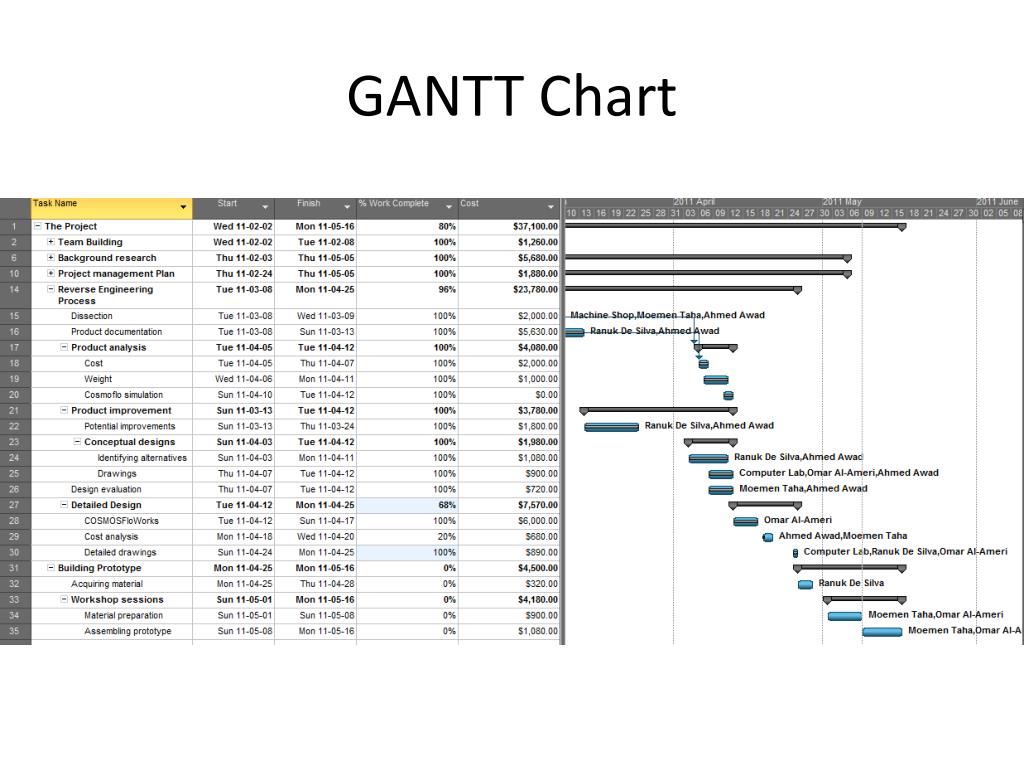

  13. GANTT Chart

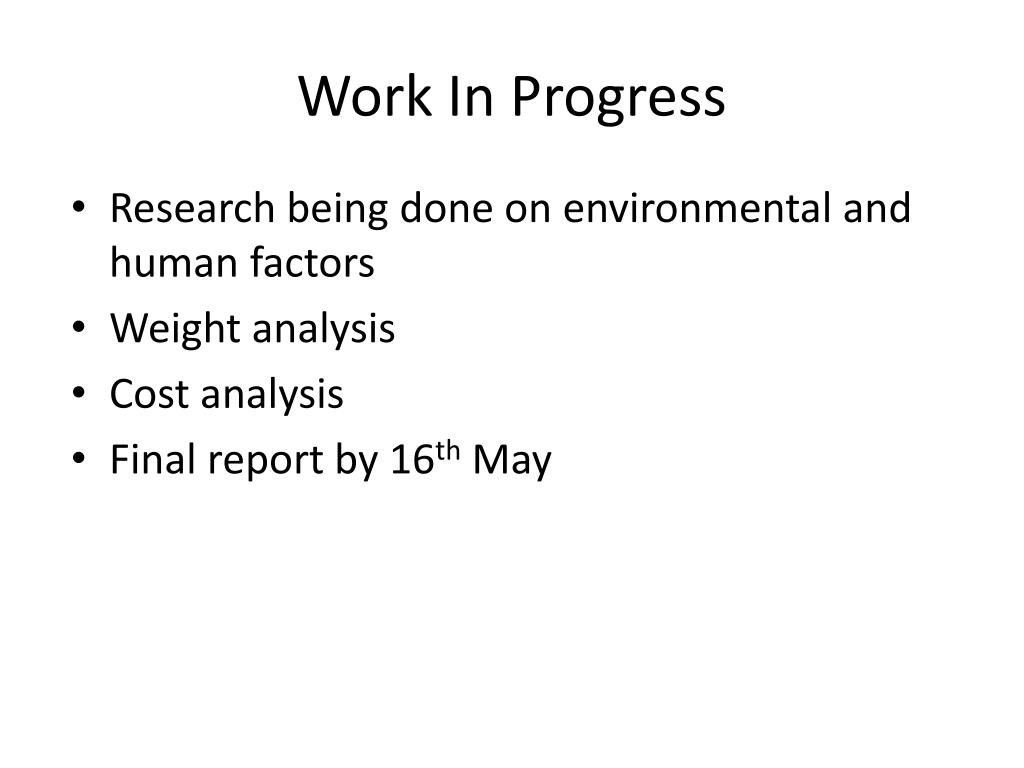

  14. Work In Progress • Research being done on environmental and human factors • Weight analysis • Cost analysis • Final report by 16th May

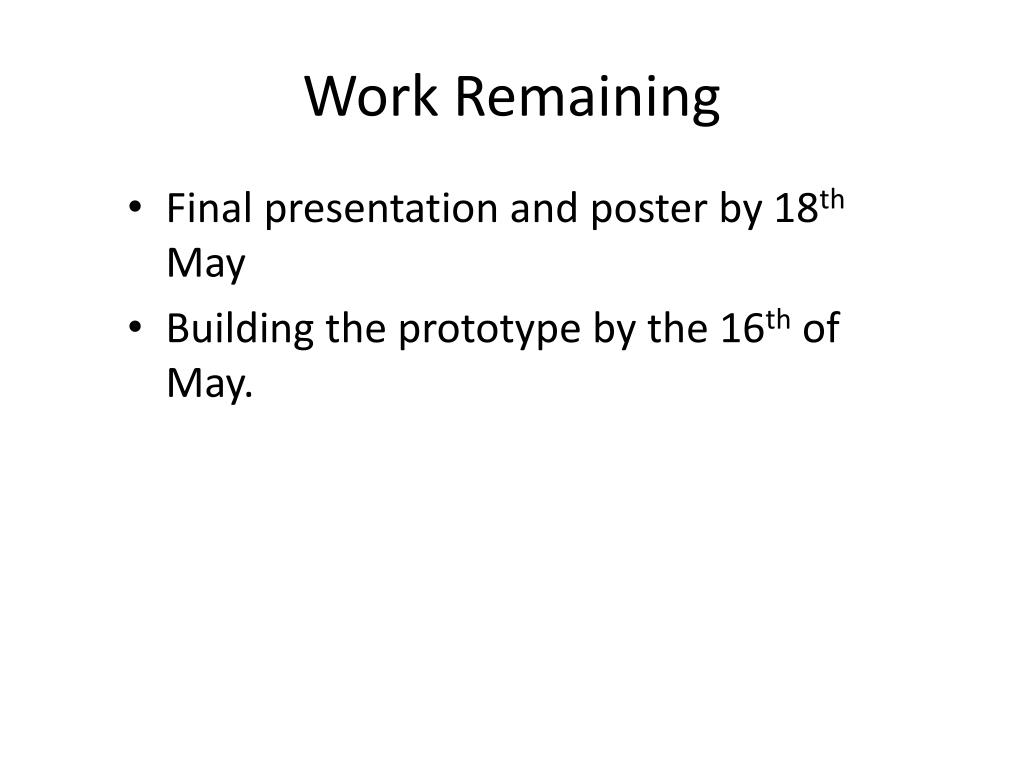

  15. Work Remaining • Final presentation and poster by 18th May • Building the prototype by the 16th of May.

  16. Pleasefeel free to askany questions Thank you for your time!
