  1. Construction Project Management Prepared By: Abd Ul-Rahman Jamal Barqawi Rana Omar Abu-Tayyoun Supervisor: Eng. BaraqJum’aa

  2. Graduation Project consist of two part: • Part 1) includes preparing a theoretical research • Part 2) includes the application of the principles in construction project management

  3. Introduction to Project ManagementWhat Is a project? • A project is a sequence of unique, complex, and connected activities having one goal or purpose and that must be completed by a specific time, within budget, and according to specification.

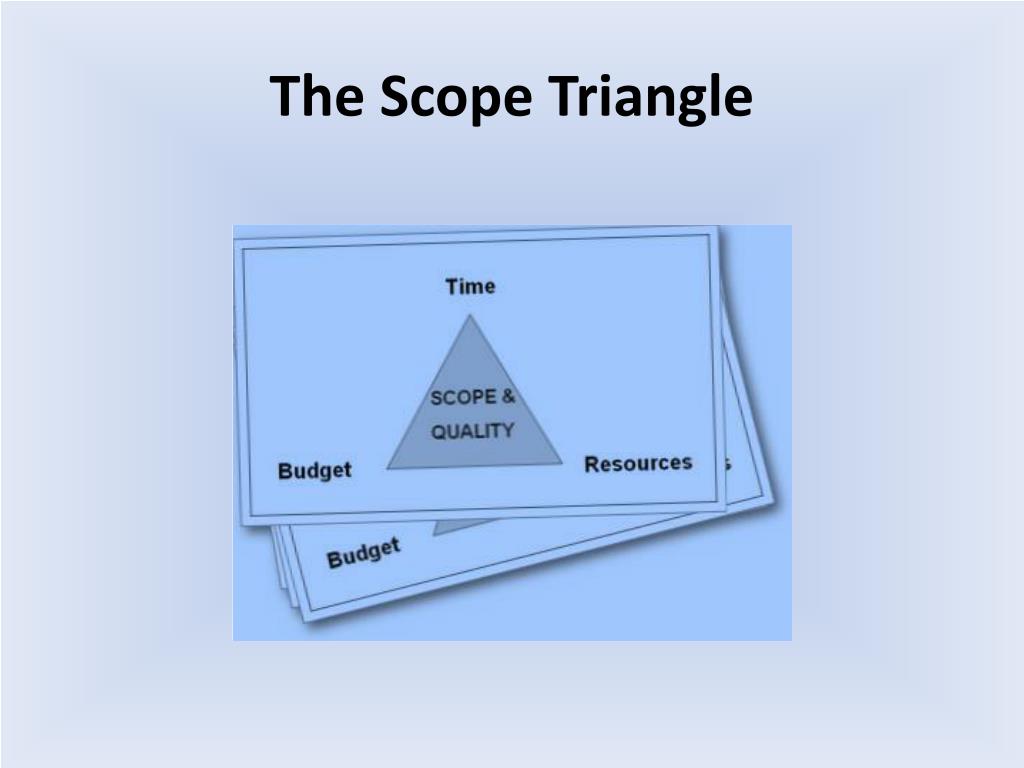

  4. The Scope Triangle

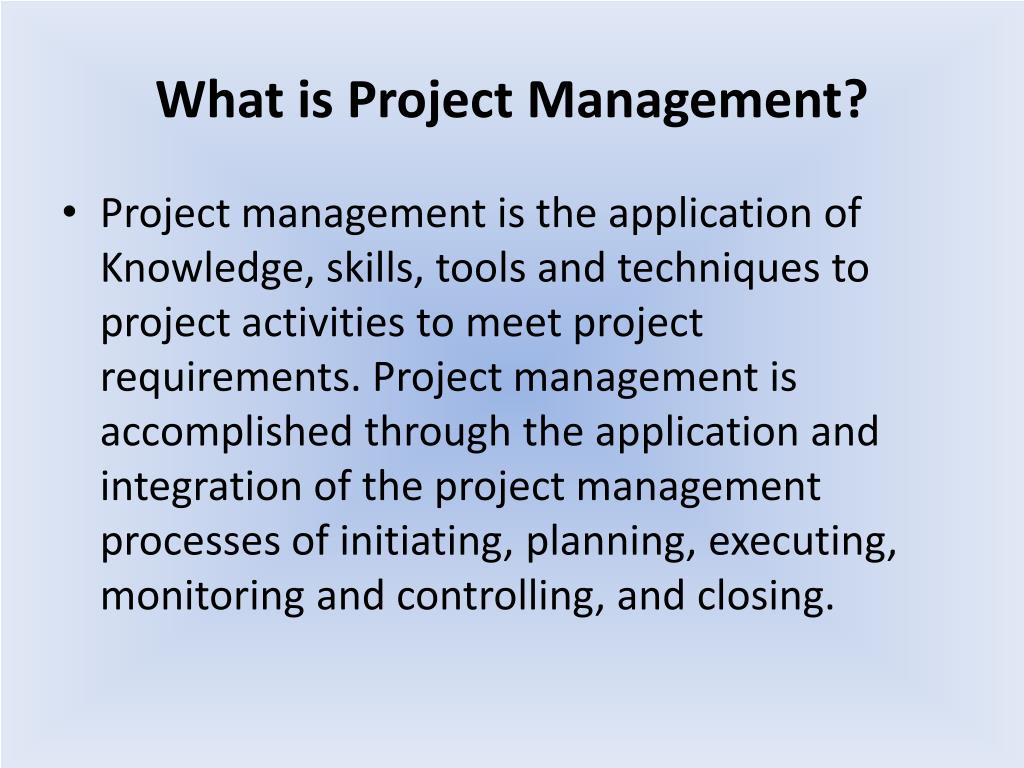

  5. What is Project Management? • Project management is the application of Knowledge, skills, tools and techniques to project activities to meet project requirements. Project management is accomplished through the application and integration of the project management processes of initiating, planning, executing, monitoring and controlling, and closing.

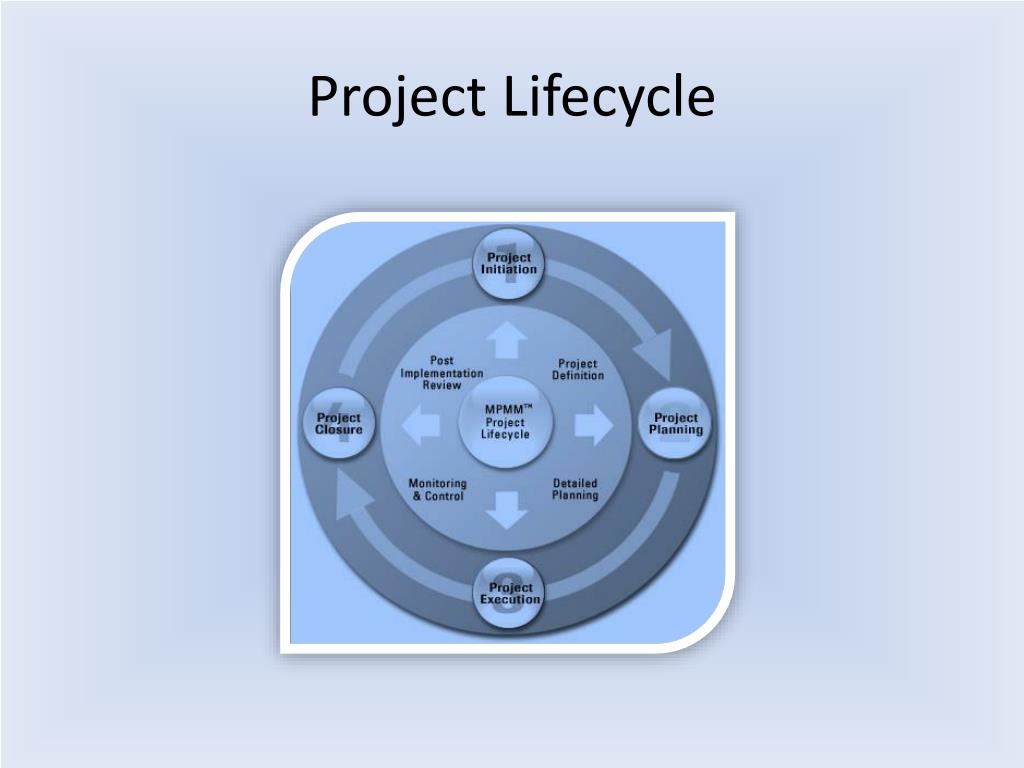

  6. Project Lifecycle

  7. Project ManagementBody Of Knowledge The PMI has identified nine topic areas to define the scope of project management knowledge as follows: • Project Integration Management • Project Scope Management • Project Time Management

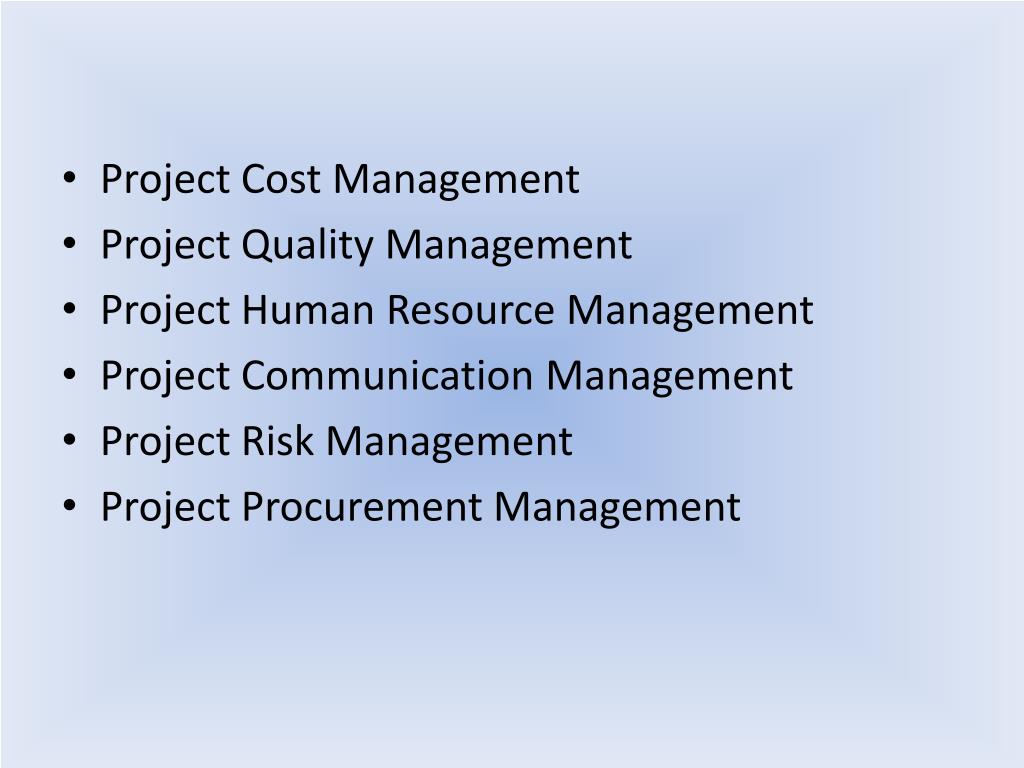

  8. Project Cost Management • Project Quality Management • Project Human Resource Management • Project Communication Management • Project Risk Management • Project Procurement Management

  9. Deir Al-Ghusun Basic Girls School

  10. Technical Description of the School Building

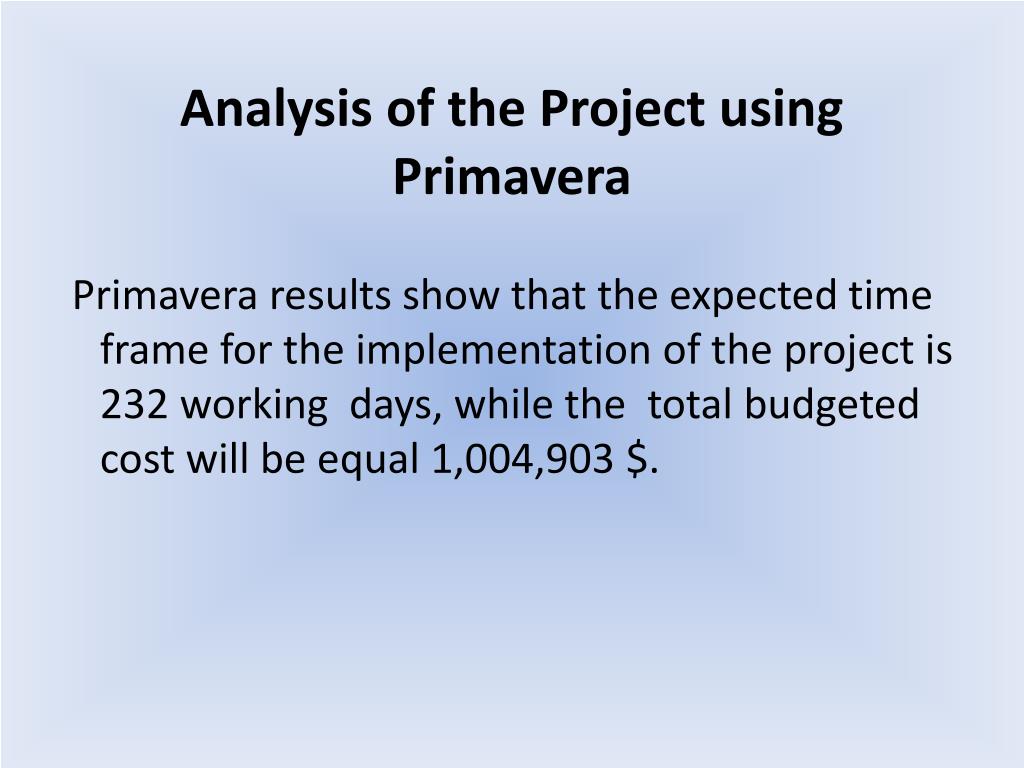

  11. Analysis of the Project using Primavera Primavera results show that the expected time frame for the implementation of the project is 232 working days, while the total budgeted cost will be equal 1,004,903 $.

  12. Work Break Down Structure

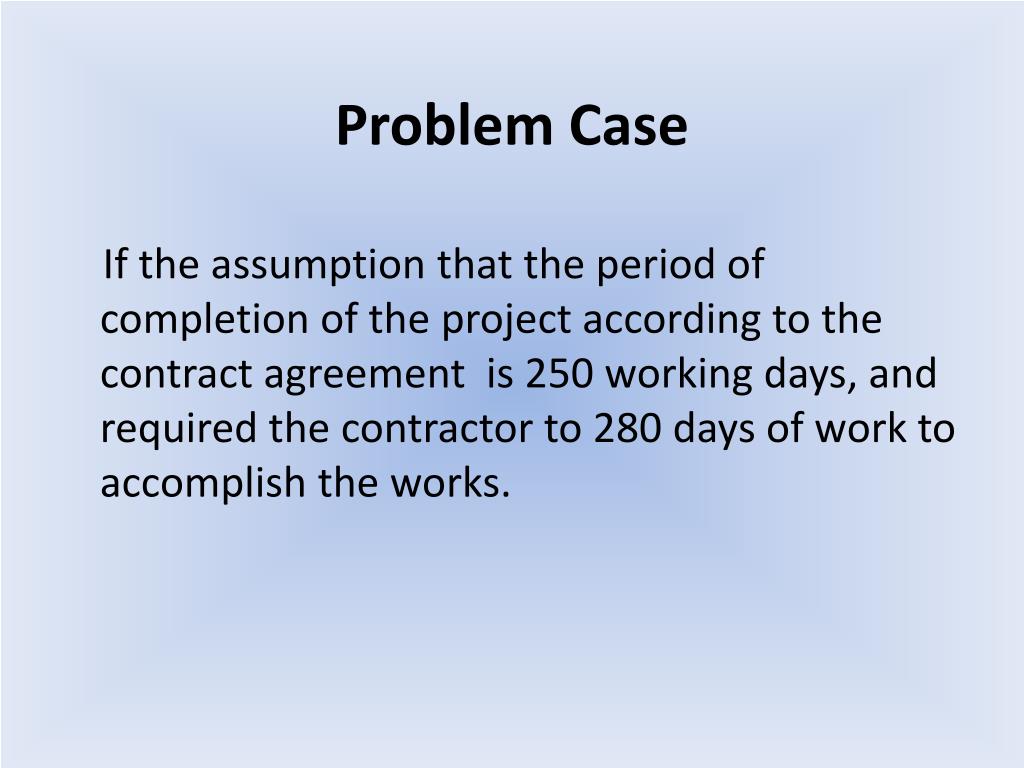

  13. Problem Case If the assumption that the period of completion of the project according to the contract agreement is 250 working days, and required the contractor to 280 days of work to accomplish the works.

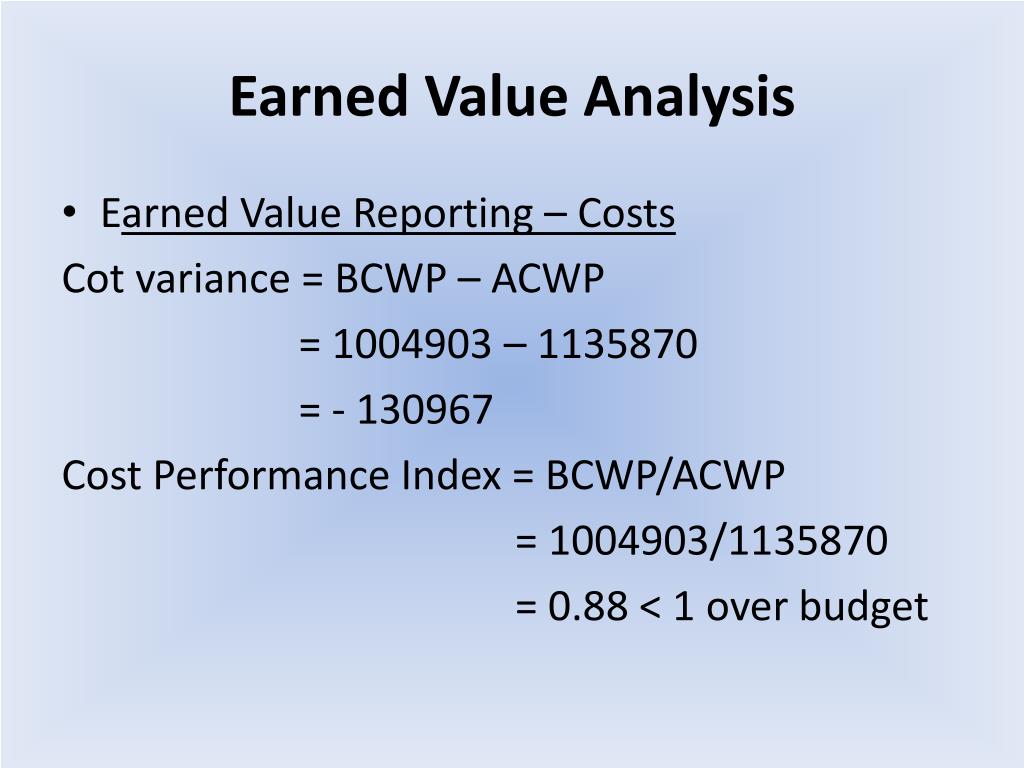

  14. Earned Value Analysis • Earned Value Reporting – Costs Cot variance = BCWP – ACWP = 1004903 – 1135870 = - 130967 Cost Performance Index = BCWP/ACWP = 1004903/1135870 = 0.88 < 1 over budget

  15. Earned Value Reporting – Schedule Schedule Variance = BCWP – BCWS = 1004903 – 1100000 = - 95097 Schedule Performance Index = BCWP / BCWS = 1004903/1100000 = 0.91 < 1 behind schedule
