OLDE TOWN ARVADA TOD Update to RTD Board September 3, 2013. Arvada’s TOD Vision.
E N D
Arvada’s TOD Vision Our team’s development proposal was conceived in response to the Project Vision and Goals contained in the Request for Qualifications. The Vision and Goals appropriately identify the qualities of a new, vibrant urban place that generates transit ridership and sound economic development, including: Quality design Connected Distinct character No surface parking Sustainable • Dense • Pedestrian Oriented • Mixed Use • Vibrant • Multi modal
Arvada TOD A Design That Meets The Vision Dense • Designed as urban, dense, and pedestrian oriented Mixed use • A mix of uses supporting a vibrant street oriented development Quality • Quality contemporary design supportive of OldeTown’s character Connected • Connected and grid oriented with activated street edges Structured parking • Strategy to structure parking for all uses on site Sustainable • Sustainable site and buildings to meet Healthy Community and LEED criteria Option A Option B
Arvada TOD Option A Program RTD Stand Alone Garage • 400 Parking Spaces at Wadsworth/Grandview (3 levels) • Bus Facility on Tiller Lot Site Residential • 250 Multi Family Residential • 182 Micro Residential Units Hotel at Vance • 108 Hotel rooms Retail • 46,000 SF
Arvada TOD Option B Program RTD Bus Station with Public Parking • 400 – 700 Parking Spaces • 8 Stall Bus Facility Hotel at Vance • 105 Hotel Rooms Residential • 300 Multi Family Units • 162 Micro Residential Units Retail • 28,500 SF
Arvada TOD Transit Plan Option B Perspective - 432 Parking Spaces and 8 Stall Bus Facility; Optional Bridge to Platform Theatre
Arvada TOD Grandview Old Wadsworth Option B LEVEL 1 - 43 SPACES 432 SPACES TOTAL Vance St. Theatre
Arvada TOD Transit Plan Option B3 Perspective - 690 Parking Spaces and 8 Stall Bus Facility; Optional Bridge to Platform Theatre
Arvada TOD Grandview Old Wadsworth Option B3 LEVEL 1 - 42 SPACES 690 SPACES TOTAL Vance St. Theatre
Arvada TOD Transit Plan OPTION B – 432 SPACES OPTION B3 – 690 SPACES
Arvada TOD Transit Plan View from Grandview Ave

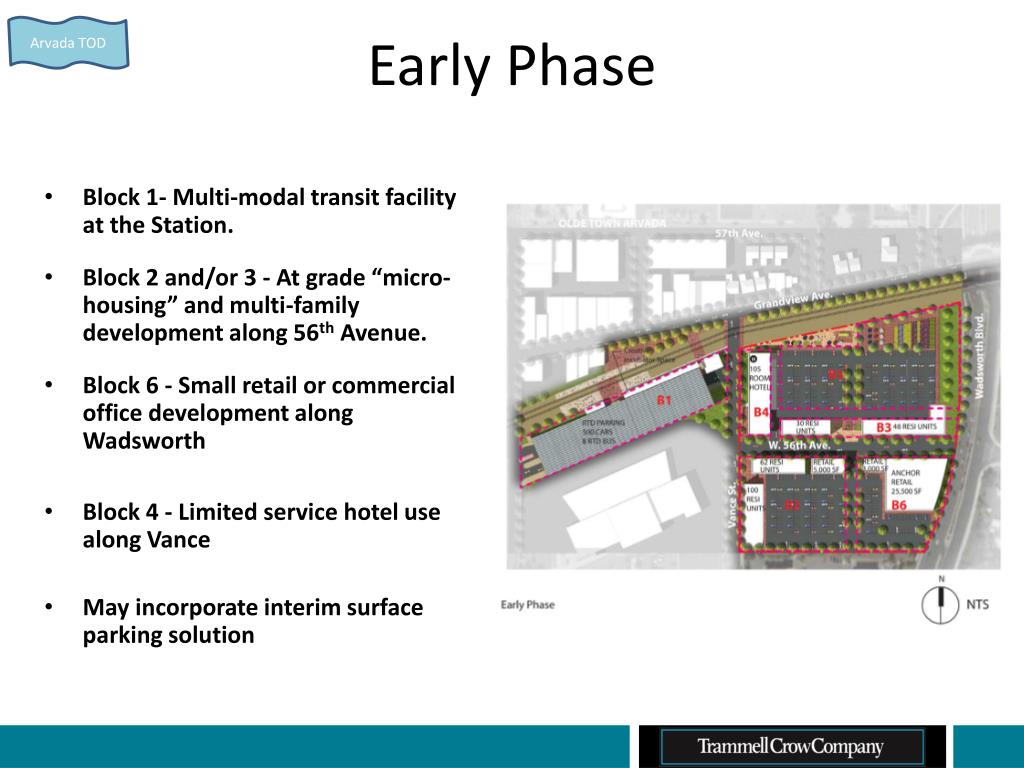

Arvada TOD Early Phase • Block 1- Multi-modal transit facility at the Station. • Block 2 and/or 3 - At grade “micro-housing” and multi-family development along 56th Avenue. • Block 6 - Small retail or commercial office development along Wadsworth • Block 4 - Limited service hotel use along Vance • May incorporate interim surface parking solution
Arvada TOD Later Phase • Block 4 – Limited Service Hotel Use along Vance • Block 5 - Multi-family housing on a parking podium along Grandview and Wadsworth • Accommodate parking for adjacent uses as required if land being used for interim surface parking

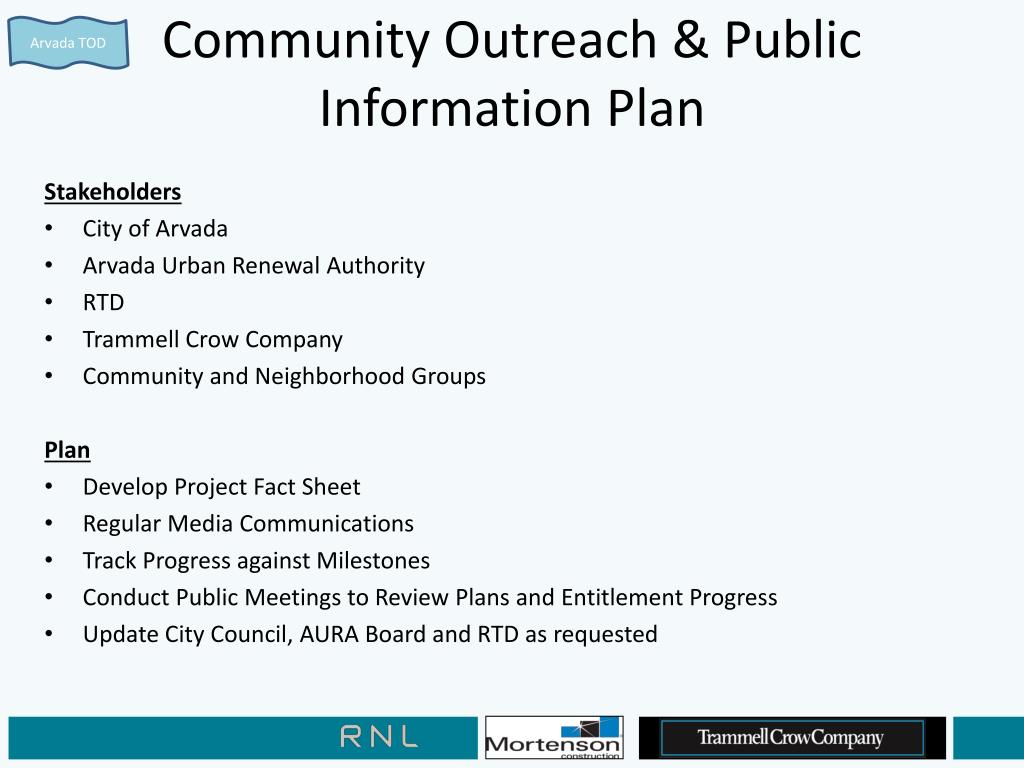

Arvada TOD Community Outreach & Public Information Plan Stakeholders • City of Arvada • Arvada Urban Renewal Authority • RTD • Trammell Crow Company • Community and Neighborhood Groups Plan • Develop Project Fact Sheet • Regular Media Communications • Track Progress against Milestones • Conduct Public Meetings to Review Plans and Entitlement Progress • Update City Council, AURA Board and RTD as requested

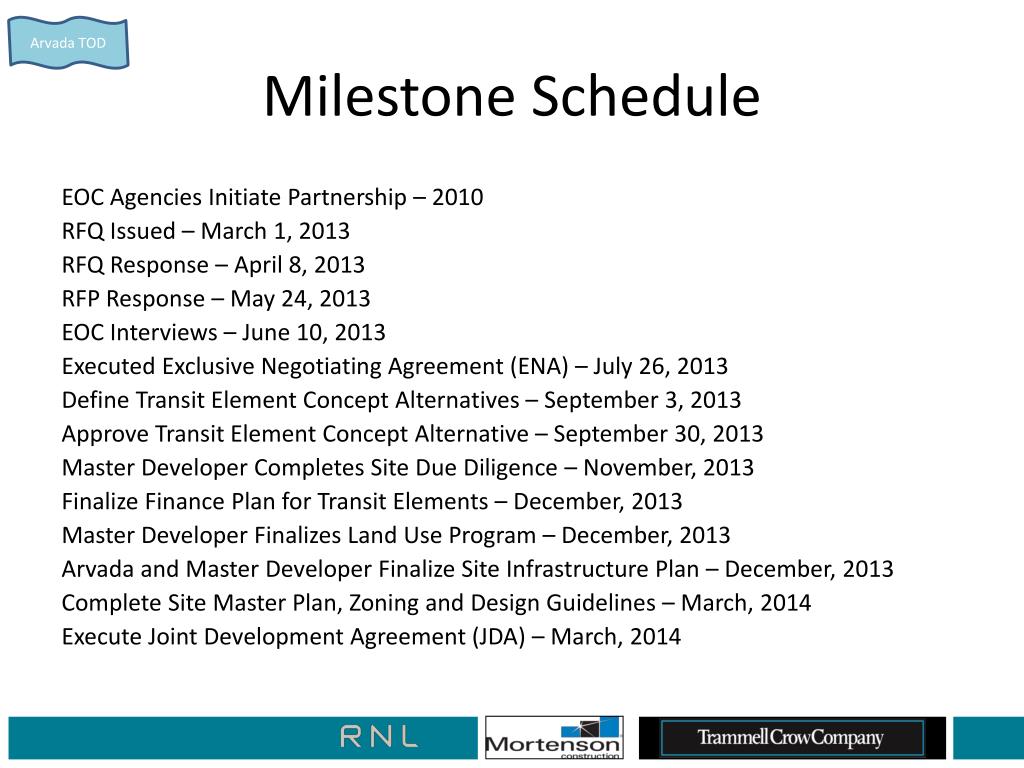

Arvada TOD Milestone Schedule EOC Agencies Initiate Partnership – 2010 RFQ Issued – March 1, 2013 RFQ Response – April 8, 2013 RFP Response – May 24, 2013 EOC Interviews – June 10, 2013 Executed Exclusive Negotiating Agreement (ENA) – July 26, 2013 Define Transit Element Concept Alternatives – September 3, 2013 Approve Transit Element Concept Alternative – September 30, 2013 Master Developer Completes Site Due Diligence – November, 2013 Finalize Finance Plan for Transit Elements – December, 2013 Master Developer Finalizes Land Use Program – December, 2013 Arvada and Master Developer Finalize Site Infrastructure Plan – December, 2013 Complete Site Master Plan, Zoning and Design Guidelines – March, 2014 Execute Joint Development Agreement (JDA) – March, 2014
