2009 – 2010 Southeast Inter-Regional Participation Process (“SIRPP”)

2009 – 2010 Southeast Inter-Regional Participation Process (“SIRPP”) Preliminary Economic Planning Results. OVERVIEW

oswald
Download Presentation

2009 – 2010 Southeast Inter-Regional Participation Process (“SIRPP”)

An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript


  1. 2009 – 2010 Southeast Inter-Regional Participation Process (“SIRPP”) Preliminary Economic Planning Results

  2. OVERVIEW • Purpose of this study is to assess the performance of the transmission systems of the Participating Transmission Owners for the five Economic Planning Studies as identified by the Stakeholders. • Assessment will include the identification of upgrades to accommodate the power flows of the five Economic Planning Studies. • Planning staff of the Participating Transmission Owners will perform the studies. • Study results will be reviewed with the Stakeholders for their input.

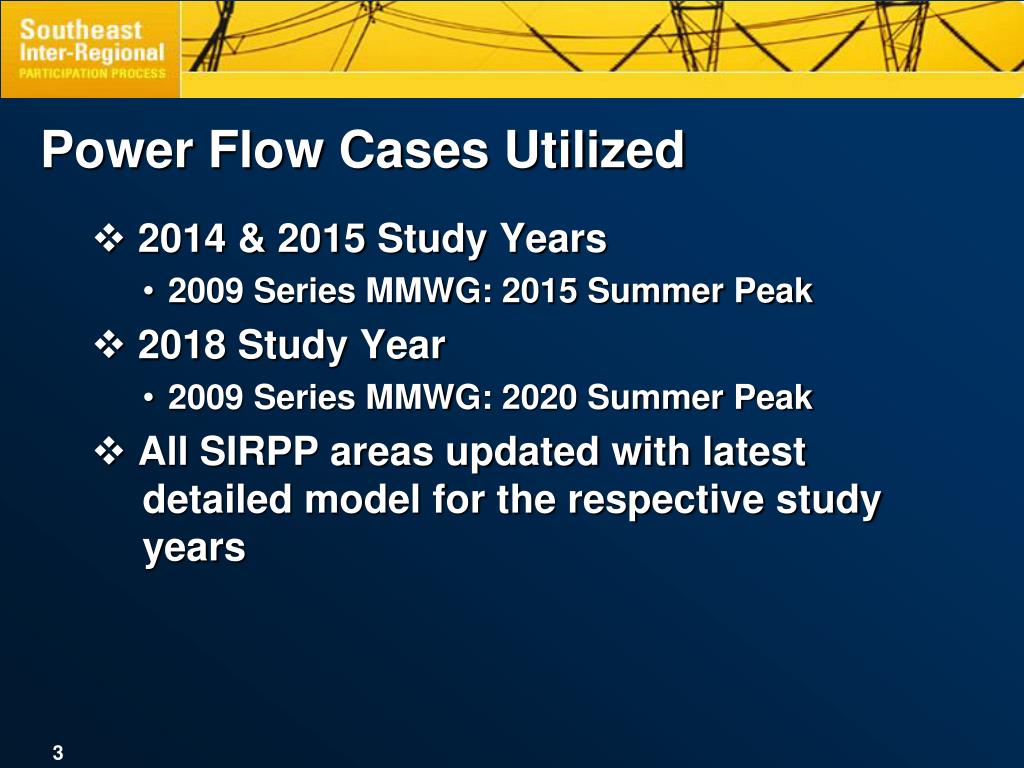

  3. Power Flow Cases Utilized • 2014 & 2015 Study Years • 2009 Series MMWG: 2015 Summer Peak • 2018 Study Year • 2009 Series MMWG: 2020 Summer Peak • All SIRPP areas updated with latest detailed model for the respective study years

  4. Preliminary Results Components • Thermal Analysis • Contingency Analysis to identify constrained elements/contingency pairs • Interface Transfer Capability Impacts • Potential Solutions • Transmission Projects and Cost Estimates

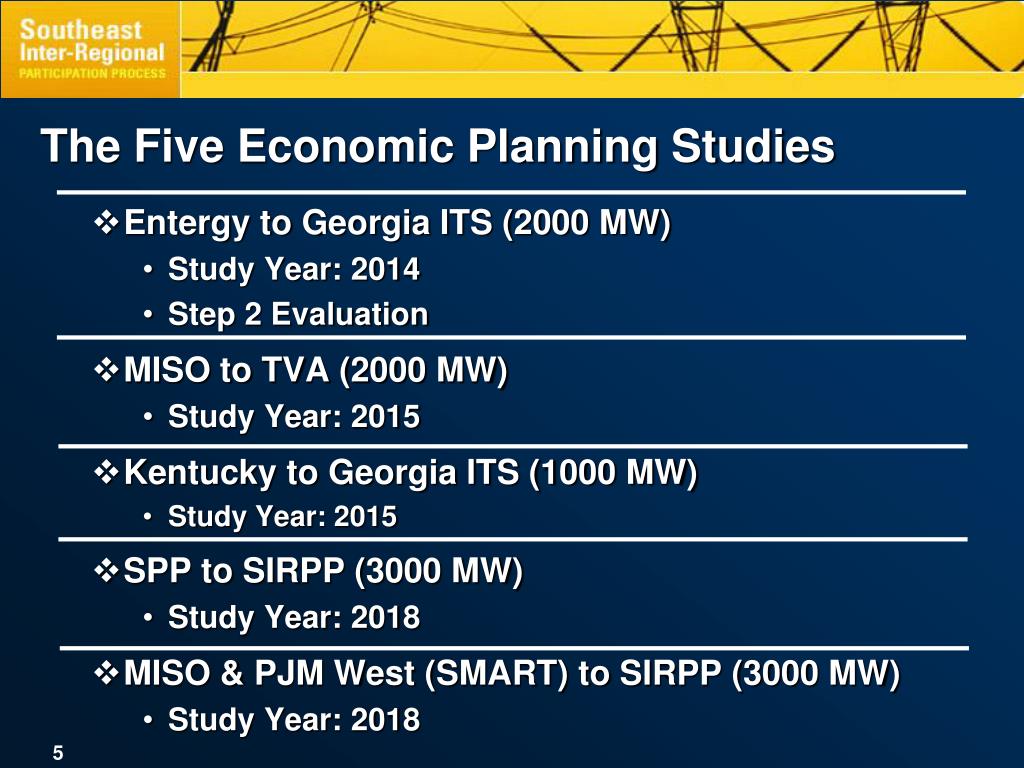

  5. The Five Economic Planning Studies • Entergy to Georgia ITS (2000 MW) • Study Year: 2014 • Step 2 Evaluation • MISO to TVA (2000 MW) • Study Year: 2015 • Kentucky to Georgia ITS (1000 MW) • Study Year: 2015 • SPP to SIRPP (3000 MW) • Study Year: 2018 • MISO & PJM West (SMART) to SIRPP (3000 MW) • Study Year: 2018

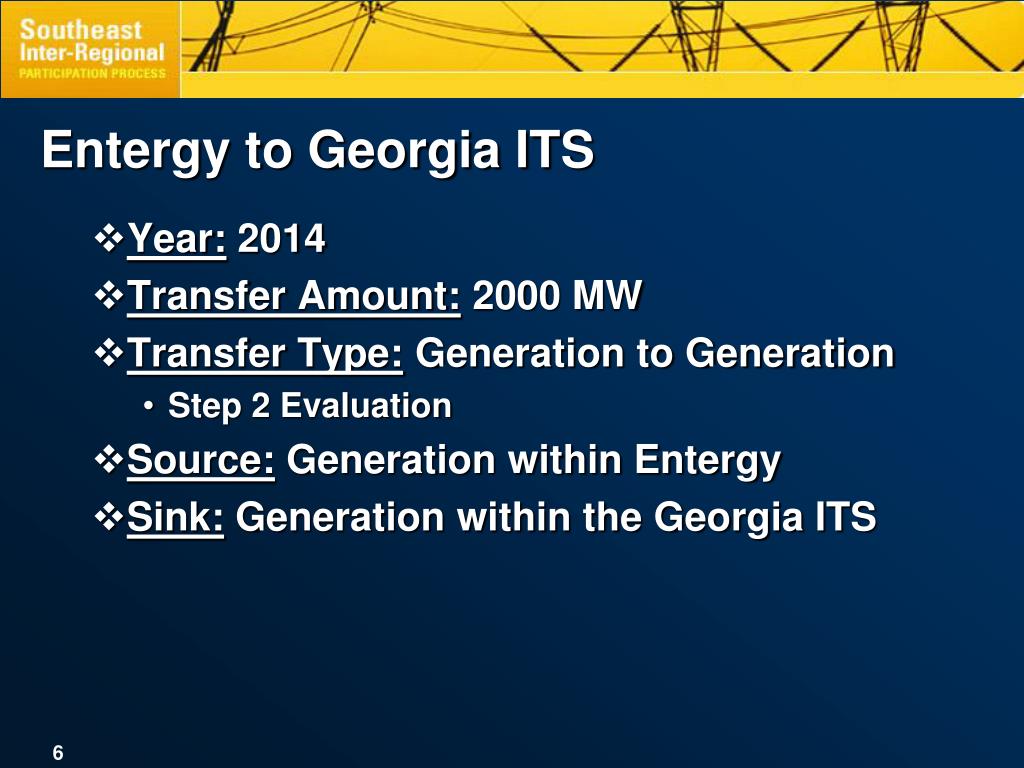

  6. Entergy to Georgia ITS • Year: 2014 • Transfer Amount: 2000 MW • Transfer Type: Generation to Generation • Step 2 Evaluation • Source: Generation within Entergy • Sink: Generation within the Georgia ITS

  7. Entergy to Georgia ITS Transmission System Upgrades for the SIRPP • One (1) 500 kV Line • One (1) 500 / 230 kV Transformer • Ten (10) 230 kV Lines • Four (4) 230 / 115 kV Transformers • Six (6) 161 kV Lines • Sixteen (16) 115 kV Lines Total Cost: $380,635,000

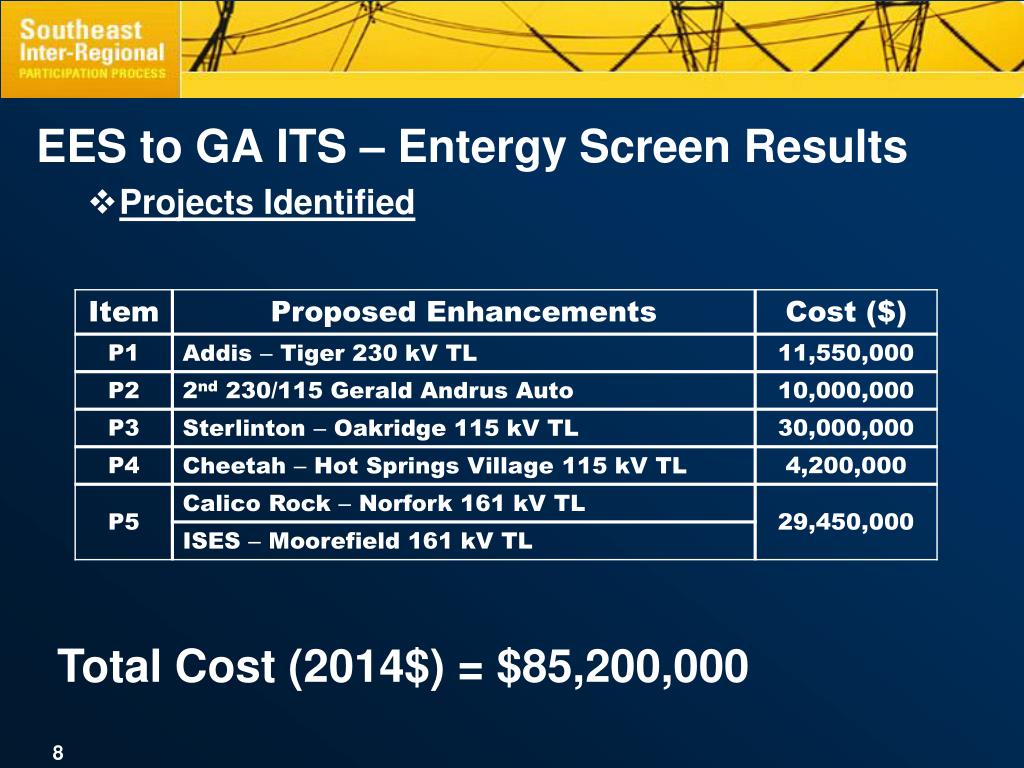

  8. EES to GA ITS – Entergy Screen Results • Projects Identified Total Cost (2014$) = $85,200,000

  9. MISO & PJM West (“SMART”) to SIRPP 3000 MW

  10. SMART to SIRPP • Year: 2018 • Transfer Amount: 3000 MW • Transfer Type: Generation to Generation • Source: Load scale (500 MW each) of the following areas • Ameren Missouri • Ameren Illinois • Alliant Energy West • Mid-American Energy • Commonwealth Edison • AEP (Ohio Power, IM Power, CS Power Zones only) • Sink: Generation within the SIRPP

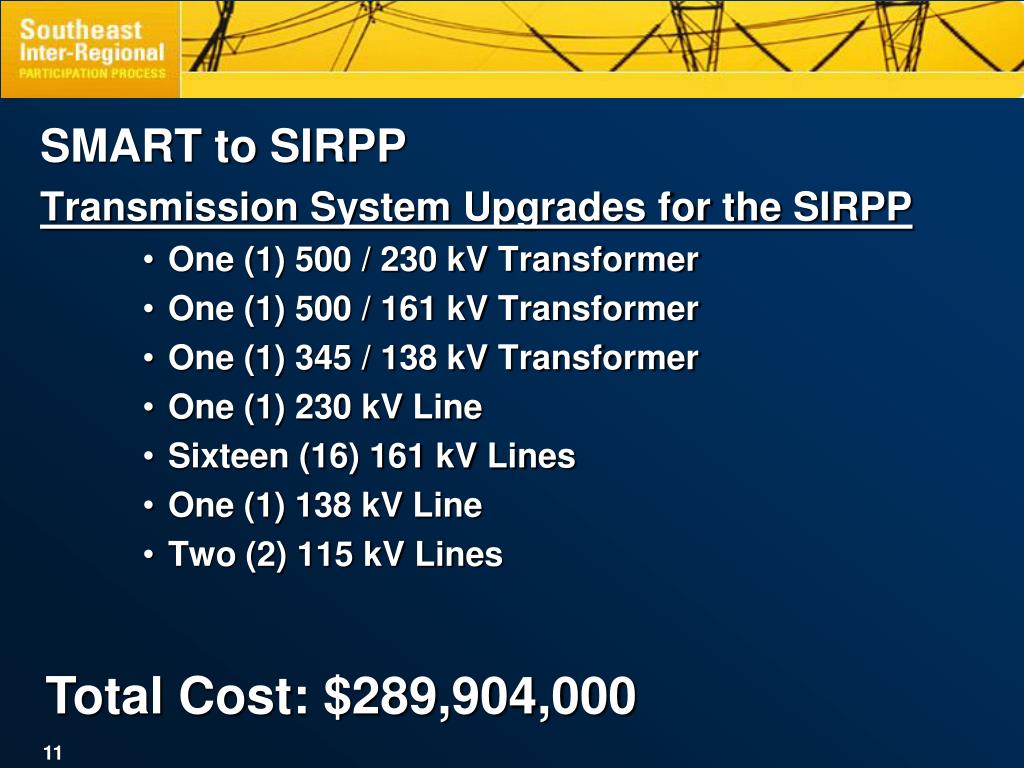

  11. SMART to SIRPP Transmission System Upgrades for the SIRPP • One (1) 500 / 230 kV Transformer • One (1) 500 / 161 kV Transformer • One (1) 345 / 138 kV Transformer • One (1) 230 kV Line • Sixteen (16) 161 kV Lines • One (1) 138 kV Line • Two (2) 115 kV Lines Total Cost: $289,904,000

  12. SMART to SIRPP – Entergy Screen Results • Projects Identified Total Cost (2018$) = $30,734,000

  13. For Additional Information www.southeastirpp.com 13

  14. Questions? Eddie FilatICT Planning Engineer501-688-1708efilat@spp.org
