The latest update on ISIS schedule - contractors work on cables for breakout box, routine maintenance, staff busy with preparatory work for January experiments. Synchrotron integration work underway for full system operation.
E N D
LOI – Next Steps? John Thomason

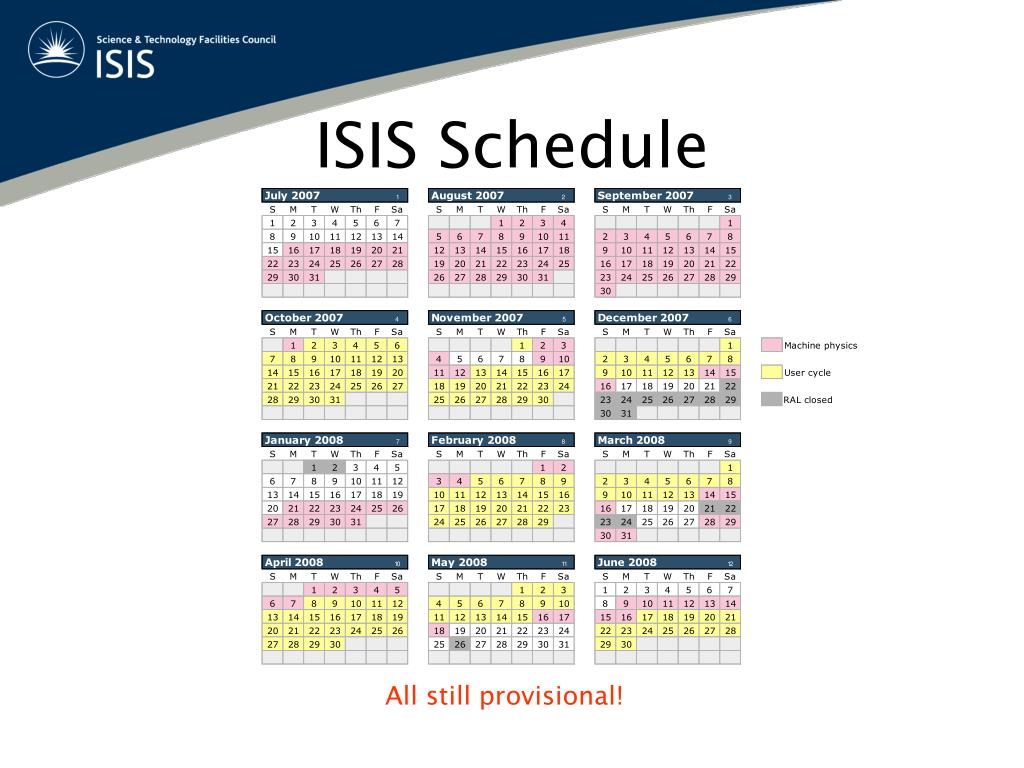

ISIS Schedule All still provisional!

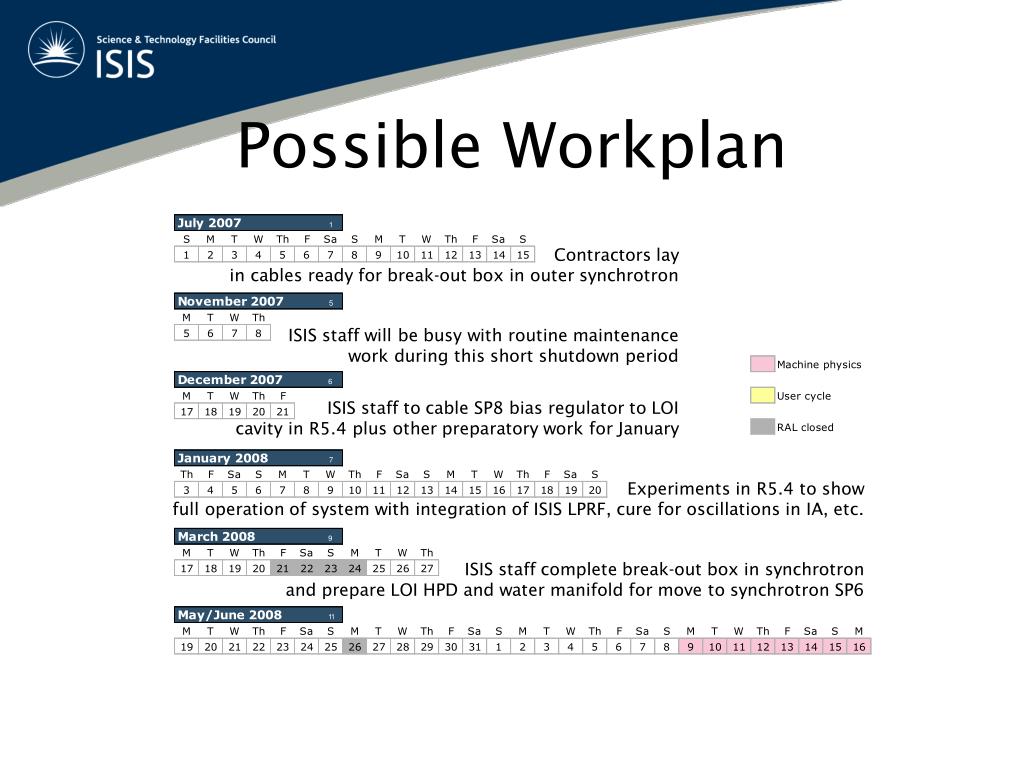

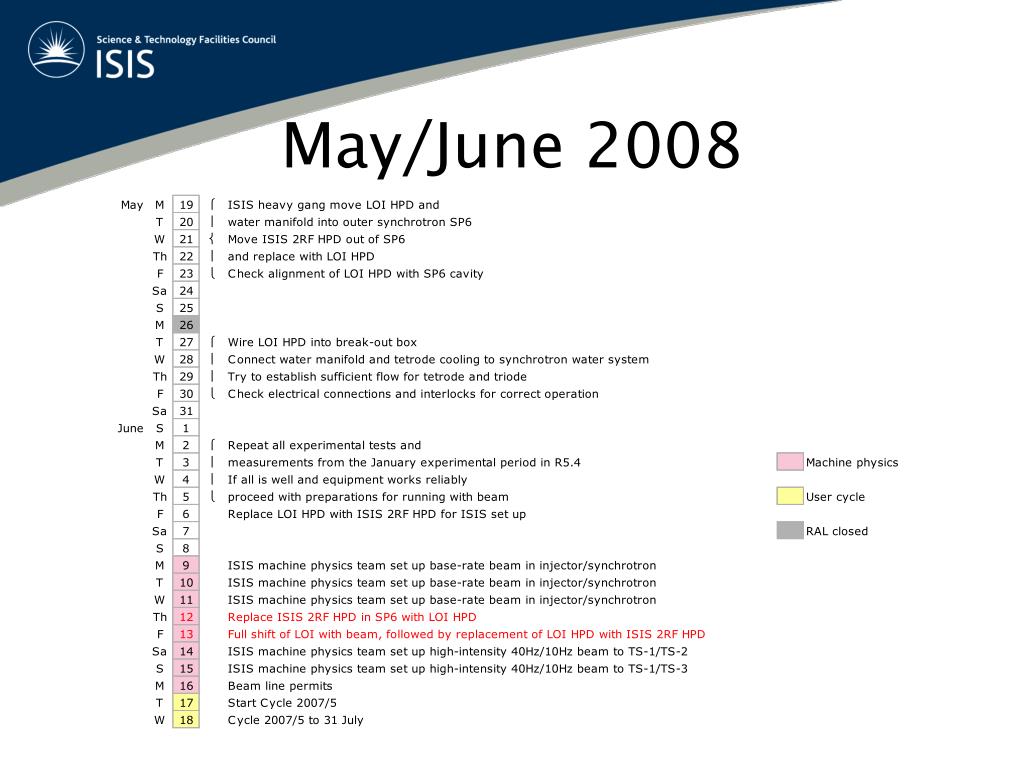

Possible Workplan Contractors lay in cables ready for break-out box in outer synchrotron ISIS staff will be busy with routine maintenance work during this short shutdown period ISIS staff to cable SP8 bias regulator to LOI cavity in R5.4 plus other preparatory work for January Experiments in R5.4 to show full operation of system with integration of ISIS LPRF, cure for oscillations in IA, etc. ISIS staff complete break-out box in synchrotron and prepare LOI HPD and water manifold for move to synchrotron SP6
