An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript

  1. Supercritical Water Oxidation Update City Council Workshop April 25, 2011

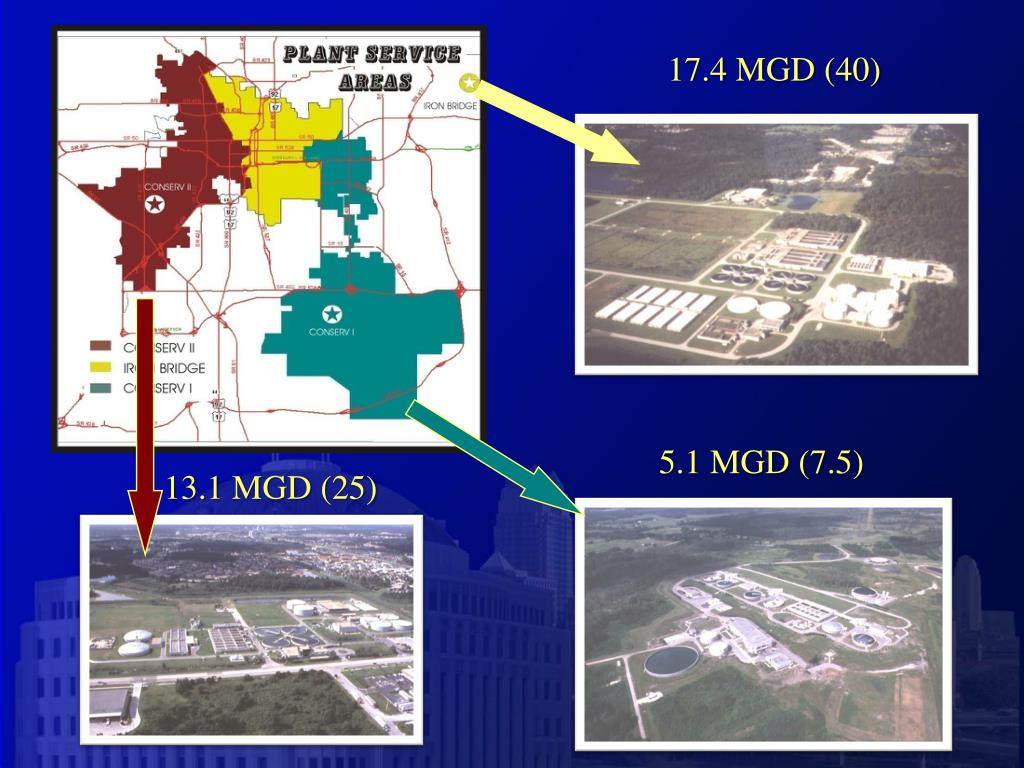

  2. 17.4 MGD (40) 5.1 MGD (7.5) 13.1 MGD (25)

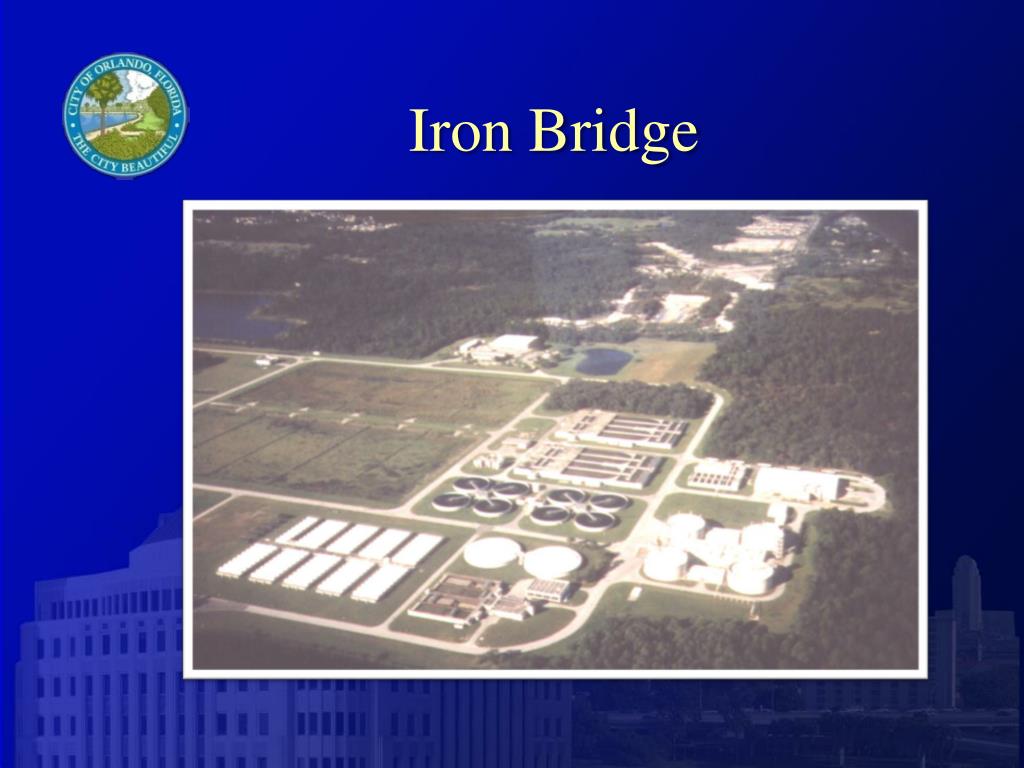

  3. Iron Bridge

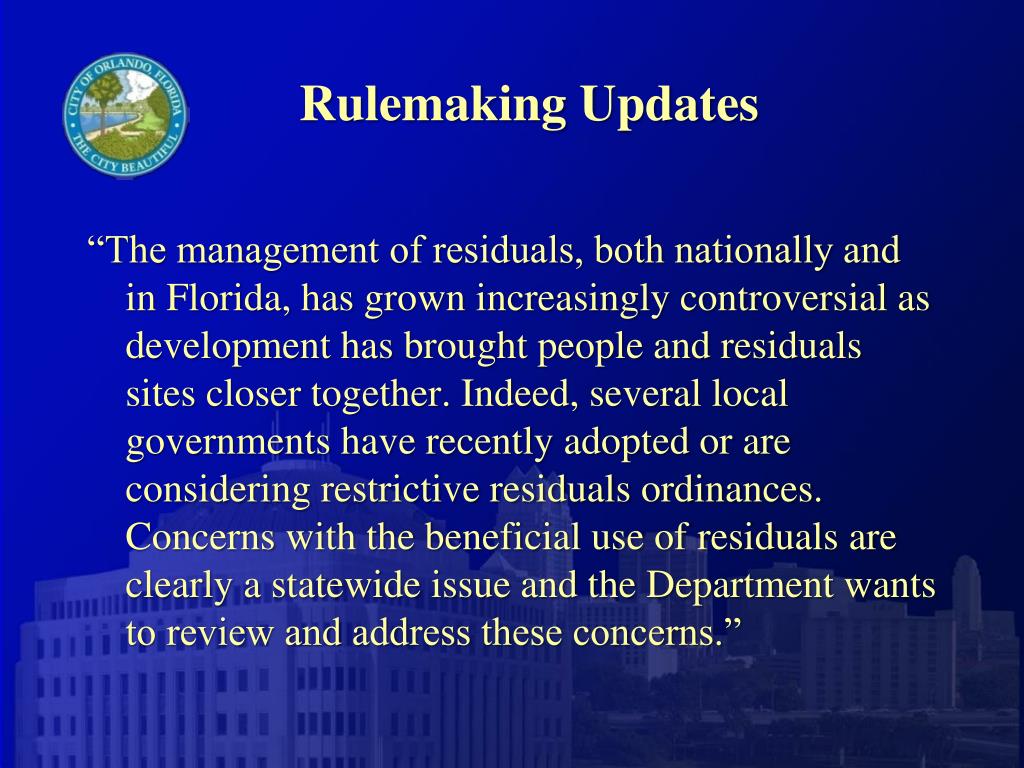

  4. Rulemaking Updates “The management of residuals, both nationally and in Florida, has grown increasingly controversial as development has brought people and residuals sites closer together. Indeed, several local governments have recently adopted or are considering restrictive residuals ordinances. Concerns with the beneficial use of residuals are clearly a statewide issue and the Department wants to review and address these concerns.”

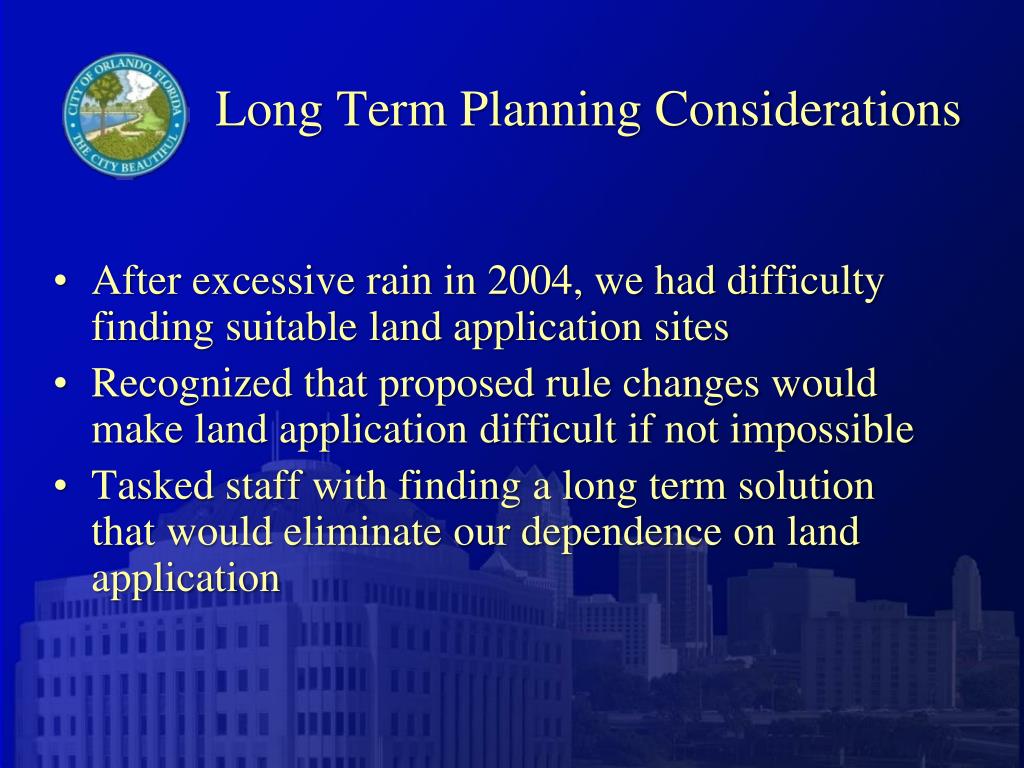

  5. Long Term Planning Considerations • After excessive rain in 2004, we had difficulty finding suitable land application sites • Recognized that proposed rule changes would make land application difficult if not impossible • Tasked staff with finding a long term solution that would eliminate our dependence on land application

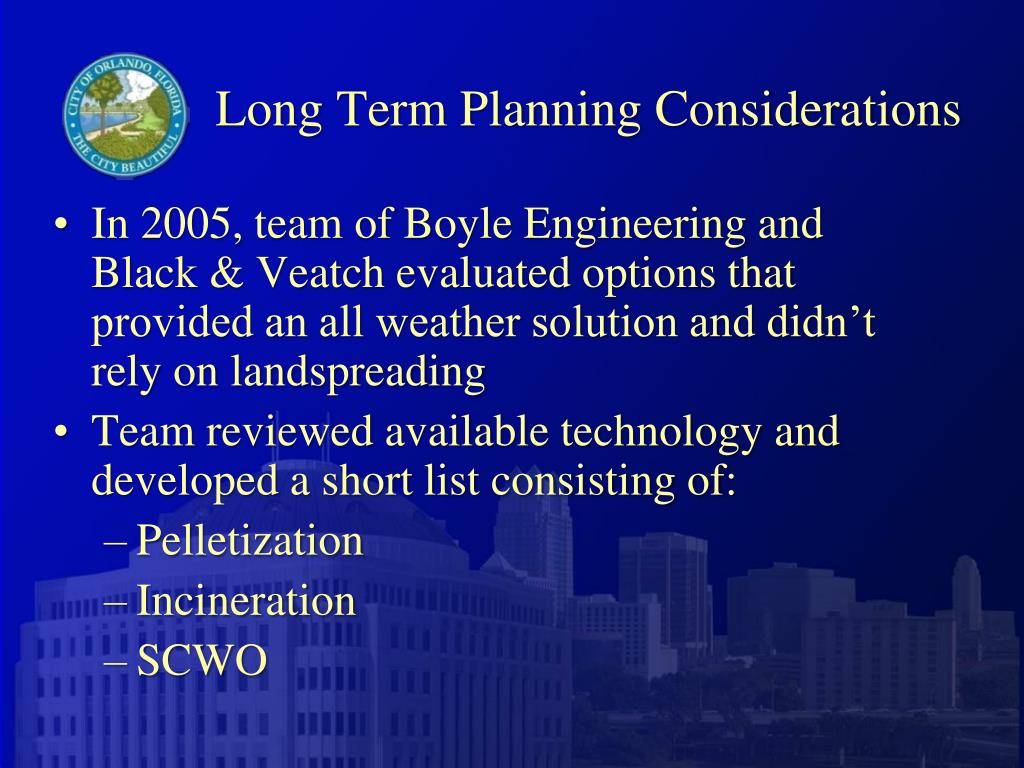

  6. Long Term Planning Considerations • In 2005, team of Boyle Engineering and Black & Veatch evaluated options that provided an all weather solution and didn’t rely on landspreading • Team reviewed available technology and developed a short list consisting of: • Pelletization • Incineration • SCWO

  7. Incineration Pelletization SCWO

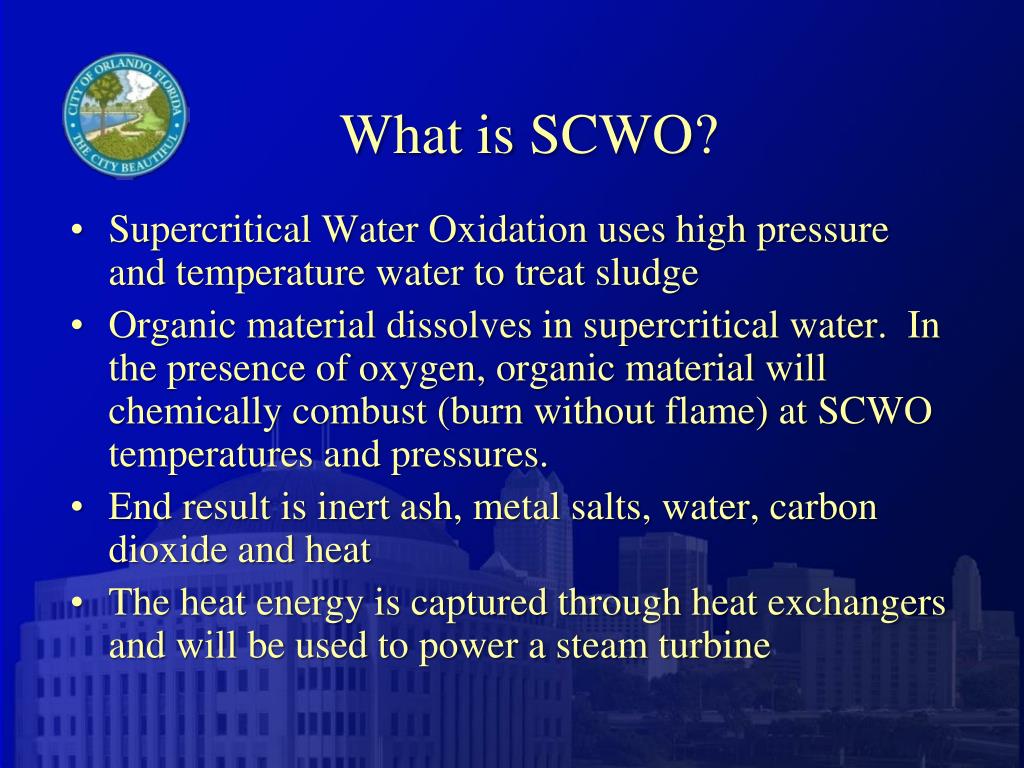

  8. What is SCWO? • Supercritical Water Oxidation uses high pressure and temperature water to treat sludge • Organic material dissolves in supercritical water. In the presence of oxygen, organic material will chemically combust (burn without flame) at SCWO temperatures and pressures. • End result is inert ash, metal salts, water, carbon dioxide and heat • The heat energy is captured through heat exchangers and will be used to power a steam turbine

  9. SCWO upsides • Technology results in complete destruction of organic material in sludge • Provides the highest level of treatment recognized by regulatory agencies • Produces excess energy and usable by-products (CO2, phosphorus and hot water) • Provides all weather solution and is not dependent on land application

  10. SCWO downsides • Technology had only been demonstrated on a small, pilot scale basis • Had not been tested extensively on wastewater sludge • Process would require significant R&D investment before it could be adapted to wastewater application

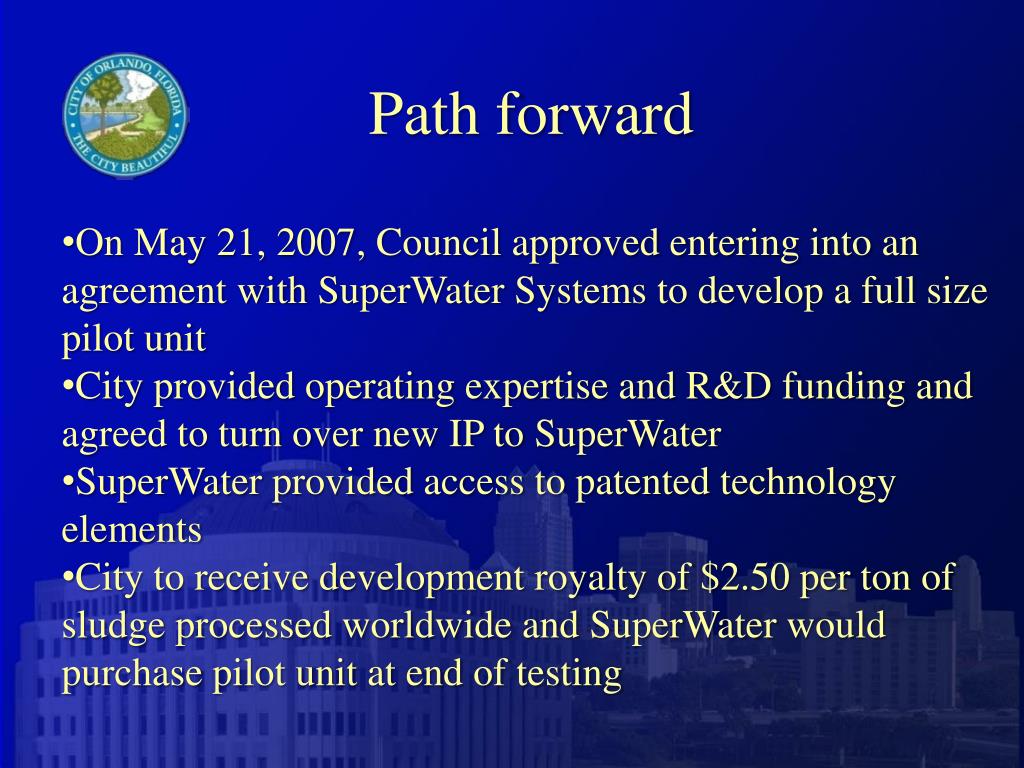

  11. Path forward • On May 21, 2007, Council approved entering into an agreement with SuperWater Systems to develop a full size pilot unit • City provided operating expertise and R&D funding and agreed to turn over new IP to SuperWater • SuperWater provided access to patented technology elements • City to receive development royalty of $2.50 per ton of sludge processed worldwide and SuperWater would purchase pilot unit at end of testing

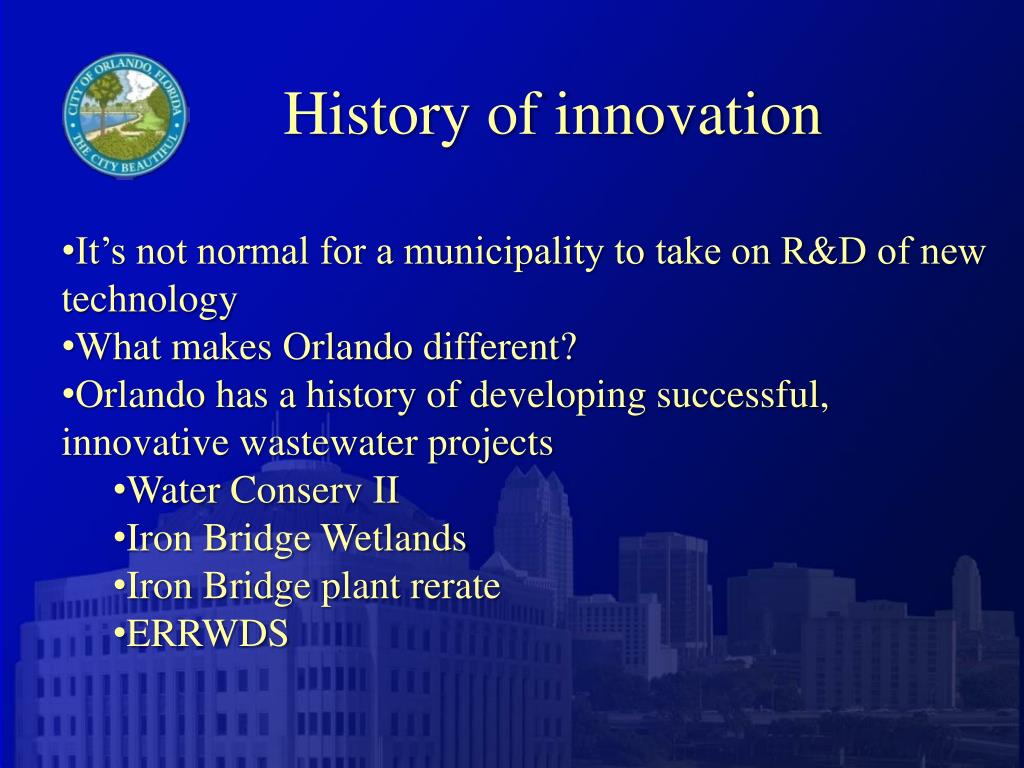

  12. History of innovation • It’s not normal for a municipality to take on R&D of new technology • What makes Orlando different? • Orlando has a history of developing successful, innovative wastewater projects • Water Conserv II • Iron Bridge Wetlands • Iron Bridge plant rerate • ERRWDS

  13. Water Conserv II

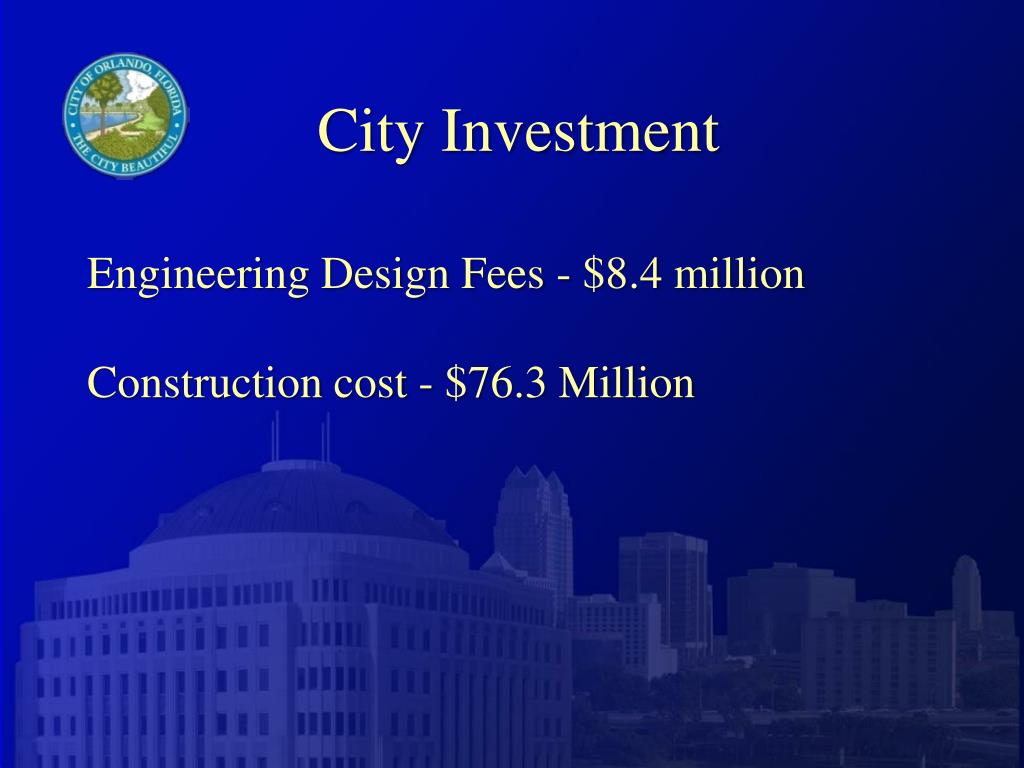

  14. City Investment Engineering Design Fees - $8.4 million Construction cost - $76.3 Million

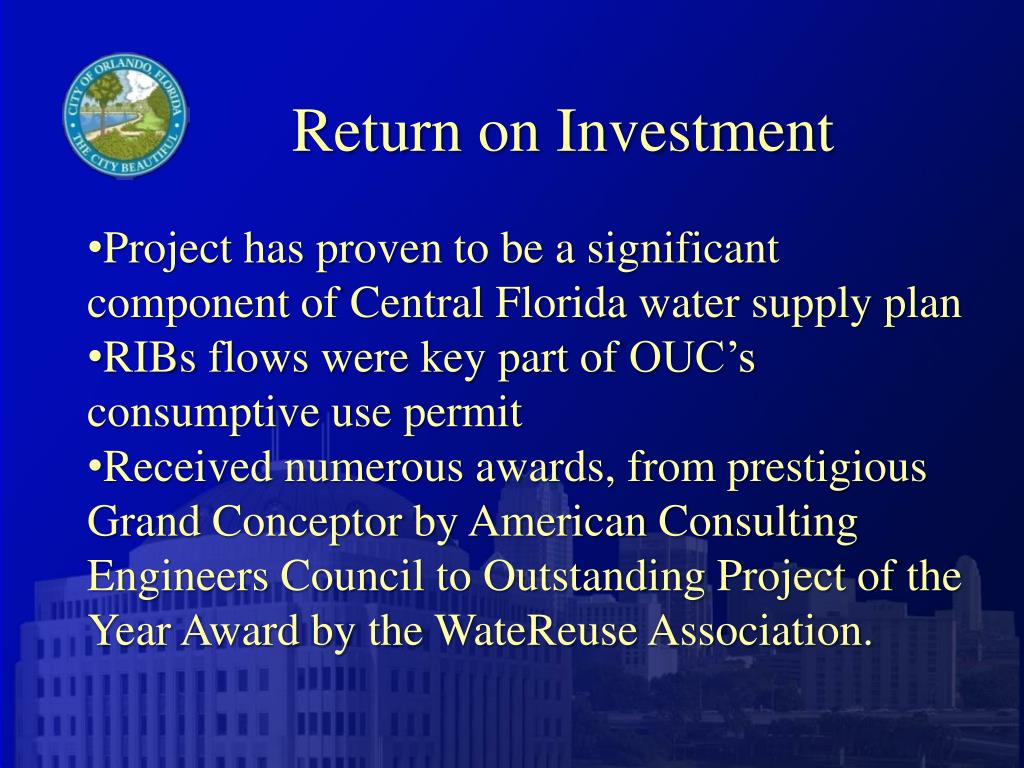

  15. Return on Investment • Project has proven to be a significant component of Central Florida water supply plan • RIBs flows were key part of OUC’s consumptive use permit • Received numerous awards, from prestigious Grand Conceptor by American Consulting Engineers Council to Outstanding Project of the Year Award by the WateReuse Association.

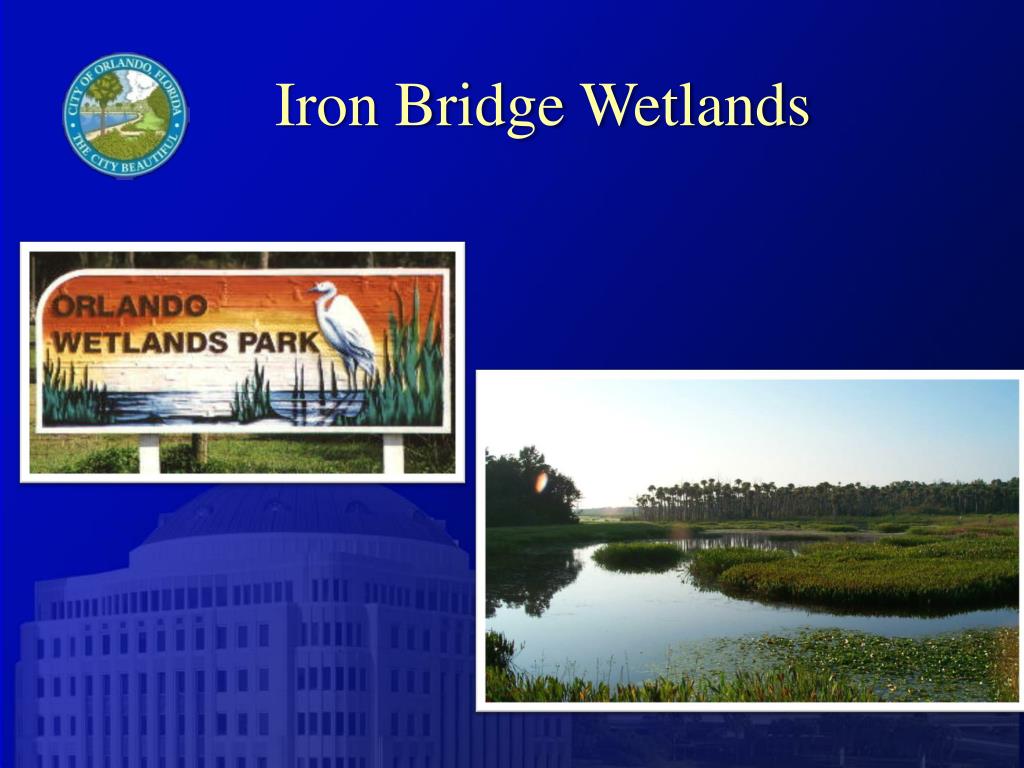

  16. Iron Bridge Wetlands

  17. City Investment Engineering Design Fees - $2.1 million Construction cost - $19.4 Million

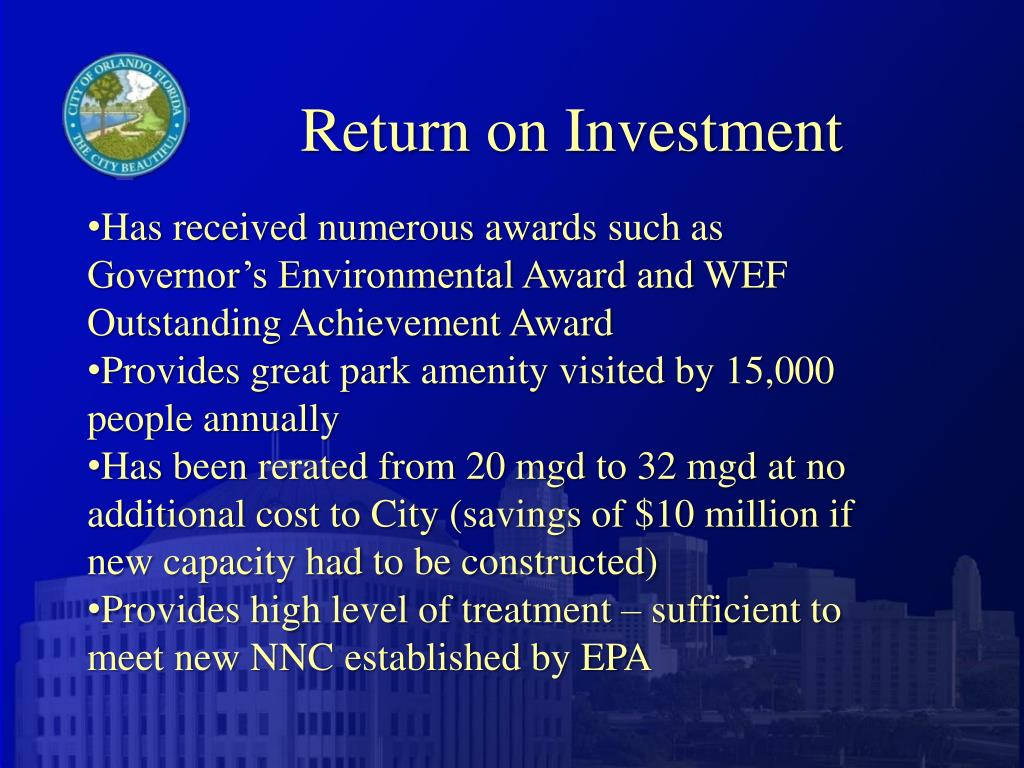

  18. Return on Investment • Has received numerous awards such as Governor’s Environmental Award and WEF Outstanding Achievement Award • Provides great park amenity visited by 15,000 people annually • Has been rerated from 20 mgd to 32 mgd at no additional cost to City (savings of $10 million if new capacity had to be constructed) • Provides high level of treatment – sufficient to meet new NNC established by EPA

  19. Iron Bridge rerating

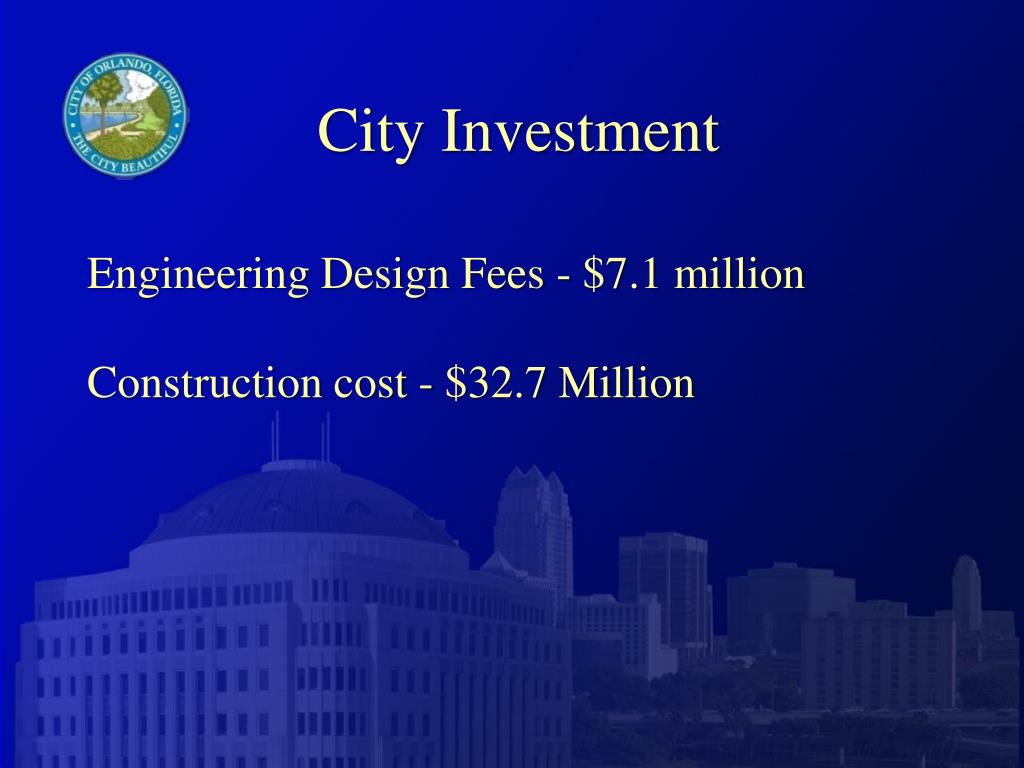

  20. City Investment Engineering Design Fees - $7.1 million Construction cost - $32.7 Million

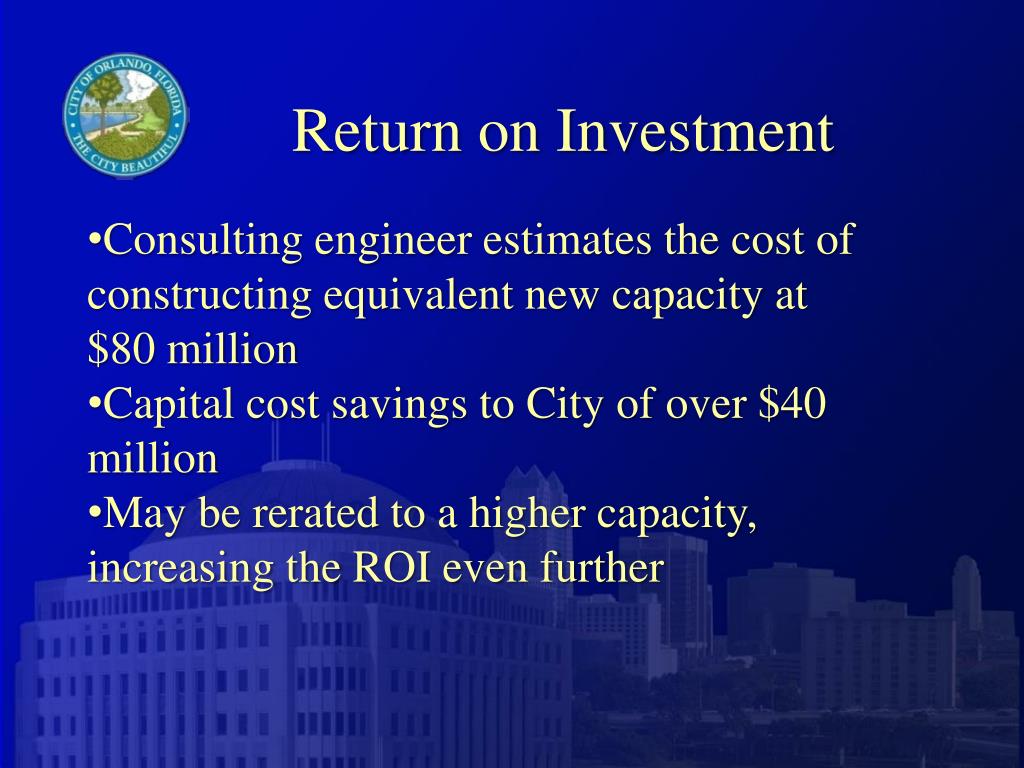

  21. Return on Investment • Consulting engineer estimates the cost of constructing equivalent new capacity at $80 million • Capital cost savings to City of over $40 million • May be rerated to a higher capacity, increasing the ROI even further

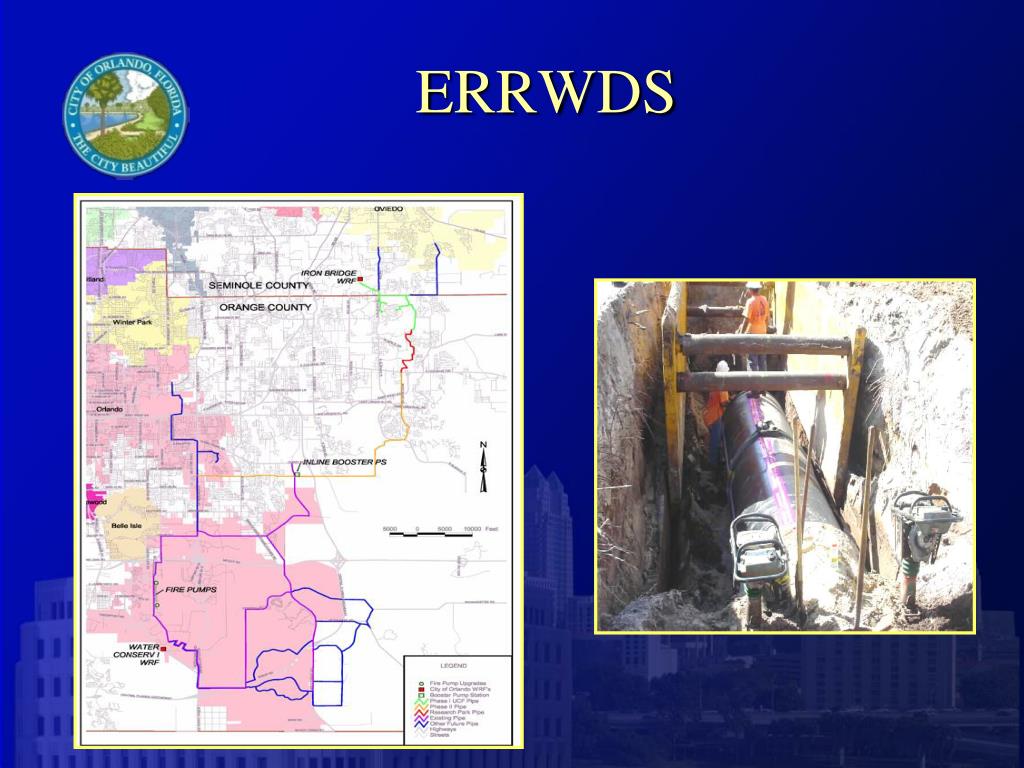

  22. ERRWDS

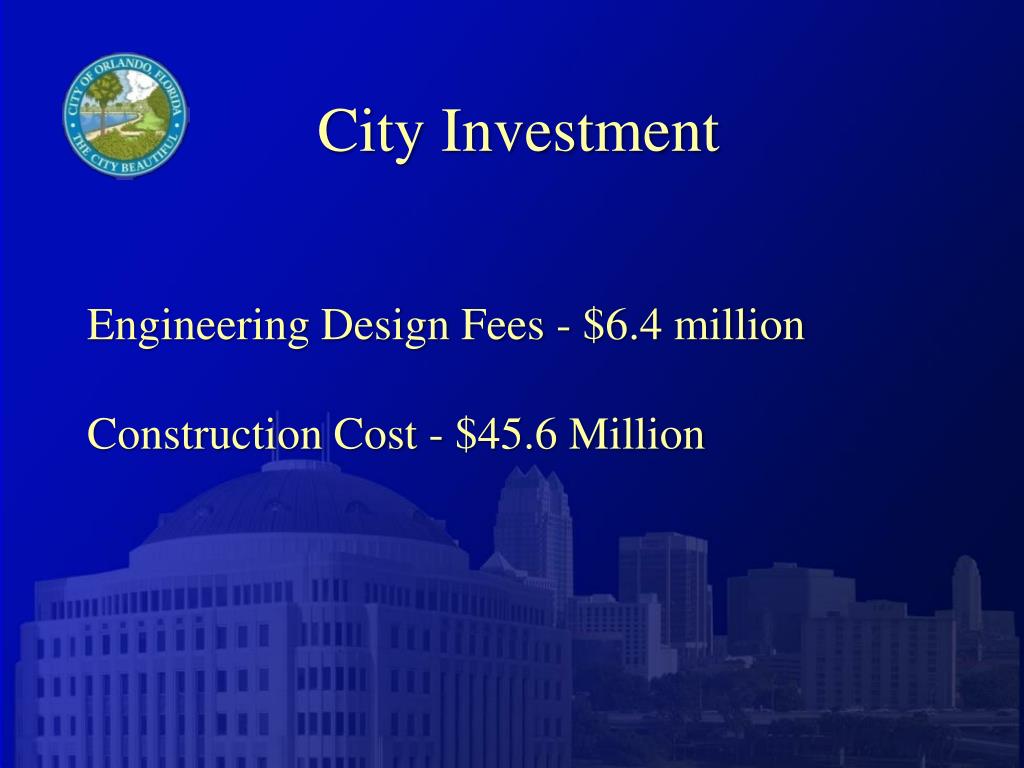

  23. City Investment Engineering Design Fees - $6.4 million Construction Cost - $45.6 Million

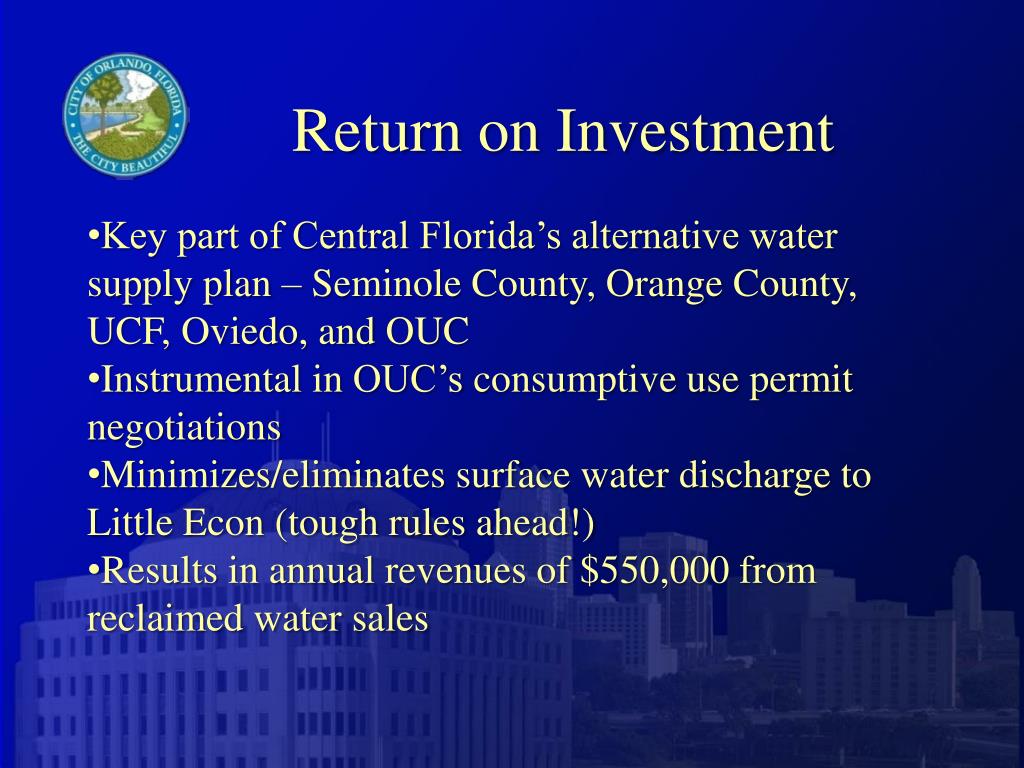

  24. Return on Investment • Key part of Central Florida’s alternative water supply plan – Seminole County, Orange County, UCF, Oviedo, and OUC • Instrumental in OUC’s consumptive use permit negotiations • Minimizes/eliminates surface water discharge to Little Econ (tough rules ahead!) • Results in annual revenues of $550,000 from reclaimed water sales

  25. SCWO Project Status

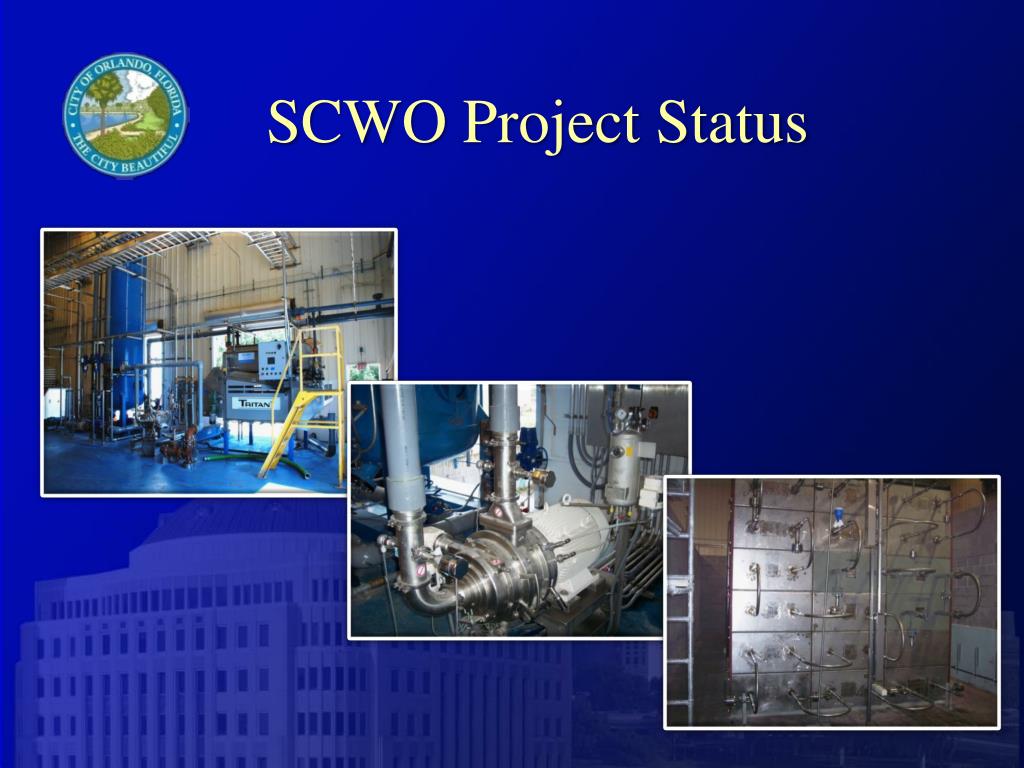

  26. SCWO Project Status • Initiated design work in 2006 and completed design concept in late 2007 • Construction initiated early 2008 using combination of city forces and contractors for fabrication and installation; completed base unit in early 2009 • Began pilot testing on Jan. 2009 and over the next 18 months, debugged and modified the process • Conducted sub-critical runs with sludge in late 2010 • Conducted super critical runs of sludge in February 2011

  27. City Investment Engineering Design Fees - $3.0 million Construction Cost - $5.5 Million

  28. Return on Investment • Long term compliance with any possible regulatory changes • Provides all-weather solution and eliminates reliance on land application • Based on SuperWater business projections, has the ability to return royalty payments of $60 million over the next 20 years

  29. Long Term Financial Considerations

  30. Transition plan

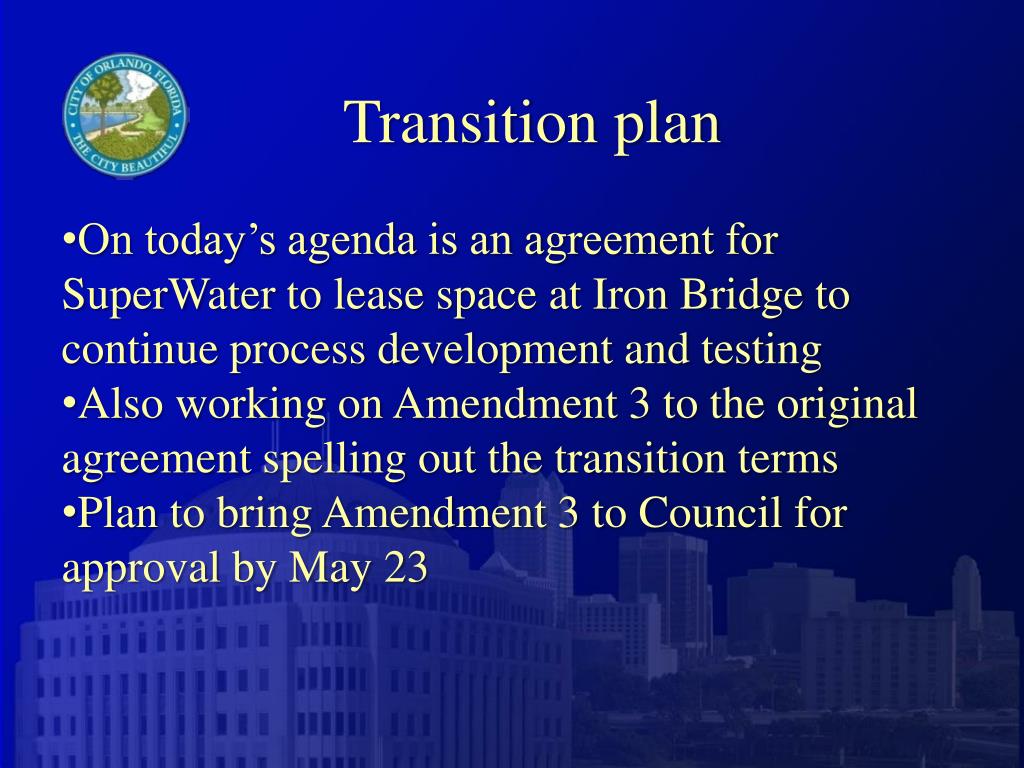

  31. Transition plan • On today’s agenda is an agreement for SuperWater to lease space at Iron Bridge to continue process development and testing • Also working on Amendment 3 to the original agreement spelling out the transition terms • Plan to bring Amendment 3 to Council for approval by May 23

  32. Don Morgan, Chief Executive Officer SuperWater Solutions, Inc. Copper Yaw, Chairman Waterway Finance Limited

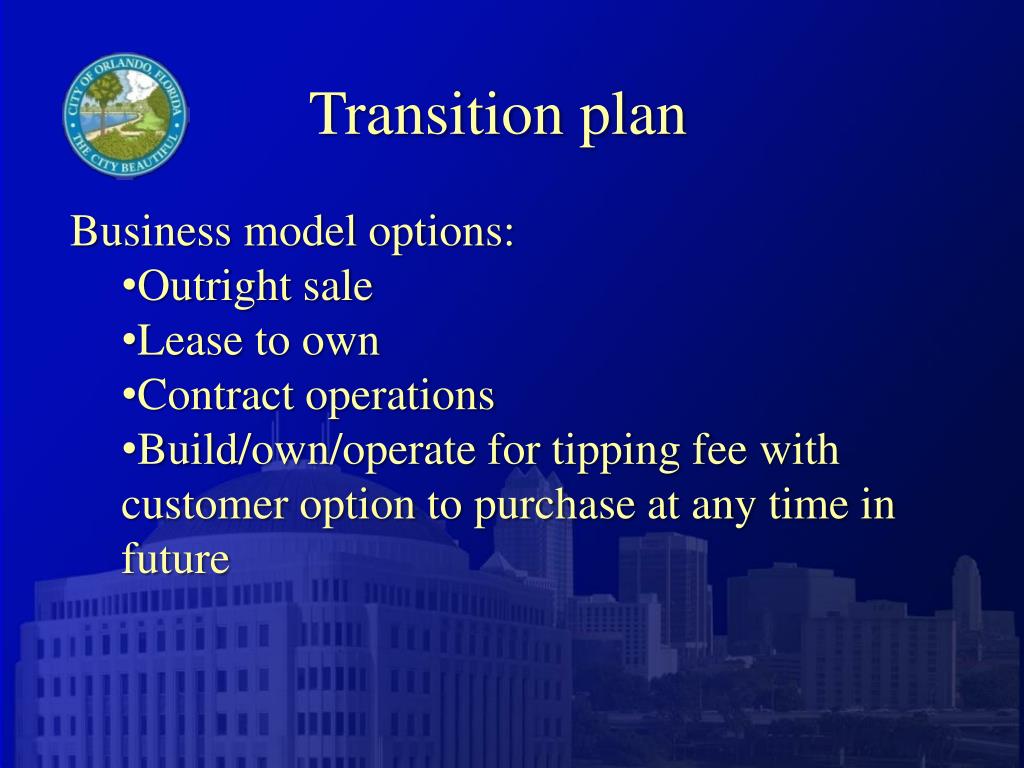

  33. Transition plan • Business model options: • Outright sale • Lease to own • Contract operations • Build/own/operate for tipping fee with customer option to purchase at any time in future

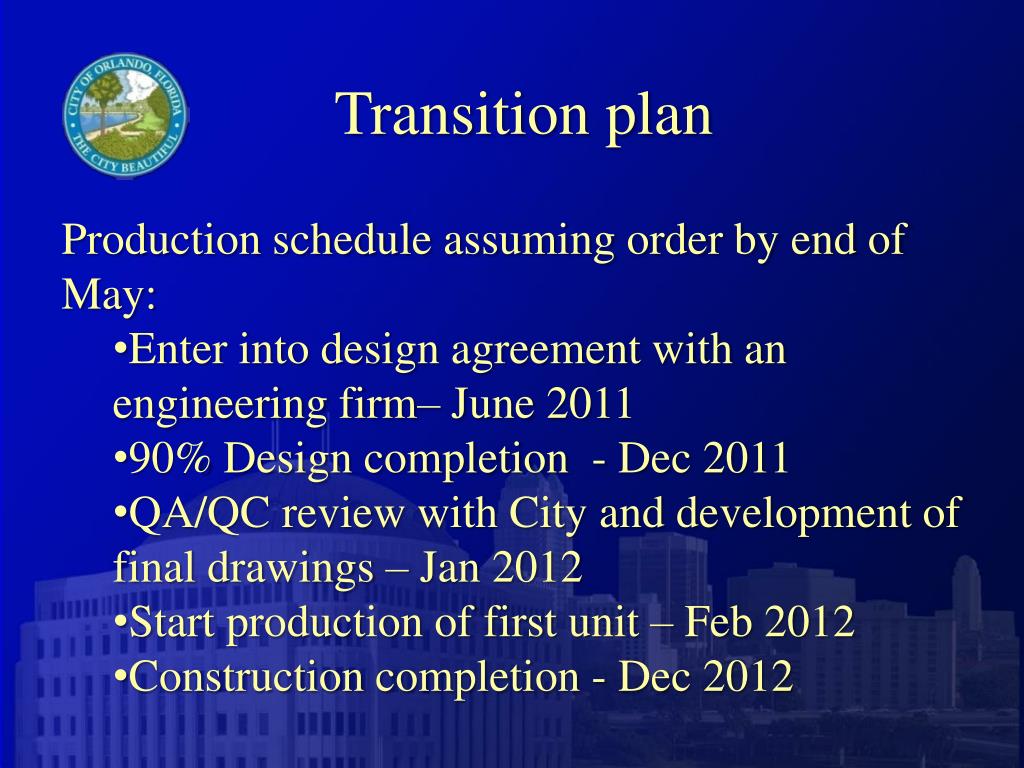

  34. Transition plan • Production schedule assuming order by end of May: • Enter into design agreement with an engineering firm– June 2011 • 90% Design completion - Dec 2011 • QA/QC review with City and development of final drawings – Jan 2012 • Start production of first unit – Feb 2012 • Construction completion - Dec 2012

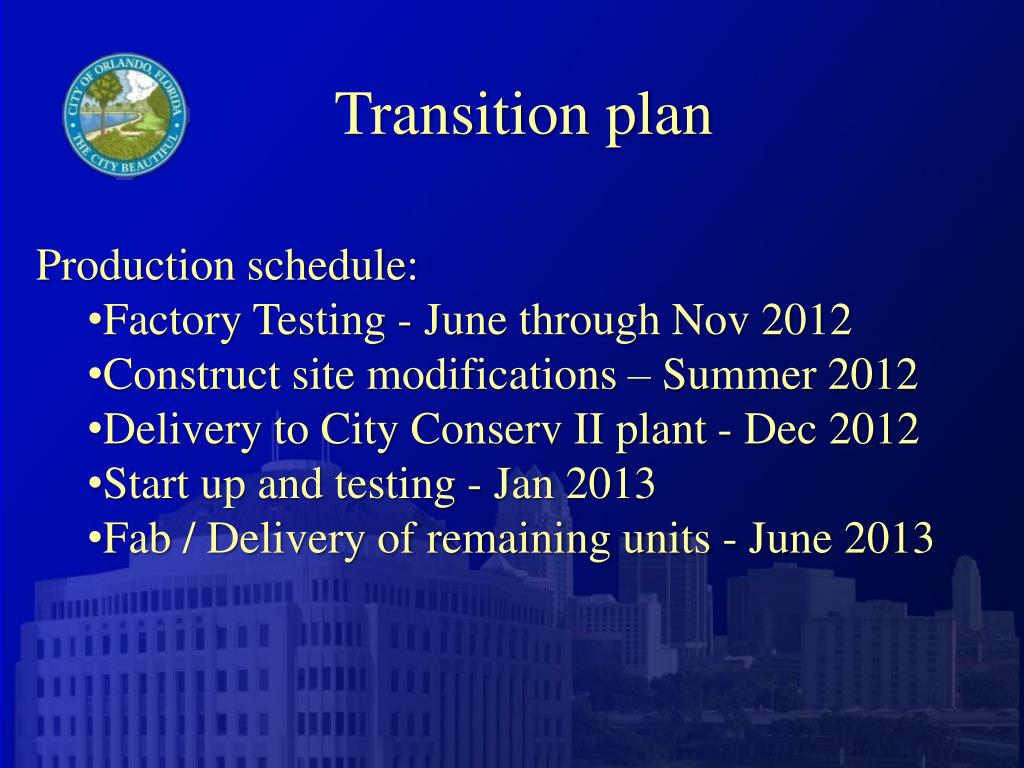

  35. Transition plan • Production schedule: • Factory Testing - June through Nov 2012 • Construct site modifications – Summer 2012 • Delivery to City Conserv II plant - Dec 2012 • Start up and testing - Jan 2013 • Fab / Delivery of remaining units - June 2013

  36. Financing Plan

  37. Questions?
