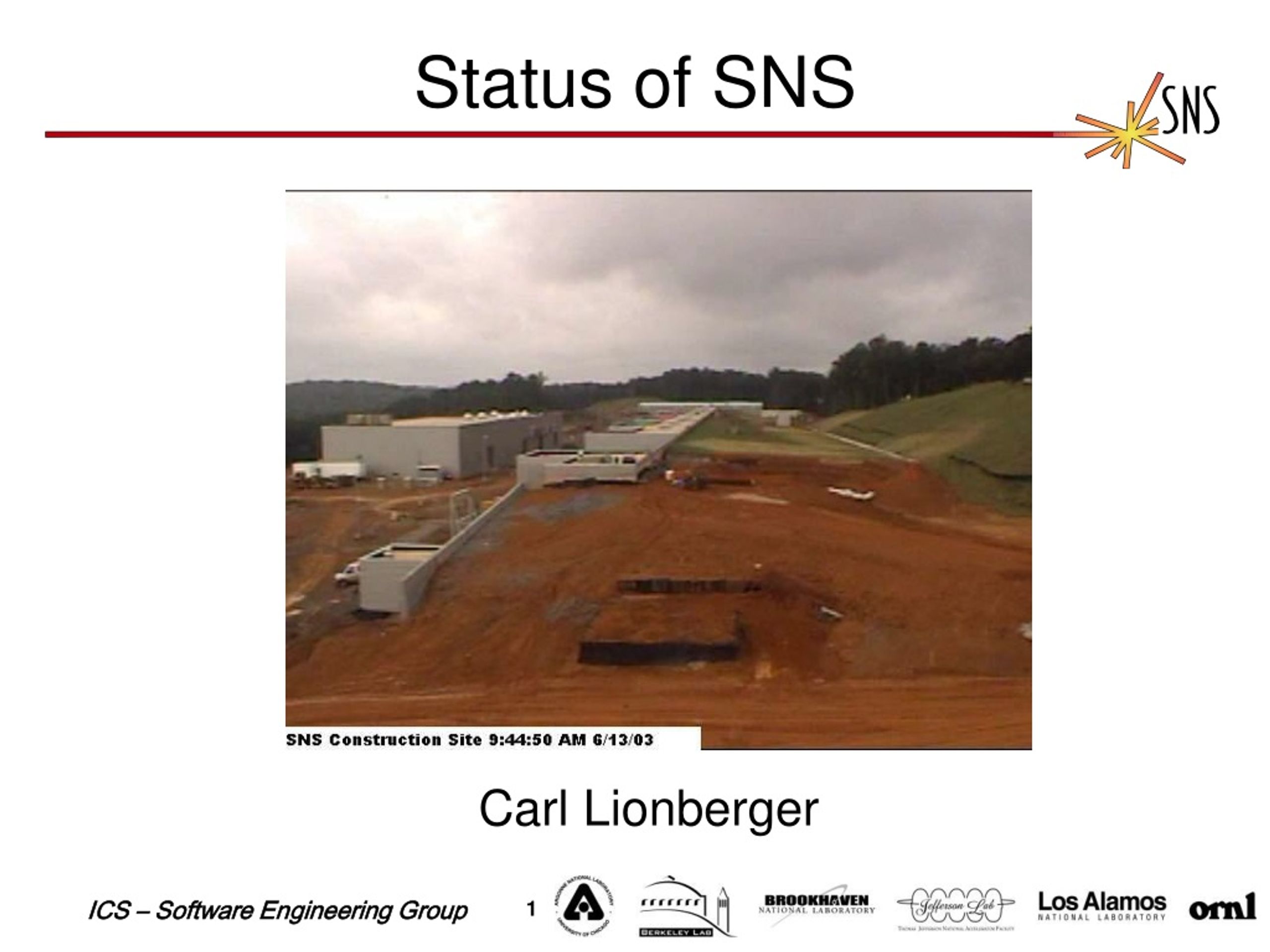

Status of SNS Carl Lionberger

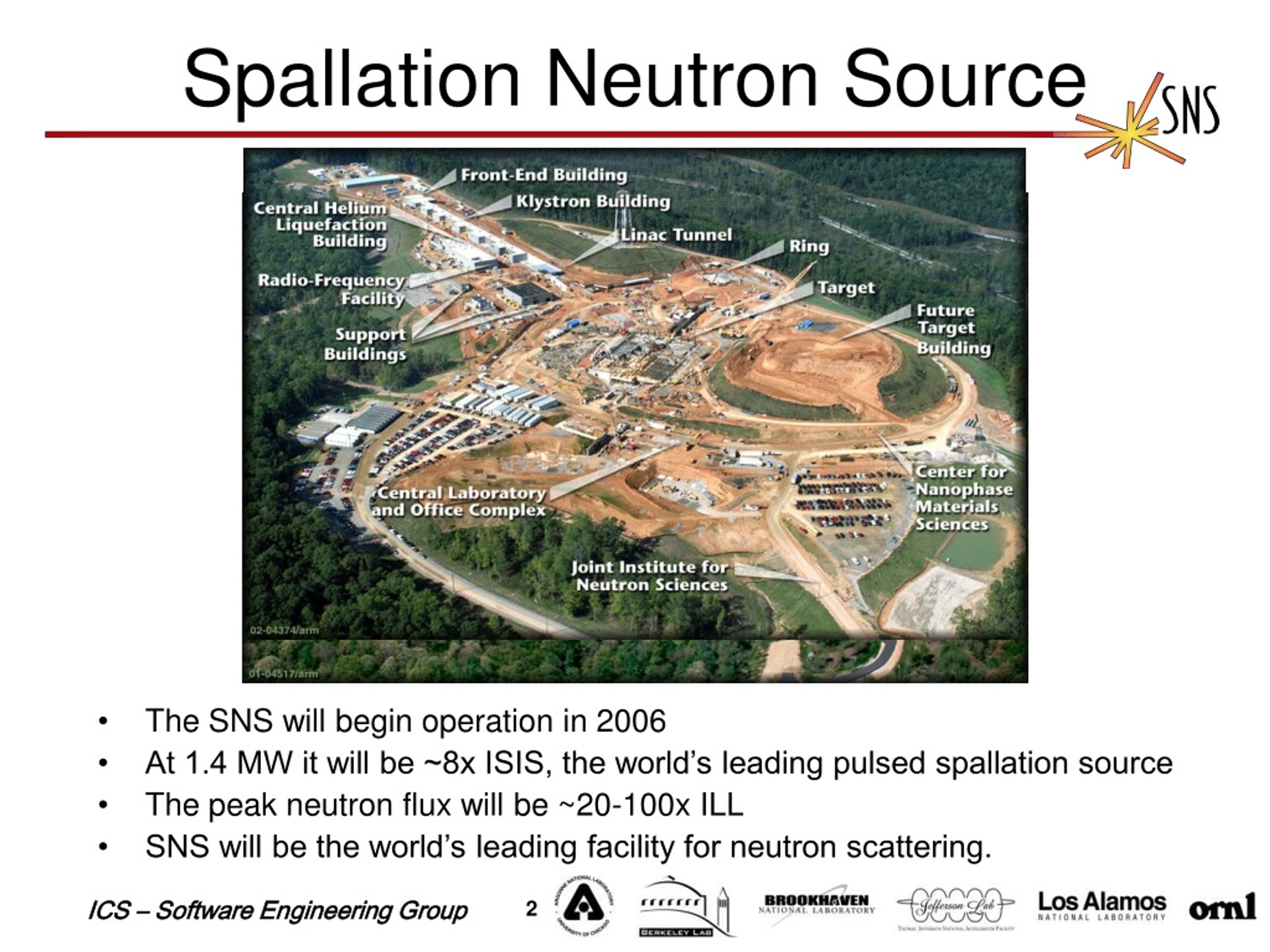

Spallation Neutron Source • The SNS will begin operation in 2006 • At 1.4 MW it will be ~8x ISIS, the world’s leading pulsed spallation source • The peak neutron flux will be ~20-100x ILL • SNS will be the world’s leading facility for neutron scattering.

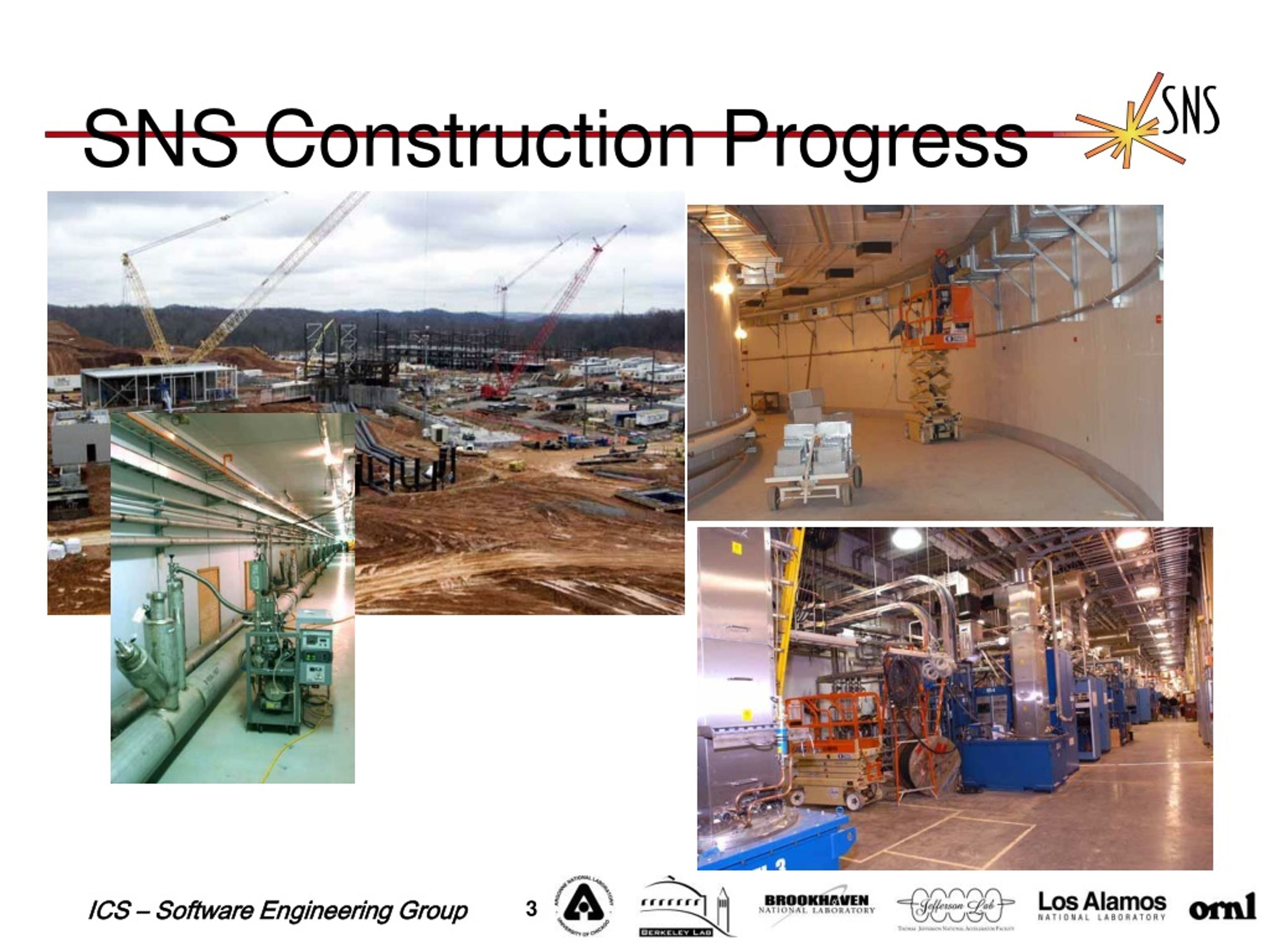

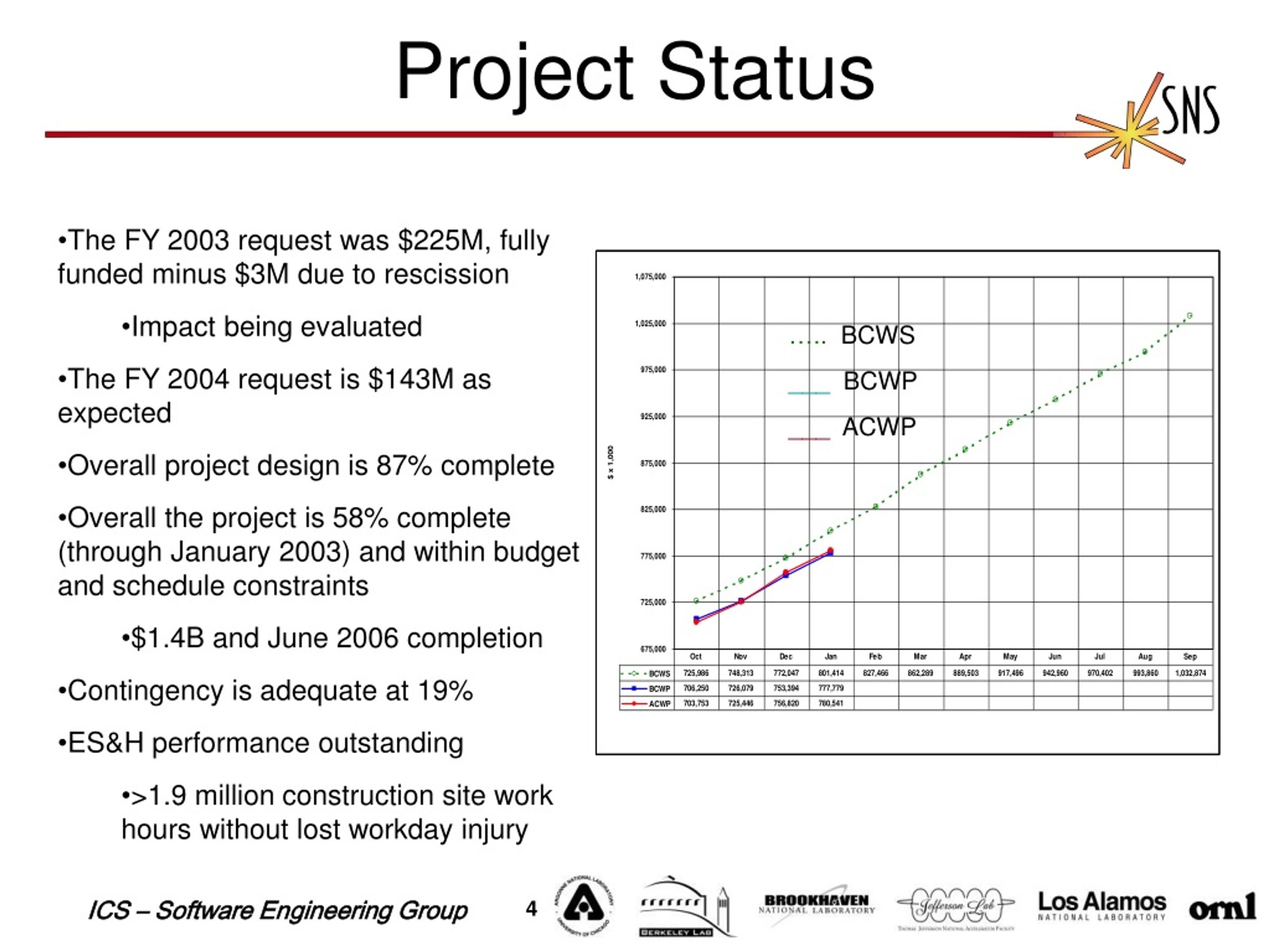

Project Status • The FY 2003 request was $225M, fully funded minus $3M due to rescission • Impact being evaluated • The FY 2004 request is $143M as expected • Overall project design is 87% complete • Overall the project is 58% complete (through January 2003) and within budget and schedule constraints • $1.4B and June 2006 completion • Contingency is adequate at 19% • ES&H performance outstanding • >1.9 million construction site work hours without lost workday injury ….. BCWS ___ BCWP ___ ACWP

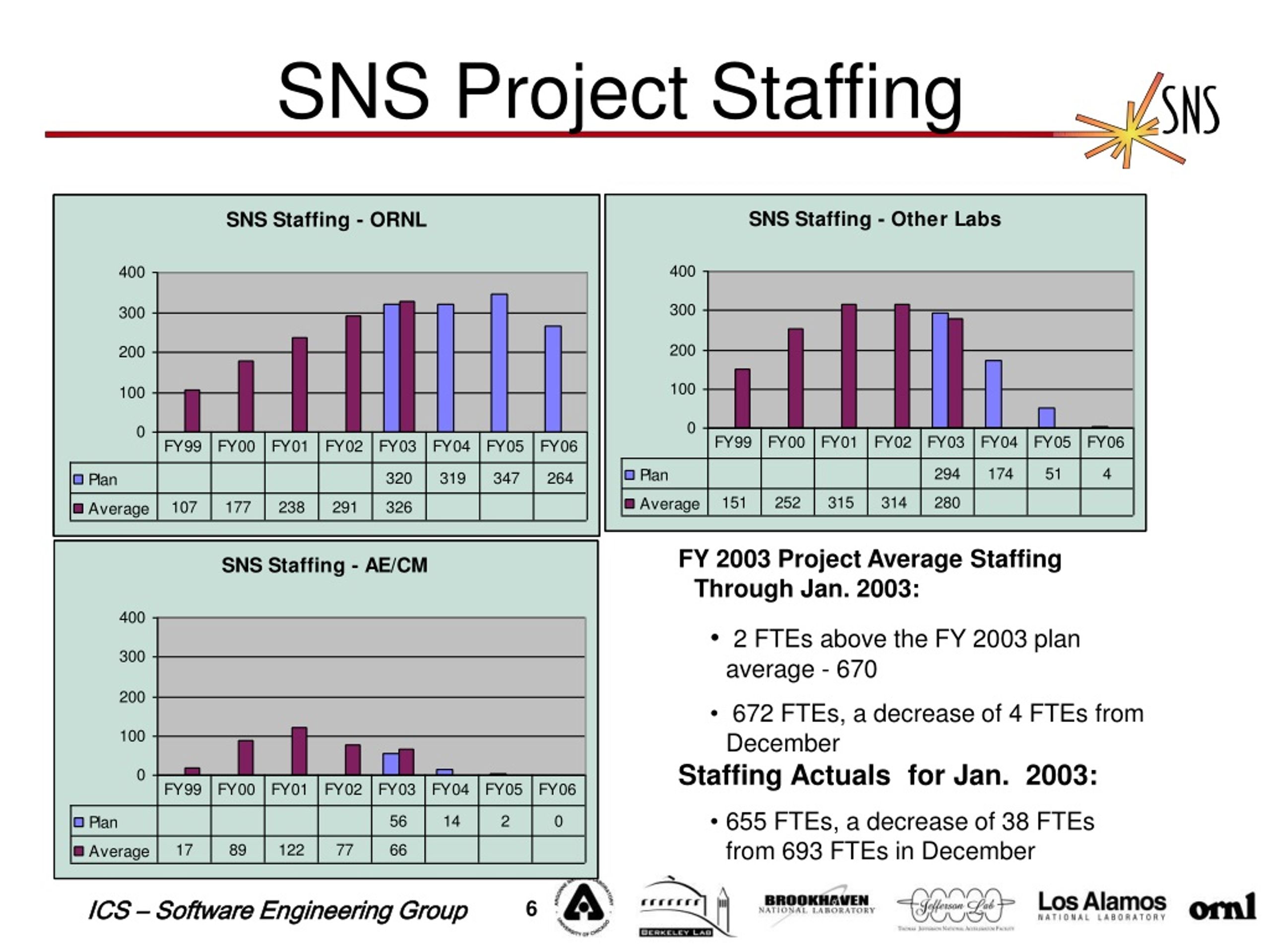

SNS Project Staffing • FY 2003 Project Average Staffing Through Jan. 2003: • 2 FTEs above the FY 2003 plan average - 670 • 672 FTEs, a decrease of 4 FTEs from December • Staffing Actuals for Jan. 2003: • 655 FTEs, a decrease of 38 FTEs from 693 FTEs in December

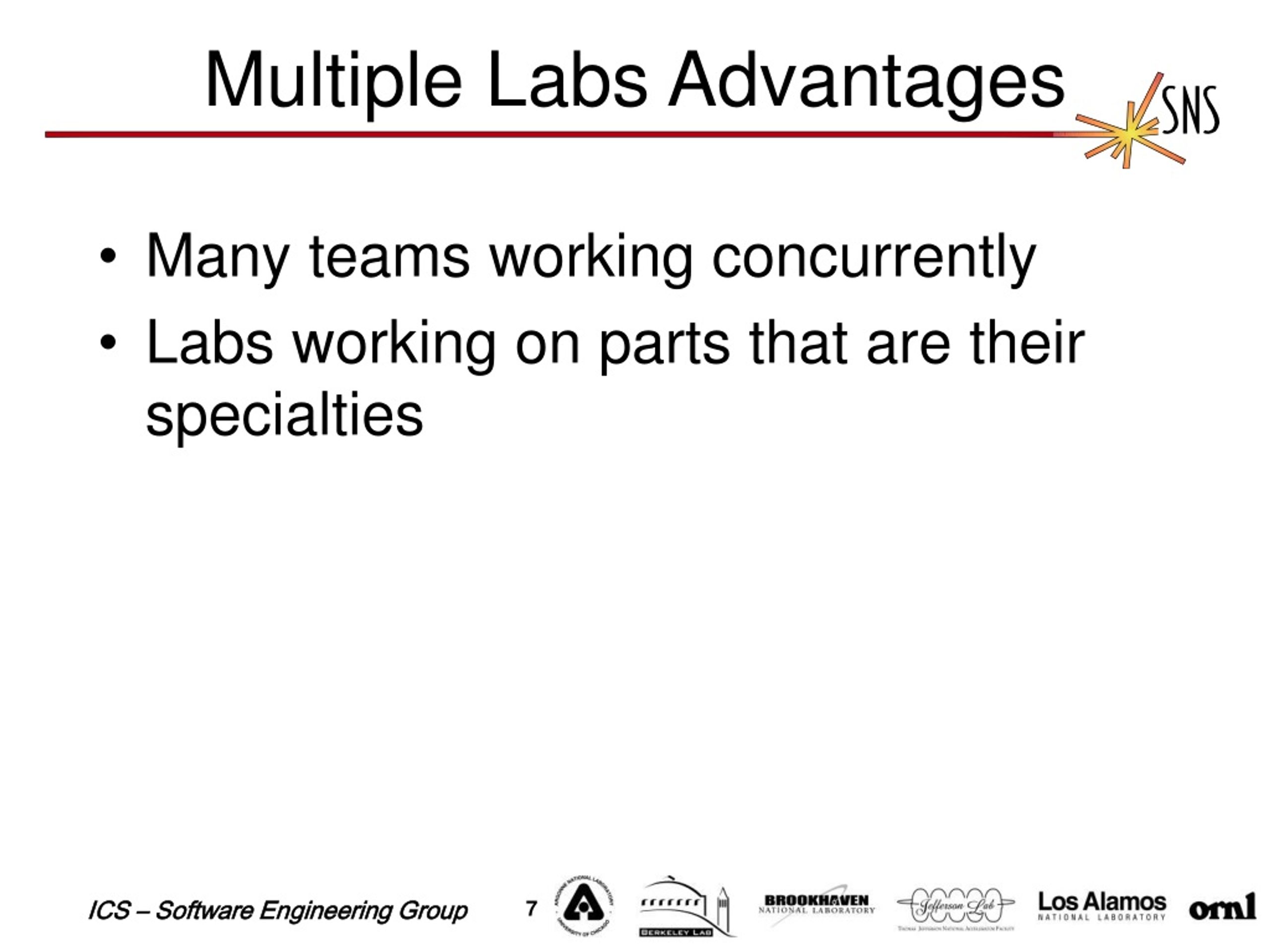

Multiple Labs Advantages • Many teams working concurrently • Labs working on parts that are their specialties

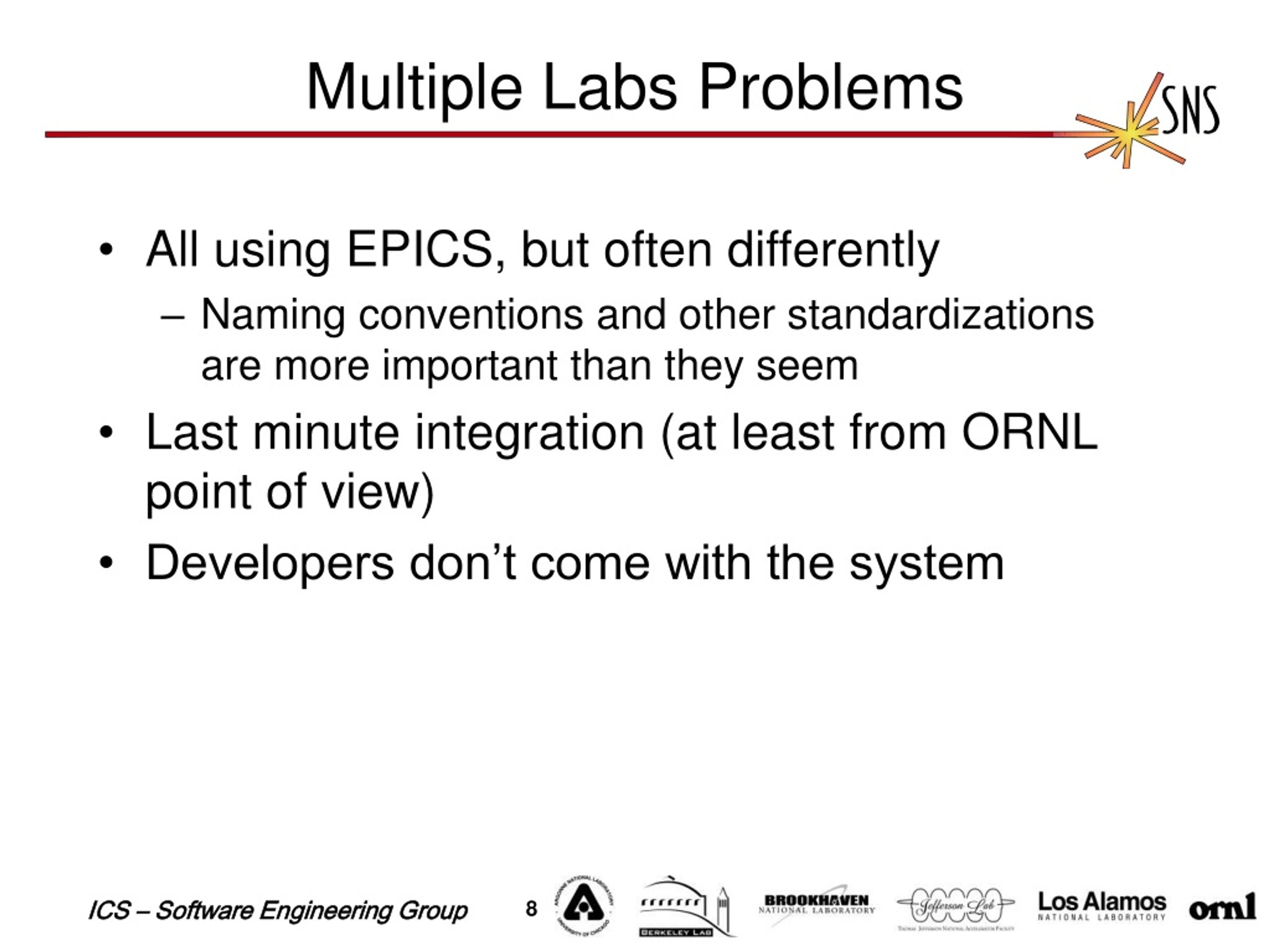

Multiple Labs Problems • All using EPICS, but often differently • Naming conventions and other standardizations are more important than they seem • Last minute integration (at least from ORNL point of view) • Developers don’t come with the system

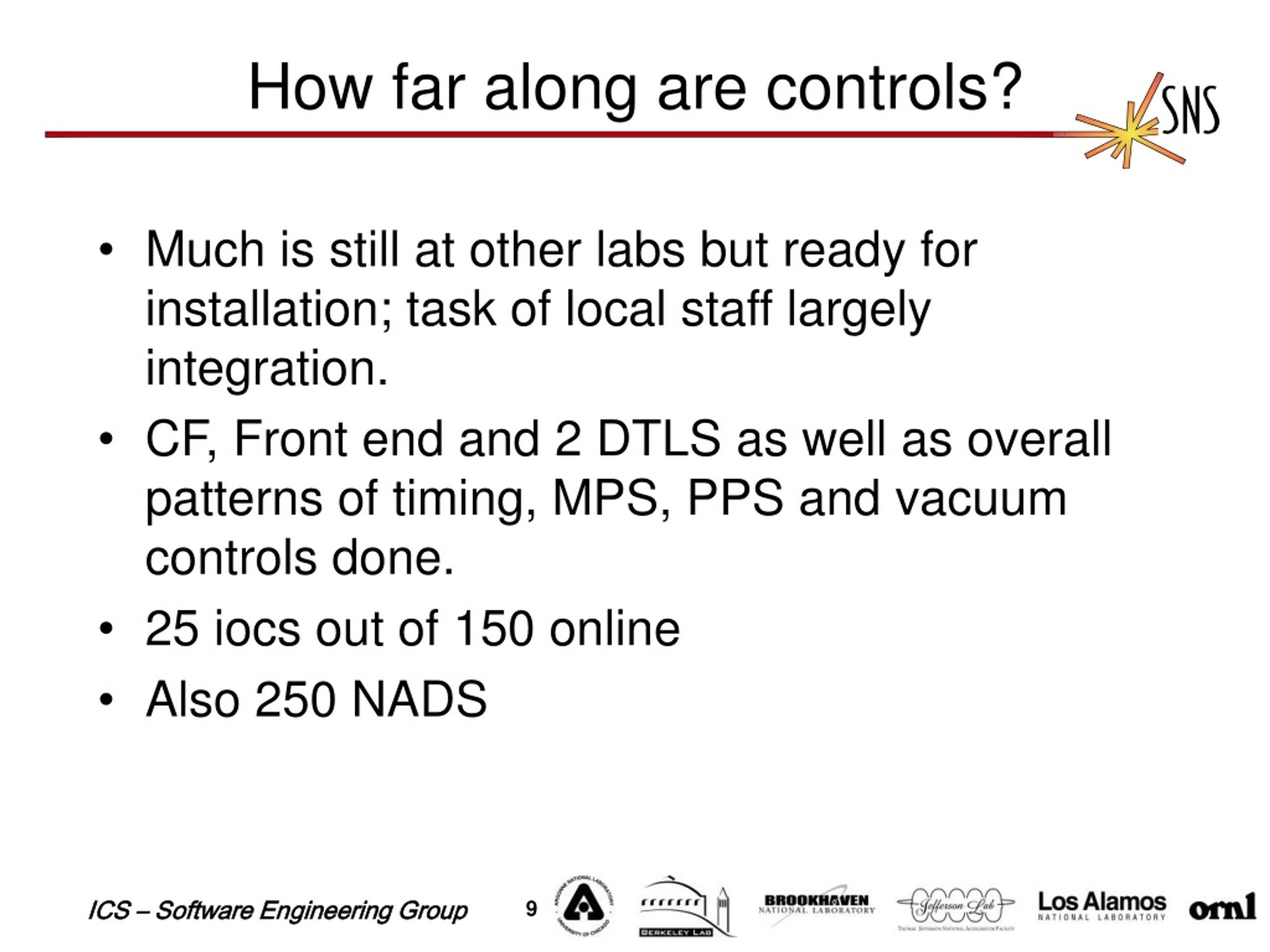

How far along are controls? • Much is still at other labs but ready for installation; task of local staff largely integration. • CF, Front end and 2 DTLS as well as overall patterns of timing, MPS, PPS and vacuum controls done. • 25 iocs out of 150 online • Also 250 NADS

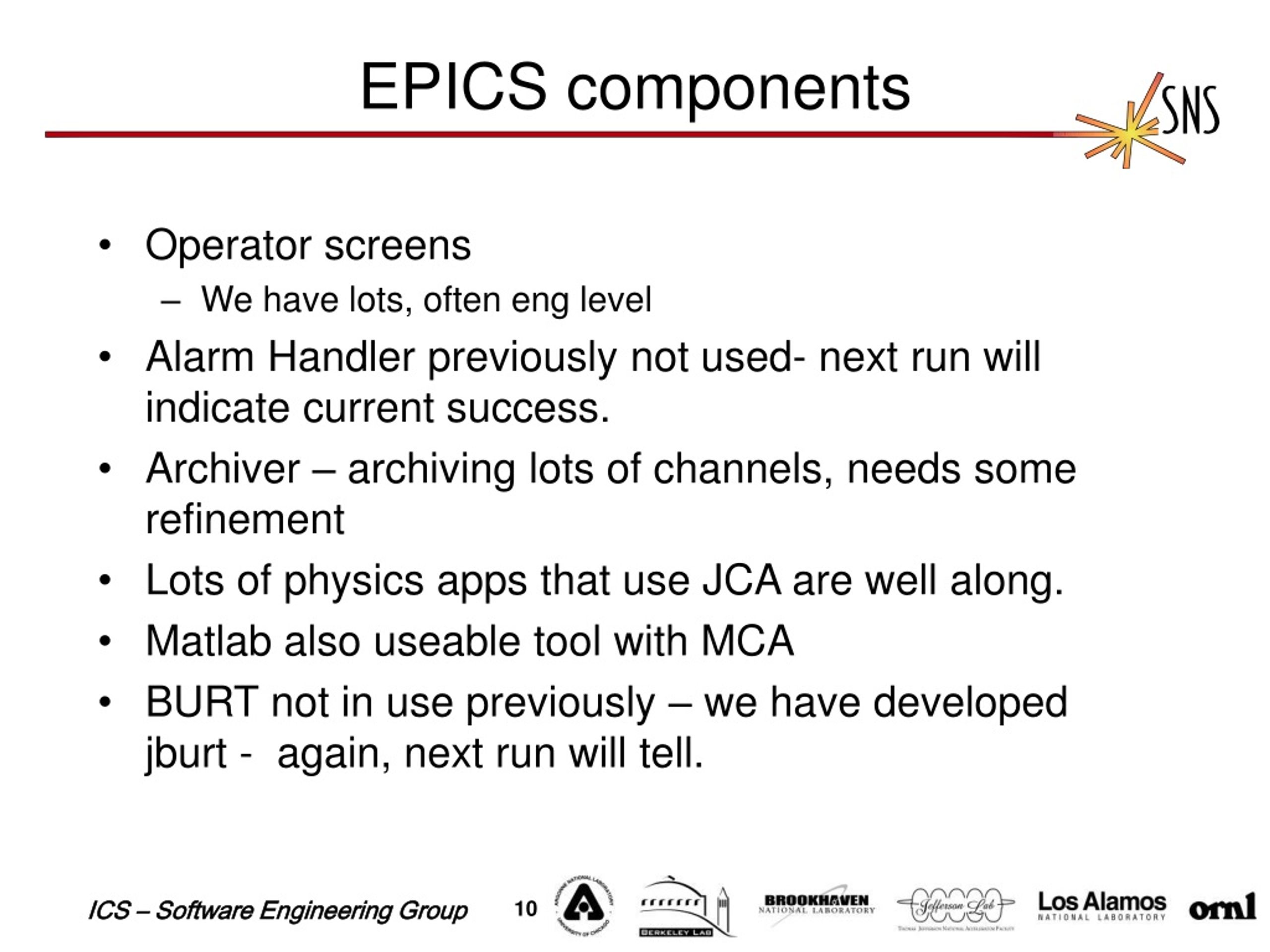

EPICS components • Operator screens • We have lots, often eng level • Alarm Handler previously not used- next run will indicate current success. • Archiver – archiving lots of channels, needs some refinement • Lots of physics apps that use JCA are well along. • Matlab also useable tool with MCA • BURT not in use previously – we have developed jburt - again, next run will tell.

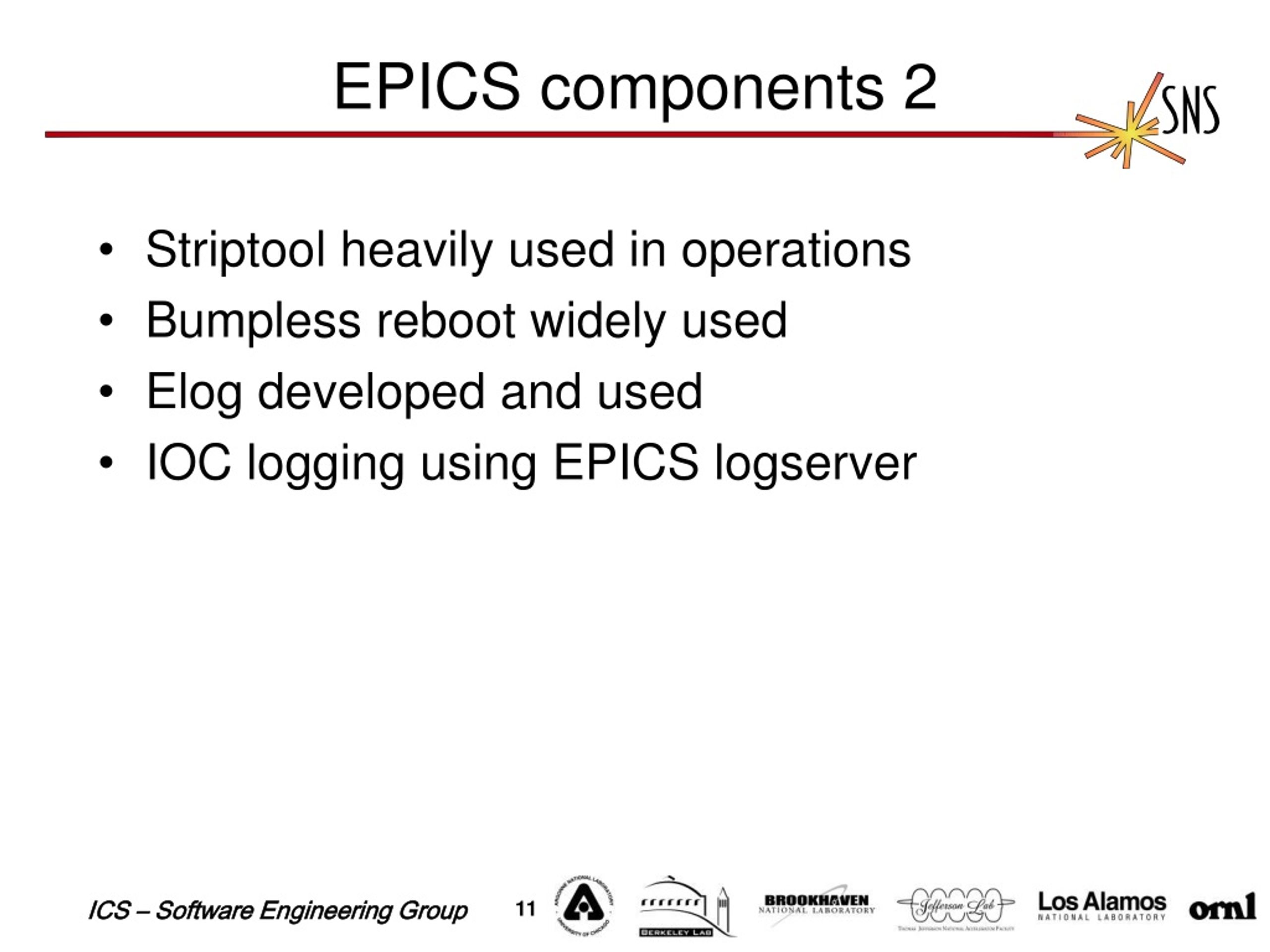

EPICS components 2 • Striptool heavily used in operations • Bumpless reboot widely used • Elog developed and used • IOC logging using EPICS logserver

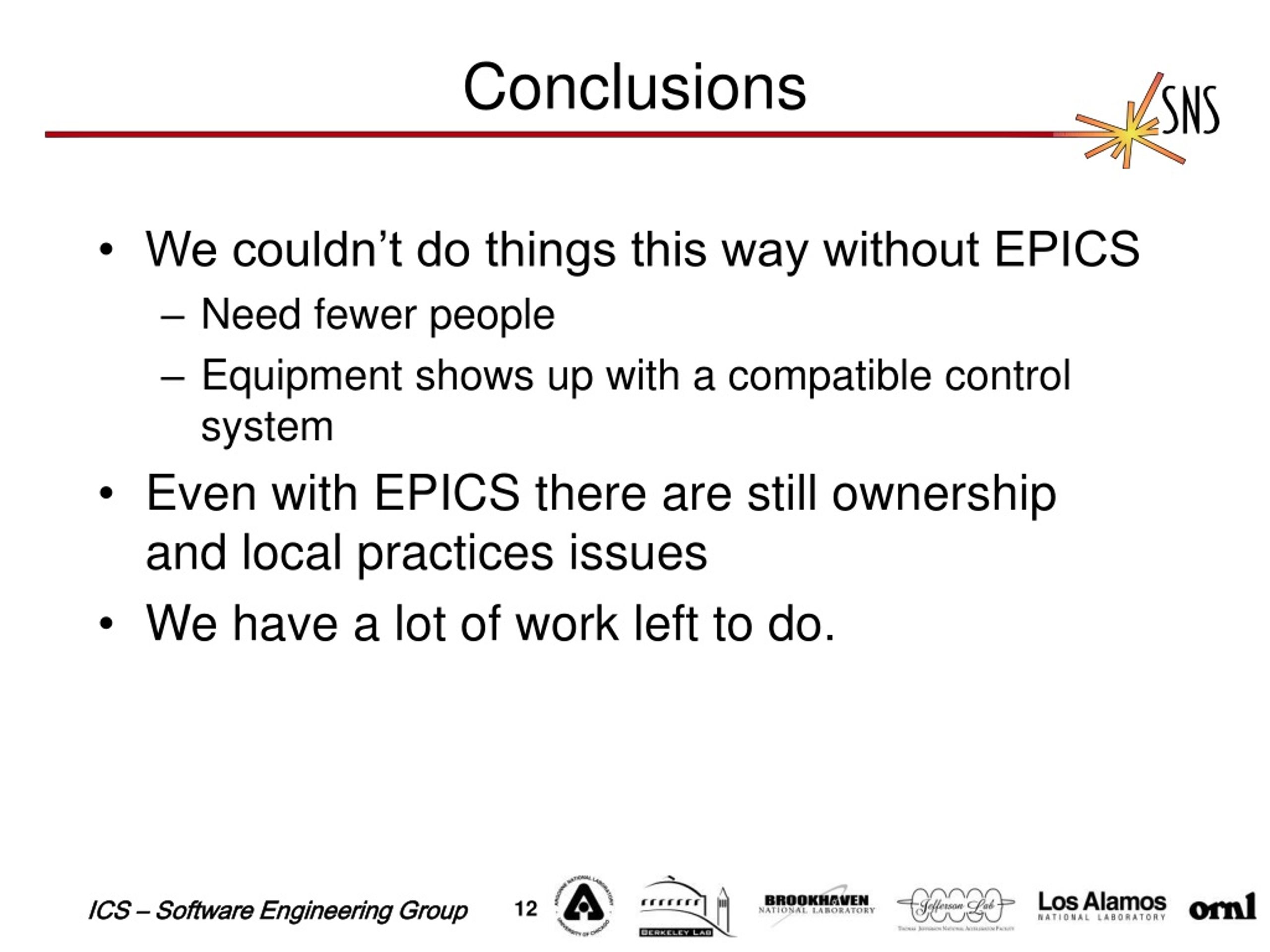

Conclusions • We couldn’t do things this way without EPICS • Need fewer people • Equipment shows up with a compatible control system • Even with EPICS there are still ownership and local practices issues • We have a lot of work left to do.
