Summer Plan. Changhyeok Bae chbae@nm.gist.ac.kr Networked Media Laboratory School of Information and Mechatronics Gwangju Institute of Science & Technology http://nm.gist.ac.kr. Personal Status Review. Current : MS 4 th semester MS Degree by Aug. 2009 (target date) Research Topic
E N D
Summer Plan Changhyeok Bae chbae@nm.gist.ac.kr Networked Media Laboratory School of Information and Mechatronics Gwangju Institute of Science & Technology http://nm.gist.ac.kr

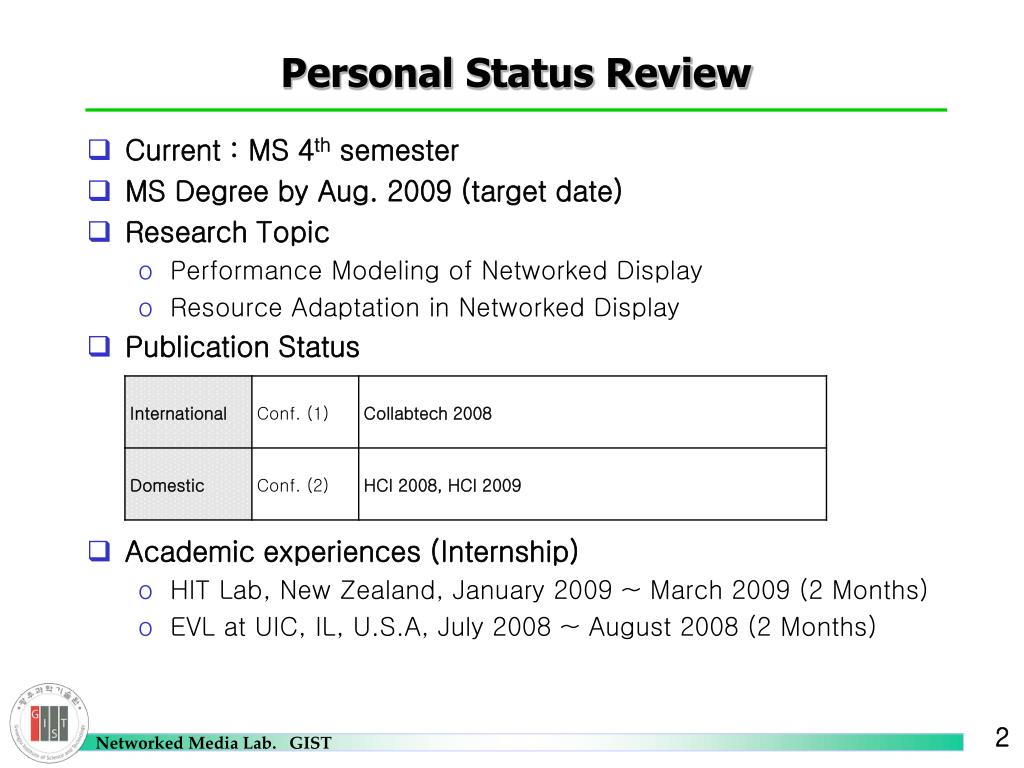

Personal Status Review • Current : MS 4th semester • MS Degree by Aug. 2009 (target date) • Research Topic • Performance Modeling of Networked Display • Resource Adaptation in Networked Display • Publication Status • Academic experiences (Internship) • HIT Lab, New Zealand, January 2009 ~ March 2009 (2 Months) • EVL at UIC, IL, U.S.A, July 2008 ~ August 2008 (2 Months)

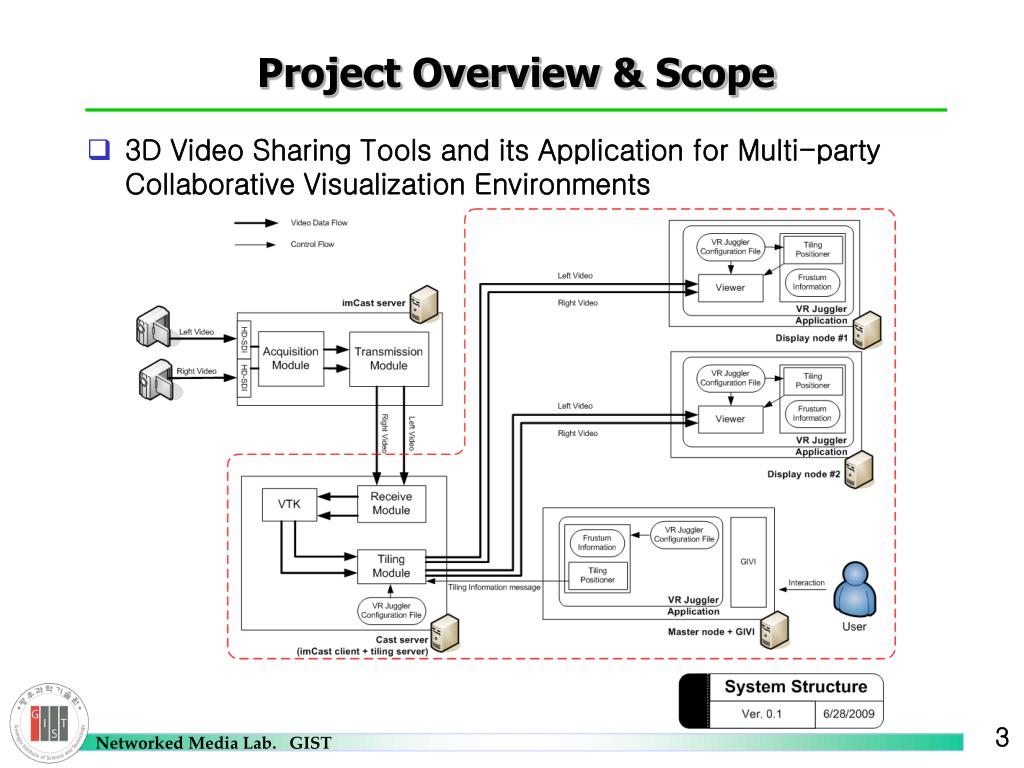

Project Overview & Scope • 3D Video Sharing Tools and its Application for Multi-party Collaborative Visualization Environments

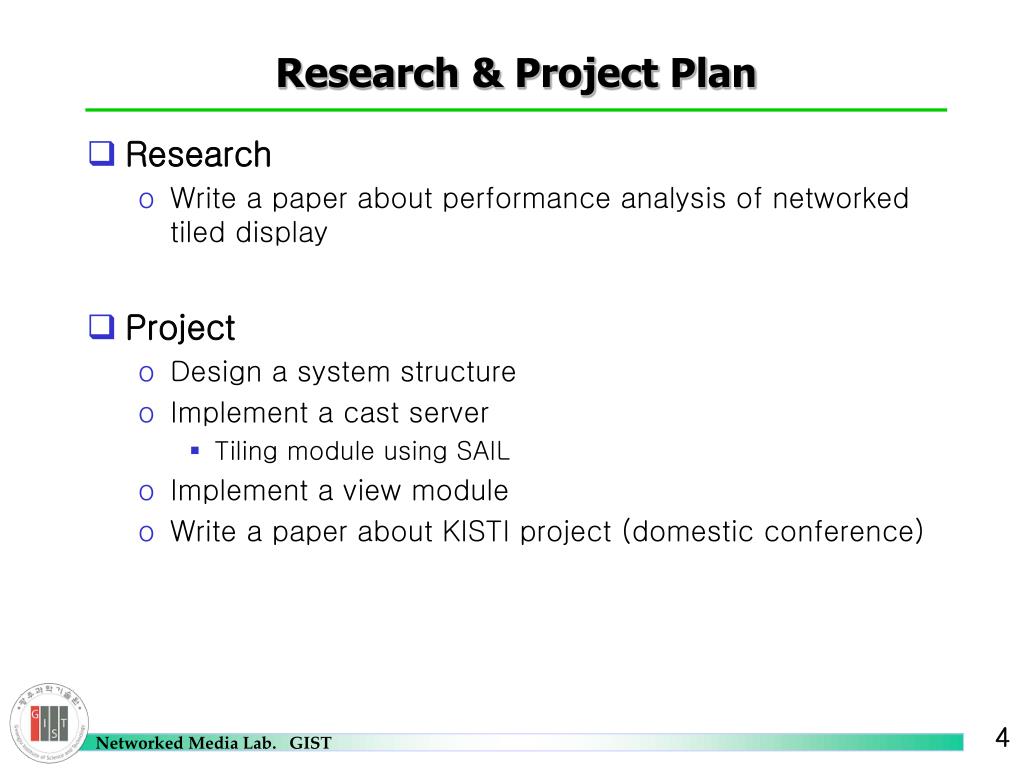

Research & Project Plan • Research • Write a paper about performance analysis of networked tiled display • Project • Design a system structure • Implement a cast server • Tiling module using SAIL • Implement a view module • Write a paper about KISTI project (domestic conference)

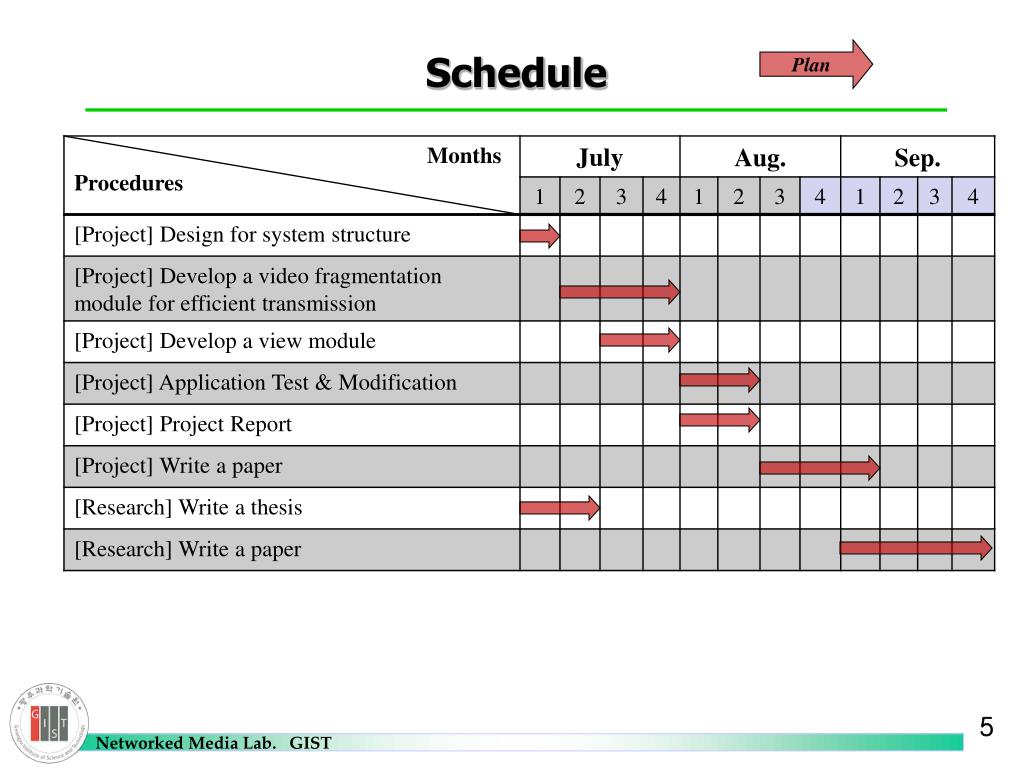

Schedule Plan
