1 / 22

IBM Project Management

IBM Project Management. October 2005. Studies show that lack of good project management often leads to failed projects. .

lok
Download Presentation

IBM Project Management

An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript

  1. IBM Project Management October 2005

  2. Studies show that lack of good project management often leads to failed projects. According to a study by Metagroup ('Why Operation Projects Fail?' November 2002) 70% of large IT projects fail or do not meet the expectations. The most common reasons refer to project management, project planning and communication.

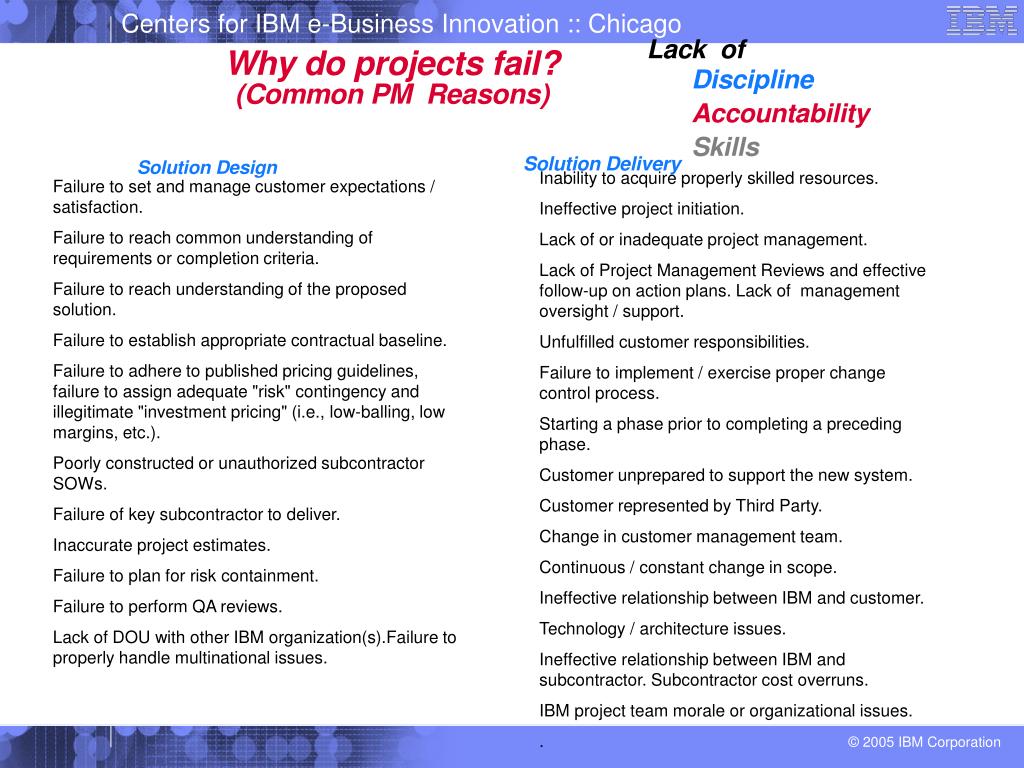

  3. Inability to acquire properly skilled resources. Ineffective project initiation. Lack of or inadequate project management. Lack of Project Management Reviews and effective follow-up on action plans. Lack of management oversight / support. Unfulfilled customer responsibilities. Failure to implement / exercise proper change control process. Starting a phase prior to completing a preceding phase. Customer unprepared to support the new system. Customer represented by Third Party. Change in customer management team. Continuous / constant change in scope. Ineffective relationship between IBM and customer. Technology / architecture issues. Ineffective relationship between IBM and subcontractor. Subcontractor cost overruns. IBM project team morale or organizational issues. . Failure to set and manage customer expectations / satisfaction. Failure to reach common understanding of requirements or completion criteria. Failure to reach understanding of the proposed solution. Failure to establish appropriate contractual baseline. Failure to adhere to published pricing guidelines, failure to assign adequate "risk" contingency and illegitimate "investment pricing" (i.e., low-balling, low margins, etc.). Poorly constructed or unauthorized subcontractor SOWs. Failure of key subcontractor to deliver. Inaccurate project estimates. Failure to plan for risk containment. Failure to perform QA reviews. Lack of DOU with other IBM organization(s).Failure to properly handle multinational issues.

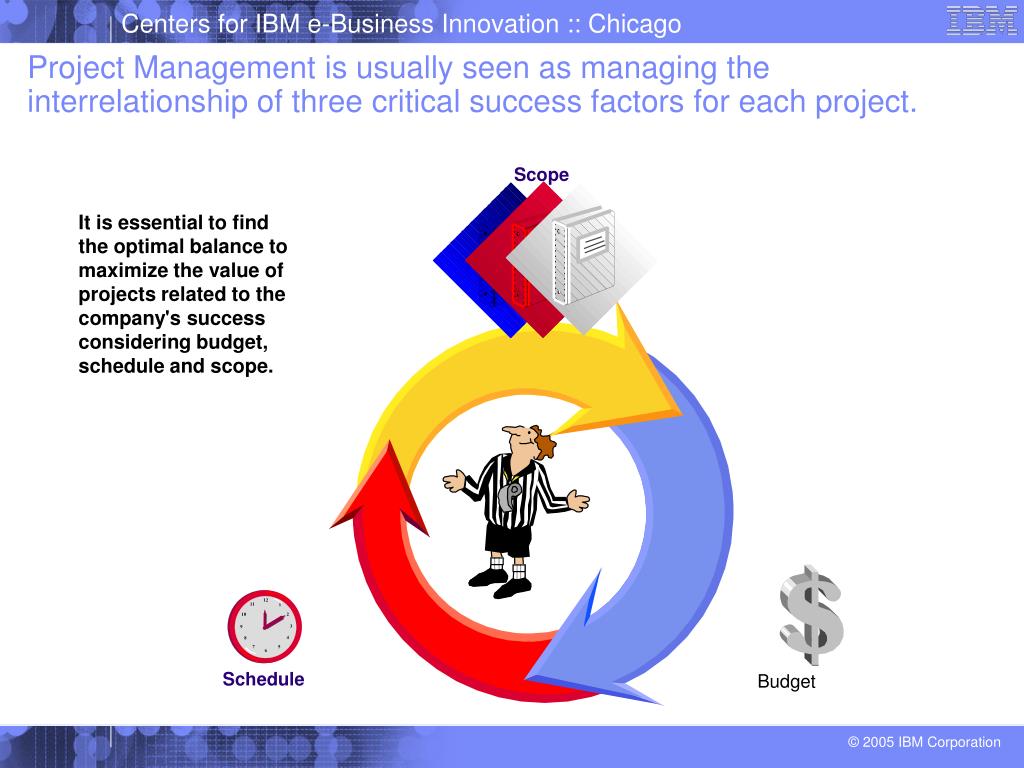

  4. Scope 12 11 1 10 2 3 9 4 8 7 5 6 Schedule Budget Project Management is usually seen as managing the interrelationship of three critical success factors for each project. It is essential to find the optimal balance to maximize the value of projects related to the company's success considering budget, schedule and scope.

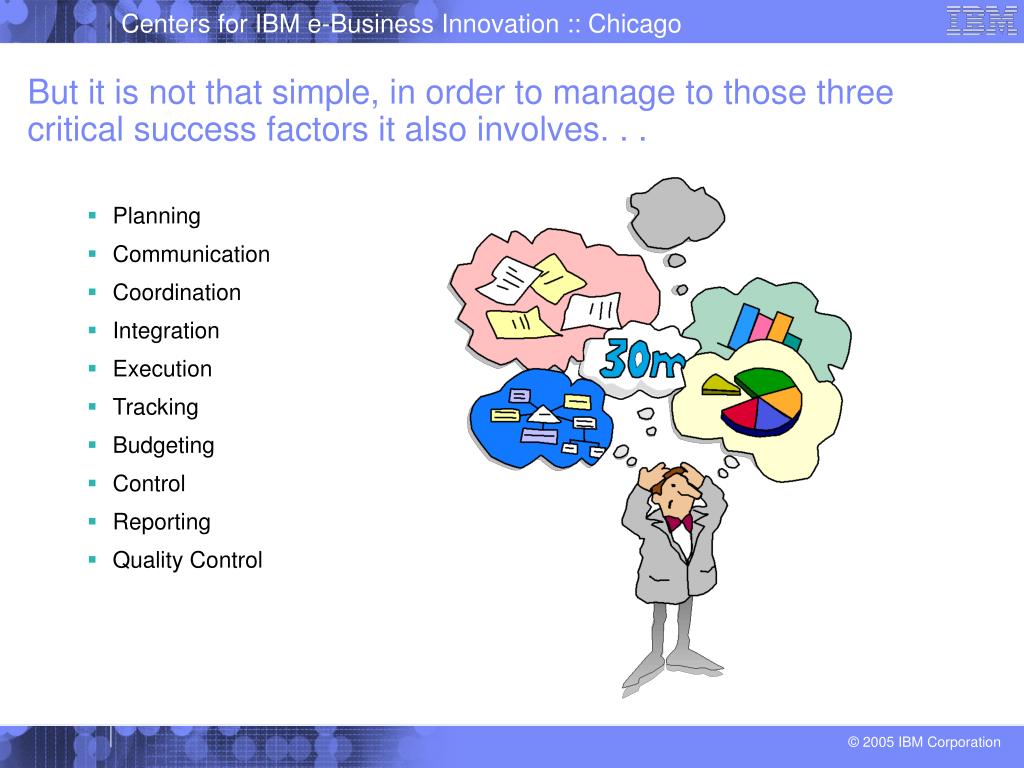

  5. But it is not that simple, in order to manage to those three critical success factors it also involves. . . • Planning • Communication • Coordination • Integration • Execution • Tracking • Budgeting • Control • Reporting • Quality Control

  6. IBM’s Project Management Approach • Project Based Business • Project Management Office (PMO) • Processes/Methodology (WWPMM) • Project Management Maturity Guide (PMPMG) • Tools – Rational Portfolio Manager • Mentoring/Staffing • Education

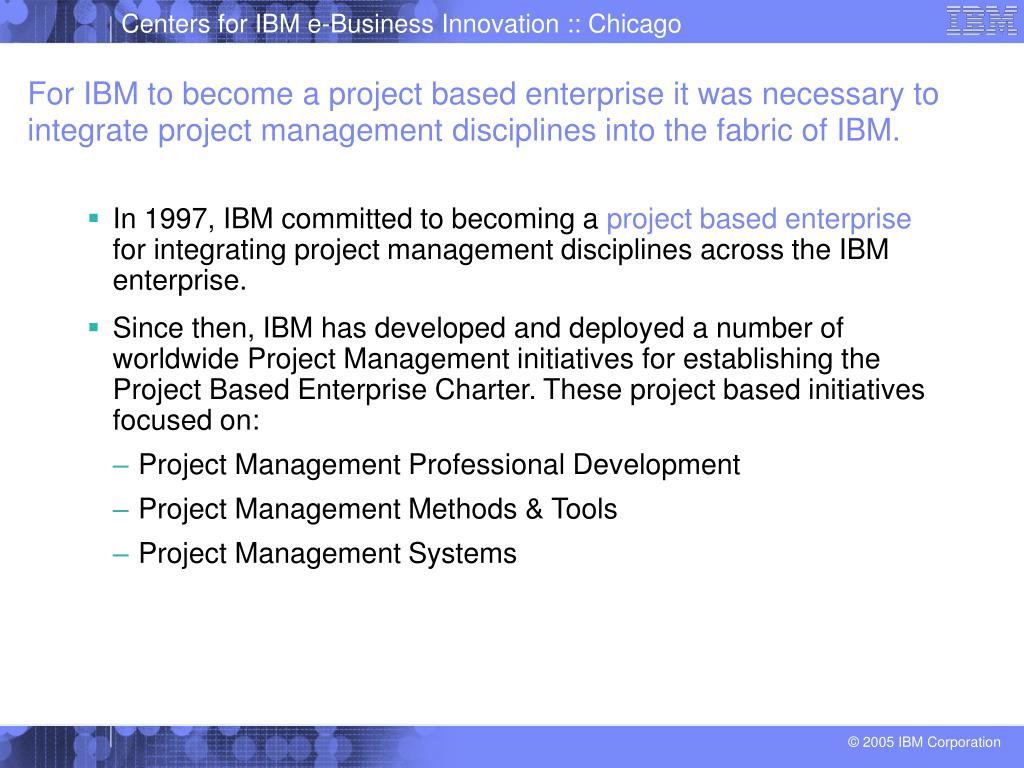

  7. For IBM to become a project based enterprise it was necessary to integrate project management disciplines into the fabric of IBM. • In 1997, IBM committed to becoming a project based enterprise for integrating project management disciplines across the IBM enterprise. • Since then, IBM has developed and deployed a number of worldwide Project Management initiatives for establishing the Project Based Enterprise Charter. These project based initiatives focused on: • Project Management Professional Development • Project Management Methods & Tools • Project Management Systems

  8. Project Management Office (PMO)

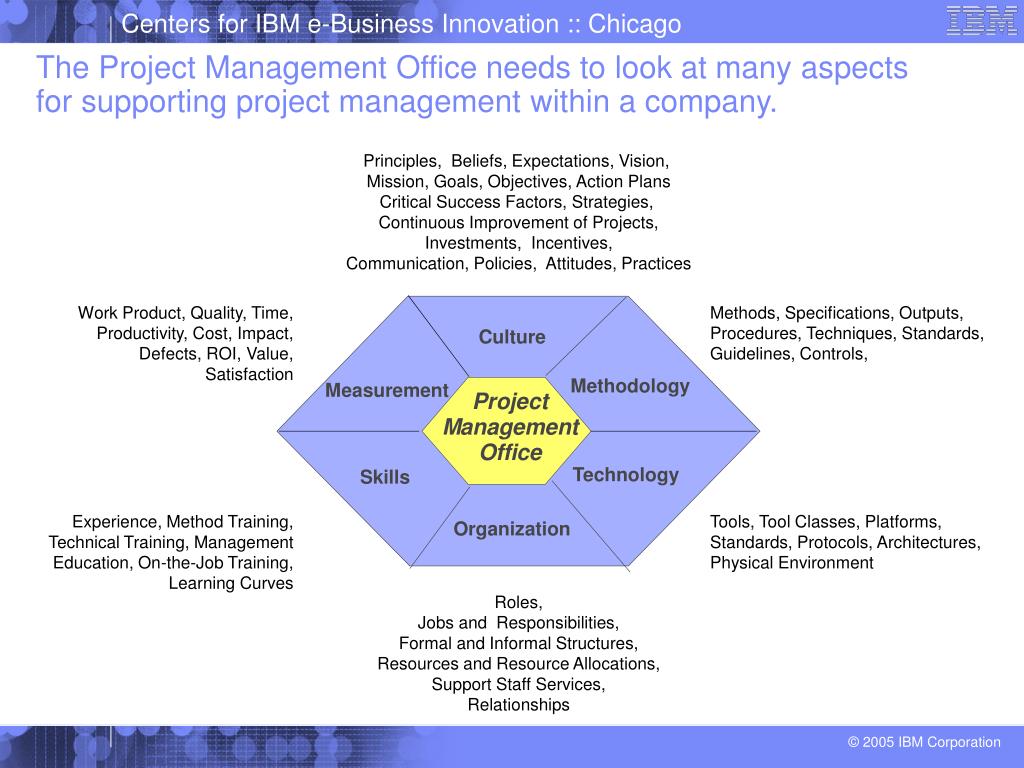

  9. The Project Management Office needs to look at many aspects for supporting project management within a company. Principles, Beliefs, Expectations, Vision, Mission, Goals, Objectives, Action Plans Critical Success Factors, Strategies, Continuous Improvement of Projects,Investments, Incentives, Communication, Policies, Attitudes, Practices Work Product, Quality, Time,Productivity, Cost, Impact,Defects, ROI, Value,Satisfaction Methods, Specifications, Outputs, Procedures, Techniques, Standards, Guidelines, Controls, Experience, Method Training,Technical Training, ManagementEducation, On-the-Job Training,Learning Curves Tools, Tool Classes, Platforms, Standards, Protocols, Architectures, Physical Environment Roles, Jobs and Responsibilities, Formal and Informal Structures, Resources and Resource Allocations, Support Staff Services, Relationships

  10. Process and Methodology WWPMM IBM Methodology to Support PM

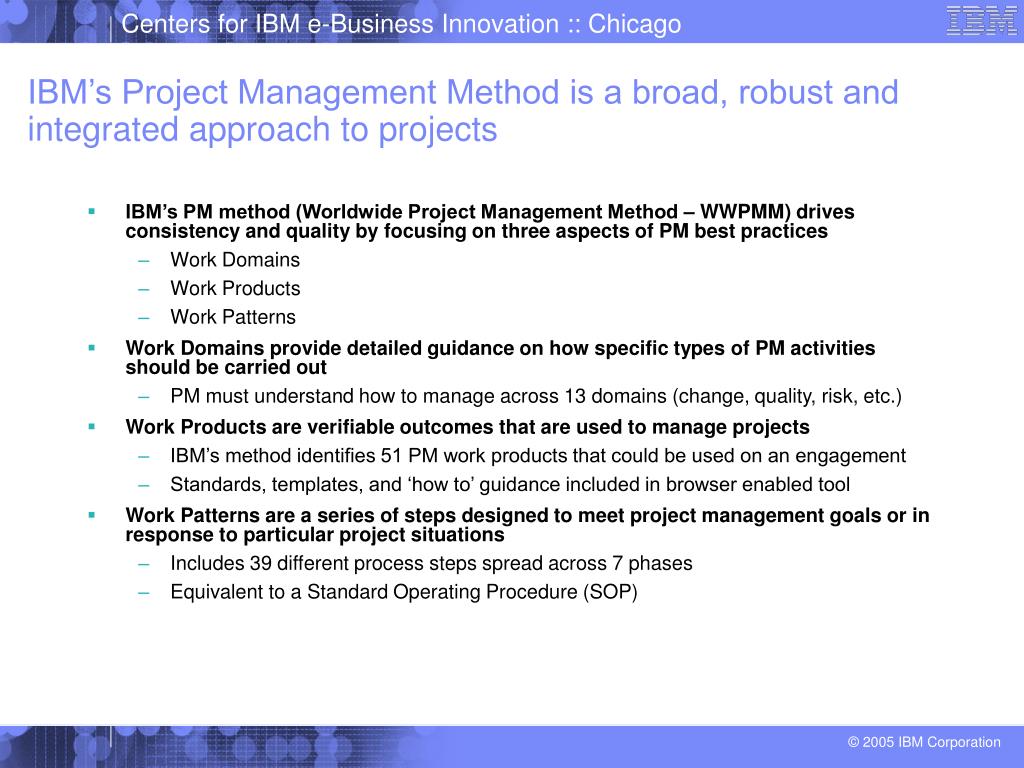

  11. IBM’s Project Management Method is a broad, robust and integrated approach to projects • IBM’s PM method (Worldwide Project Management Method – WWPMM) drives consistency and quality by focusing on three aspects of PM best practices • Work Domains • Work Products • Work Patterns • Work Domains provide detailed guidance on how specific types of PM activities should be carried out • PM must understand how to manage across 13 domains (change, quality, risk, etc.) • Work Products are verifiable outcomes that are used to manage projects • IBM’s method identifies 51 PM work products that could be used on an engagement • Standards, templates, and ‘how to’ guidance included in browser enabled tool • Work Patterns are a series of steps designed to meet project management goals or in response to particular project situations • Includes 39 different process steps spread across 7 phases • Equivalent to a Standard Operating Procedure (SOP)

  12. World Wide Project Management Methodology - WWPMM • WWPMM helps define the PM System, a collection of plans, procedures and records that direct all PM activities and describe the current state and history of the project. • Generic templates are provided in downloadable form, from the WWPMM reference page and through various PM tools. • When used with appropriate tools and integrated with business and technical management systems, this material provides a comprehensive PM environment. How the project is shaped, and how its execution is managed How the work is done

  13. Project Management Process Maturity Assessment Levels

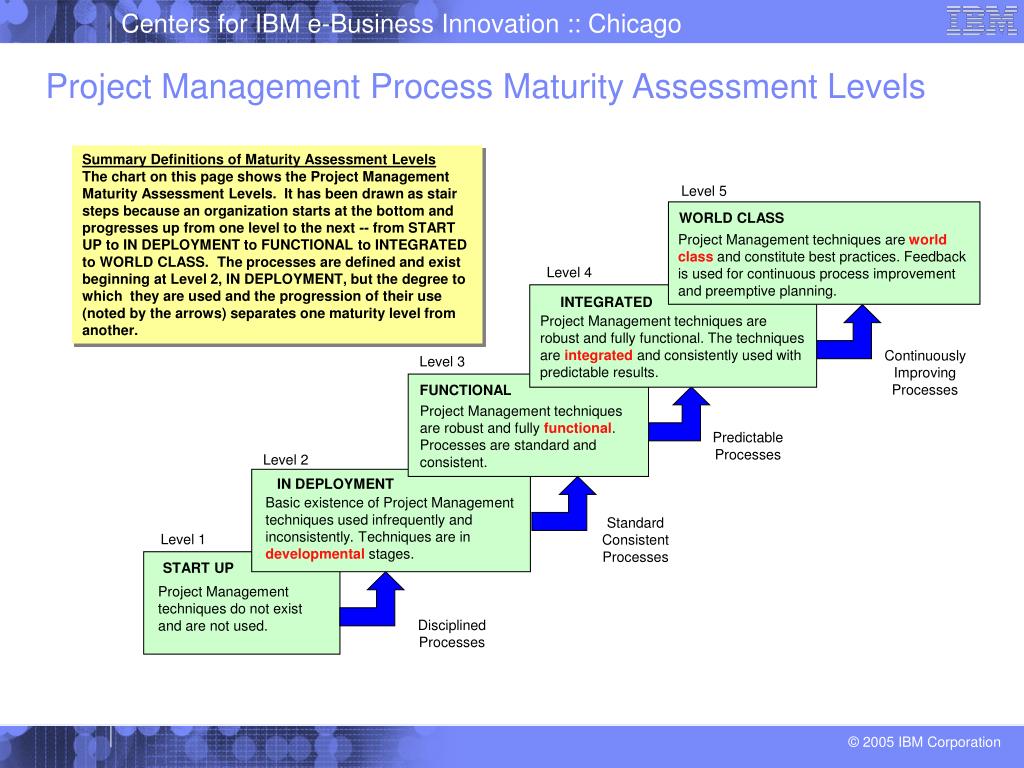

  14. Level 4 Level 5 INTEGRATED Project Management techniques are robust and fully functional. The techniques are integrated and consistently used with predictable results. WORLD CLASS Project Management techniques are world class and constitute best practices. Feedback is used for continuous process improvement and preemptive planning. Level 2 Level 3 IN DEPLOYMENT Basic existence of Project Management techniques used infrequently and inconsistently. Techniques are in developmental stages. FUNCTIONAL Project Management techniques are robust and fullyfunctional. Processes are standard and consistent. Level 1 Project Management techniques do not exist and are not used. START UP Project Management Process Maturity Assessment Levels Summary Definitions of Maturity Assessment Levels The chart on this page shows the Project Management Maturity Assessment Levels. It has been drawn as stair steps because an organization starts at the bottom and progresses up from one level to the next -- from START UP to IN DEPLOYMENT to FUNCTIONAL to INTEGRATED to WORLD CLASS. The processes are defined and exist beginning at Level 2, IN DEPLOYMENT, but the degree to which they are used and the progression of their use (noted by the arrows) separates one maturity level from another. Continuously Improving Processes Predictable Processes Standard Consistent Processes Disciplined Processes

  15. Project Management Tools IBM Rational Portfolio Manager

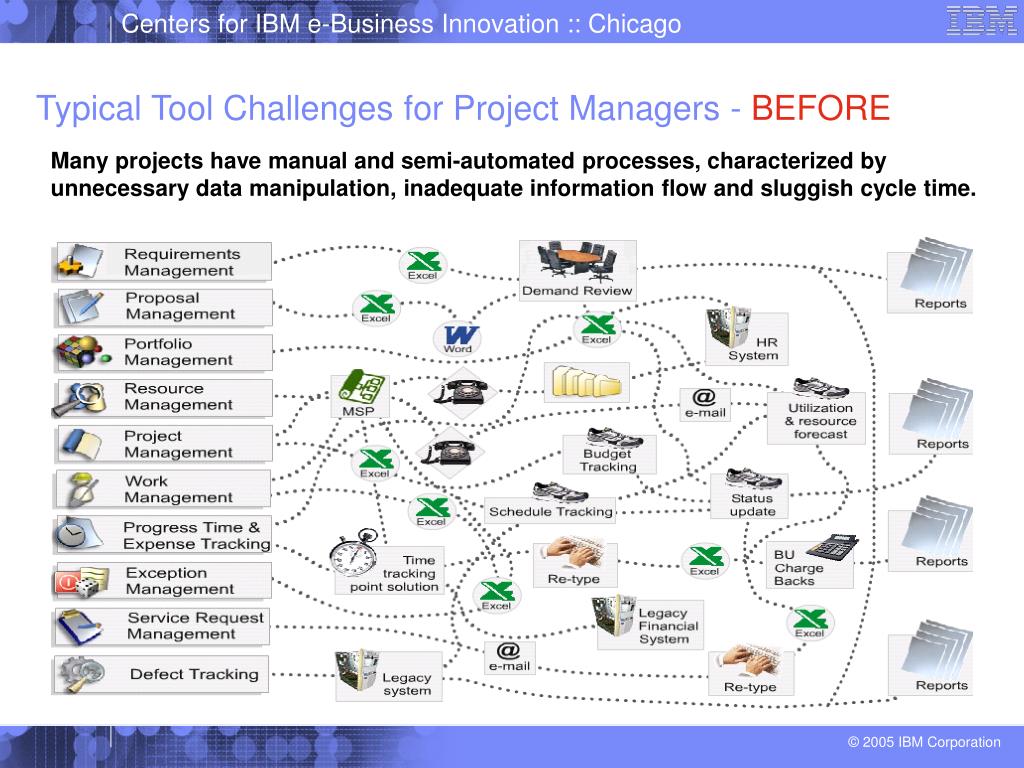

  16. Typical Tool Challenges for Project Managers - BEFORE Many projects have manual and semi-automated processes, characterized by unnecessary data manipulation, inadequate information flow and sluggish cycle time.

  17. Rational Portfolio Manager is IBM’s Solution of Choice - AFTER Rational PM provides process automation, thereby increasing efficiency and reducing the complexity of project and portfolio processes. One stop shop” project repository, including the project control book Support more effective project startup Superior project tracking and control capabilities Project management process support Collaborative and communicative project environment

  18. Project Management Education and Certification IBM Rational Portfolio Manager

  19. IBM can supply skilled Project Management Mentoring and Staffing Capability IBM’s certification process is more demanding than the standards set by the Project Management Institute

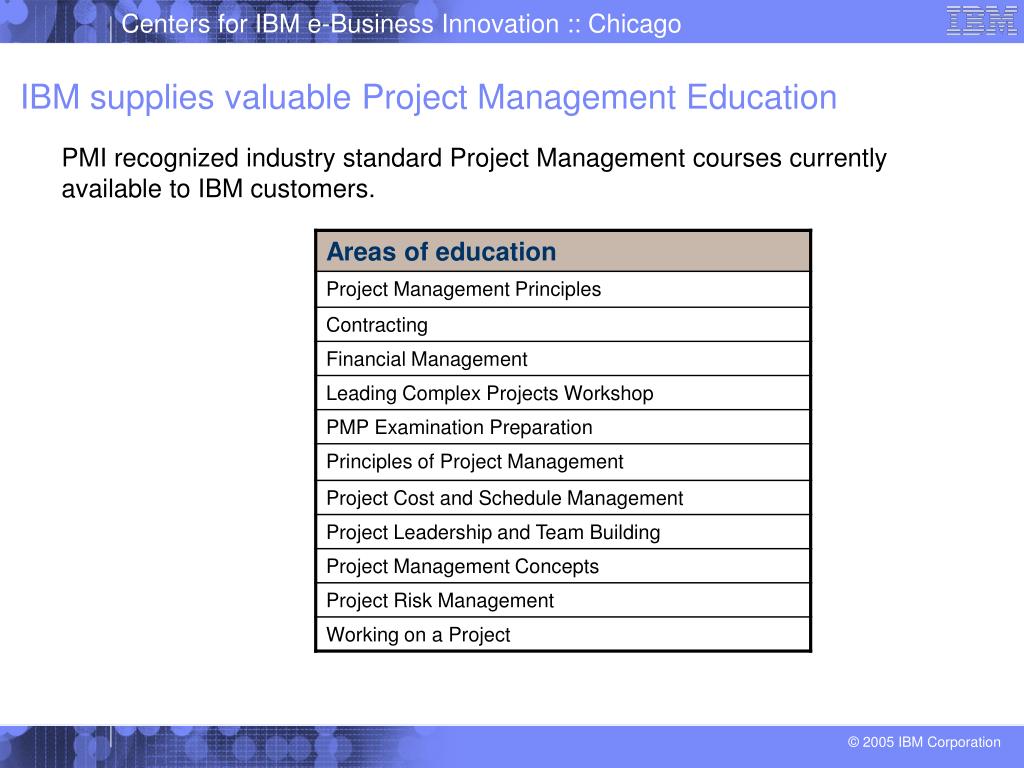

  20. IBM supplies valuable Project Management Education PMI recognized industry standard Project Management courses currently available to IBM customers.
