Due Date Planning for Complex Product Systems with Uncertain Processing Times

Due Date Planning for Complex Product Systems with Uncertain Processing Times. By : Dongping Song Supervisor : Dr. C.Hicks and Dr. C.F.Earl Dept. of MMM Eng. Univ. of Newcastle upon Tyne April, 1999. Overview. 1. Introduction 2. Literature review

Download Presentation

Due Date Planning for Complex Product Systems with Uncertain Processing Times

An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript


  1. Due Date Planning for Complex Product Systemswith Uncertain Processing Times By: Dongping Song Supervisor: Dr. C.HicksandDr. C.F.Earl Dept. of MMM Eng. Univ. of Newcastle upon Tyne April, 1999

  2. Overview 1. Introduction 2. Literature review 3. Leadtime distribution estimation 4. Due date planning 5. Industrial case study 6. Discussion and conclusion 7. Further work

  3. Introduction

  4. Uncertainty in processing • disrupt the timing of material receipt • result in deviation of completion time from due date

  5. Introduction • Complex product system • Assembly and product structure • Uncertain processing times • Cumulative and interacting • Problem : setting due date in complex product systems withuncertainprocessing times

  6. Uncertainty in complex products

  7. Literature Review Two principal research streams [Cheng(1989), Lawrence(1995)] • Empirical method: based on job characteristics and shop status. Such as: TWK, SLK, NOP, JIQ, JIS Due date(DD) = k1×TWK + k2 • Analytic method: queuing networks, mathematical programming etc.by minimising a cost function

  8. Literature Review Limitation of above research • Both focus on job shop situations • Empirical - rely on simulation, time consuming in stochastic systems • Analytic - limited to “small” problems

  9. Appr. procedure for product DD

  10. Appr. procedure for stage DD

  11. Simple Two Stage System • Product structure

  12. Planned start time S1, S1i • Holding cost at subsequent stage • Resource capacity limitation • Reduce variability

  13. Minimum processing time M1 • Prob. density func.(PDF)Cumul. distr. func.(CDF) • Big variance may result in negative operation times

  14. Analytical Result • CDF of leadtime W is: FW(t)= 0, t<M1+S1; FW(t) = F1(M1) FZ(t-M1) + F1¢ÄFZ, t ³ M1 + S1. where F1 ¾ CDF of assembly processing time; FZ¾ CDF of actual assembly start time; FZ(t)= P1n F1i(t-S1i) ľ convolution operator in [M1, t - S1]; F1¢ÄFZ= òF1¢(x) FZ(x-t)dx

  15. Leadtime Distribution Estimation Complex product structure • approximate method Assumptions • normally distributed processing times • approximate leadtime by truncated normal distribution (Soroush, 1999)

  16. Leadtime Distribution Estimation Normal distribution approximation • Compute mean and variance of assembly start time Z and assembly process time Q : mZ, sZ2andmQ, sQ2 • Obtain mean and variance of leadtime W(=Z+Q): mW = mQ+mZ, sW2 = sQ2+sZ2 • Approximate W by truncated normal distribution: N(mW, sW2), t ³ M1+ S1. More moments are needed if using general distribution to approximate

  17. Due Date Planning • Achieve a specified probability ÞDD* by N(0, 1)

  18. Due Date Planning • Mean absolute lateness (MAL) ÞDD* = median • Standard deviation lateness (SDL) ÞDD* = mean • Asymmetric earliness and tardiness cost ÞDD* by root finding method

  19. Industrial Case Study • Product structure 17 components 17 components

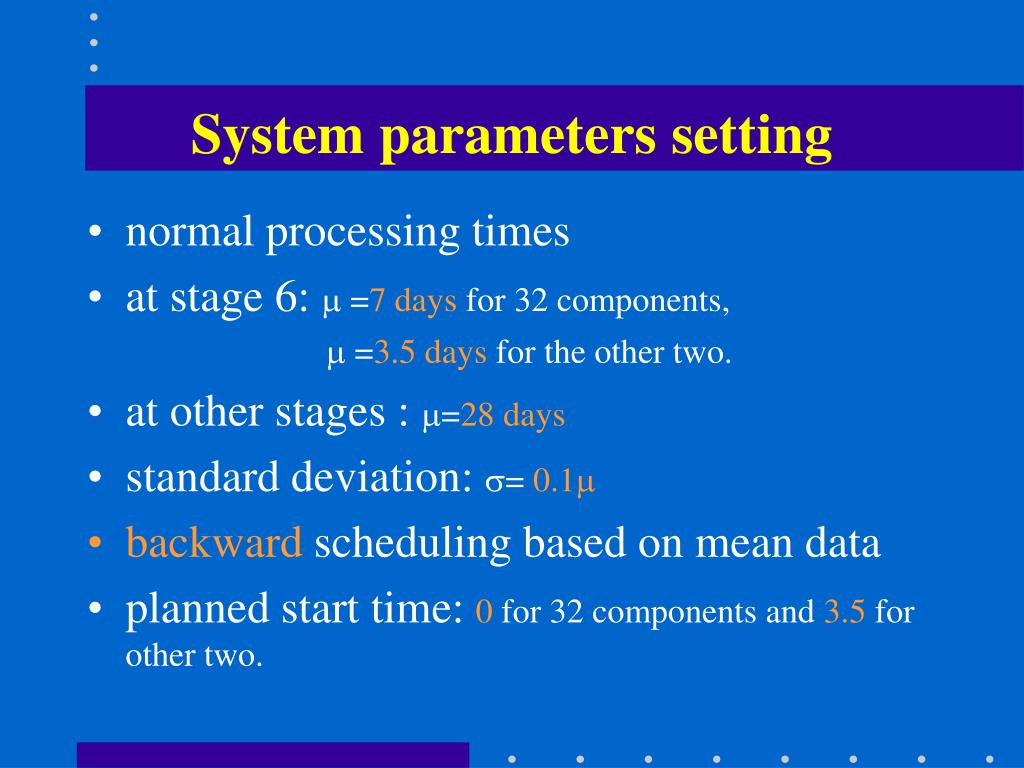

  20. System parameters setting • normal processing times • at stage 6: m =7days for 32 components, m =3.5 days for the other two. • at other stages : m=28 days • standard deviation: s= 0.1m • backward scheduling based on mean data • planned start time: 0 for 32 components and 3.5 for other two.

  21. Simulation histogram & Appr. PDF

  22. Simulation histogram & Appr. PDF

  23. Product Due Date • Simulation verification for product due date to achieve specified probability

  24. Stage Due Dates • Simulation verification for stage due dates to achieve 90% probability

  25. Discussion • Minimum processing time • Production plan • Stage due date

  26. Conclusion • Complex product systems with uncertainty • A procedure to estimate leadtime distribution • Approximate method to set due dates • Used to design planned start times

  27. Further Work • Skewed processing times • Using more general distribution to approximate, like l-type distribution • Resource constraint systems
