Office of the New Mexico Secretary of StateBusiness Filing System – Phase 2 Change Request Presented to the DoIT Project Certification Committee June 25, 2014

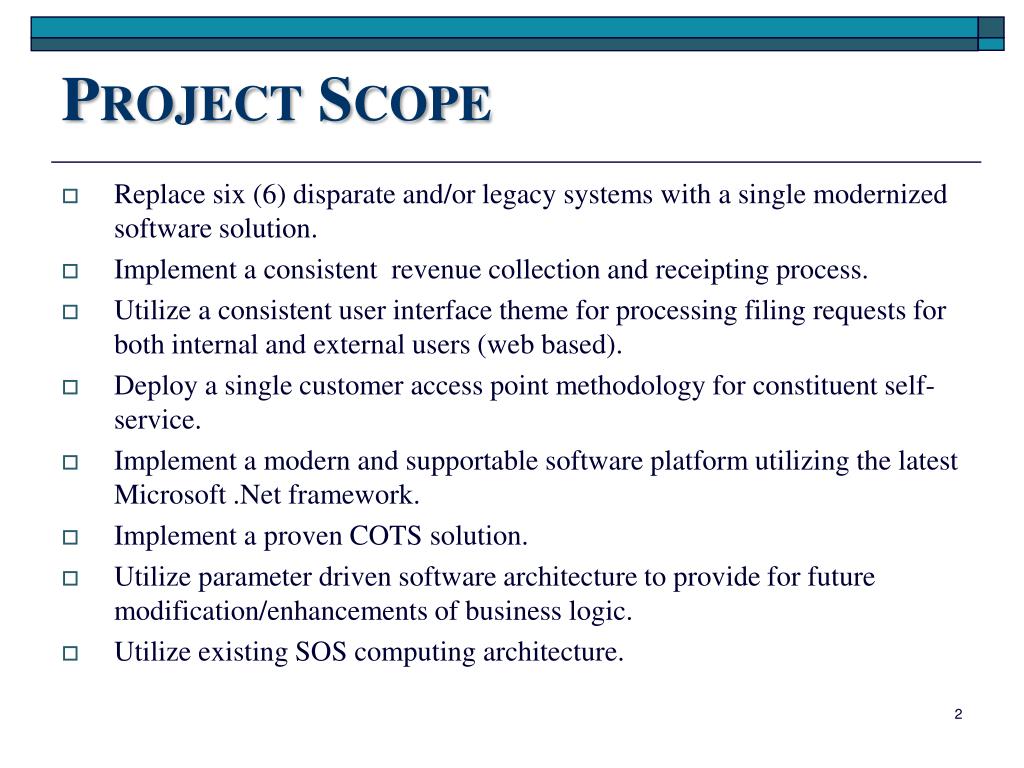

Project Scope • Replace six (6) disparate and/or legacy systems with a single modernized software solution. • Implement a consistent revenue collection and receipting process. • Utilize a consistent user interface theme for processing filing requests for both internal and external users (web based). • Deploy a single customer access point methodology for constituent self-service. • Implement a modern and supportable software platform utilizing the latest Microsoft .Netframework. • Implement a proven COTS solution. • Utilize parameter driven software architecture to provide for future modification/enhancements of business logic. • Utilize existing SOS computing architecture.

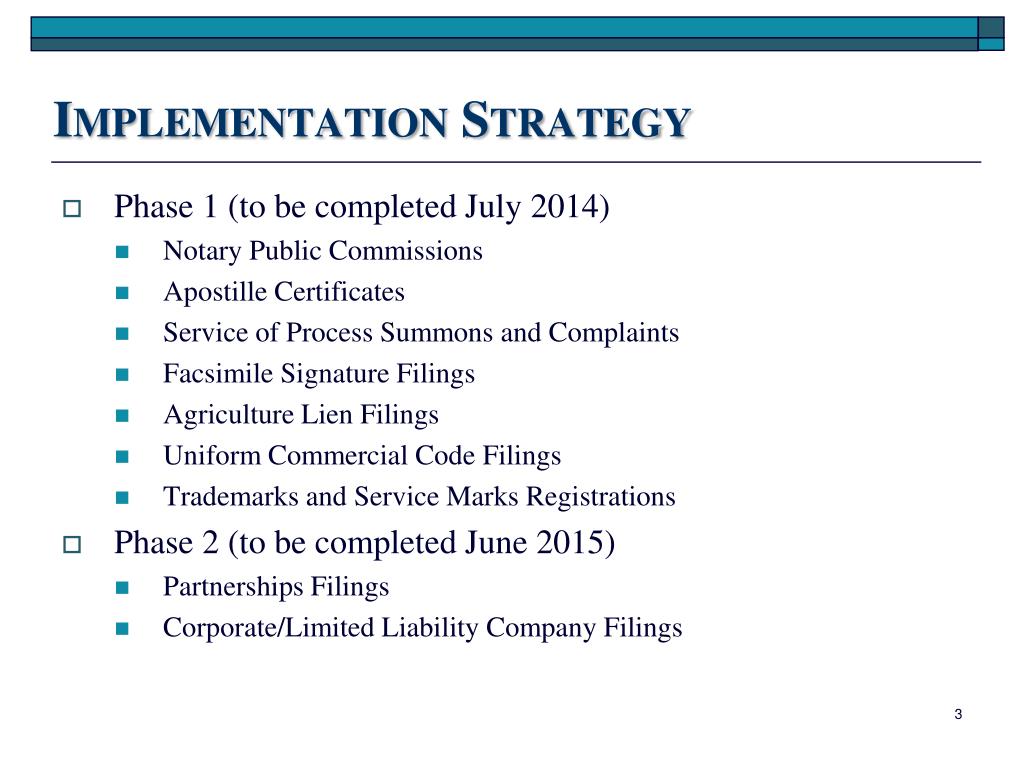

Implementation Strategy • Phase 1 (to be completed July 2014) • Notary Public Commissions • ApostilleCertificates • Service of Process Summons and Complaints • Facsimile Signature Filings • Agriculture Lien Filings • Uniform Commercial Code Filings • Trademarks and Service Marks Registrations • Phase 2 (to be completed June 2015) • Partnerships Filings • Corporate/Limited Liability Company Filings

Certification History Total Project Appropriation • Funding Source – Laws 2013, Chapter 227, Section 7 (10) • Amount - $1,215,000 • Funding Source – Laws 2014, Chapter 63, Section 4 • Amount - $11,000 • Project Initiation & Planning – May 23, 2013 • Amount - $215,000 • Project Implementation Phase 1 – December 2013 • Amount - $861,000 • Project Implementation Phase 2 – June 2014 (Current Request) • Amount - $150,000

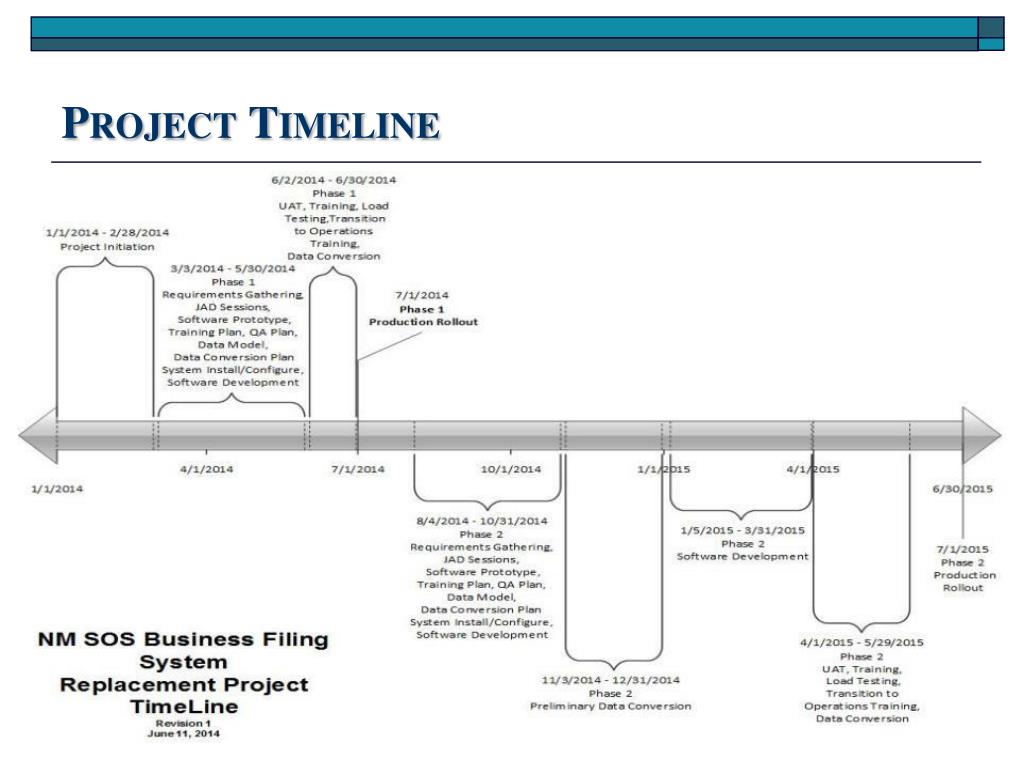

Major Deliverables & ScheduleProject Implementation Phase 1:

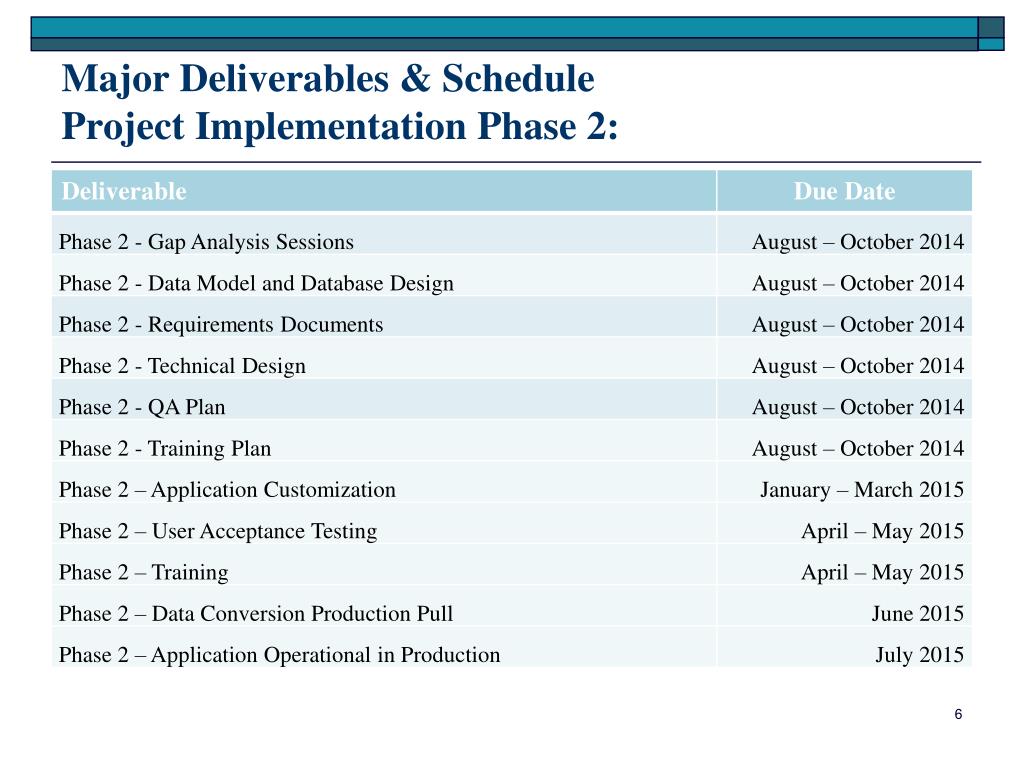

Major Deliverables & ScheduleProject Implementation Phase 2:
Project Accomplishments • SOS & PRC Corporations “As-Is” and “To Be” Documents completed February/April 2013: • RFP Development – May/June 2013 • RFP Award – November/December 2013 • IV&V Contract Established – October 2013 • Software Security Assessment – May/June 2014 • Phase 1 Implementation – July 2014

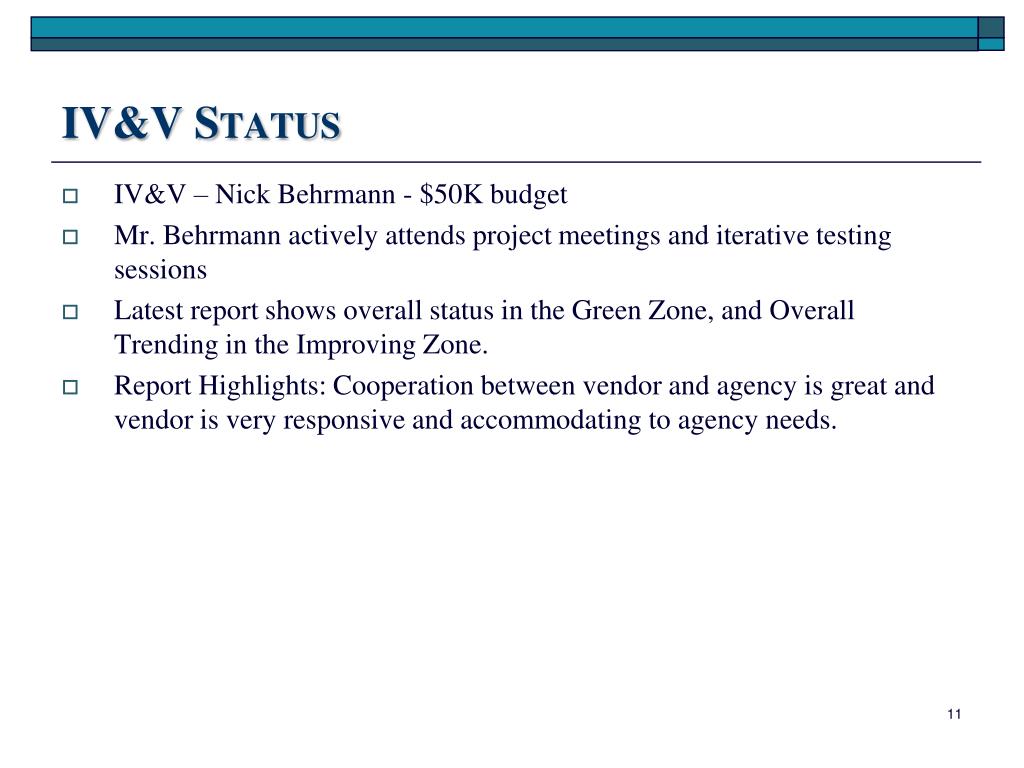

IV&V Status • IV&V – Nick Behrmann - $50K budget • Mr. Behrmann actively attends project meetings and iterative testing sessions • Latest report shows overall status in the Green Zone, and Overall Trending in the Improving Zone. • Report Highlights: Cooperation between vendor and agency is great and vendor is very responsive and accommodating to agency needs.
