  1. ITCC CougarNet Briefing Dennis Fouty, Ph.D. Associate Vice Chancellor, University of Houston System Associate Vice President, University of Houston Mary Dickerson, MCSE CougarNet Project Manager February 28, 2003

  2. Agenda • Overview • UH Windows Environment • CougarNet • Project Status

  3. What is CougarNet? • Name for UH Active Directory domain • Formerly: Windows 2000 Project, Active Directory Project • Project name change to CougarNet • Active Directory – Infrastructure architecture by Microsoft for enterprise environments

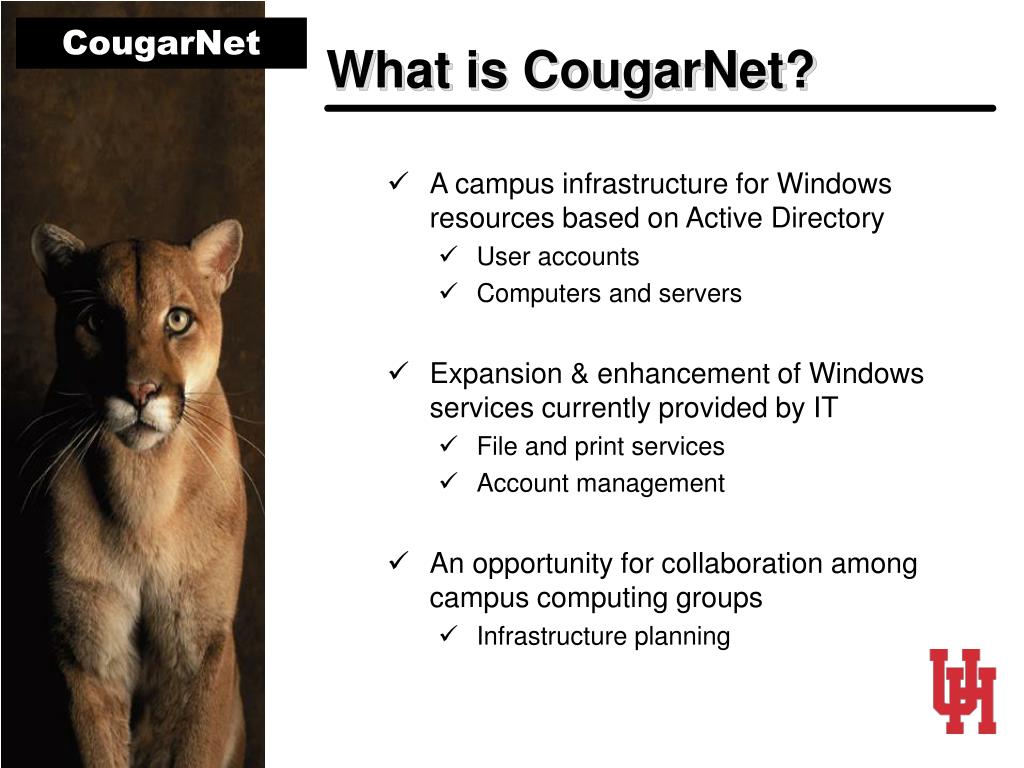

  4. What is CougarNet? • A campus infrastructure for Windows resources based on Active Directory • User accounts • Computers and servers • Expansion & enhancement of Windows services currently provided by IT • File and print services • Account management • An opportunity for collaboration among campus computing groups • Infrastructure planning

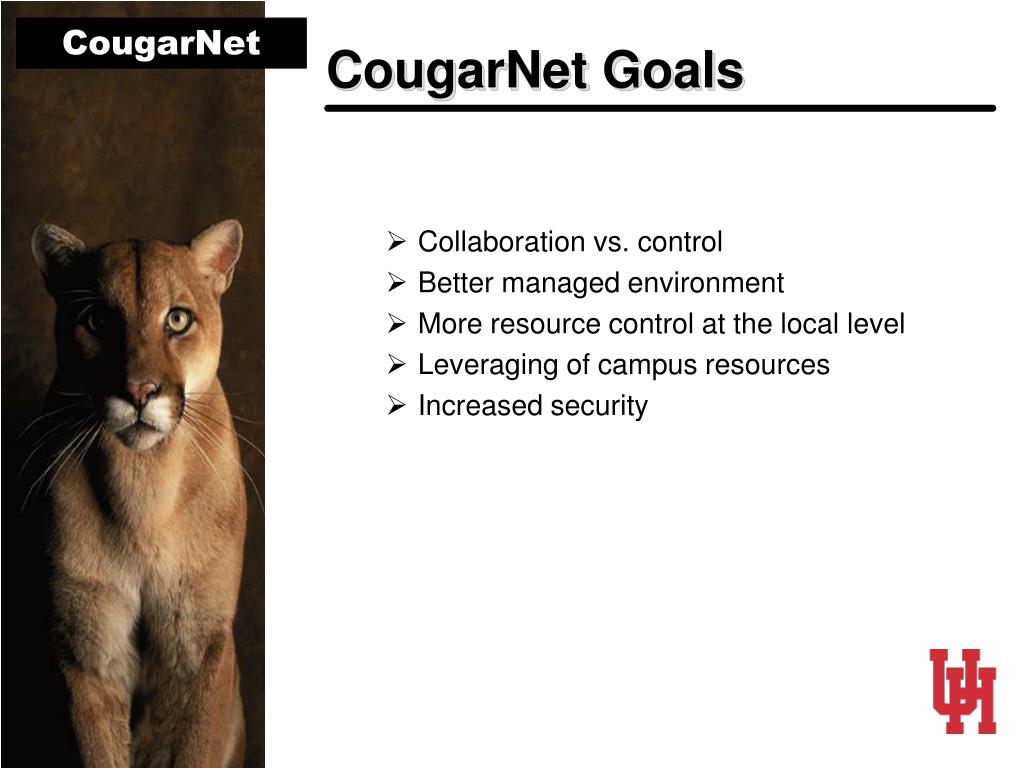

  5. CougarNet Goals • Collaboration vs. control • Better managed environment • More resource control at the local level • Leveraging of campus resources • Increased security

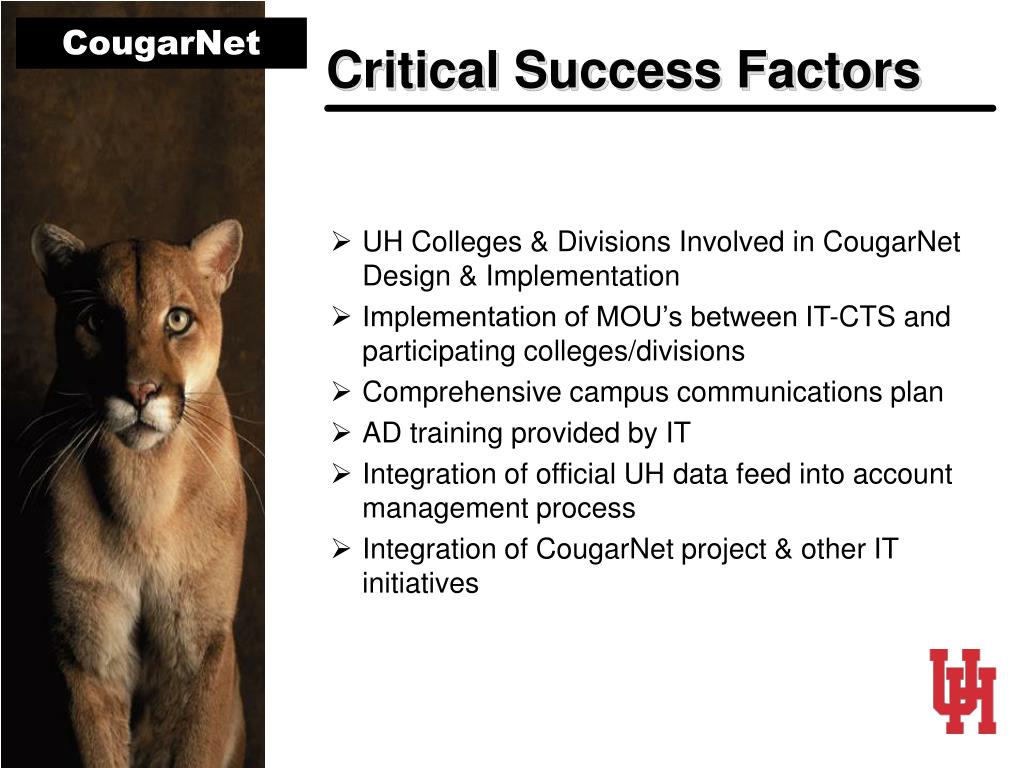

  6. Critical Success Factors • UH Colleges & Divisions Involved in CougarNet Design & Implementation • Implementation of MOU’s between IT-CTS and participating colleges/divisions • Comprehensive campus communications plan • AD training provided by IT • Integration of official UH data feed into account management process • Integration of CougarNet project & other IT initiatives

  7. CougarNet: A Well Planned Effort • Within IT • Representatives from all departments • Dedicated test lab environment • Within Campus – Windows Infrastructure Planning Team • Appointed representatives-Colleges & Divisions • Communication plans for campus • Among Enterprise Vendors • Microsoft • HP/Compaq • Quest Software • Lucent Consulting • Project Recognized by Microsoft • Presentation by Chuck Shomper at MS Higher Ed CIO Summit, Redmond WA • Presentations by Project Team at multiple MS Workshops

  8. Project Milestones 1998 Domain restructuring project - cancelled 1999 November – IT Win2K Project Team Formed 2000 February – Windows 2000 AD software available April – Executive Briefing for IT Management May – Test Lab Established in Computing Center November – Campus Workshops by Project Team

  9. Project Milestones 2001 February – Project Team expanded to include College/Division representatives April – First meeting of campus-wide Windows Infrastructure Planning Team 2002 January – Implementation of “CougarNet” AD March – Project timeline defined with campus reps. June – UH System AD issues defined for CIOs September – CougarNet MOU draft reviewed with campus representatives November – CougarNet MOU distributed for signature October – December – Meetings w/campus groups re: CougarNet

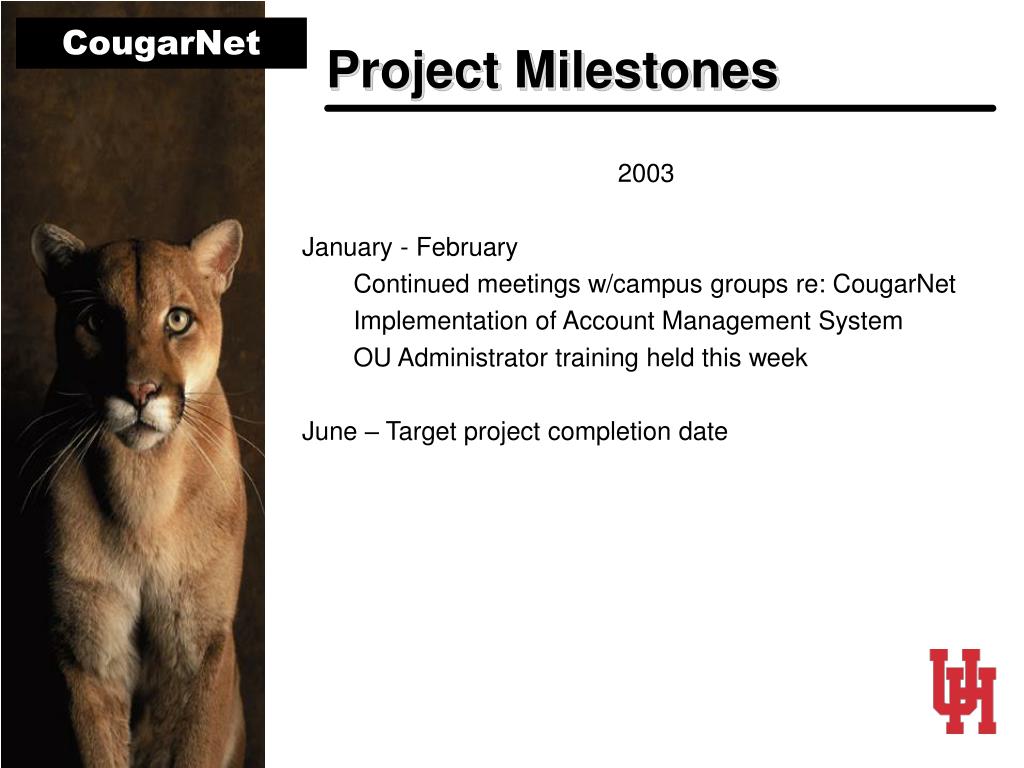

  10. Project Milestones 2003 January - February Continued meetings w/campus groups re: CougarNet Implementation of Account Management System OU Administrator training held this week June – Target project completion date

  11. UH Windows Infrastructure • Current Windows NT environment • Why Active Directory? • AD Implementation at UH • Project Lifecycle • CougarNet Infrastructure • ER.UH.EDU (Empty Root Domain) • Cougarnet.UH.EDU (Account Domain) • Top-level OU’s – Colleges/Divisions

  12. Windows 2000

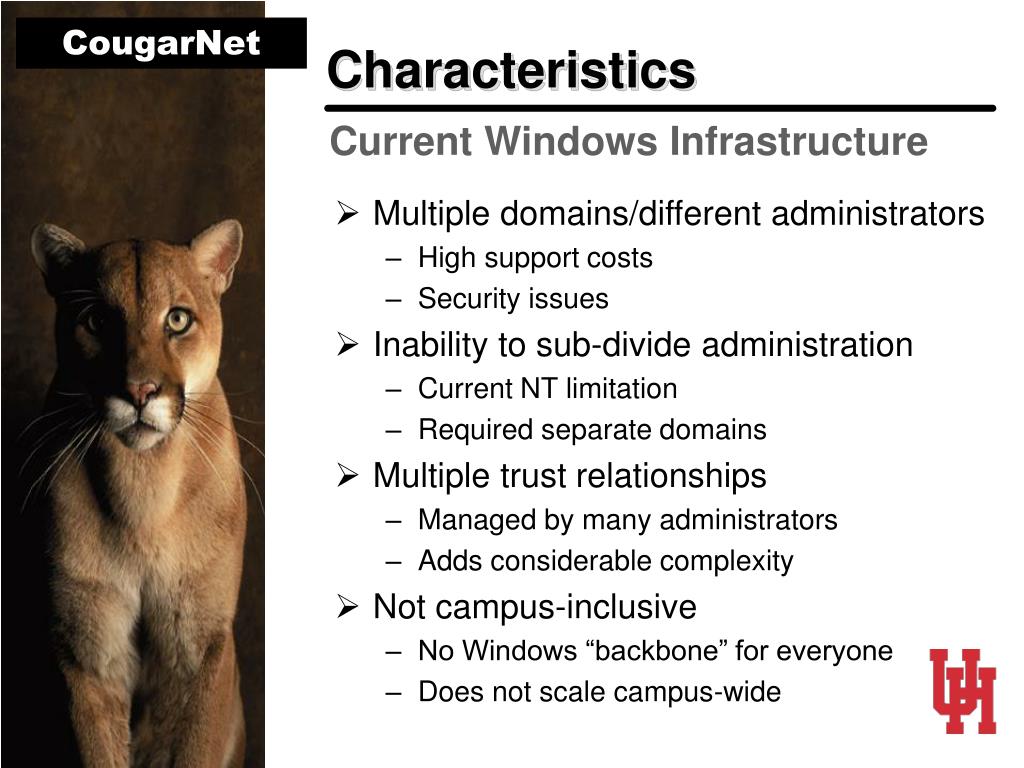

  13. Characteristics Current Windows Infrastructure • Multiple domains/different administrators • High support costs • Security issues • Inability to sub-divide administration • Current NT limitation • Required separate domains • Multiple trust relationships • Managed by many administrators • Adds considerable complexity • Not campus-inclusive • No Windows “backbone” for everyone • Does not scale campus-wide

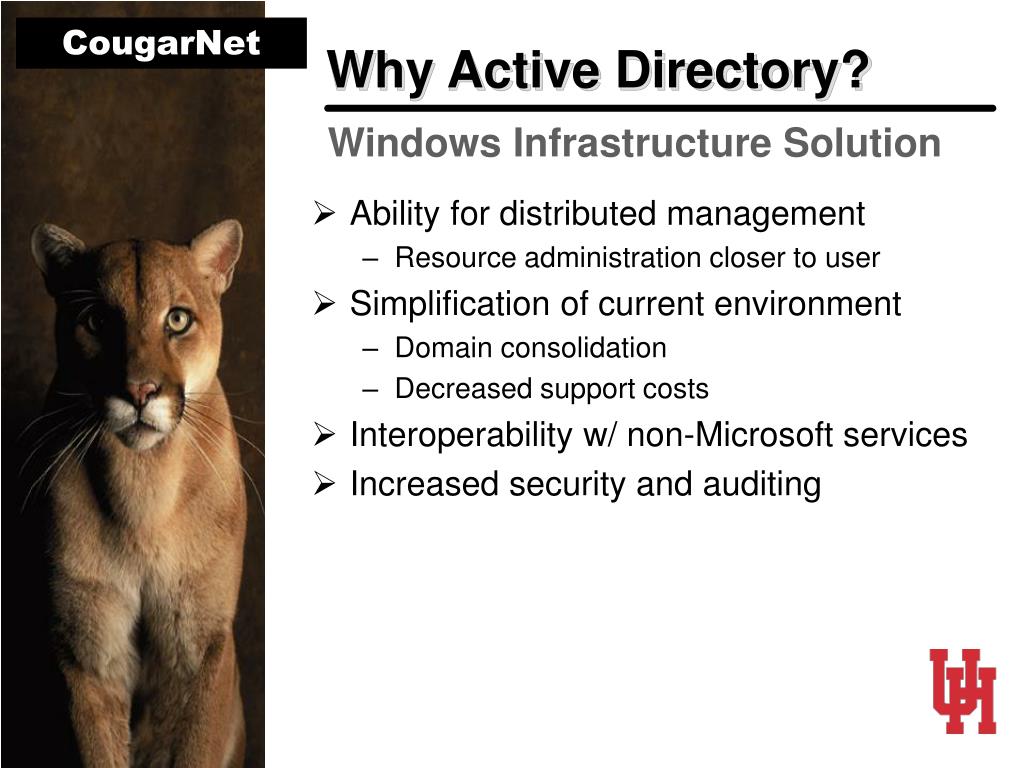

  14. Why Active Directory? Windows Infrastructure Solution • Ability for distributed management • Resource administration closer to user • Simplification of current environment • Domain consolidation • Decreased support costs • Interoperability w/ non-Microsoft services • Increased security and auditing

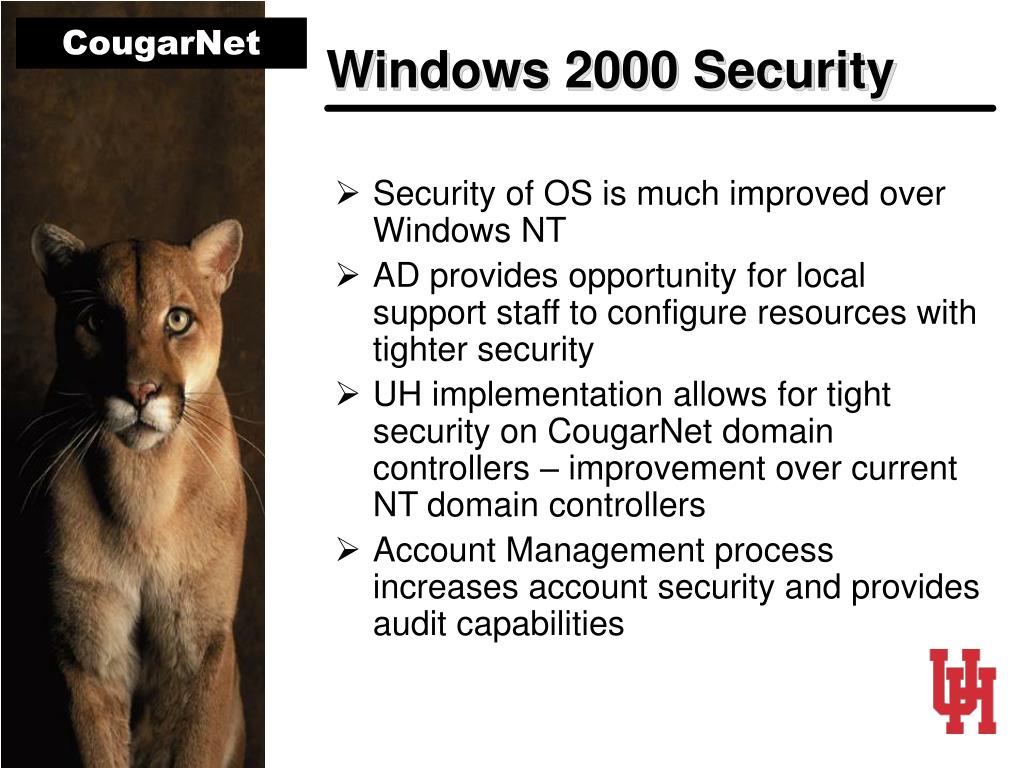

  15. Windows 2000 Security • Security of OS is much improved over Windows NT • AD provides opportunity for local support staff to configure resources with tighter security • UH implementation allows for tight security on CougarNet domain controllers – improvement over current NT domain controllers • Account Management process increases account security and provides audit capabilities

  16. AD Implementation at UH • IT Windows 2000 Project Team • Identified key deployment issues • IT Executive Briefing–decision to implement AD • Provided foundation for support & communications • Representatives appointed by colleges/divisions • Representative profile created • Infrastructure Requirements • Interoperability with existing network services • Collaboration with PeopleSoft implementation • Use of existing staff and resources

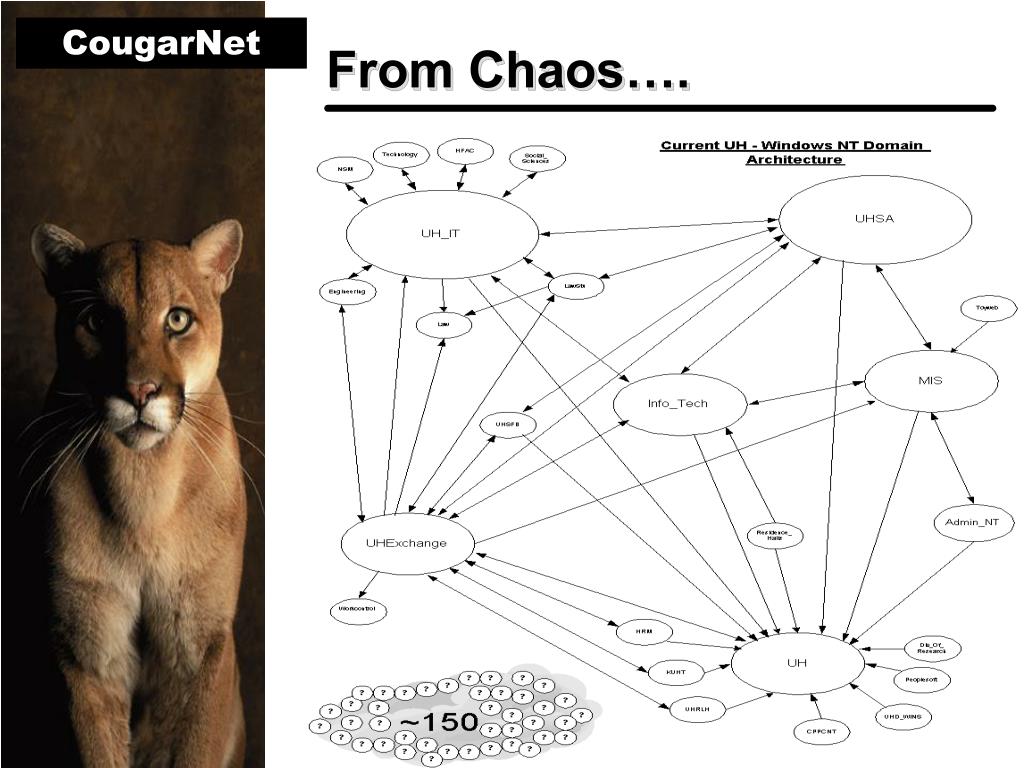

  17. From Chaos….

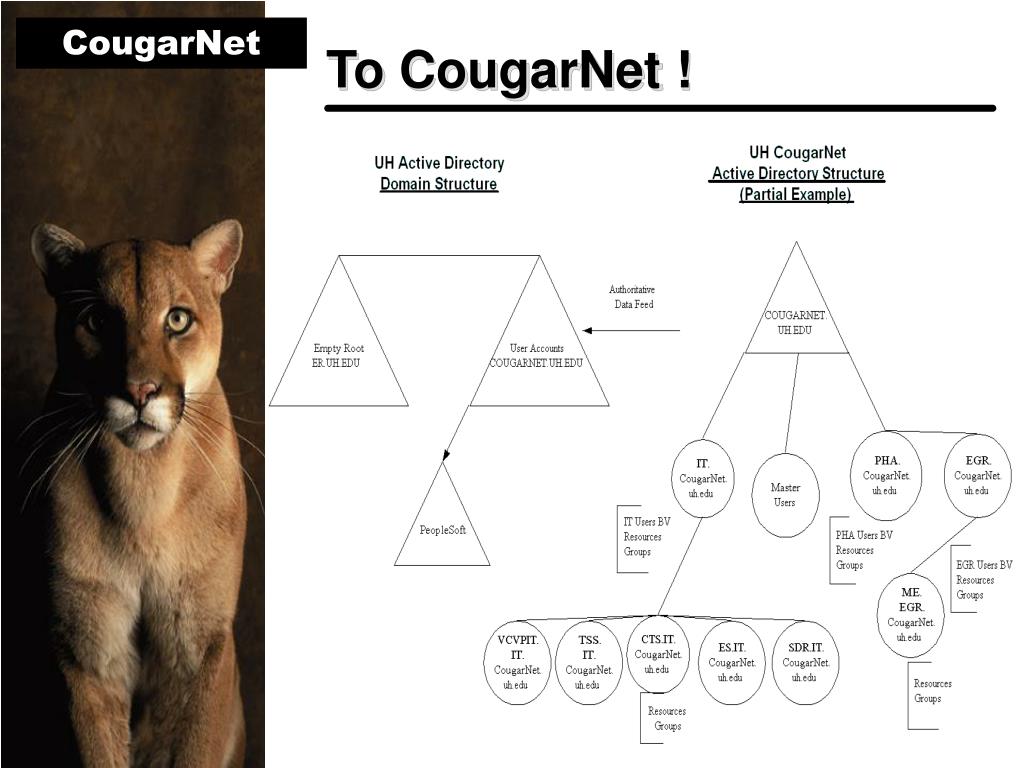

  18. To CougarNet !

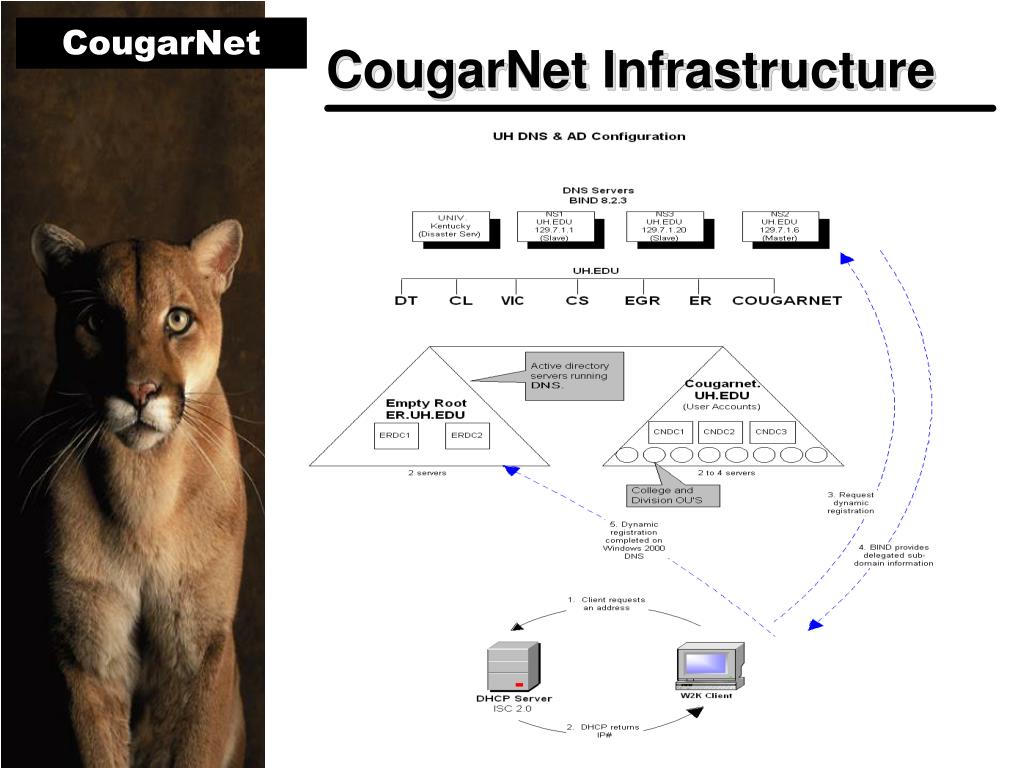

  19. CougarNet Infrastructure

  20. CougarNet Infrastructure

  21. Example 1: College Implementation • Pharmacy Division OU - PHA • No sub-OUs • All computers and groups managed by same support staff

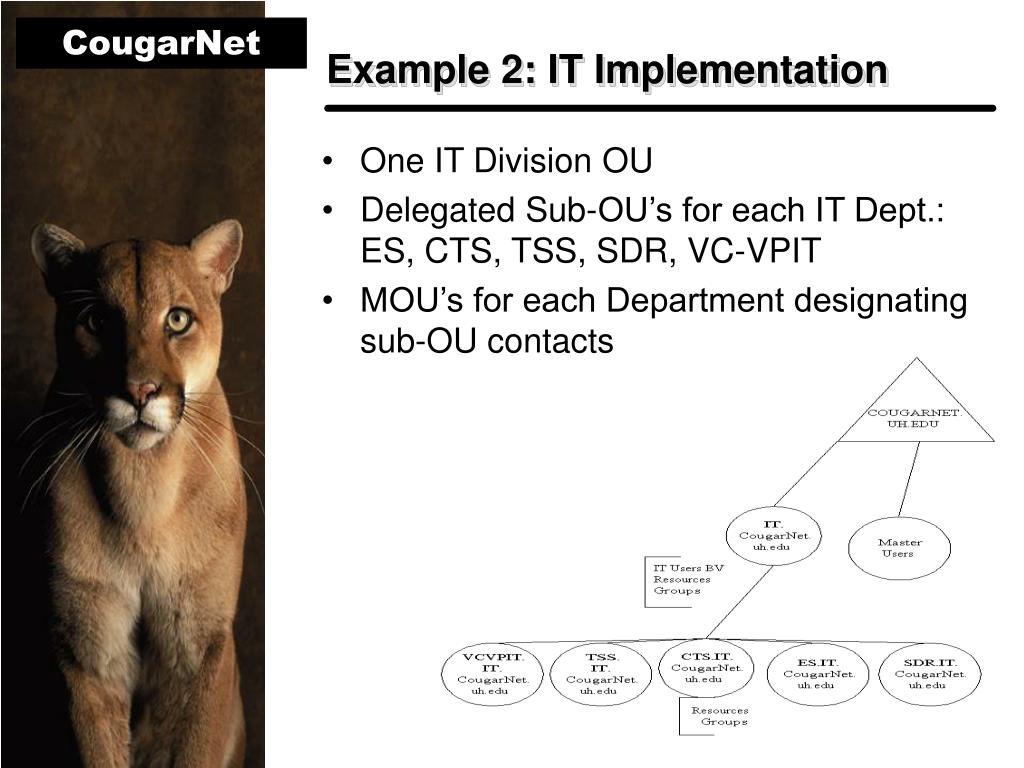

  22. Example 2: IT Implementation • One IT Division OU • Delegated Sub-OU’s for each IT Dept.: ES, CTS, TSS, SDR, VC-VPIT • MOU’s for each Department designating sub-OU contacts

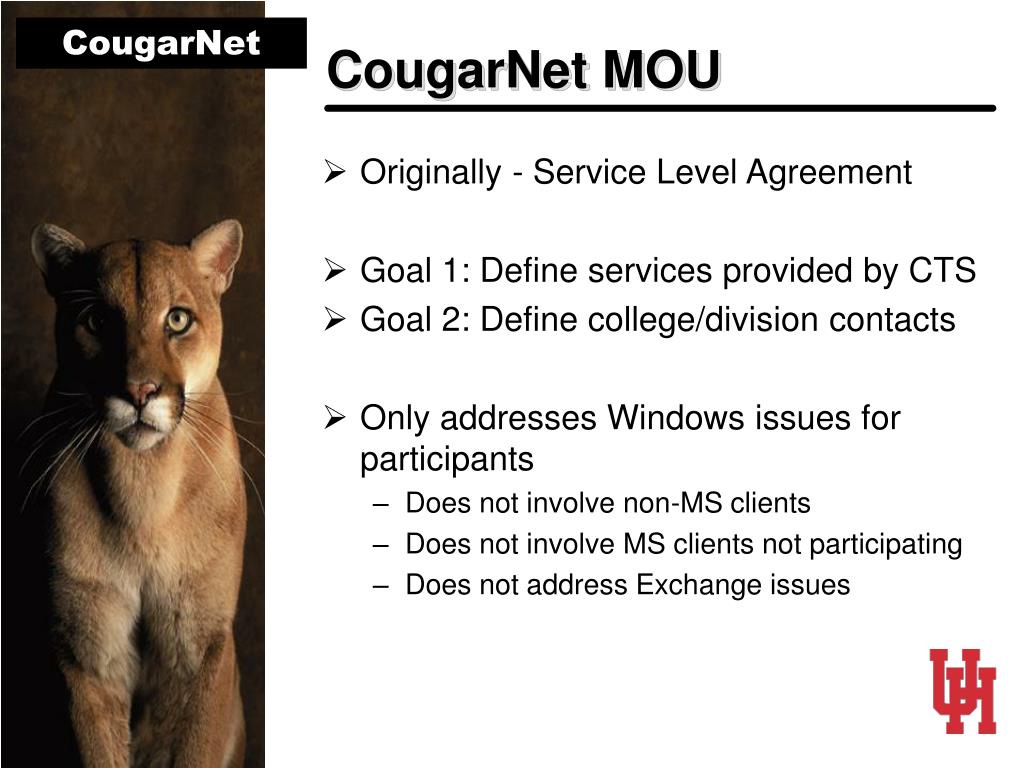

  23. CougarNet MOU • Originally - Service Level Agreement • Goal 1: Define services provided by CTS • Goal 2: Define college/division contacts • Only addresses Windows issues for participants • Does not involve non-MS clients • Does not involve MS clients not participating • Does not address Exchange issues

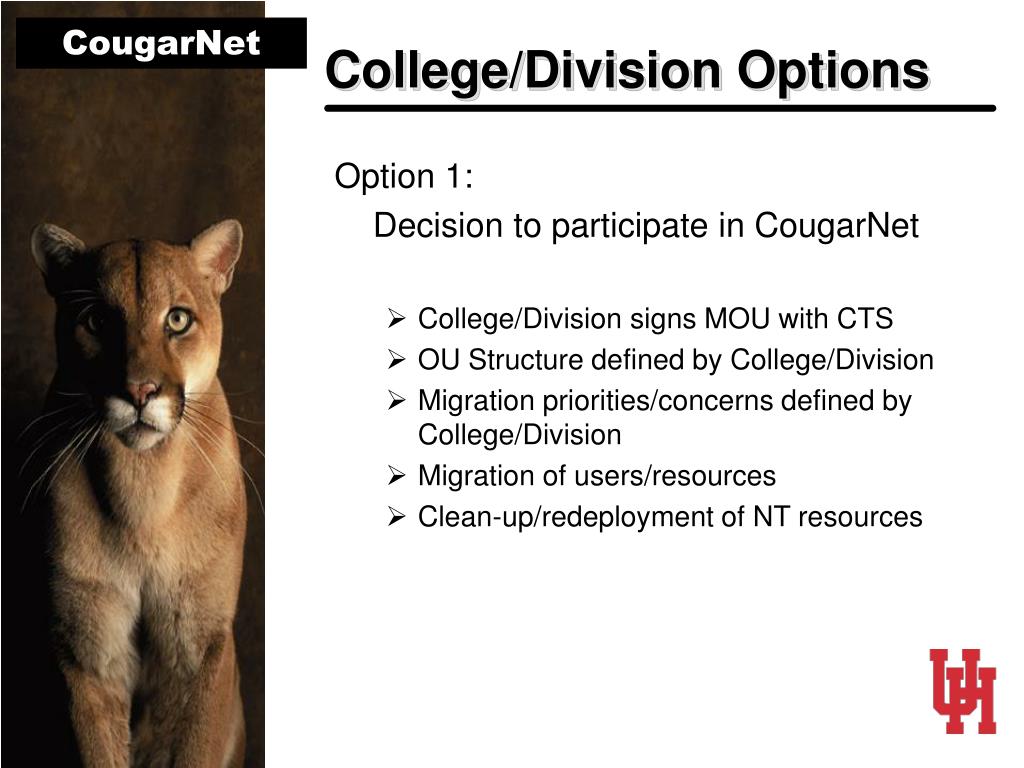

  24. College/Division Options Option 1: Decision to participate in CougarNet • College/Division signs MOU with CTS • OU Structure defined by College/Division • Migration priorities/concerns defined by College/Division • Migration of users/resources • Clean-up/redeployment of NT resources

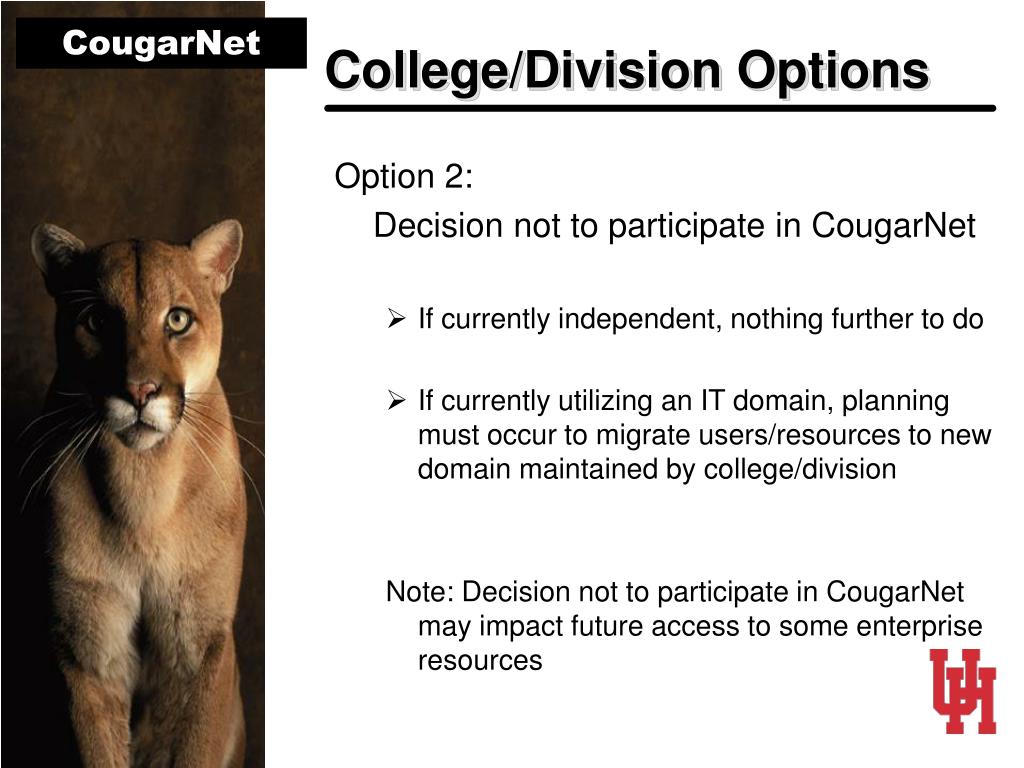

  25. College/Division Options Option 2: Decision not to participate in CougarNet • If currently independent, nothing further to do • If currently utilizing an IT domain, planning must occur to migrate users/resources to new domain maintained by college/division Note: Decision not to participate in CougarNet may impact future access to some enterprise resources

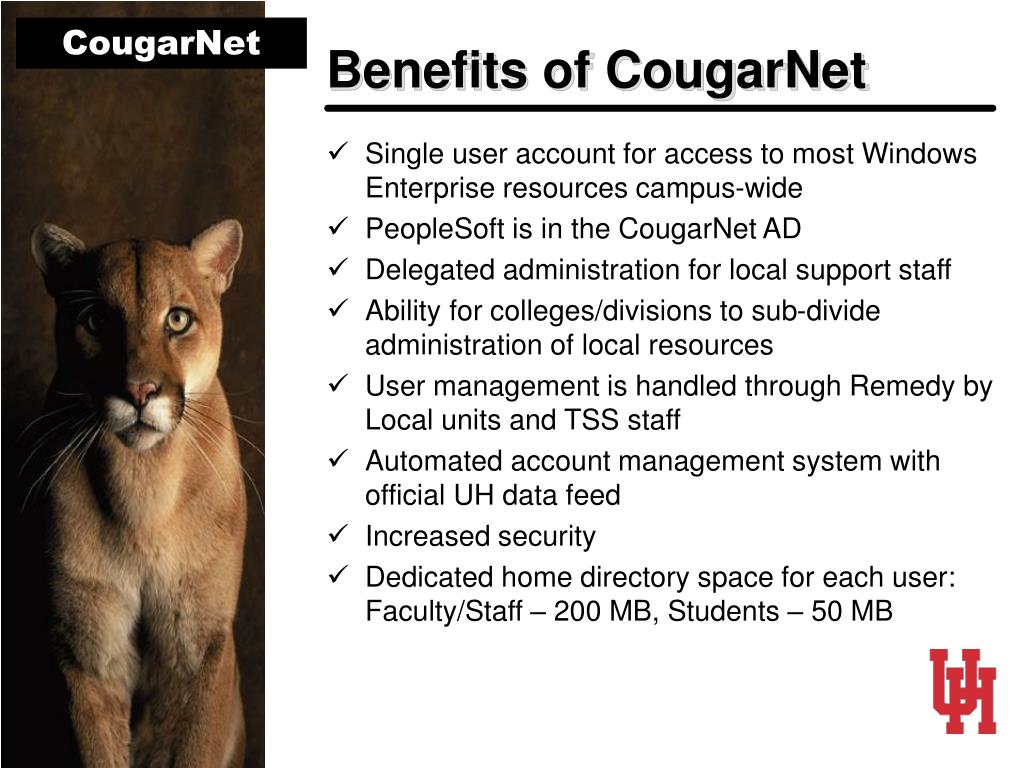

  26. Benefits of CougarNet • Single user account for access to most Windows Enterprise resources campus-wide • PeopleSoft is in the CougarNet AD • Delegated administration for local support staff • Ability for colleges/divisions to sub-divide administration of local resources • User management is handled through Remedy by Local units and TSS staff • Automated account management system with official UH data feed • Increased security • Dedicated home directory space for each user: Faculty/Staff – 200 MB, Students – 50 MB

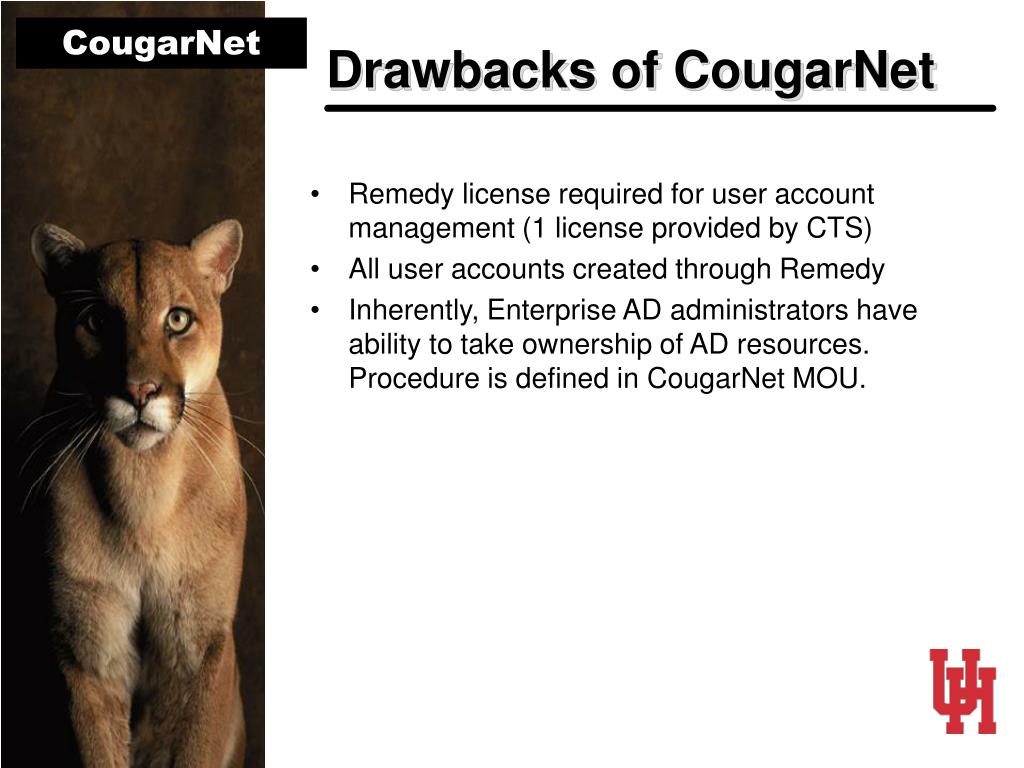

  27. Drawbacks of CougarNet • Remedy license required for user account management (1 license provided by CTS) • All user accounts created through Remedy • Inherently, Enterprise AD administrators have ability to take ownership of AD resources. Procedure is defined in CougarNet MOU.

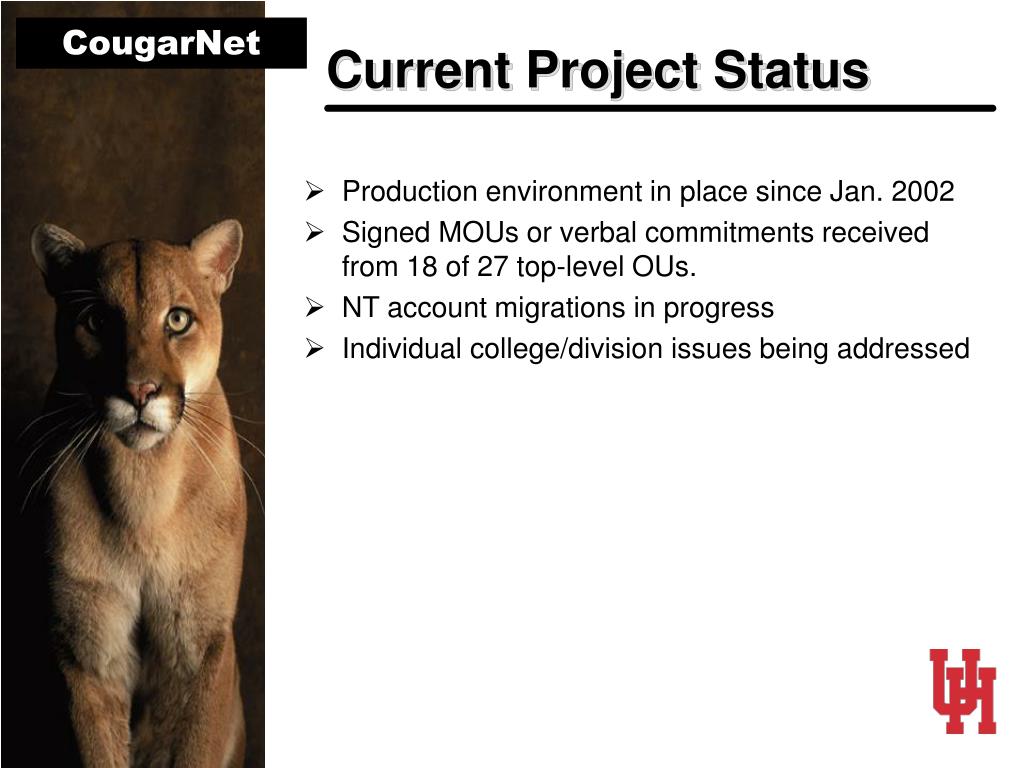

  28. Current Project Status • Production environment in place since Jan. 2002 • Signed MOUs or verbal commitments received from 18 of 27 top-level OUs. • NT account migrations in progress • Individual college/division issues being addressed

  29. Windows 2000 Project - CougarNet Web Site: http://www.uh.edu/cougarnet Email Address: Cougarnet@uh.edu Project Team Leader: Mary Dickerson, MCSE Email: MDickerson@uh.edu
