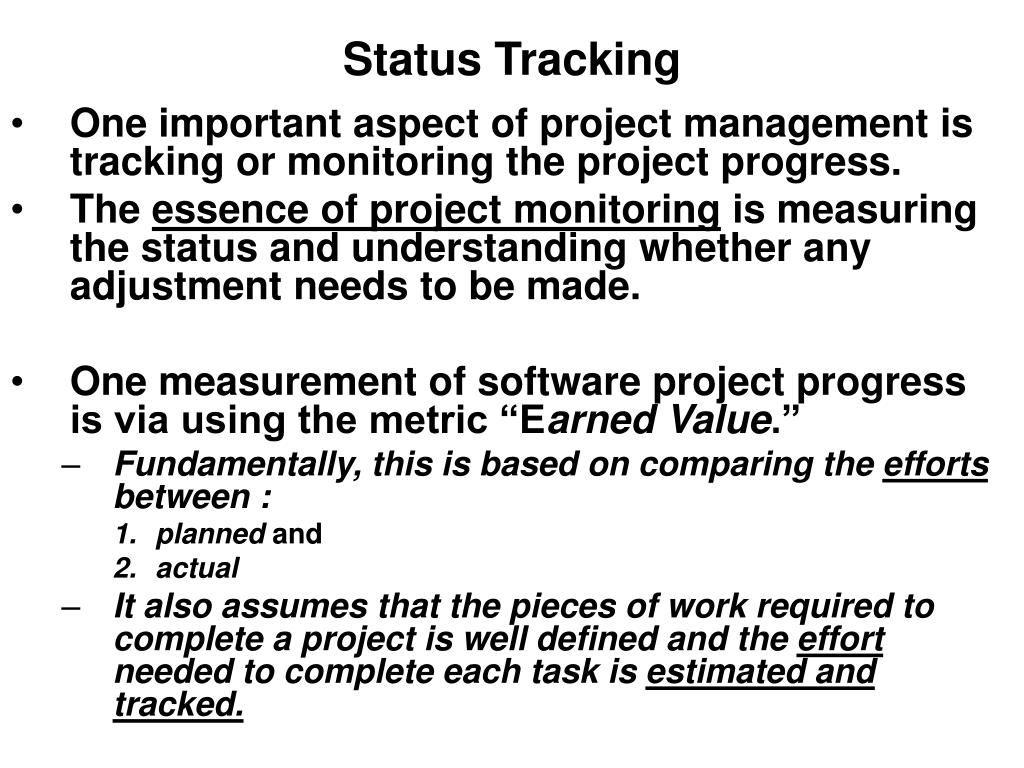

  1. Status Tracking • One important aspect of project management is tracking or monitoring the project progress. • The essence of project monitoring is measuring the status and understanding whether any adjustment needs to be made. • One measurement of software project progress is via using the metric “Earned Value.” • Fundamentally, this is based on comparing the efforts between : • planned and • actual • It also assumes that the pieces of work required to complete a project is well defined and the effort needed to complete each task is estimated and tracked.

  2. Some Definitions • Some Basic Definitions: • Budgeted cost of Work (BCW): the estimated effort for each work task • Budgeted Cost of Work Scheduled (BCWS) : the sum of the estimated effort for all the tasks that were scheduled to be completed by the specified time (sum of BCW’s that were scheduled to be completed by that date). • Budget at Completion (BAC): the estimate of the total project effort or the total of all the BCWs • Planned Value (PV) : the percentage of the total estimated effort that is assigned to the particular task, j, or (BCW of j)/ BAC • Budgeted Cost of Work Performed (BCWP): the sum of the estimated effort of the tasks that have beencompleted by the specified time. • Actual Cost of Work Performed (ACWP): the sum of the actualefforts expended for the tasks that have been completed

  3. Example note Date : 4/5/2004 Actual Effort spent so far in Pers-days Estimated Effort in Pers-days Estimated Completion date Actual Completion date Work Tasks 10 10 2/5/04 1 2/5/04 2 25 3/15/04 3/25/04 15 3 1 30 15 4/25/04 4 5/5/04 4/1/04 25 20 5 5 5/25/04 15 6/10/04 20 15 6 Each estimated effort is the BCW (e.g. for work task 3 it is 30 person days). BAC = 10+15+30+25+15+20 = 115 person-days BCWS (on 4/5/04 – tasks 1 and 2 were scheduled to be completed) = 10+15 = 25 person days BCWP (on 4/5/04 –tasks 1, 2, and 4 are completed) = 10 +15+25 = 50 person-days ACWP (on 4/5/04 – actual cost of tasks completed) = 10 + 25 + 20 = 55 person-days

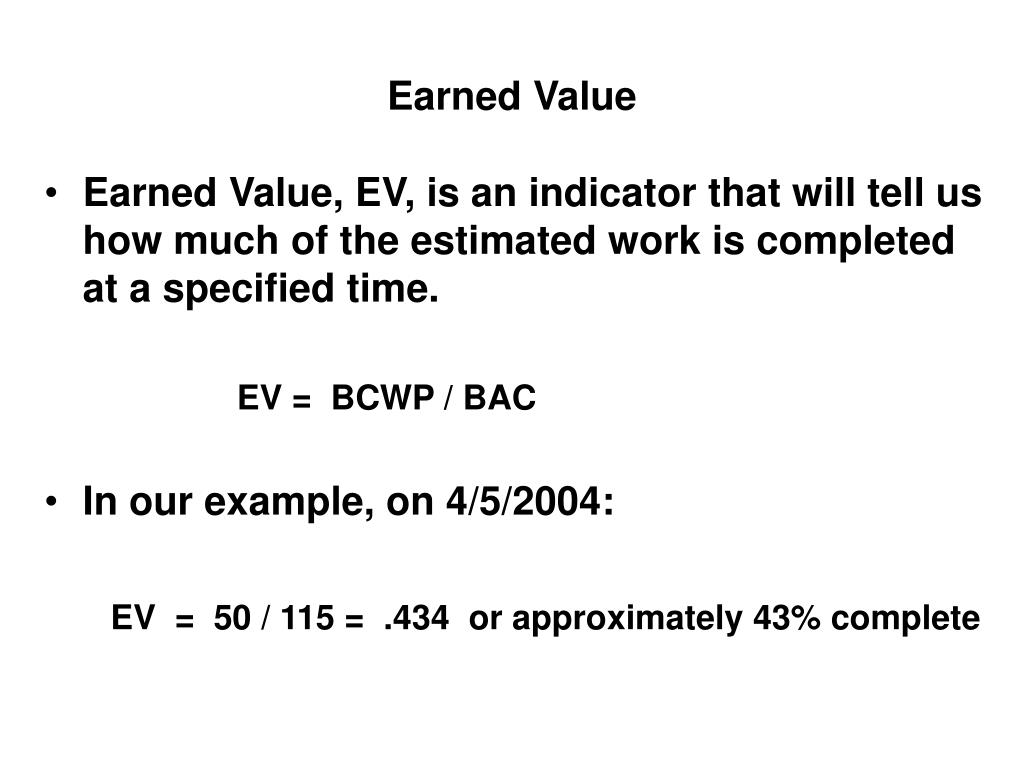

  4. Earned Value • Earned Value, EV, is an indicator that will tell us how much of the estimated work is completed at a specified time. EV = BCWP / BAC • In our example, on 4/5/2004: EV = 50 / 115 = .434 or approximately 43% complete

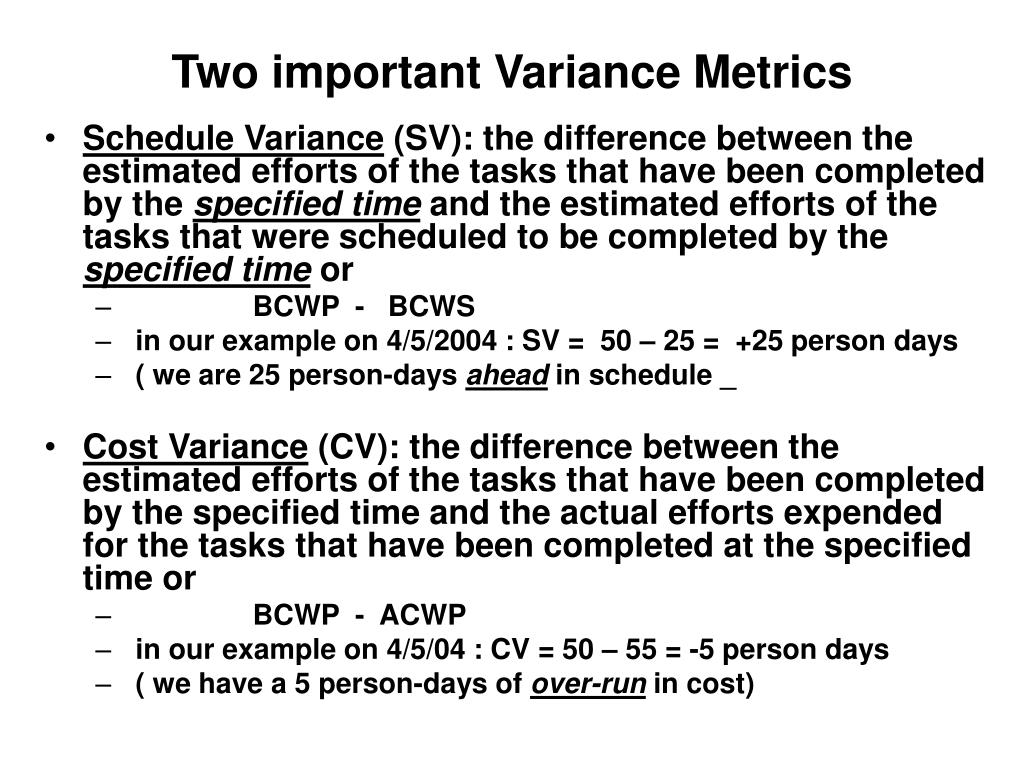

  5. Two important Variance Metrics • Schedule Variance (SV): the difference between the estimated efforts of the tasks that have been completed by the specified time and the estimated efforts of the tasks that were scheduled to be completed by the specified time or • BCWP - BCWS • in our example on 4/5/2004 : SV = 50 – 25 = +25 person days • ( we are 25 person-days ahead in schedule _ • Cost Variance (CV): the difference between the estimated efforts of the tasks that have been completed by the specified time and the actual efforts expended for the tasks that have been completed at the specified time or • BCWP - ACWP • in our example on 4/5/04 : CV = 50 – 55 = -5 person days • ( we have a 5 person-days of over-run in cost)

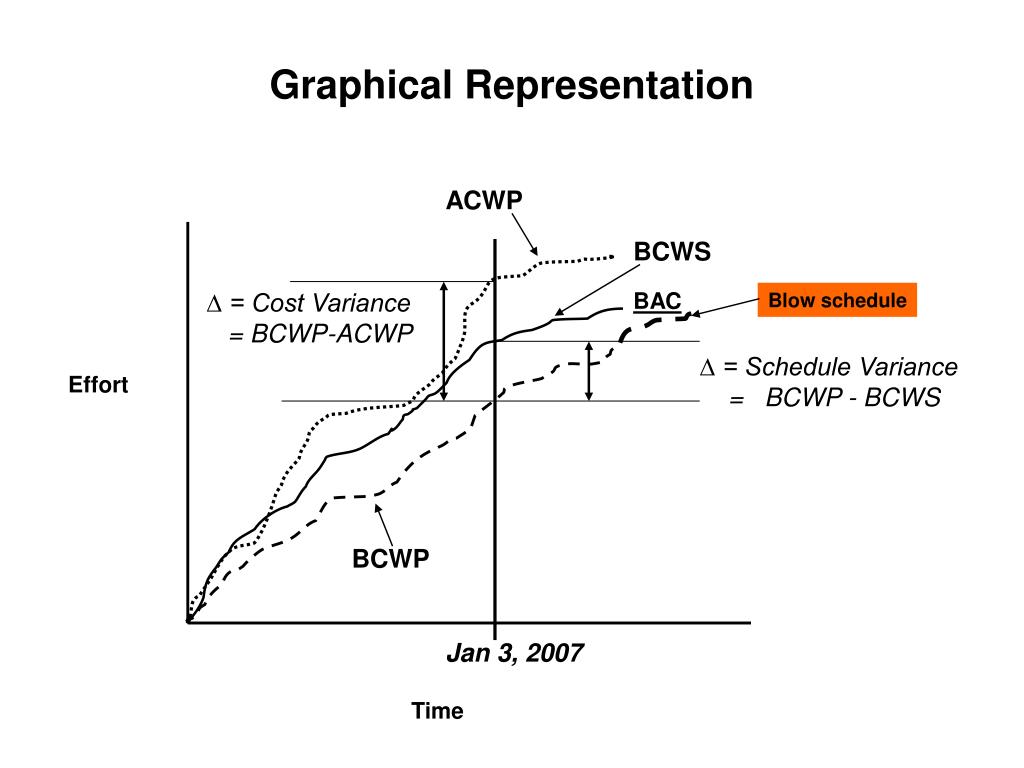

  6. Graphical Representation ACWP BCWS ∆ = Cost Variance = BCWP-ACWP BAC Blow schedule ∆ = Schedule Variance = BCWP - BCWS Effort BCWP Jan 3, 2007 Time

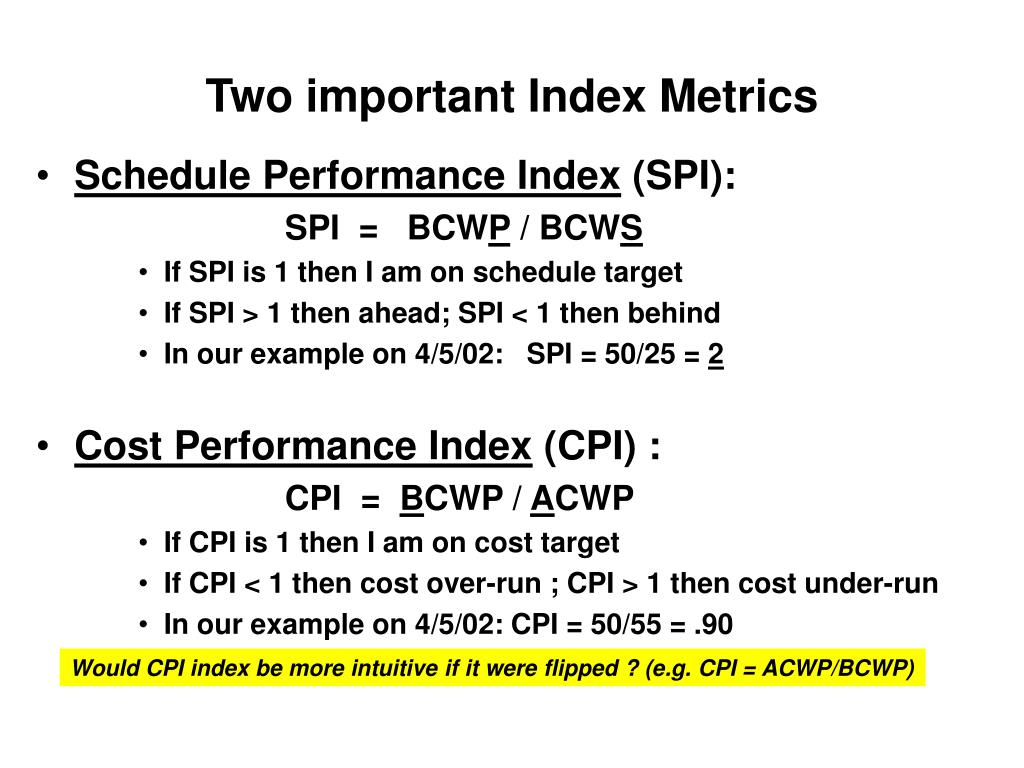

  7. Two important Index Metrics • Schedule Performance Index (SPI): SPI = BCWP / BCWS • If SPI is 1 then I am on schedule target • If SPI > 1 then ahead; SPI < 1 then behind • In our example on 4/5/02: SPI = 50/25 = 2 • Cost Performance Index (CPI) : CPI = BCWP / ACWP • If CPI is 1 then I am on cost target • If CPI < 1 then cost over-run ; CPI > 1 then cost under-run • In our example on 4/5/02: CPI = 50/55 = .90 Would CPI index be more intuitive if it were flipped ? (e.g. CPI = ACWP/BCWP)

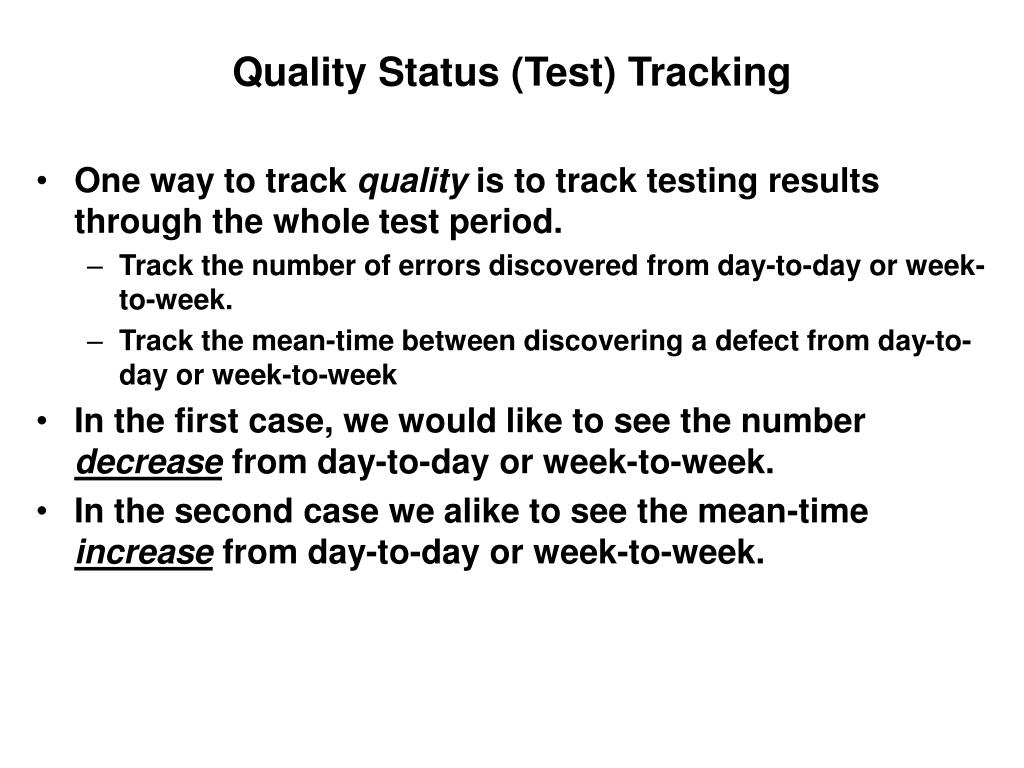

  8. Quality Status (Test) Tracking • One way to track quality is to track testing results through the whole test period. • Track the number of errors discovered from day-to-day or week-to-week. • Track the mean-time between discovering a defect from day-to-day or week-to-week • In the first case, we would like to see the number decrease from day-to-day or week-to-week. • In the second case we alike to see the mean-time increase from day-to-day or week-to-week.

  9. Defect Discovery Rate Tracking Desirable Curves Number of defect # of bugs discovered OR Mean-time to failure Mean-time between bug discovery week

  10. Possible Project post -mortem • Parameters to be considered : planned vs real • Project Size • Project Cost • Project Schedule • Project Quality • Project Process & Methodology • Project Tools • Other attributes
