HIFI from now through launch. Peter Roelfsema. HIFI project status. Main success HIFI delivered and integrated (except LO) various troubles, but it’s working Pieter New calibration manager; Michael Olberg HCSS remerge, pipeline progress Russ’ team
E N D
HIFI from now through launch Peter Roelfsema

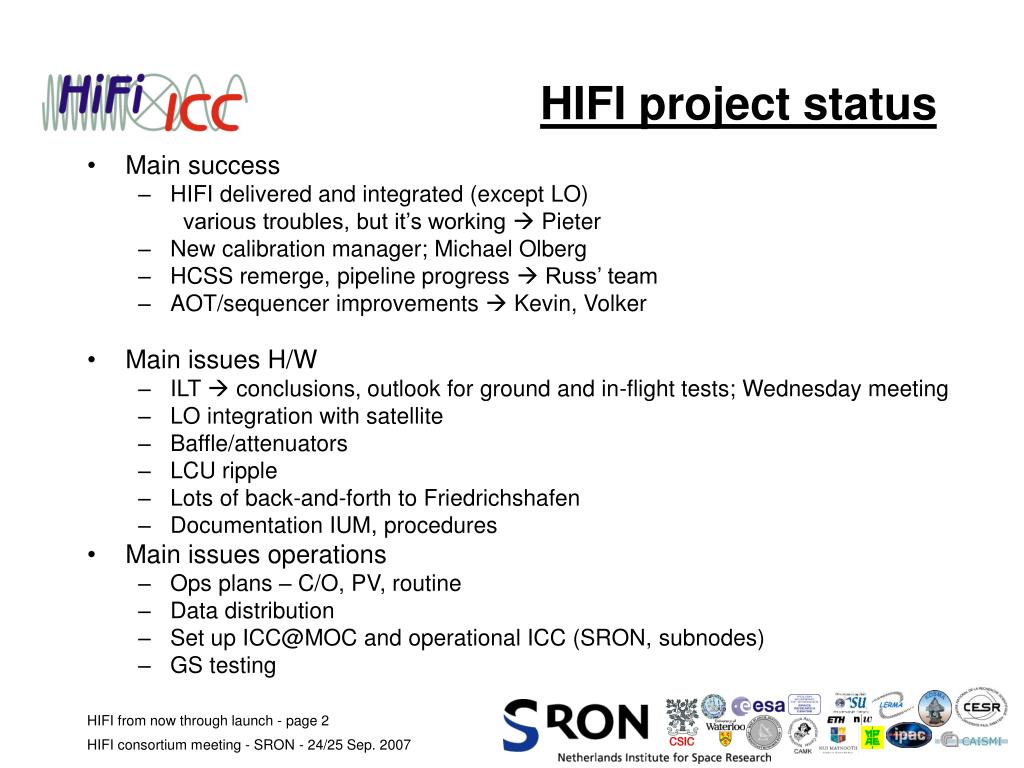

HIFI project status • Main success • HIFI delivered and integrated (except LO) various troubles, but it’s working Pieter • New calibration manager; Michael Olberg • HCSS remerge, pipeline progress Russ’ team • AOT/sequencer improvements Kevin, Volker • Main issues H/W • ILT conclusions, outlook for ground and in-flight tests; Wednesday meeting • LO integration with satellite • Baffle/attenuators • LCU ripple • Lots of back-and-forth to Friedrichshafen • Documentation IUM, procedures • Main issues operations • Ops plans – C/O, PV, routine • Data distribution • Set up ICC@MOC and operational ICC (SRON, subnodes) • GS testing HIFI from now through launch - page 2
HIFI organization HIFI reorganization • HIFI manager Peter Roelfsema • AIV manager Pieter Dieleman • Operations David Teyssier • Uplink Kevin Edwards/Pat Morris • Calibration manager Michael Olberg • GS test manager Albrecht de Jonge HIFI from now through launch - page 3
Groups and meetings • Management group – bi-weekly meetings • Peter, Nick, Pieter, Michael, Russ • System group – bi-weekly meetings • Nick, Pieter, Michael, Pat/Kevin, David, Russ, Albrecht, Thijs, Peter minutes to be published on WWW • Subgroups per area set up by leaders • Likely e.g. Downlink will have multiple (e.g. pipeline, infrastructure, IA etc.) minutes to be published on WWW • PA/QA • Herman for H/W and Do for GS issues • Need to go to stricter configuration control regular CCBs HIFI from now through launch - page 4
Upcoming activities • Activities • Finalise hardware integration • Satellite moves; January to ESTEC, late May to Kourou • Testing: • Satellite Integrated Satellite Test (includes Reference Mission Scenario) • System: System Validation Test, System Operations Validation Test • Ground segment: DP End-to-End tests, PV verification, simulations • Launch campaign • Operations phases • Check Out • Performance Verification • Reviews • Instrument User Manual – late October • PV review – November • ICC readiness review – early 2008, GSRR -2 months 1st March • Ground Segment Readiness review – L-3 months 1st May • Flight acceptance review HIFI from now through launch - page 5
Herschel schedule Update of 15 September • Launch 31 July • 1 month recovery need • …(very) success oriented HIFI from now through launch - page 6
Next consortium meeting • Tuesday/Wednesday 8/9 April - Groningen HIFI from now through launch - page 7
