An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript


  1. TILFORD EAST BRIDGE PROGRESS UPDATE 17TH MAY 2018

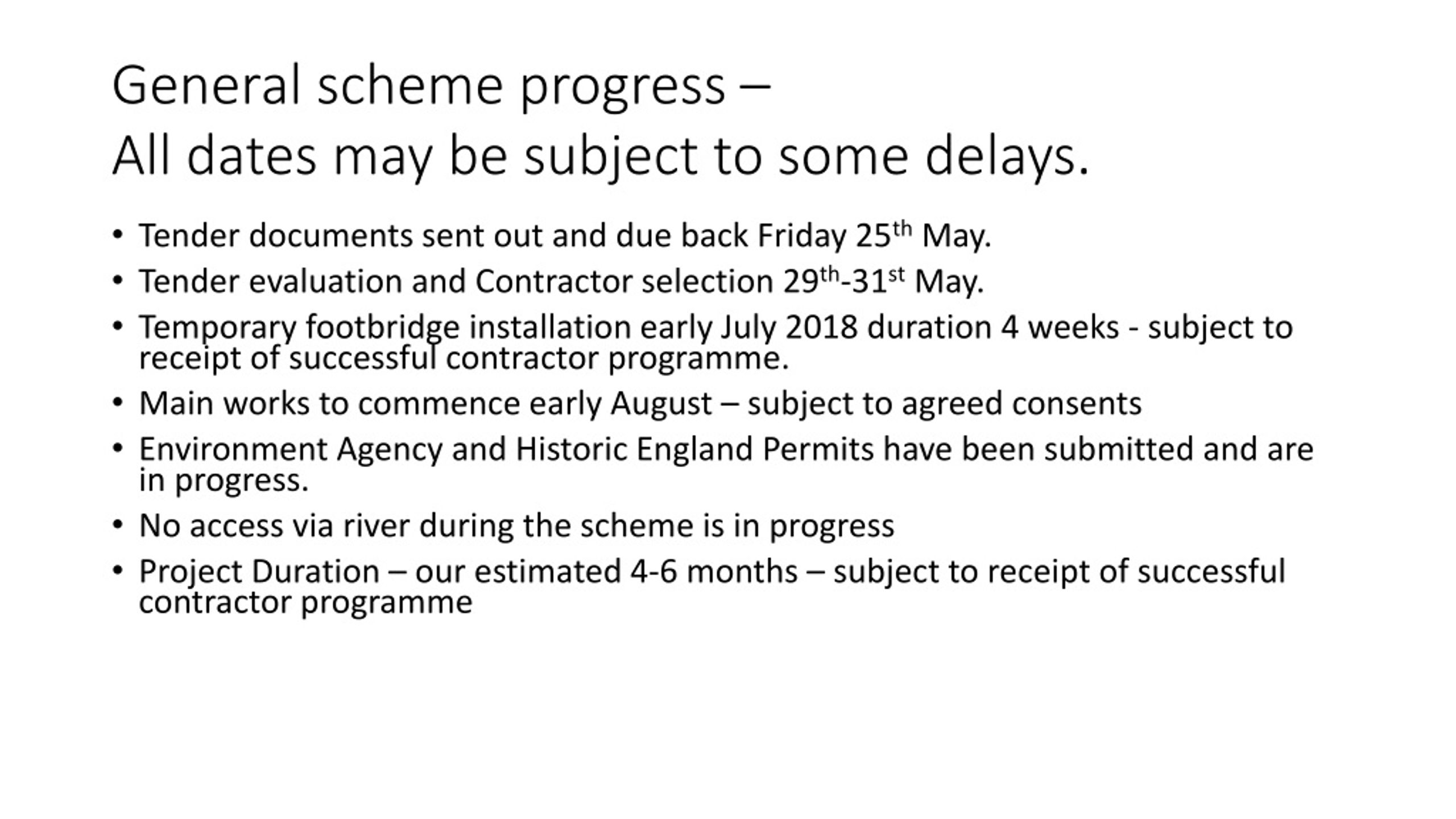

  2. General scheme progress – All dates may be subject to some delays. • Tender documents sent out and due back Friday 25th May. • Tender evaluation and Contractor selection 29th-31st May. • Temporary footbridge installation early July 2018 duration 4 weeks - subject to receipt of successful contractor programme. • Main works to commence early August – subject to agreed consents • Environment Agency and Historic England Permits have been submitted and are in progress. • No access via river during the scheme is in progress • Project Duration – our estimated 4-6 months – subject to receipt of successful contractor programme

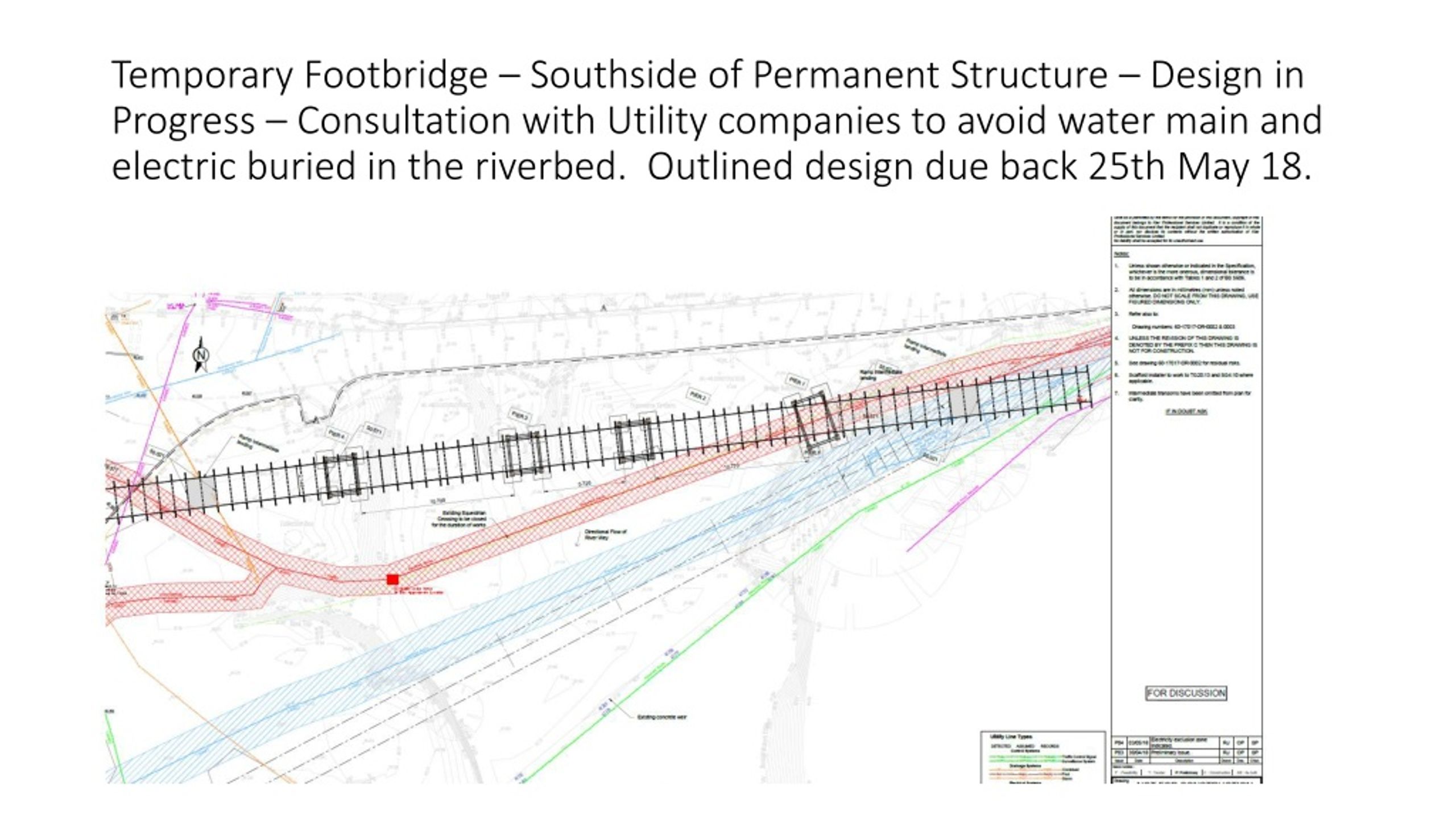

  3. Temporary Footbridge – Southside of Permanent Structure – Design in Progress – Consultation with Utility companies to avoid water main and electric buried in the riverbed. Outlined design due back 25th May 18.

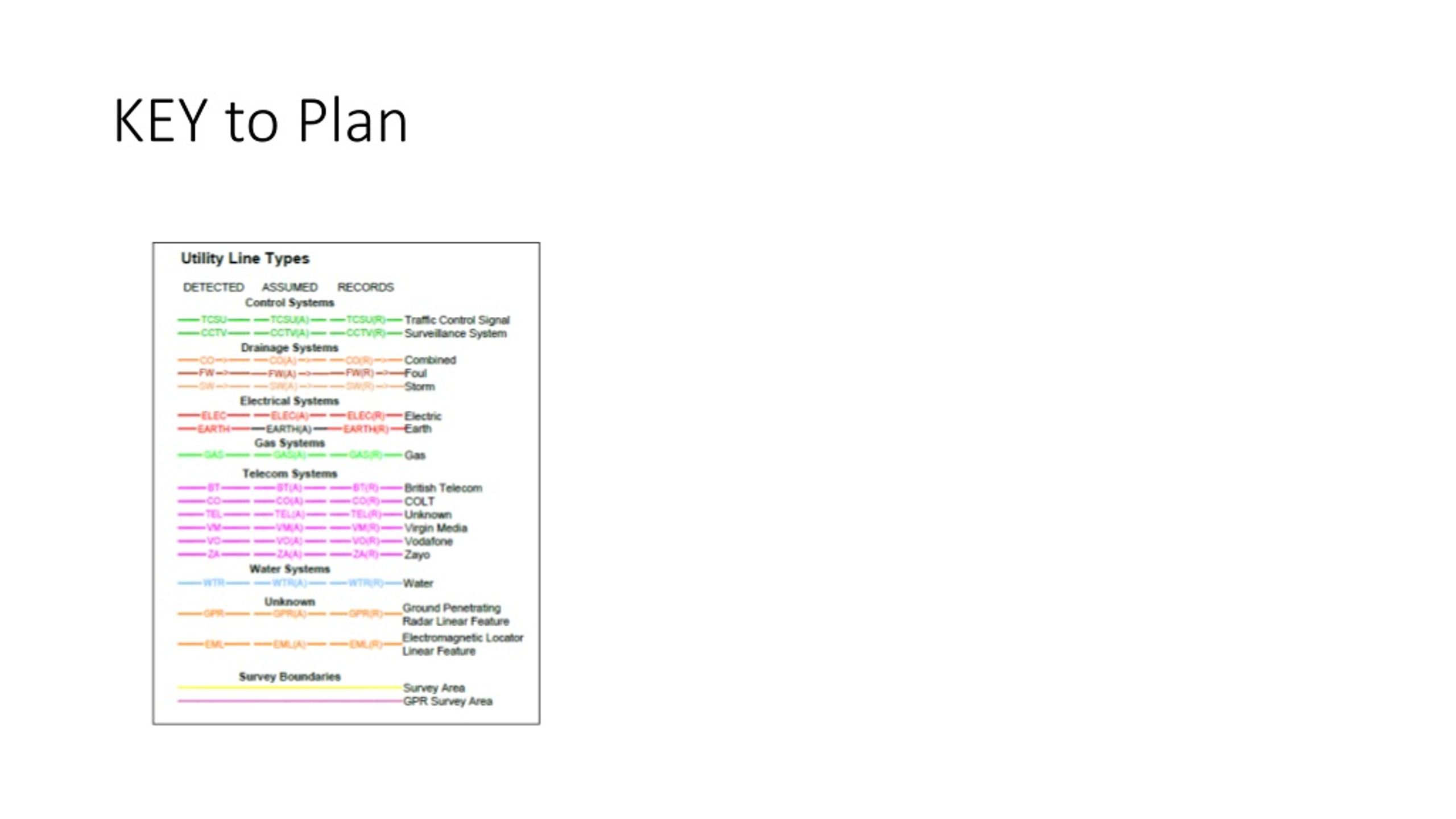

  4. KEY to Plan

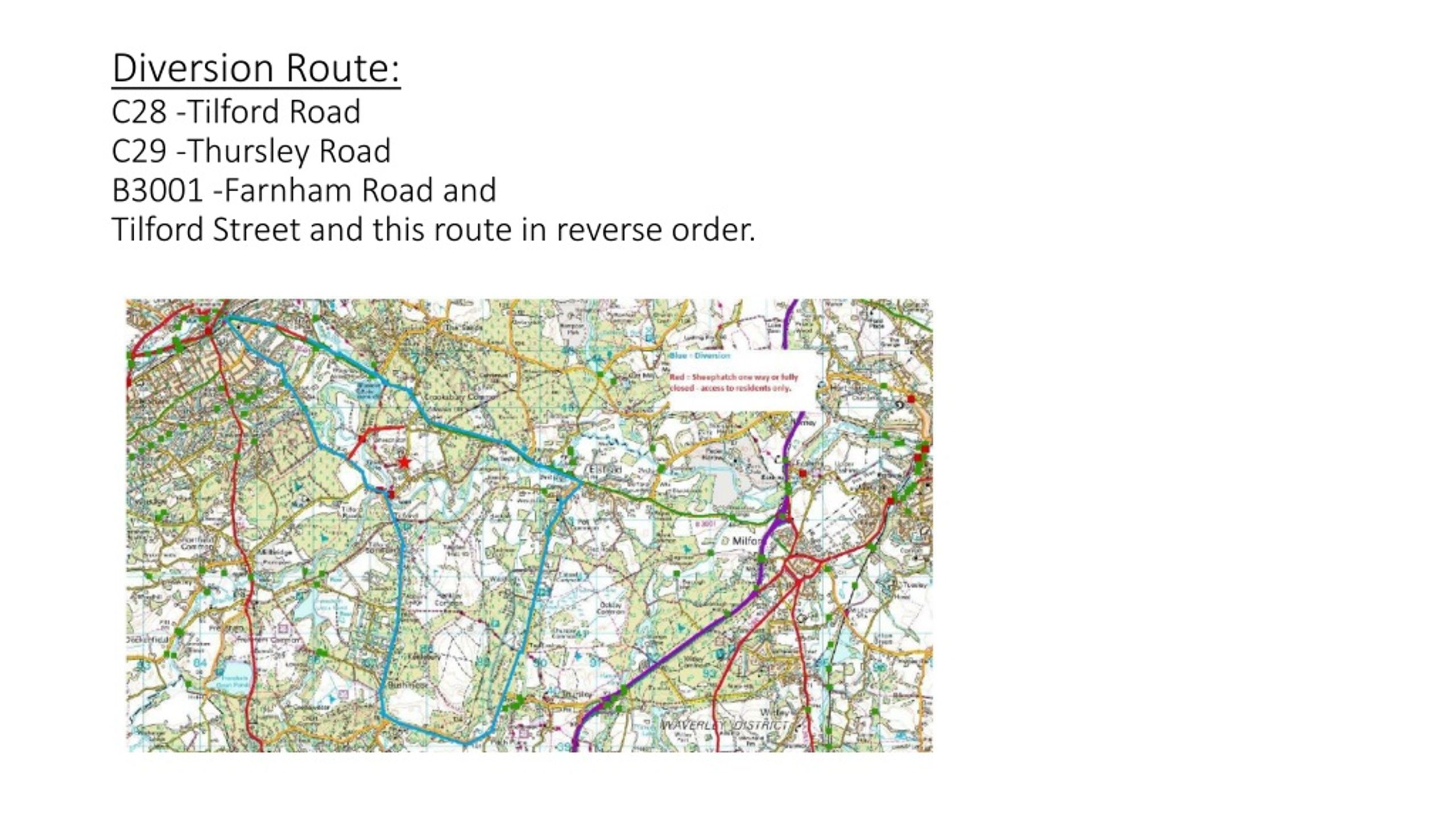

  5. Diversion Route:C28 -Tilford Road C29 -Thursley RoadB3001 -Farnham Road and Tilford Street and this route in reverse order.

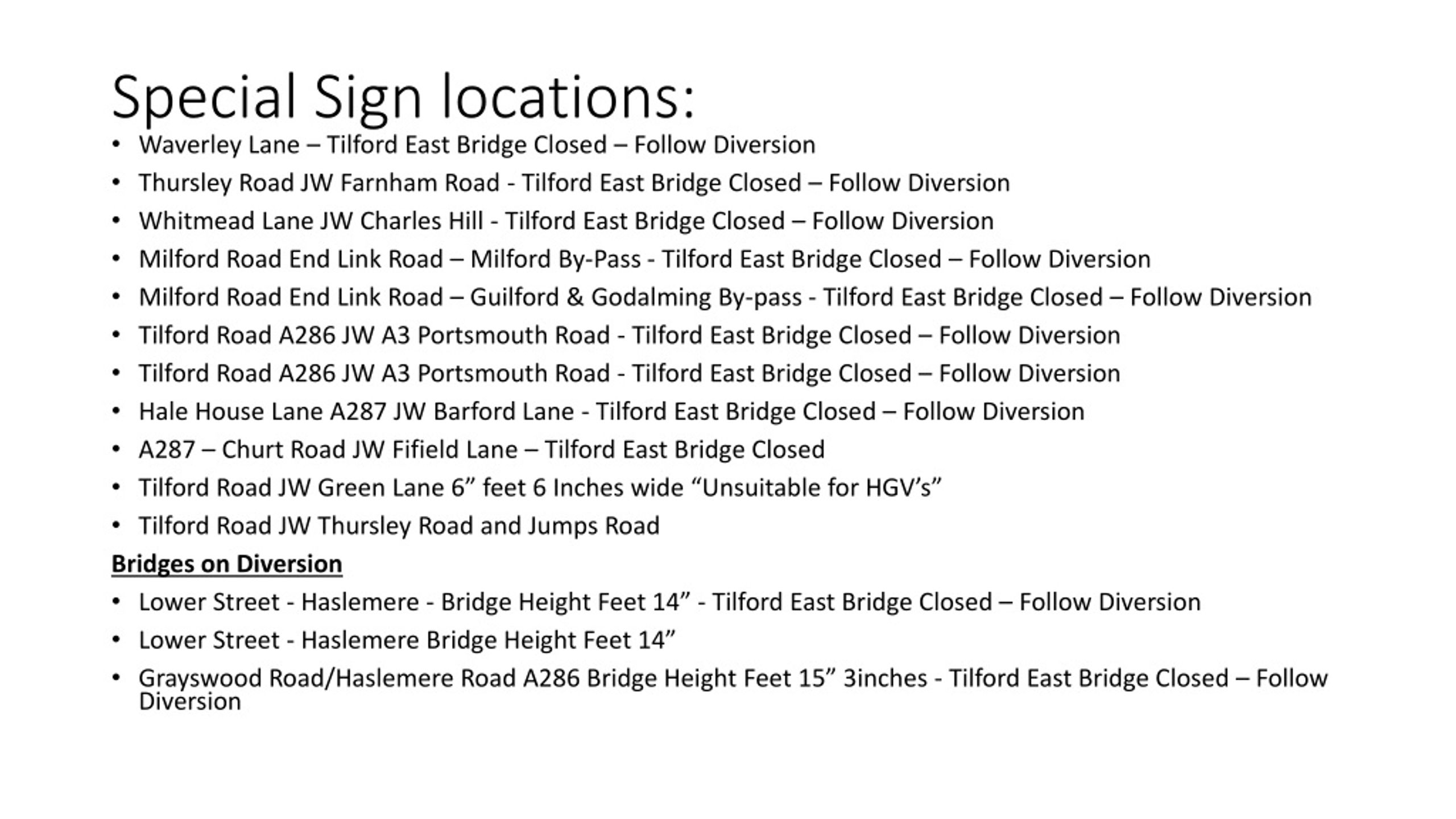

  6. Special Sign locations: • Waverley Lane – Tilford East Bridge Closed – Follow Diversion • Thursley Road JW Farnham Road - Tilford East Bridge Closed – Follow Diversion • Whitmead Lane JW Charles Hill - Tilford East Bridge Closed – Follow Diversion • Milford Road End Link Road – Milford By-Pass - Tilford East Bridge Closed – Follow Diversion • Milford Road End Link Road – Guilford & Godalming By-pass - Tilford East Bridge Closed – Follow Diversion • Tilford Road A286 JW A3 Portsmouth Road - Tilford East Bridge Closed – Follow Diversion • Tilford Road A286 JW A3 Portsmouth Road - Tilford East Bridge Closed – Follow Diversion • Hale House Lane A287 JW Barford Lane - Tilford East Bridge Closed – Follow Diversion • A287 – Churt Road JW Fifield Lane – Tilford East Bridge Closed • Tilford Road JW Green Lane 6” feet 6 Inches wide “Unsuitable for HGV’s” • Tilford Road JW Thursley Road and Jumps Road Bridges on Diversion • Lower Street - Haslemere - Bridge Height Feet 14” - Tilford East Bridge Closed – Follow Diversion • Lower Street - Haslemere Bridge Height Feet 14” • Grayswood Road/Haslemere Road A286 Bridge Height Feet 15” 3inches - Tilford East Bridge Closed – Follow Diversion

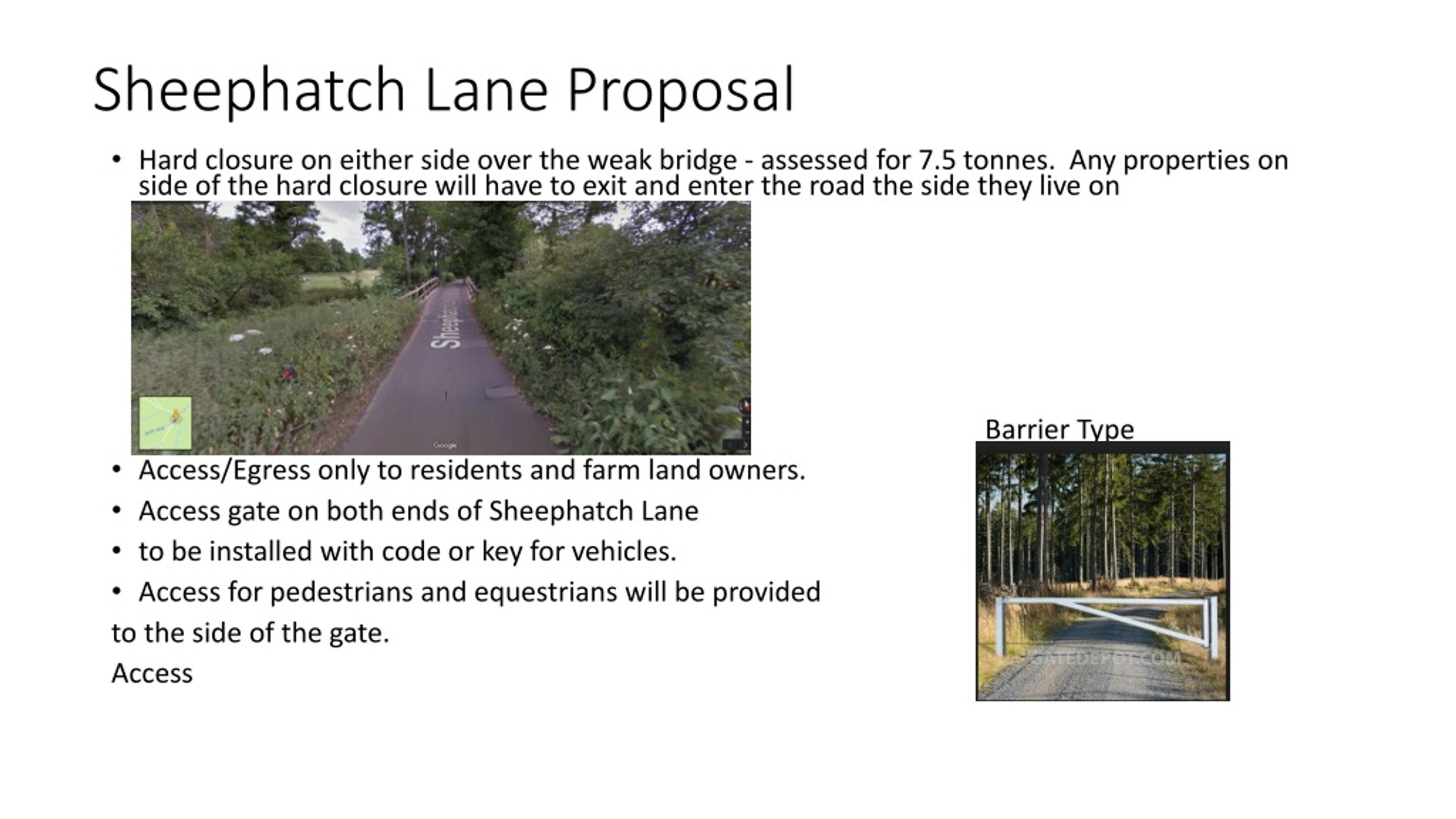

  7. Sheephatch Lane Proposal • Hard closure on either side over the weak bridge - assessed for 7.5 tonnes. Any properties on side of the hard closure will have to exit and enter the road the side they live on Barrier Type • Access/Egress only to residents and farm land owners. • Access gate on both ends of Sheephatch Lane • to be installed with code or key for vehicles. • Access for pedestrians and equestrians will be provided to the side of the gate. Access

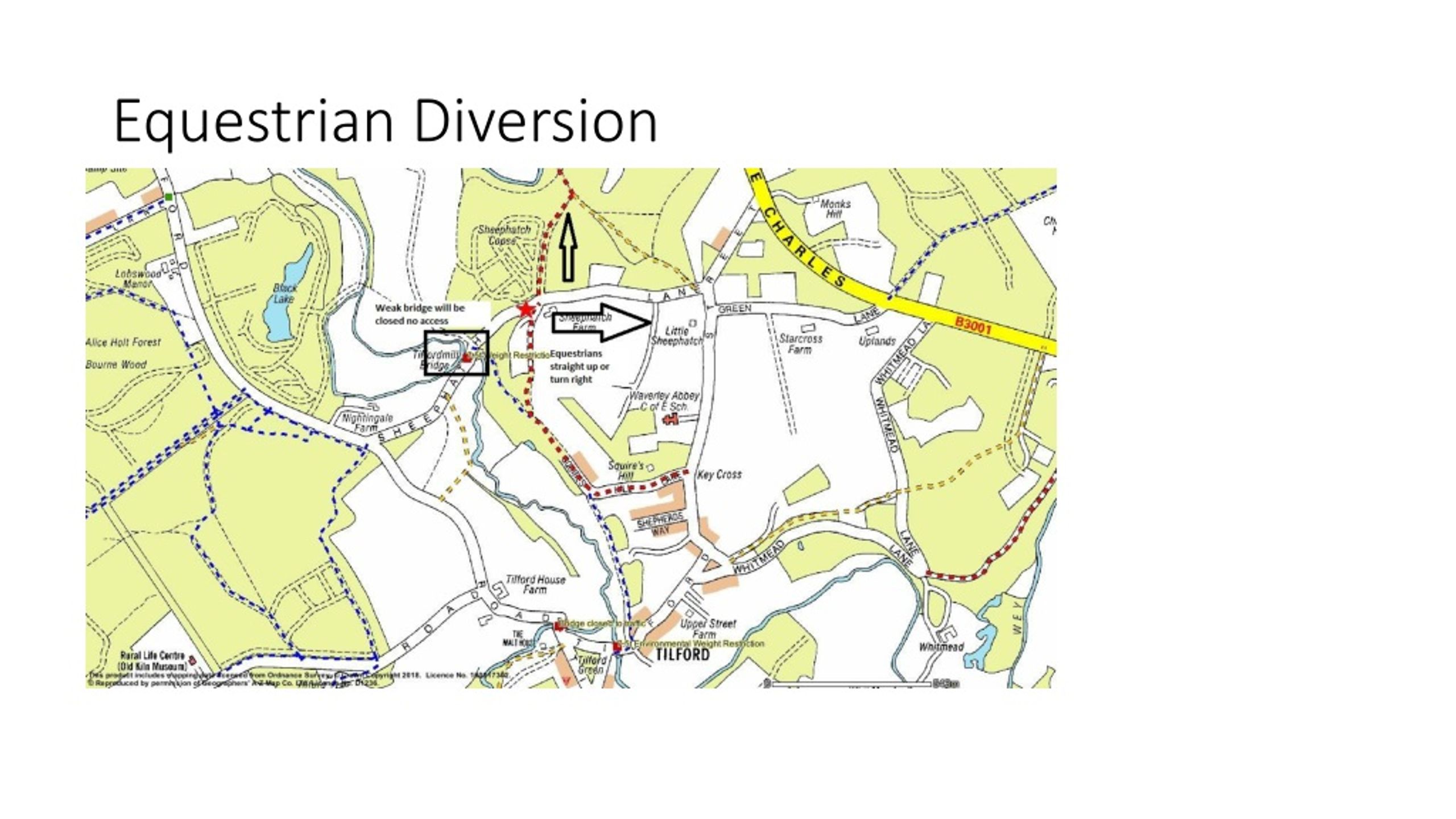

  8. Equestrian Diversion

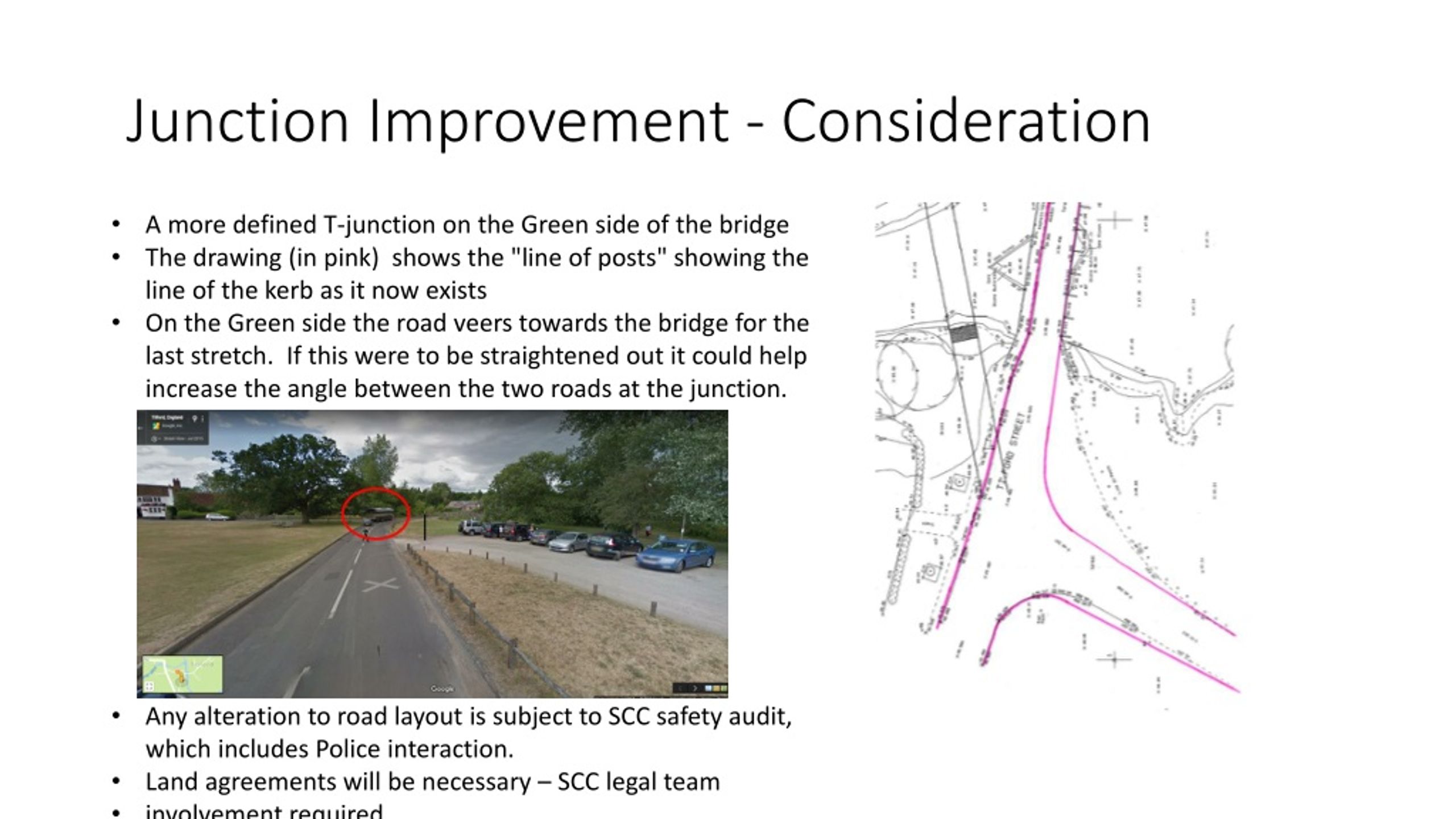

  9. Junction Improvement - Consideration • A more defined T-junction on the Green side of the bridge • The drawing (in pink) shows the "line of posts" showing the line of the kerb as it now exists • On the Green side the road veers towards the bridge for the last stretch. If this were to be straightened out it could help increase the angle between the two roads at the junction. • Any alteration to road layoutis subject to SCC safety audit, which includes Police interaction. • Land agreements will be necessary – SCC legal team • involvement required
