FVTX Wedge Assembly WBS 1.4.1.3.3, 1.4.1.3.4, 1.4.1.3.5, 1.4.1.3.6, 1.4.1.3.7, 1.4.1.3.8

FVTX Wedge Assembly WBS 1.4.1.3.3, 1.4.1.3.4, 1.4.1.3.5, 1.4.1.3.6, 1.4.1.3.7, 1.4.1.3.8. David Winter Columbia University FVTX Wedge Manager. Backplane. HDI. Detector. FPHX Chips. Thermally and electrically conductive adhesives. Thermally conductive adhesive. Talk Outline. Scope

dewey
Download Presentation

FVTX Wedge Assembly WBS 1.4.1.3.3, 1.4.1.3.4, 1.4.1.3.5, 1.4.1.3.6, 1.4.1.3.7, 1.4.1.3.8

An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript


  1. FVTX Wedge AssemblyWBS 1.4.1.3.3, 1.4.1.3.4, 1.4.1.3.5, 1.4.1.3.6, 1.4.1.3.7, 1.4.1.3.8 David Winter Columbia University FVTX Wedge Manager

  2. Backplane HDI Detector FPHX Chips Thermally and electrically conductive adhesives Thermally conductive adhesive Talk Outline • Scope • WBS 1.4.1.3.3 Attach HDI/Backplane • WBS 1.4.1.3.7 Bond Chips • WBS 1.4.1.3.8 Test Chips and HDI • WBS 1.4.1.3.4 Attach Sensor • WBS 1.4.1.3.5 Wire bond Assembly • WBS 1.4.1.3.6 Test Assembly • Wedge Schedule • Prototyping • Assembly Procedure • Assembly Fixtures • QA Testing and Manpower • Summary ~10 cm Winter FVTX Review November 2008

  3. Scope • Prepare assembly lab(s) • Develop assembly procedure • Receive backplanes, high-density interconnects (HDIs), sensors • All components arrive tested and qualified • HDIs populated with passive components • Assemble received components into wedges • Execute QA and testing procedures • Enter QA/Test results into database • Store assembled units • Deliver assembled wedges to detector assembly facility at BNL Winter FVTX Review November 2008

  4. Wedge Schedule Highlights of Dates Important to Assembly • Prototyping and design of components, fixtures: In progress • Procure and Test sensors: 2/11/09 9/8/09 • Procure HDI: 1/2/09 3/12/09 • Fabrication of backplanes: 20/2/09 6/19/09 • Procure Wedge Assembly fixtures: 9/26/08 11/6/08 • FNAL testing of production run of FPHX: 4/1/10 6/23/10 • Wedge assembly: 6/22/09 3/04/11 • WBS 1.4.1.3.3 Attach HDI to Backplane:6/22/09 1/15/10 • WBS 1.4.1.3.7 Bond FPHX chips: 6/24/10 1/19/11 • WBS 1.4.1.3.8 Test chips and HDI: 7/1/10 1/26/11 • WBS 1.4.1.3.4 Attach sensor: 7/8/10 2/2/11 • WBS 1.4.1.3.5 Wire bond: 7/12/10 2/4/11 • WBS 1.4.1.3.6 Testing Assembly: 8/9/10 3/4/11 • Endcap assembly (into cage structure): 9/6/10 6/1/11 Important dependencies • Critical path components: FPHX, HDI prototype • Sensor development and production Winter FVTX Review November 2008

  5. Prototype Assembly • Sidet at FNAL has been contracted to do prototype assembly • Provide feedback to develop assembly procedure and assembly fixtures • Build prototype wedge with mockup parts • Mount sample FPHXs to test boards for testing • Assemble prototype HDI + sample of FPHX chips for testing • Build full prototype wedge • Gain knowledge of tolerances and adhesives needed • Ultimate goal is estimate of preproduction and production costs and schedule Winter FVTX Review November 2008

  6. Prototype Assembly Procedure • Bond HDI to backplane • Inspect assembly and test HDI • Bond FPHX readout chips to HDI • Wire bond FPHX output pads to HDI • Inspect assembly and test HDI + FPHXs • Bond sensor to HDI • Wire bond sensor output pads to FPHX input pads • Inspect and test assembly • Encapsulate wire bonds • Additional technical details: • Arclad 8026 adhesive tape for non-conducting bonds • Sensor bonded in two ways: • Arclad for baseline bonding • Silver epoxy for sensor bias connection • Assembly includes traveler documents for each module Mock FPHXs diced for prototype assembly Winter FVTX Review November 2008

  7. Dummy Mockup @ Sidet • Blank Si sensor, chips • 4 mil Kapton tape for mock HDI Getting a feel for what the wedge will look like Winter FVTX Review November 2008

  8. Prototype Assembly Fixtures • Prototype fixtures have been designed by HYTEC incorporating feedback from Sidet • Order cut to fabricate by shop near HYTEC • Two sets costing $9144/total • Expecting delivery at beginning of Dec Winter FVTX Review November 2008

  9. Assembly fixtures: Backplane and HDI • Carbon fiber backplane positioned on fixture • HDI positioned on backplane, bonded • Dowel-pin placement used Winter FVTX Review November 2008

  10. Assembly Fixtures: FPHX chips Positioning Transfer Placement • Chips positioned on positioning fixture, held in place with vacuum • Transfer fixture placed over chips • Held with vacuum • Positioning vacuum released • Clear acrylic to enable optical inspection throughout process • Transfer fixture placed onto assembly fixture, chips bonded Winter FVTX Review November 2008

  11. Assembly Fixtures: Sensor Positioning Transfer Placement • Sensor placed on positioning fixture, held in place with vacuum • Transfer fixture placed on sensor • Held on with vacuum • Vacuum released from positioning fixture • Clear acrylic to enable optical inspection throughout process • Transfer fixture placed onto assembly fixture, bonded Winter FVTX Review November 2008

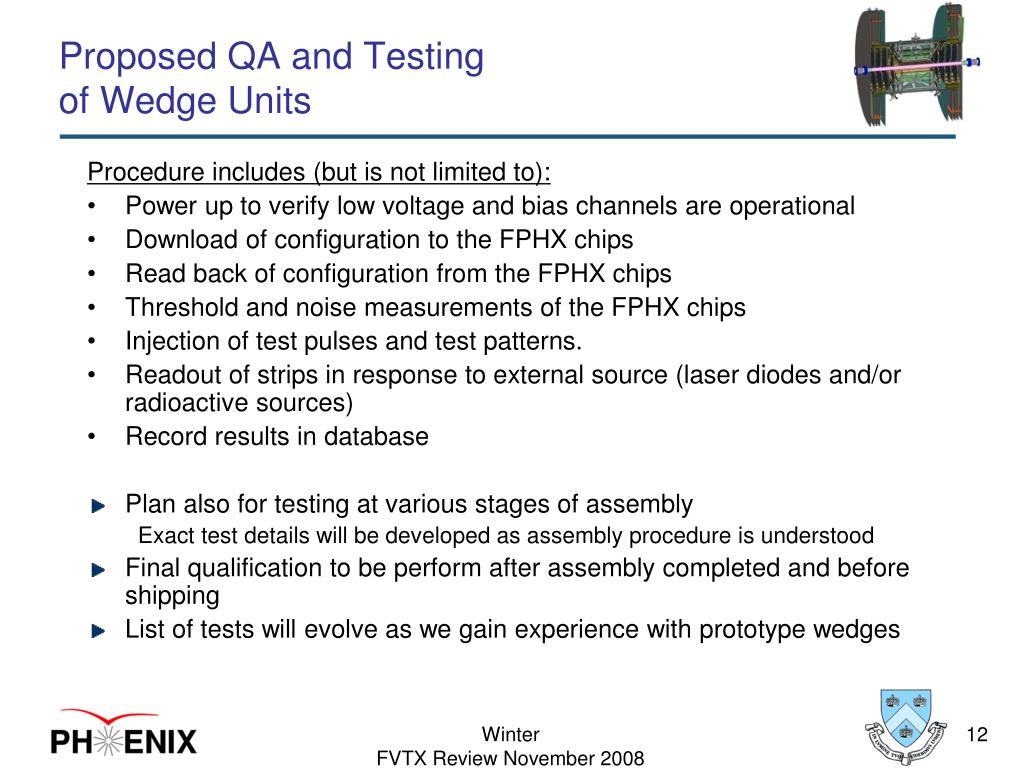

  12. Proposed QA and Testingof Wedge Units Procedure includes (but is not limited to): • Power up to verify low voltage and bias channels are operational • Download of configuration to the FPHX chips • Read back of configuration from the FPHX chips • Threshold and noise measurements of the FPHX chips • Injection of test pulses and test patterns. • Readout of strips in response to external source (laser diodes and/or radioactive sources) • Record results in database • Plan also for testing at various stages of assembly Exact test details will be developed as assembly procedure is understood • Final qualification to be perform after assembly completed and before shipping • List of tests will evolve as we gain experience with prototype wedges Winter FVTX Review November 2008

  13. Proposed Manpower Needs • Assembly performed by Sidet senior technicians and technicians • As production proceeds, manhours will shift from senior to junior individuals • Level of expertise chosen (by Sidet) to optimize the tradeoff between successful assembly and cost of manhours • FVTX collaborators: • Subsystem managers in charge of assembly and Physicist liaisons • Perform testing (on location) at required times • Graduate students and Postdocs available from several institutions to perform on-site testing • Subsystem manager stationed on-site to oversee production • Assembly steps to be identified that can be assigned to FVTX collaborators in order to reduce cost • Most likely steps are the initial lamination (Backplane and HDI) Winter FVTX Review November 2008

  14. Facilities • Requirements • Clean room/tent at Class 10k level • Room for 2-3 people to work • Storage for components and completed units (dry enclosures/shelving) • Identified labs • SIDET • Others • Nevis: 300 sq ft of self-contained clean room • UNM: Clean room and tent (similar total size) • LANL • Required equipment • High-precision positioning equipment • Assembly fixtures • Adhesive dispensing system • Testing • Dark boxes (i.e.. Enclose units for response tests) • Low- and Bias-voltage supplies • Mini-DAQ (e.g. turnkey version of FVTX readout) • On-project funds are allocated for equipment • Up to $100k budgeted • Wherever possible borrow equipment Winter FVTX Review November 2008

  15. Summary • Wedge assembly comprises WBS items 1.4.1.3.3 –1.4.1.3.8 • Production schedule: 6/22/09 to 3/4/11 • Prototyping in progress • Fixtures designed and in process of procurement • Sidet developing procedure with mockups Winter FVTX Review November 2008

  16. Backup slides Winter FVTX Review November 2008

  17. Silicon Detector Center @ FNAL • Primier facility for building and testing vertex detectors for HEP experiments • Five large-scale clean rooms for assembly and testing • Several wirebonding stations • Wide expertise with Silicon and CCD technology • CDF, D0, CMS, SNAP among others Winter FVTX Review November 2008

  18. Summary:WBS 1.4.1.3.3/4/5/6 - Cost and Schedule • Cost (AY$) 1.4.1.3.3$ 32k • 1.4.1.3.4 $ 32k • 1.4.1.3.5 $ 208k • 1.4.1.3.6 $ 38k • R&D needed Assy fixtures, adhesives, procedures • Cost Basis vendor and engineering quotes • Cost Contingency 1.4.1.3.3 22% • 1.4.1.3.4 22% • 1.4.1.3.5 26% • 1.4.1.3.6 22% • Schedule Start and Complete 6/22/09 - 3/4/11 • Schedule Contingency FPHX, HDI is critical path • Risk Low Winter FVTX Review November 2008

  19. Summary:WBS 1.4.1.3.3/4/5/6 – Technical • Specification Document TDR, Draft Doc • Prototype status Draft • Number of wedges 110 small, 330 large • Spares 8 small, 25 large • Manpower (on-project) $100k (FY07$), 1.0 FTE • Institutions Involved Columbia, NMSU, UNM, LANL • Infrastructure Defined Draft • QA procedures in place Done Winter FVTX Review November 2008
