TWSd – New Best Practices

TWS Education & Training. TWSd – New Best Practices. Agenda. Global options Scheduling FINAL Monitoring FINAL EDWA/external monitoring/auto-ticketing Monitoring EDWA Other integrations Other tips. Global options. enLegacyId / li = NO YES was useful only for network with 8.2 FTAs

davis
Download Presentation

TWSd – New Best Practices

An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript


  1. TWS Education & Training TWSd – New Best Practices

  2. Agenda • Global options • Scheduling FINAL • Monitoring FINAL • EDWA/external monitoring/auto-ticketing • Monitoring EDWA • Other integrations • Other tips

  3. Global options • enLegacyId / li = NO • YES was useful only for network with 8.2 FTAs • enTimeZone / tz = YES • Even with a single TZ, YES should be the preferred option • enLegacyStartOfDayEvaluation / le = NO • Easier to understand but it changes the schedulation

  4. Global options – enLegacyStartOfDayEvaluation=NO Start Of Day = 0600 06:00 06:00 April, 12 Miami April, 12 Rome 06:00 06:00

  5. Global options – enLegacyStartOfDayEvaluation=YES Start Of Day = 0600 06:00 06:00 Miami(Master) April, 12 April, 12 Rome 12:00 12:00

  6. Scheduling FINAL Every working day at 7AM we extend the plan until 12PM of the next working day 07:00 12:00 12:00 of next working day

  7. Scheduling FINAL • Required settings • enCarryForward / cf = ALL • extension to next work day w/ buffer • FINAL to run on every workday (at 7:00) • HOLIDAYS calendar defined • ignoreCals / ic = NO • Makeplan to be changed to extend until next work day MakePlan –to `datecalc today + 1 workday pic mm/dd/yyyy` 1200 TZ America/NewYork • Set Until Time on JS to remove from plan uncompleted JS • with cf=ALL JS are not removed when a new plan is created • Optional settings • startOfDay / sd = 0000 • enPreventStart = ???

  8. Monitoring FINAL • STARTAPPSERVER • MAKEPLAN  Can be scheduled in advance • SWITCHPLAN  Most critical • CREATEPOSTREPORTS  No production impact • UPDATESTATS  No production impact

  9. Monitoring FINAL • Monitor FINAL jobs status (EDWA or external product) • SwitchPlan abend may not be reported since TWS is down • Monitor SwitchPlan long duration (EDWA or external product) • E.g.: alerting if SwitchPlan does not complete within the double of its normal duration • Periodically check FNCJSI • the size of Pre-Production plan is related to that > planman showinfo ... Start time of first not complete preproduction plan job stream instance: 03/25/2011 00:00 TZ CET

  10. Monitoring FINAL Job Status Changed FINAL.SWITCHPLAN to status EXEC Job Status Changed FINAL.SWITCHPLAN to status SUCC, ABEND, FAIL Timeout = double of normal time Timeout Action: Send mail to administrator

  11. EDWA/external monitoring/auto-ticketing • Use monitoring tools to be notified of failure in TWS • Job abends • Unlinked WS (outside FINAL timeframe) • TWS processes down on master netman mailman batchman jobman WAS monman • TWS mailbox size • Forward the identified problem to ticketing application to automatically generate a ticket

  12. EDWA/external monitoring/auto-ticketing • EDWA • Can be used to monitor Jobs, unlinked WS, TWS processes, TWS mailbox size • Need to monitor EDWA itself • IBM Tivoli Monitoring • Integration provided with TWS can be used to monitor Jobs, TWS processes, TWS mailbox size • Monitor unlinked WS currently not provided in the integration • Can be implemented using BMEvents.conf events • Other monitoring tool • Jobs, unlinked WS can be implemented using BMEvents.conf events • Evtsize can be called to determine mailbox usage • TWS processes should be monitored through OS (pids directory contains TWS processes pids)

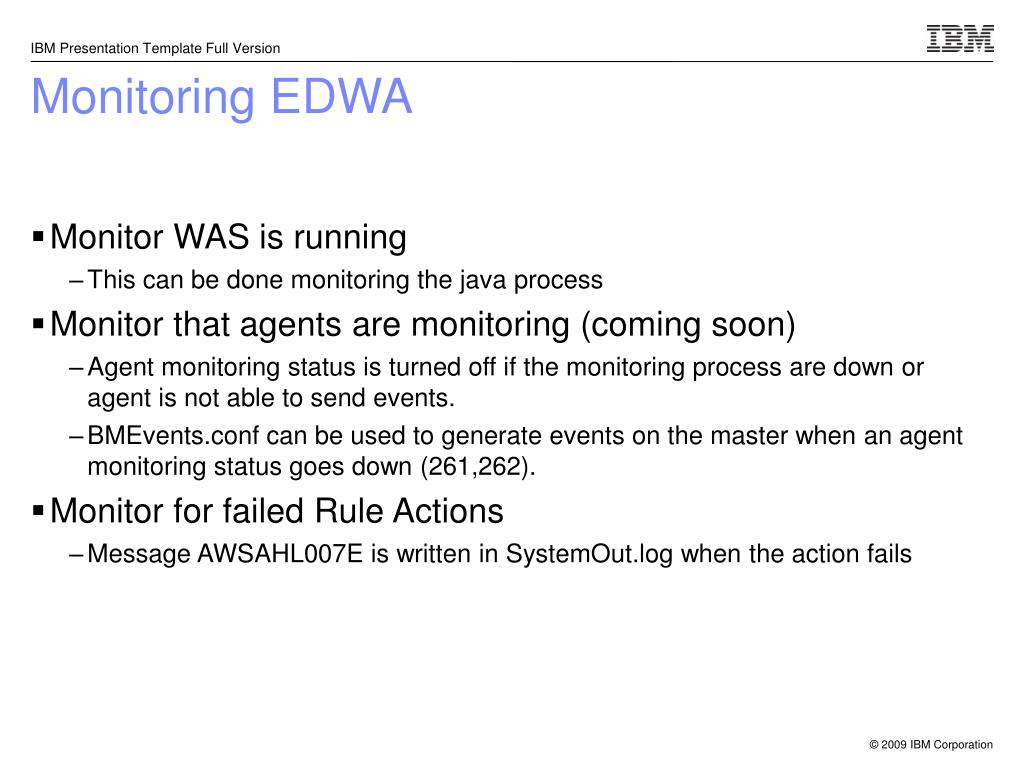

  13. Monitoring EDWA • Monitor WAS is running • This can be done monitoring the java process • Monitor that agents are monitoring (coming soon) • Agent monitoring status is turned off if the monitoring process are down or agent is not able to send events. • BMEvents.conf can be used to generate events on the master when an agent monitoring status goes down (261,262). • Monitor for failed Rule Actions • Message AWSAHL007E is written in SystemOut.log when the action fails

  14. Other integrations • Self service (via conman/Java APIs) • Allow your end-users to operate directly on their scheduling activities • Product like IBM Tivoli Service Request Manager can be used to implement an approval process before the action is performed • Custom GUIs can provide a simplified and limited interface design on the enduser need • Change management (via composer/Java APIs) • Promote your scheduling defintion from Dev to Q&A and from Q&A to Prod • Product like IBM Tivoli Service Request Manager can be used to implement an approval process before the action is performed

  15. Other tips • “conman” always return rc 0, you can workaround this limitation with a wrapper script that intercept returned errors and exit with different rc accordingly http://www-01.ibm.com/support/docview.wss?uid=swg21470088 • Unlink Tool (coming soon) • “Check Health Status” command fron conman and WebUI diagnose unlink problems, .msg and Symphony files • Prevent losing events with EDWA • Modify EIF/monmaneif.templ and ssm/eif/tecad_snmp_eeif.templ setting: ConnectionMode=connection_less

  16. Other tips (TDWC) • Windows Domain Users? • Consider accessing it as LDAP user registry instead as LocalOS • Improve TDWC scalability • Set maxOpenConnections=“20000” for WC_adminhost and WC_adminhost_secure in eWAS/profiles/twaprofile/config/cells/DefaultNode/nodes/DefaultNode/servers/twaserver/server.xml • Improve Graphical View scalability • Set isGrowable=“true” for TWSWebUIWorkManager in eWAS/profiles/twaprofile/config/cells/DefaultNode/nodes/DefaultNode/servers/twaserver/resources-pme.xml
