FSU/CI JPII Workgroup Status Report 2 - July 22. Current work events. Team work continues in forward, direction over past few weeks. Software Inventory nearly complete. Some documentation efforts currently underway. Report from IT Practicum expected later this week.
E N D

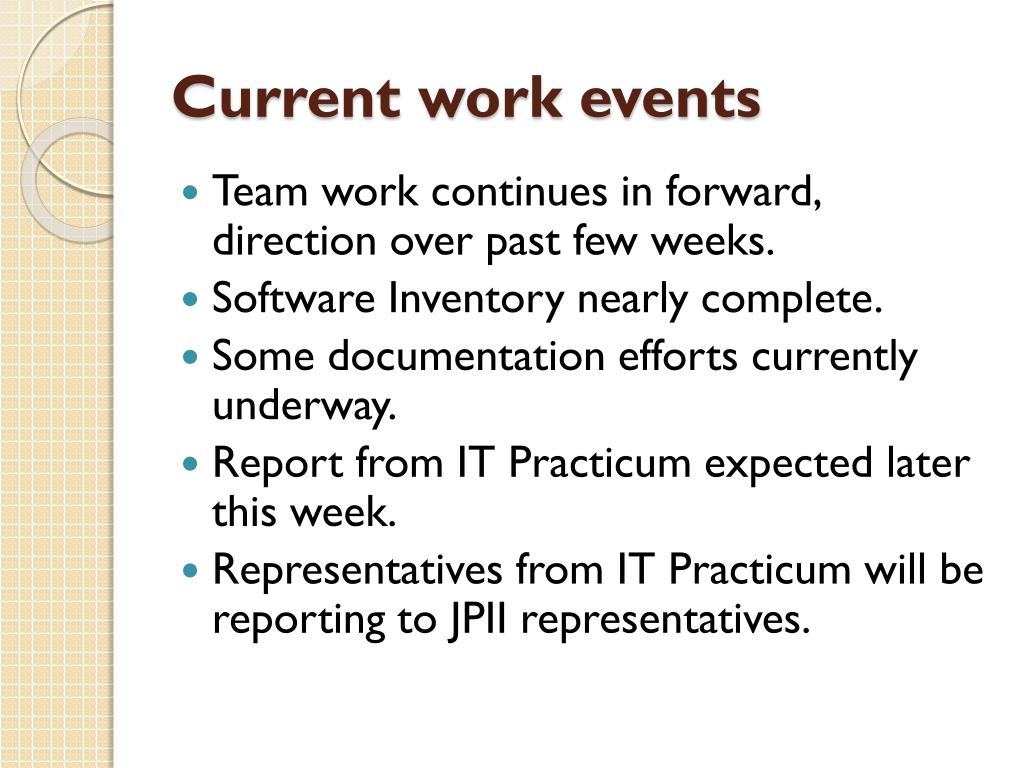

Current work events • Team work continues in forward, direction over past few weeks. • Software Inventory nearly complete. • Some documentation efforts currently underway. • Report from IT Practicum expected later this week. • Representatives from IT Practicum will be reporting to JPII representatives.

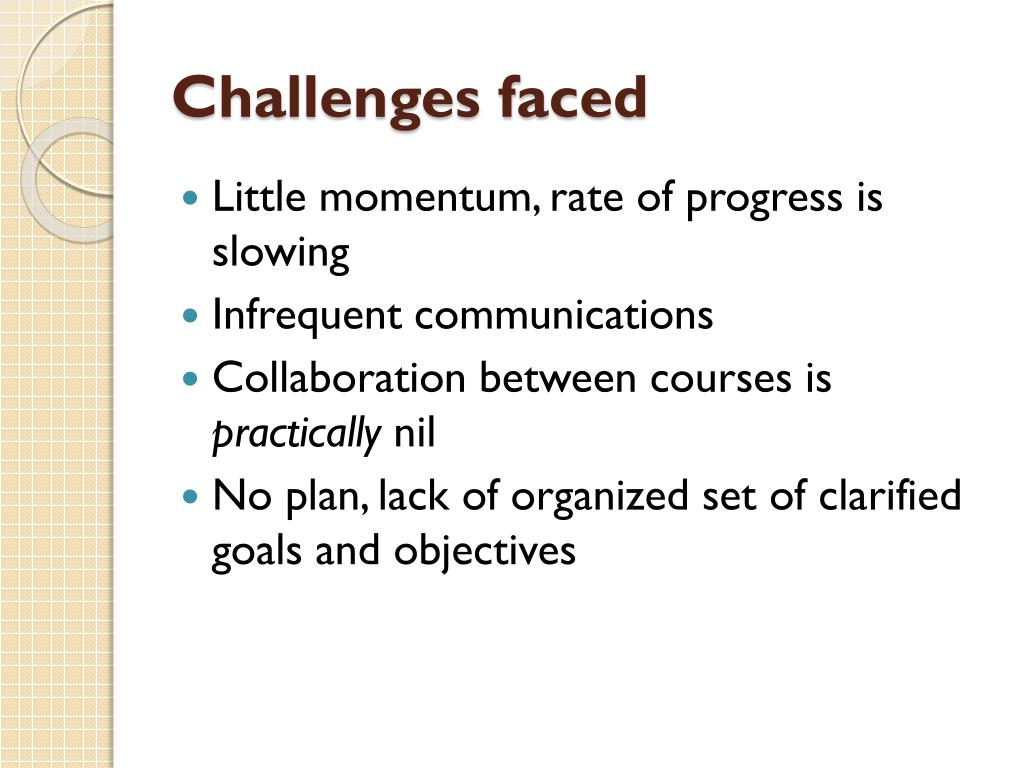

Challenges faced • Little momentum, rate of progress is slowing • Infrequent communications • Collaboration between courses is practically nil • No plan, lack of organized set of clarified goals and objectives

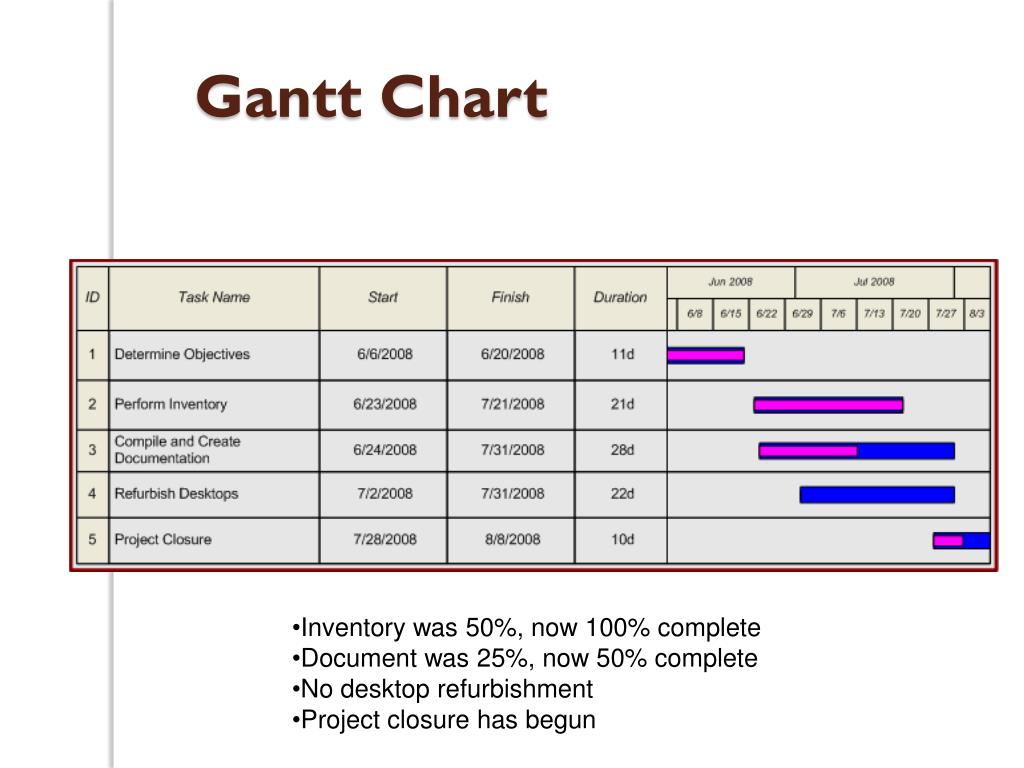

Gantt Chart • Inventory was 50%, now 100% complete • Document was 25%, now 50% complete • No desktop refurbishment • Project closure has begun

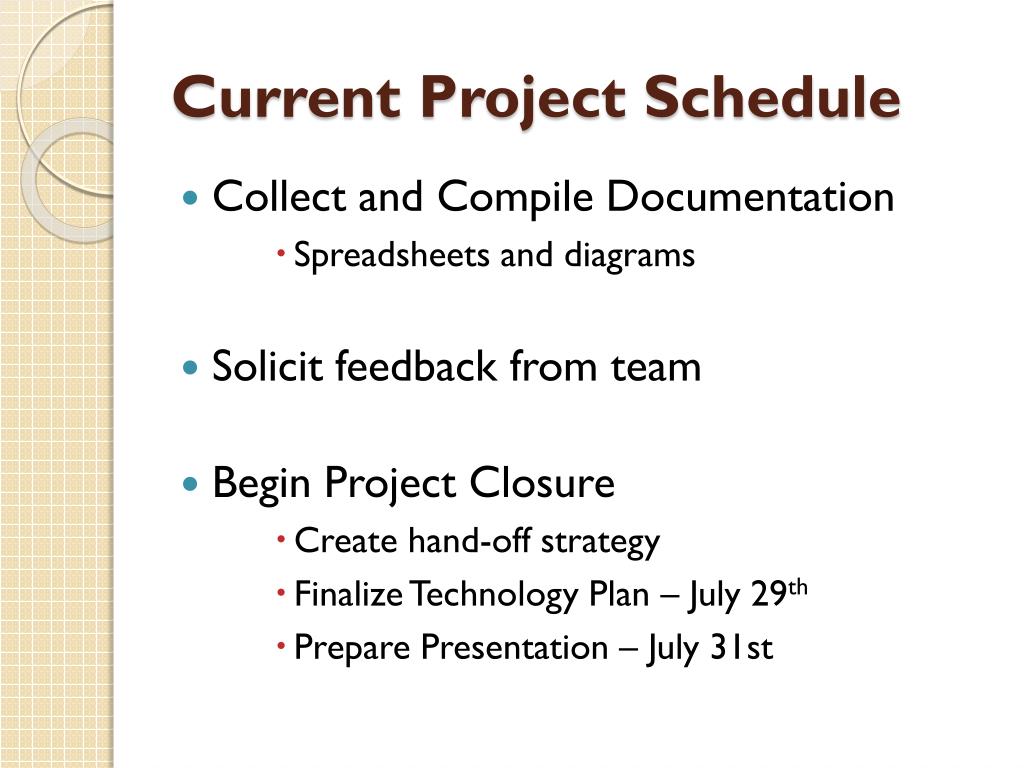

Current Project Schedule • Collect and Compile Documentation • Spreadsheets and diagrams • Solicit feedback from team • Begin Project Closure • Create hand-off strategy • Finalize Technology Plan – July 29th • Prepare Presentation – July 31st

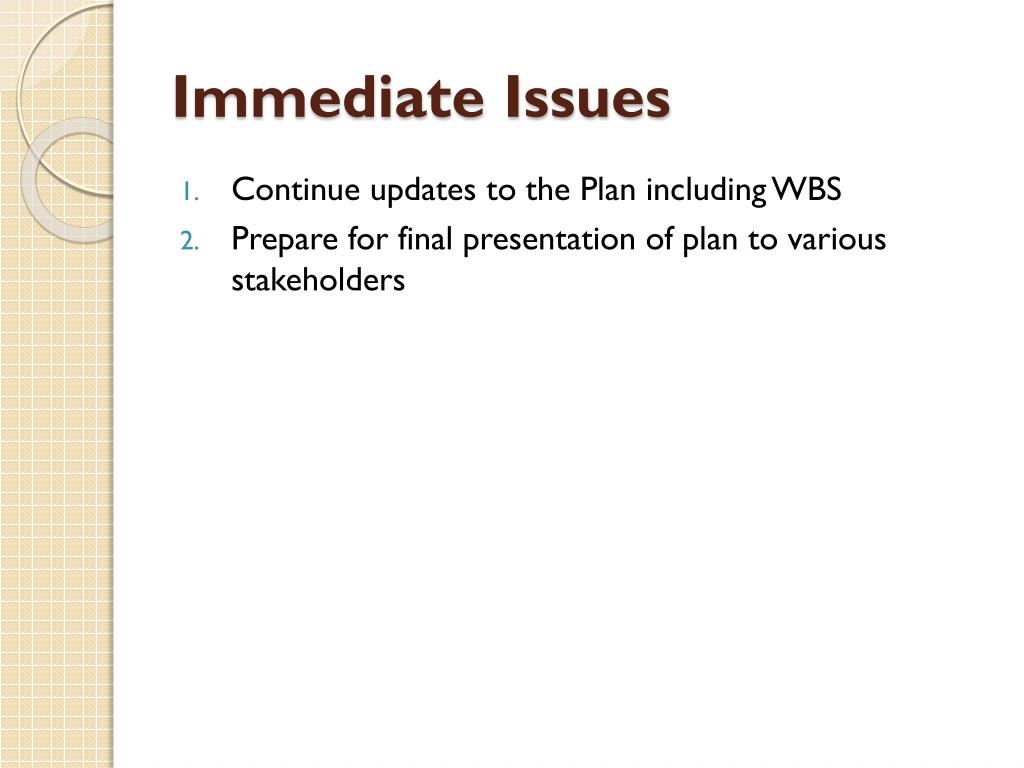

Immediate Issues • Continue updates to the Plan including WBS • Prepare for final presentation of plan to various stakeholders
