210 likes | 327 Views
Deployment of a Shibboleth-based Infrastructure in Switzerland: SWITCHaai. Martin Sutter, Head of NetServices, SWITCH (Ueli Kienholz & Thomas Lenggenhager) UK e-Science Core Programme Town Meeting Monday 11 th April 2005. Project Timeline. 2001. 2002. 2003. 2004. 2005. 2006. Study.
E N D
Deployment of a Shibboleth-based Infrastructure in Switzerland: SWITCHaai Martin Sutter, Head of NetServices, SWITCH (Ueli Kienholz & Thomas Lenggenhager) UK e-Science Core Programme Town Meeting Monday 11th April 2005

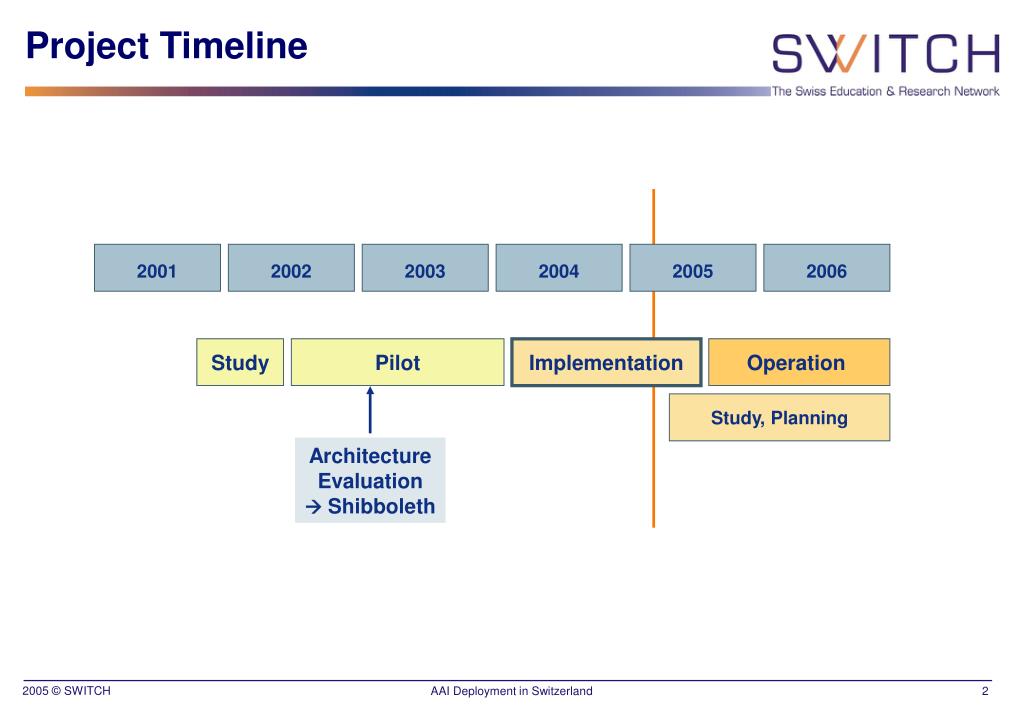

Project Timeline 2001 2002 2003 2004 2005 2006 Study Pilot Implementation Operation Study, Planning Architecture Evaluation Shibboleth
Without AAI • Tedious user registration at all resources • Unreliable and outdated user data at resources • Different login processes • Many different passwords • Many resources not protected due to difficulties • Often IP-based authorization • Costly implementation of inter-institutional access University A Student Admin Web Mail e-Learning Library B e-Journals Literature DB University C Research DB e-Learning User Administration Authentication Authorization Resource Credentials
With AAI • No user registration and user data maintenance at resource needed • Single login process for the users • Many new resources available for the users • Enlarged user communities for resources • Authorization independent of location • Efficient implementation of inter-institutional access University A AAI Student Admin Web Mail e-Learning Library B e-Journals Literature DB University C Research DB e-Learning User Administration Authentication Authorization Resource Credentials

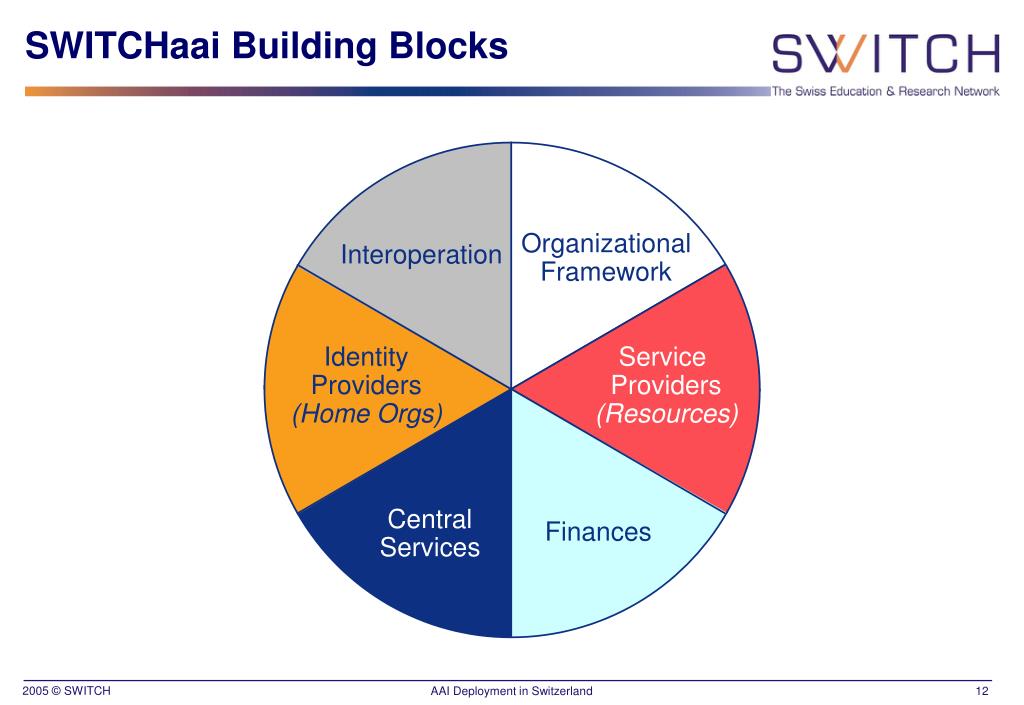

SWITCHaai Building Blocks Organizational Framework Interoperation Identity Providers (Home Orgs) Service Providers (Resources) Central Services Finances
Organizational Framework Organization SWITCH acts as SWITCHaai Federation service provider Federation membership based on signed service agreements
Interoperation Requires agreement on technical details like • Standards • SAML 1.1 • Software versions • Shibboleth 1.1 for identity providersShibboleth 1.2.1 for service providers • Accepted certificate authorities • SWITCHpki, plus Thawte, Trustcenter, VeriSign • Attribute specification • SwissEduPerson Interoperation

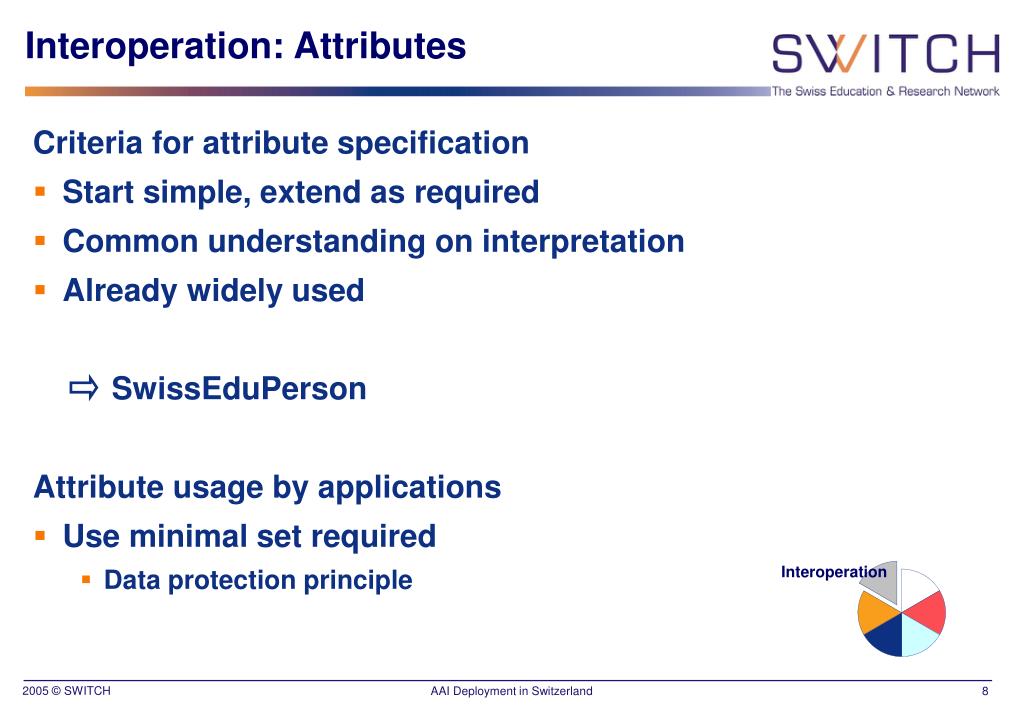

Interoperation: Attributes Criteria for attribute specification • Start simple, extend as required • Common understanding on interpretation • Already widely used SwissEduPerson • Attribute usage by applications • Use minimal set required • Data protection principle Interoperation
Identity Provider Integration AAI-enabled Identity Provider • Currently in use in SWITCHaai: • Authentication Systems • OpenLDAP with CAS or Pubcookie • Kerberos AuthN with Active Directory • Windows AuthN with IIS • User Directory • OpenLDAP • Active Directory AAI AuthenticationSystem UserDirectory Identity Providers
University Bern Université de Fribourg Virtual Home Org Université de Lausanne Université de Genève Identity Providers in SWITCHaai Operational AAI Identity Provider University Hospital Zurich Zürcher Hochschule Winterthur AAI Identity Provider getting ready Prototype running University Zurich Service Agreement SFIT Zurich SWITCH University Lucerne Identity Providers 110’000 Swiss Higher Ed users have an AAI-Account (≈ 50% of all)

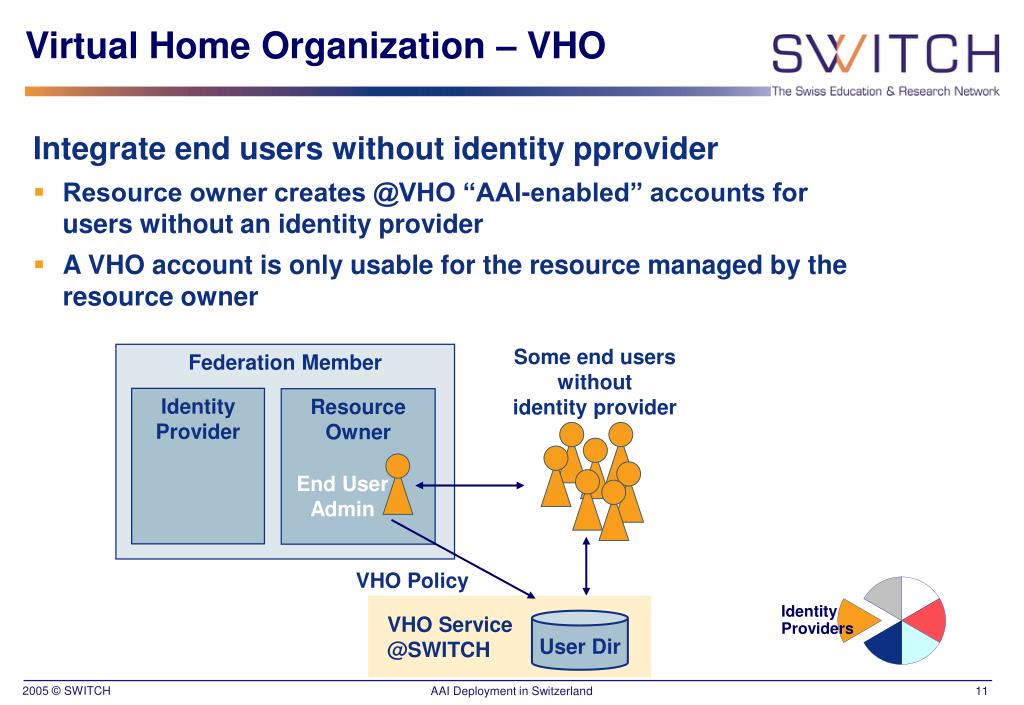

VHO Service @SWITCH User Dir Virtual Home Organization – VHO • Integrate end users without identity pprovider • Resource owner creates @VHO “AAI-enabled” accounts forusers without an identity provider • A VHO account is only usable for the resource managed by the resource owner Some end users without identity provider Federation Member Identity Provider Resource Owner End User Admin VHO Policy Identity Providers
SWITCHaai Building Blocks Organizational Framework Interoperation Identity Providers (Home Orgs) Service Providers (Resources) Central Services Finances
Types of Service Providers e-learning libraries OLAT Vista@SVC EZproxy WebCT@ETHZ VITELS ScienceDirect DOIT Blackboard Moodle … BSCW ILIAS AD Learn & Co other web applications commercial Vconf-Reservation SwissLex TWiki SMS-Gateway eShops IS-Academia Service Providers Jobs@BWI
Service Provider Example: DOIT DOIT: Dermatology Online with Interactive Technology Access Rule IdP = UniZH | UniBE | UniL affiliation = student studyBranch = medicine studyLevel = 15 AAI Identity Provider AAI Service Provider UniZH ETHZ SWITCH UniBE VHO UniL UniGE Service Providers 500 AAI Users
Service Provider Example: OLAT OLAT: Online Learning an Training (open source e-learning platform of the University of Zurich) AAI Identity Provider AAI Service Provider UniZH ETHZ SWITCH UniBE VHO UniL UniGE Service Providers 5000 AAI Users 75 Courses
Integration of „Blackboxes“ • Authentication / authorization gateway • Portal functionalities (optional) • User management (optional) • Adaptors toblackbox applications: • WebCT Vista • WebCT CE • … Sign On Application AAIportal A1 A2 API . . . Shibboleth Service Providers
Central AAI Services • Strategy & marketing • International contacts • Support, consulting, training • Providing federation-specific files and configuration guides • Operating WAYF • Testing parties (identity provider service provider) • Jump-start service Central Services
Funding funding / costs pilot project project operational service funded by SWITCH & Universities funded by federal grants funded by tariffs 2000 2001 2002 2003 2004 2005 2006 2007 2008 2009 2010 Finances
Outlook • Projects with federal grants • Non-web service providers, e.g. grid • ECTS (Study) • AAA (Study) • Federation partners
Further Information • SWITCHaai Website http://www.switch.ch/aai • Shibboleth • http://shibboleth.internet2.edu/ • Shibboleth Demo http://www.switch.ch/aai/demo • Attribute Specification http://www.switch.ch/aai/docs/AAI_Attr_Specs.pdf
Questions ? Q & A http://www.switch.ch/aai aai@switch.ch
