Yakima Air Terminal Alpha Taxiway Rehabilitation Improvement Project

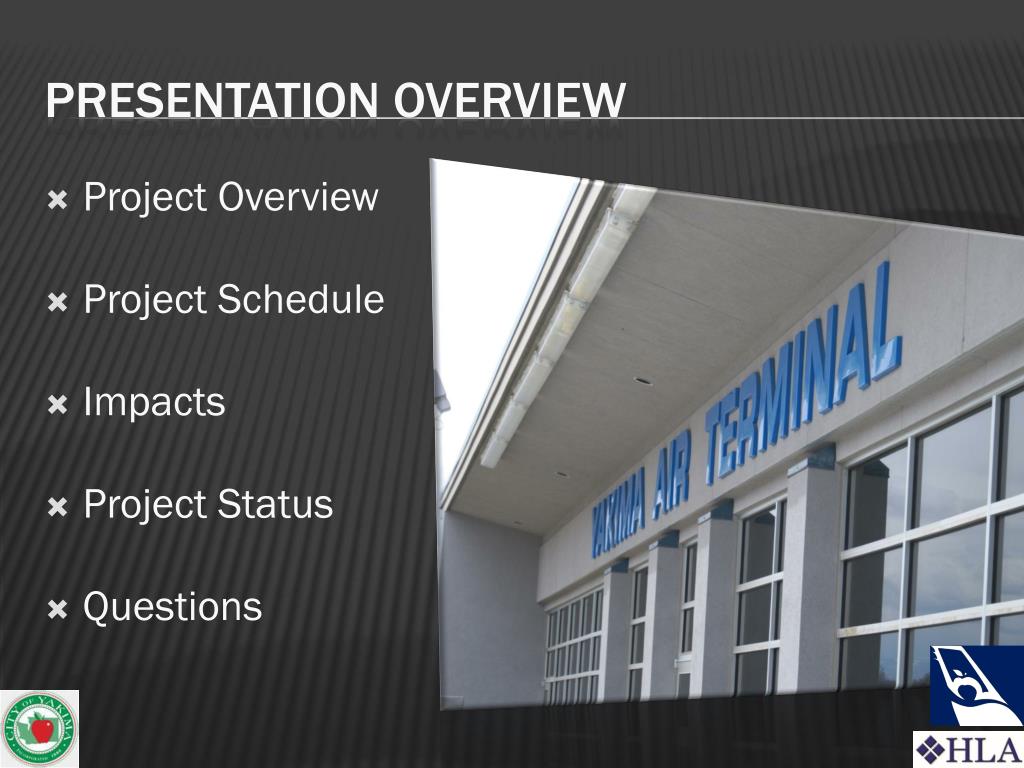

Project Overview Project Schedule Impacts Project Status Questions Presentation Overview

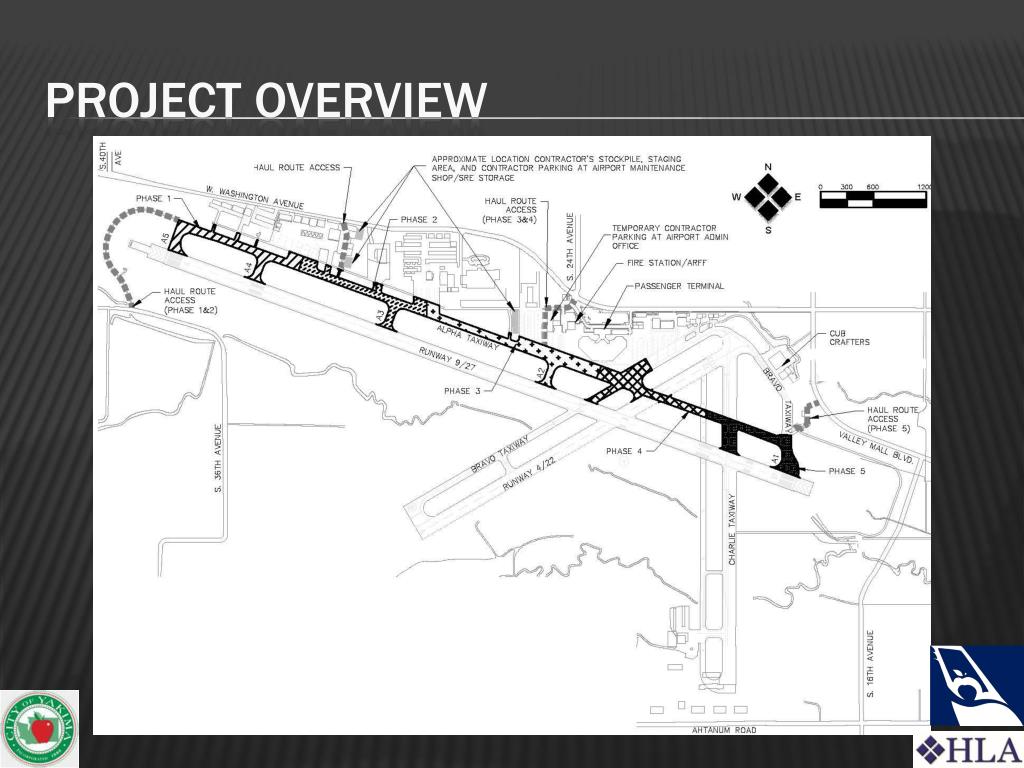

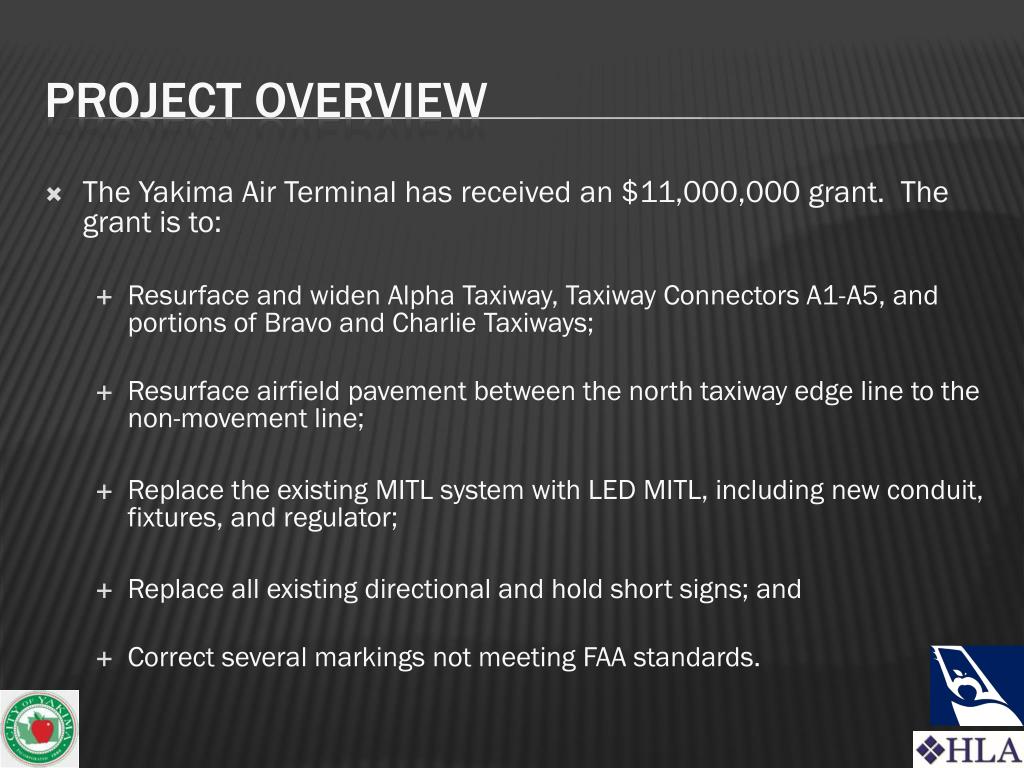

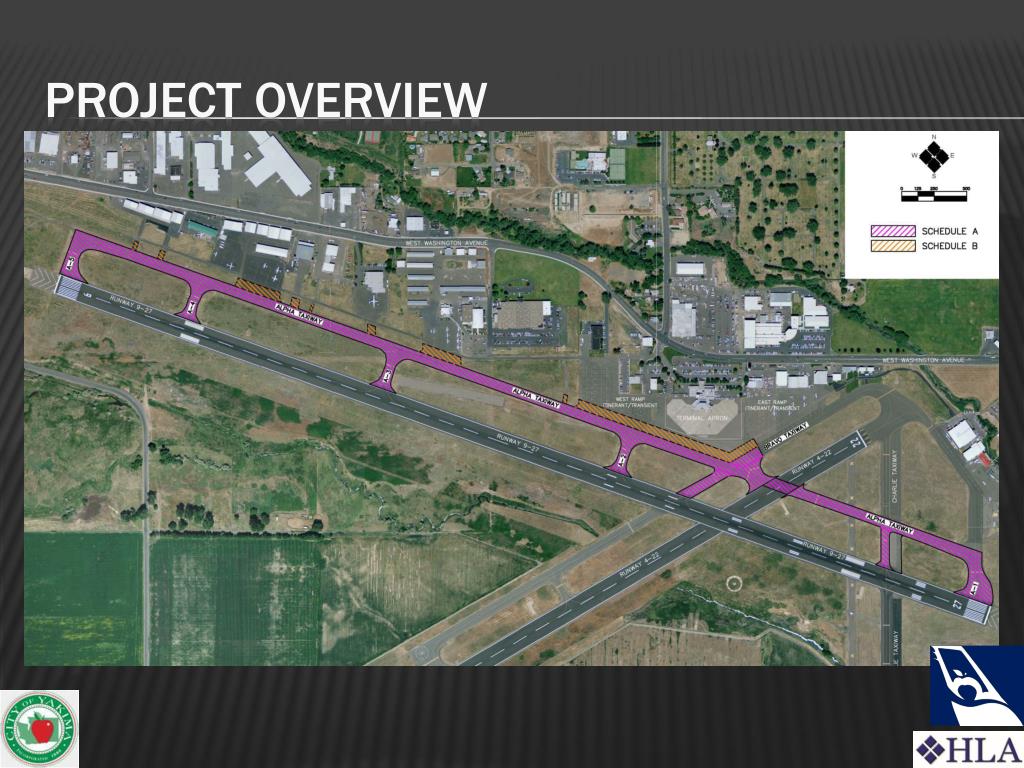

The Yakima Air Terminal has received an $11,000,000 grant. The grant is to: • Resurface and widen Alpha Taxiway, Taxiway Connectors A1-A5, and portions of Bravo and Charlie Taxiways; • Resurface airfield pavement between the north taxiway edge line to the non-movement line; • Replace the existing MITL system with LED MITL, including new conduit, fixtures, and regulator; • Replace all existing directional and hold short signs; and • Correct several markings not meeting FAA standards. Project Overview

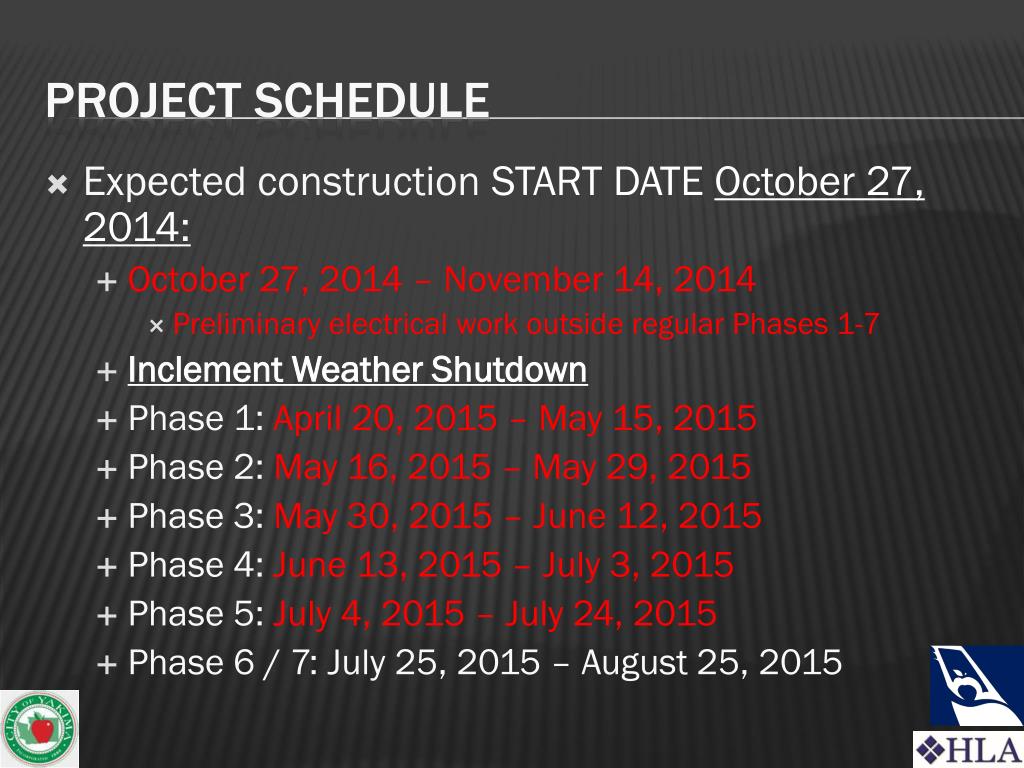

Expected construction START DATE October 27, 2014: • October 27, 2014 – November 14, 2014 • Preliminary electrical work outside regular Phases 1-7 • Inclement Weather Shutdown • Phase 1: April 20, 2015 – May 15, 2015 • Phase 2: May 16, 2015 – May 29, 2015 • Phase 3: May 30, 2015 – June 12, 2015 • Phase 4: June 13, 2015 – July 3, 2015 • Phase 5: July 4, 2015 – July 24, 2015 • Phase 6 / 7: July 25, 2015 – August 25, 2015 Project Schedule

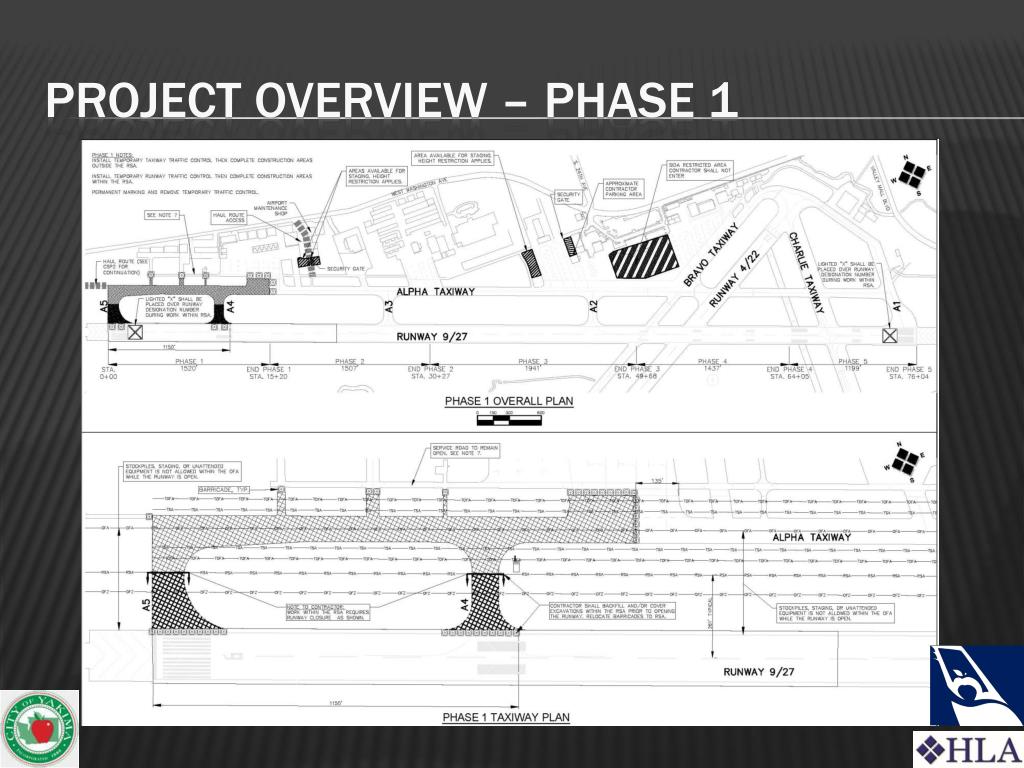

Phase 1:April 20, 2015 – May 15, 2015 • Ramp Closures. • McCormick West, and Plath Hangar. • Partial Ramp Closures. • Fuel Tank/House and McCormick Air Center. • Temporary Runway 9/27 Closure for work within the Runway Safety Area. • On-going construction activities and vehicle traffic on service roads and ramps. Impacts

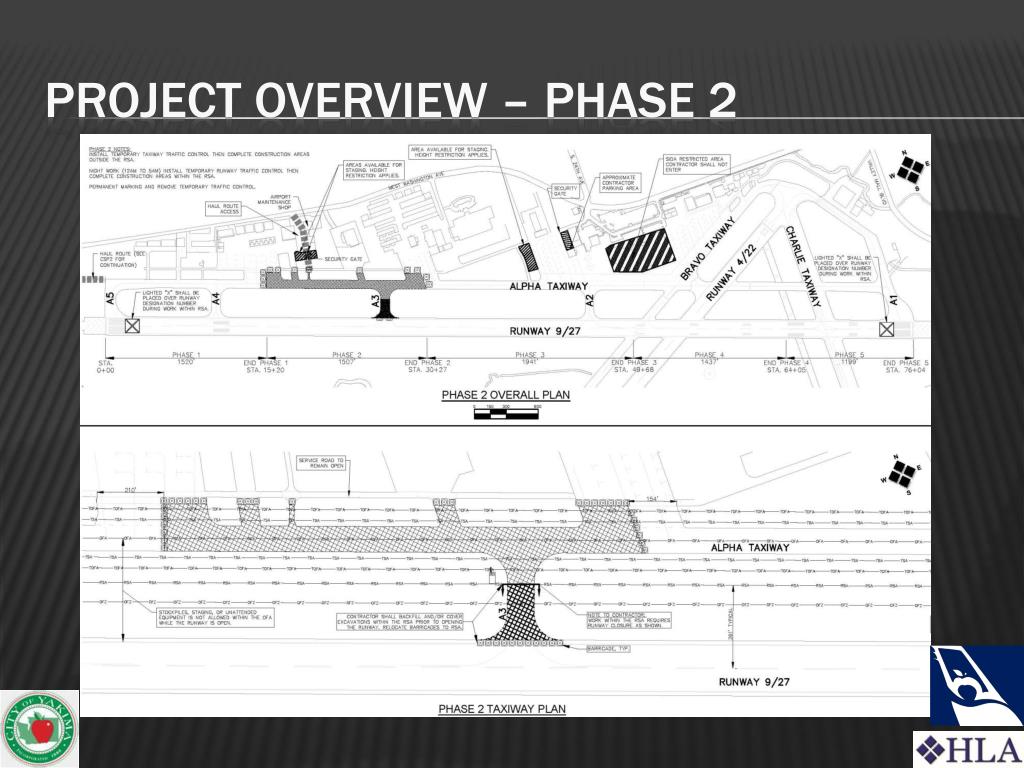

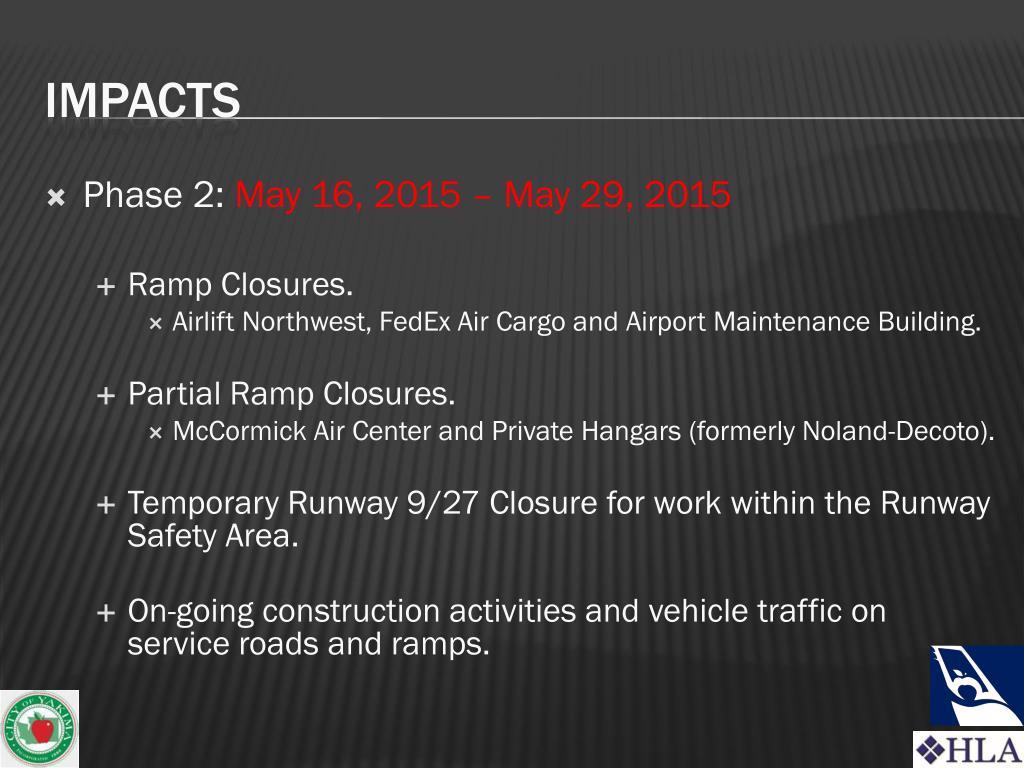

Phase 2: May 16, 2015 – May 29, 2015 • Ramp Closures. • Airlift Northwest, FedEx Air Cargo and Airport Maintenance Building. • Partial Ramp Closures. • McCormick Air Center and Private Hangars (formerly Noland-Decoto). • Temporary Runway 9/27 Closure for work within the Runway Safety Area. • On-going construction activities and vehicle traffic on service roads and ramps. Impacts

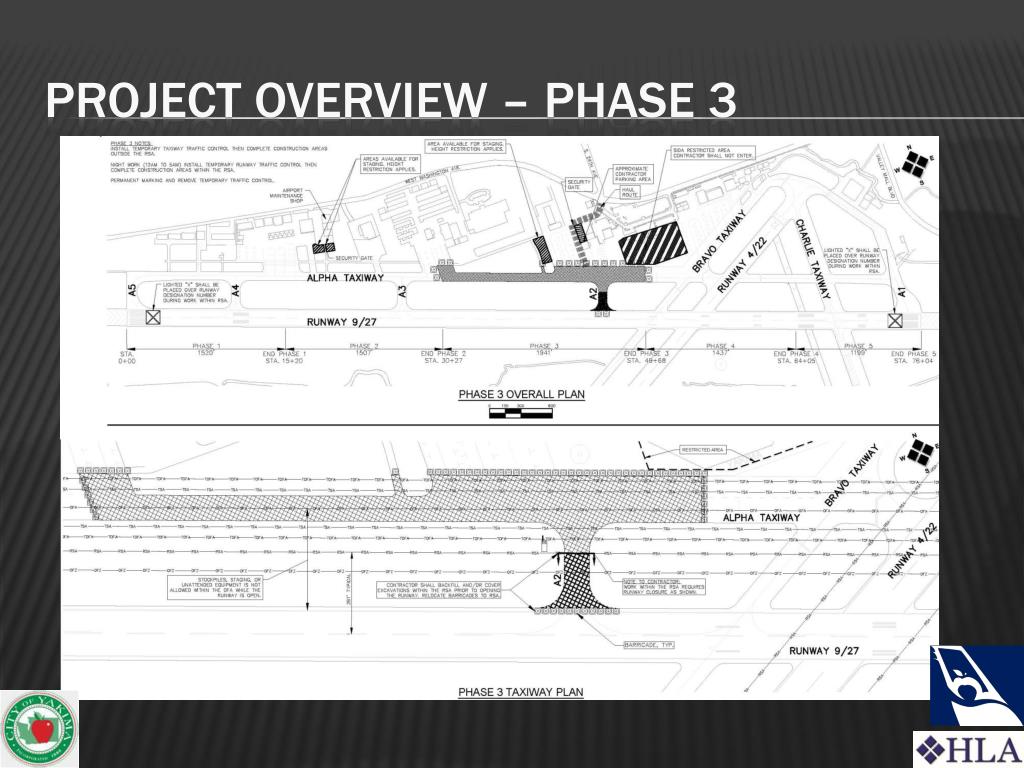

Phase 3: May 30, 2015 – June 12, 2015 • Ramp Closures. • GE Aviation, West Itinerant Ramp, Med Assets, and West Terminal Apron Ramp. • Partial Ramp Closures. • Private Hangars (formerly Noland-Decoto). • Temporary Runway 9/27 Closure for work within the Runway Safety Area. • On-going construction activities and vehicle traffic on service roads and ramps. Impacts

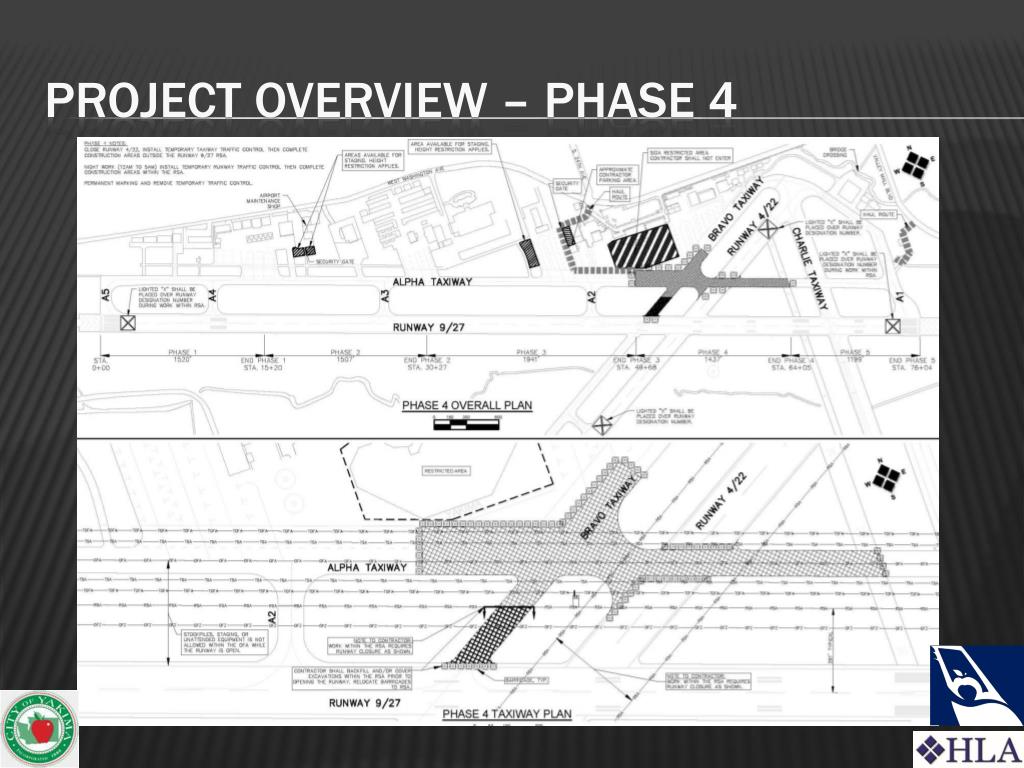

Phase 4: June 13, 2015 – July 3, 2015 • Ramp Closures. • East Terminal Apron Ramp. • Partial Ramp Closures. • East Itinerant Ramp. • Runway 4/22 and Bravo Taxiway Closed. • Temporary Runway 9/27 Closure for work within the Runway Safety Area. • On-going construction activities and vehicle traffic on service roads and ramps. Impacts

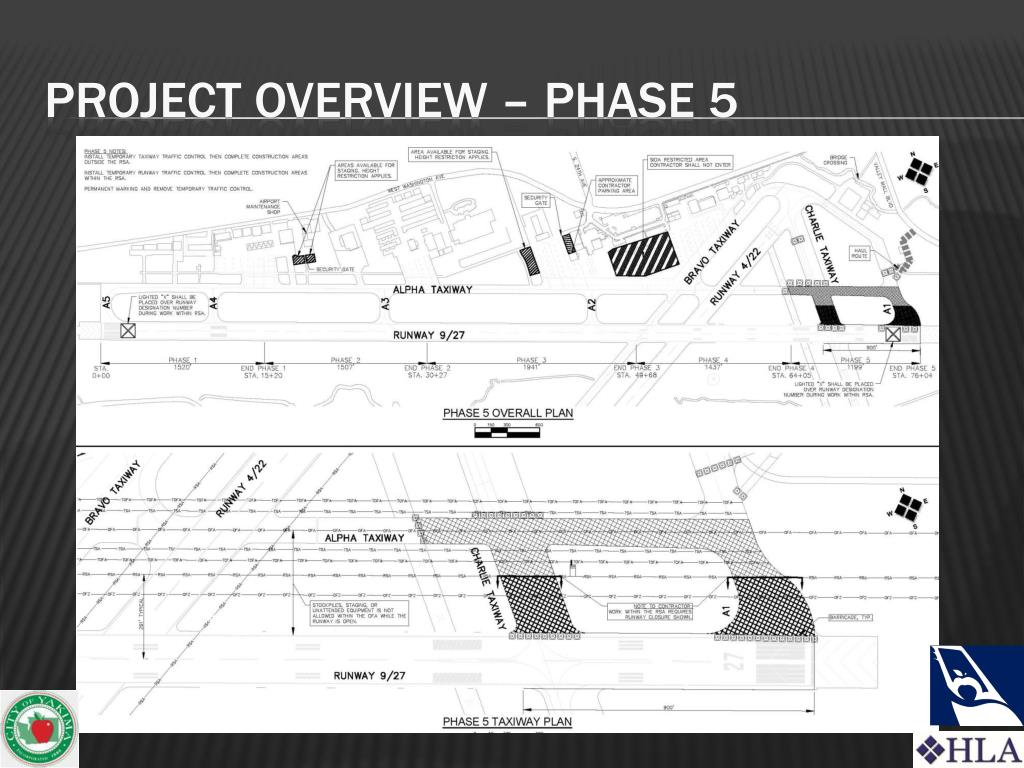

Phase 5: July 4, 2015 – July 24, 2015 • Ramp Closures. • No Ramps Closed. • Alternate routes required for: Cub Crafters, McAllister Museum, Advanced Medical Systems, and South Air Park. • Temporary Runway 9/27 Closure for work within the Runway Safety Area. • On-going construction activities and vehicle traffic on service roads and ramps. Impacts

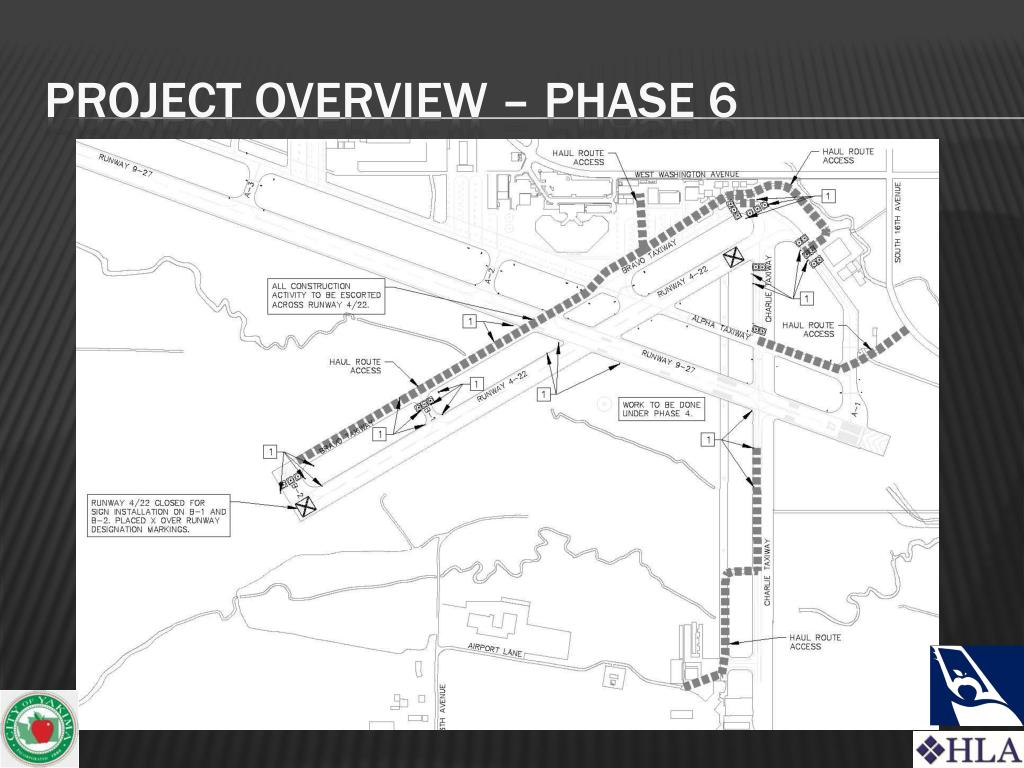

Phase 6: July 25, 2015 – August 25, 2015 • Partial Ramp closures denoted by barricades. • Runway 4/22 closed intermittently. • On-going construction activity and vehicle traffic on service roads and taxiways. Impacts

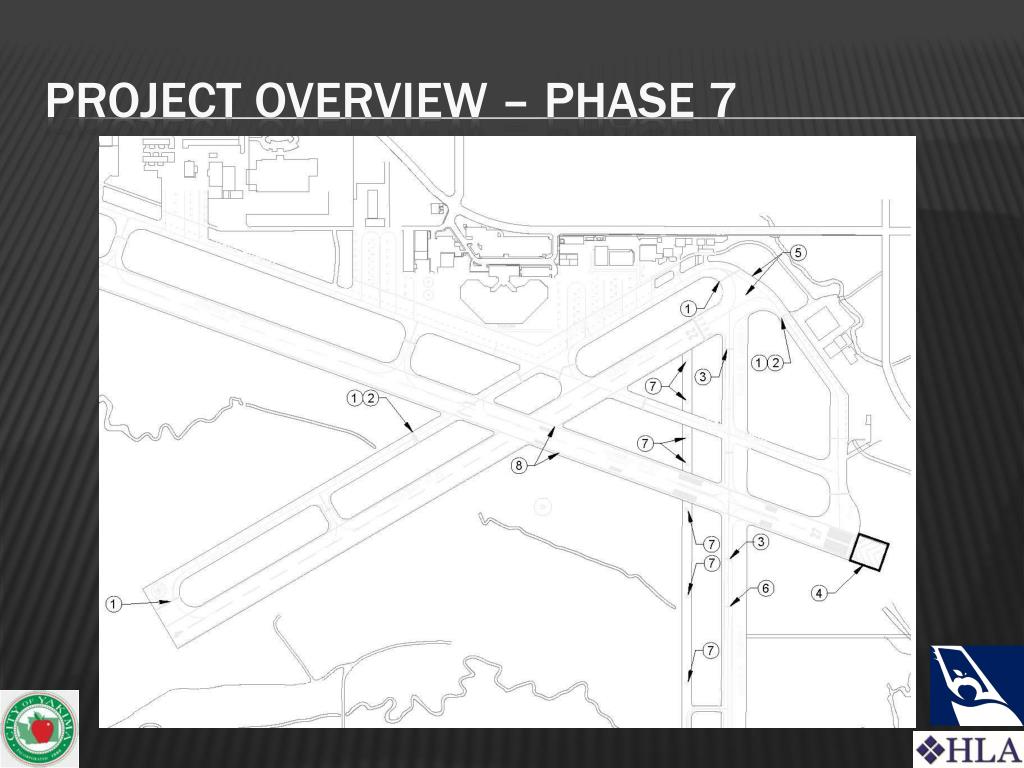

Phase 7: July 25, 2015 – August 25, 2015 • Not expecting any closures, however a schedule will be provided of the impacted areas to minimize air traffic and vehicle operations within the work areas. • On-going construction activities and vehicle traffic on service roads and ramps. Impacts
If at all possible, avoid construction areas. • Please plan all operations around construction to the maximum extent possible. • If there are known operations that will be impacted by the proposed schedule, please let us know. • The Airport Management will provide NOTAMs. • Do not travel (plane or car) across barricades delineating closed pavement. • Do not provide direction to the contractor unless there is an emergency. Operations During Construction
Robert Peterson Rob.Peterson@yakimaairterminal.com Office: (509) 575-6149 (#7) Cell: (509) 833-0898 Kris Yalovich Kris.Yalovich@yakimaairterminal.com Office: (509) 575-6149 (#7) Stephanie Ray, PE sray@hlacivil.com (509) 966-7000 Michael Battle, PE mbattle@hlacivil.com (509) 966-7000 Questions
