Implementation of Project Governance at the Center Level

Implementation of Project Governance at the Center Level. James Williams June 29, 2010. Outline. Project Governance – what is it? Why do we need Project Governance? How did we implement IT Project Governance at NASA Ames? Lessons learned. IT Project Governance – what is it?.

brook
Download Presentation

Implementation of Project Governance at the Center Level

An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript

  1. Implementation of Project Governanceat the Center Level James Williams June 29, 2010

  2. Outline • Project Governance – what is it? • Why do we need Project Governance? • How did we implement IT Project Governance at NASA Ames? • Lessons learned Implementation of Project Governanceat the Center Level—2—June 29, 2010

  3. IT Project Governance – what is it? • The leadership, structures and processes to ensure that IT sustains and extends the organization's strategy and objectives • In other words – playing an active role in IT Projects success Implementation of Project Governanceat the Center Level—3—June 29, 2010

  4. IT Project Governance – what is it? • Playing an active role in project success includes: • Framework • Processes • Systems and tools • Transparency • Accountability • Stakeholders involvement in decisions • Expectations, control, performance • Risk management Implementation of Project Governanceat the Center Level—4—June 29, 2010

  5. IT Project Governance – what is it? • The organizational structure to support Project Governance entails: • Oversight • Project review board • Decision making body - voting • Financial transparency and control Implementation of Project Governanceat the Center Level—5—June 29, 2010

  6. Yes, governance can and does bring the RED TAPE that may slow an organization and its projects down to a halt.Our resources are constrained already!So why did we need it?! Implementation of Project Governanceat the Center Level—6—June 29, 2010

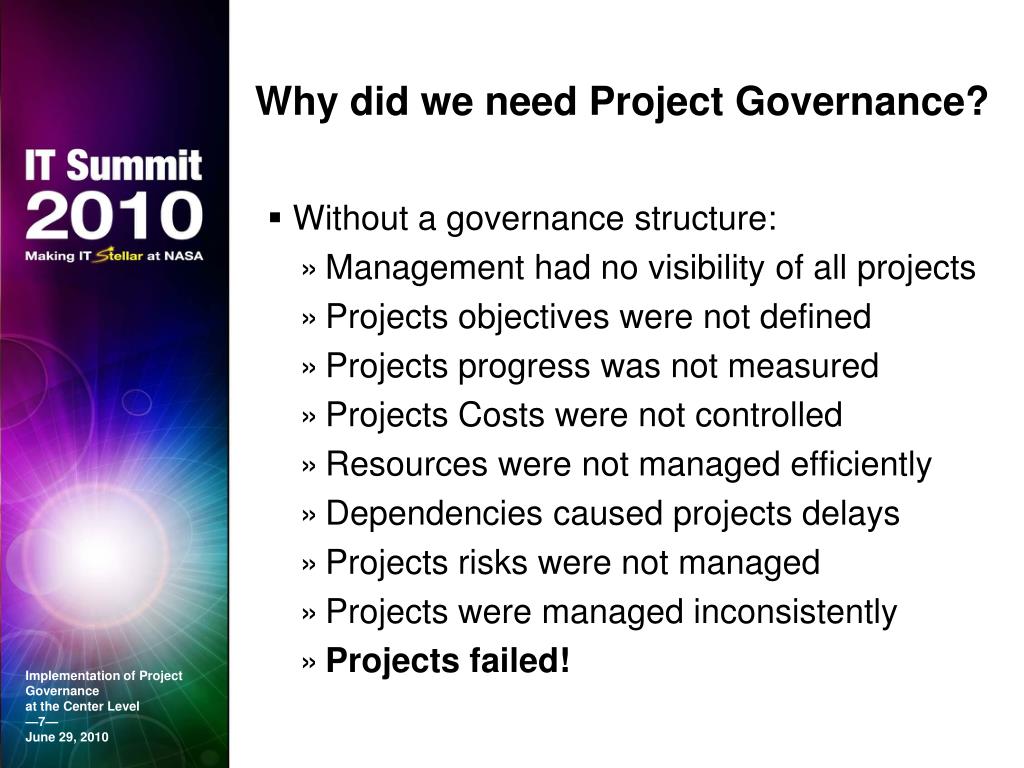

  7. Why did we need Project Governance? • Without a governance structure: • Management had no visibility of all projects • Projects objectives were not defined • Projects progress was not measured • Projects Costs were not controlled • Resources were not managed efficiently • Dependencies caused projects delays • Projects risks were not managed • Projects were managed inconsistently • Projects failed! Implementation of Project Governanceat the Center Level—7—June 29, 2010

  8. It was time for a CHANGE! Implementation of Project Governanceat the Center Level—8—June 29, 2010

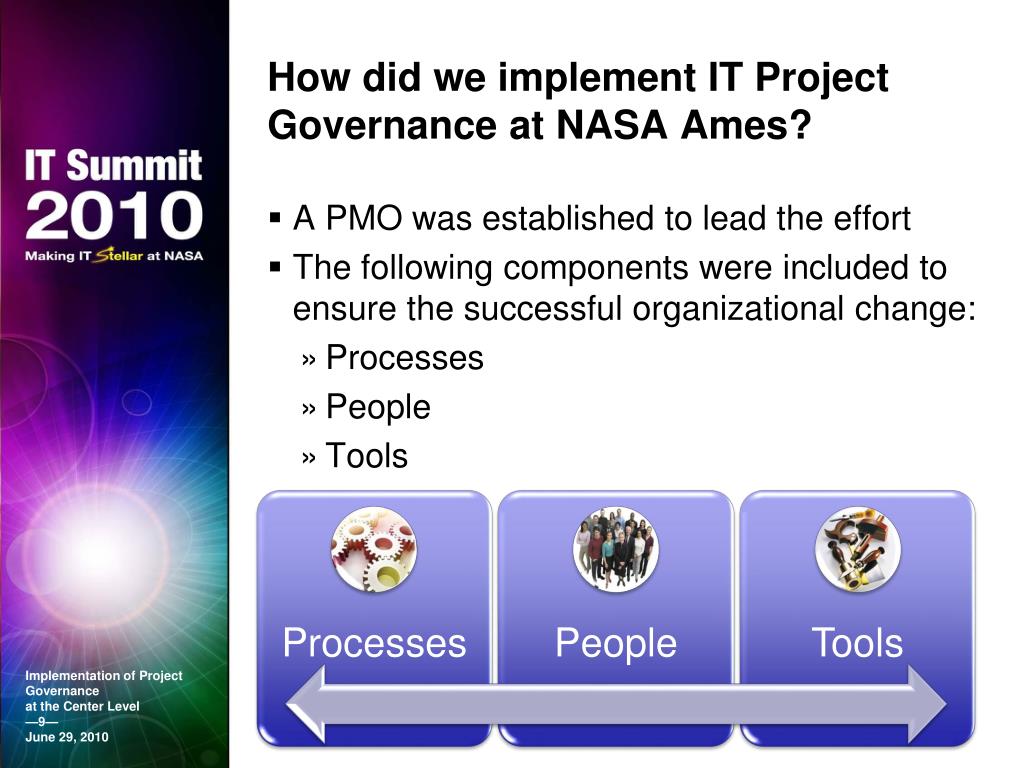

  9. How did we implement IT Project Governance at NASA Ames? • A PMO was established to lead the effort • The following components were included to ensure the successful organizational change: • Processes • People • Tools Implementation of Project Governanceat the Center Level—9—June 29, 2010

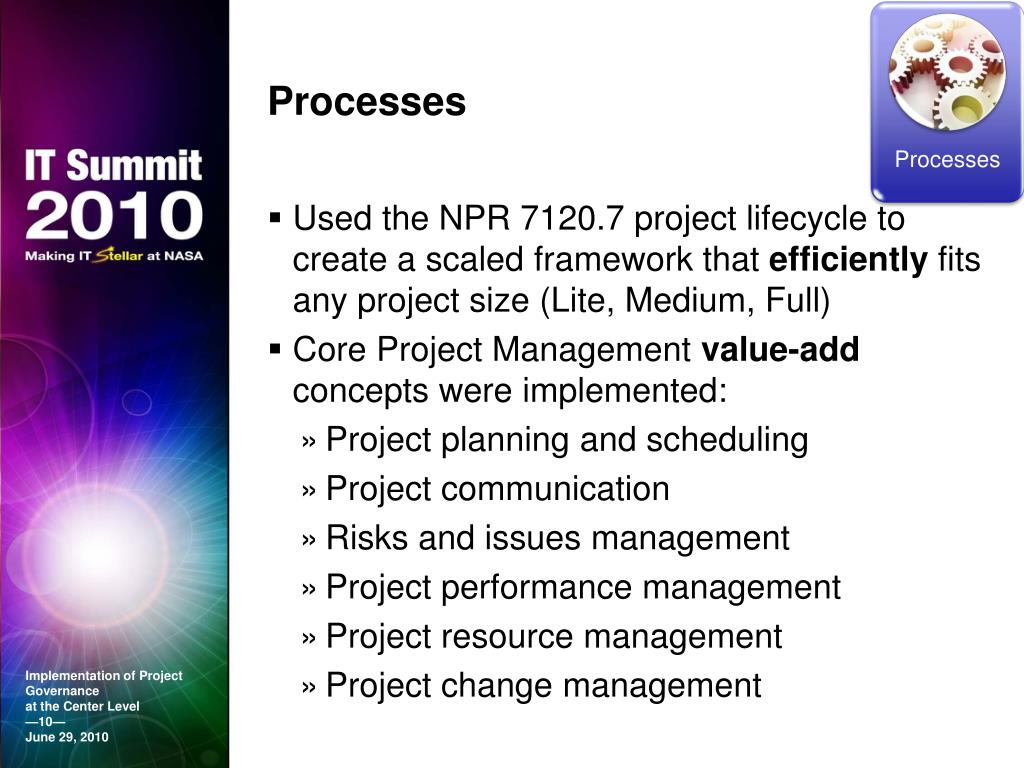

  10. Processes • Used the NPR 7120.7 project lifecycle to create a scaled framework that efficiently fits any project size (Lite, Medium, Full) • Core Project Management value-add concepts were implemented: • Project planning and scheduling • Project communication • Risks and issues management • Project performance management • Project resource management • Project change management Processes Implementation of Project Governanceat the Center Level—10—June 29, 2010

  11. People • Code I ITPMB was established as the governance body for all Code I projects. Members include all the Directorate senior management who meet monthly to vote and decide on projects KDPs, review projects status, cost, schedule, and risks • PMO core and PM staff are all professional project managers, trained and mentored • PM working group includes representatives from across the organization who provide feedback on PM processes before rollout • PM community forum consists of all project managers to discuss relevant topics People Implementation of Project Governanceat the Center Level—11—June 29, 2010

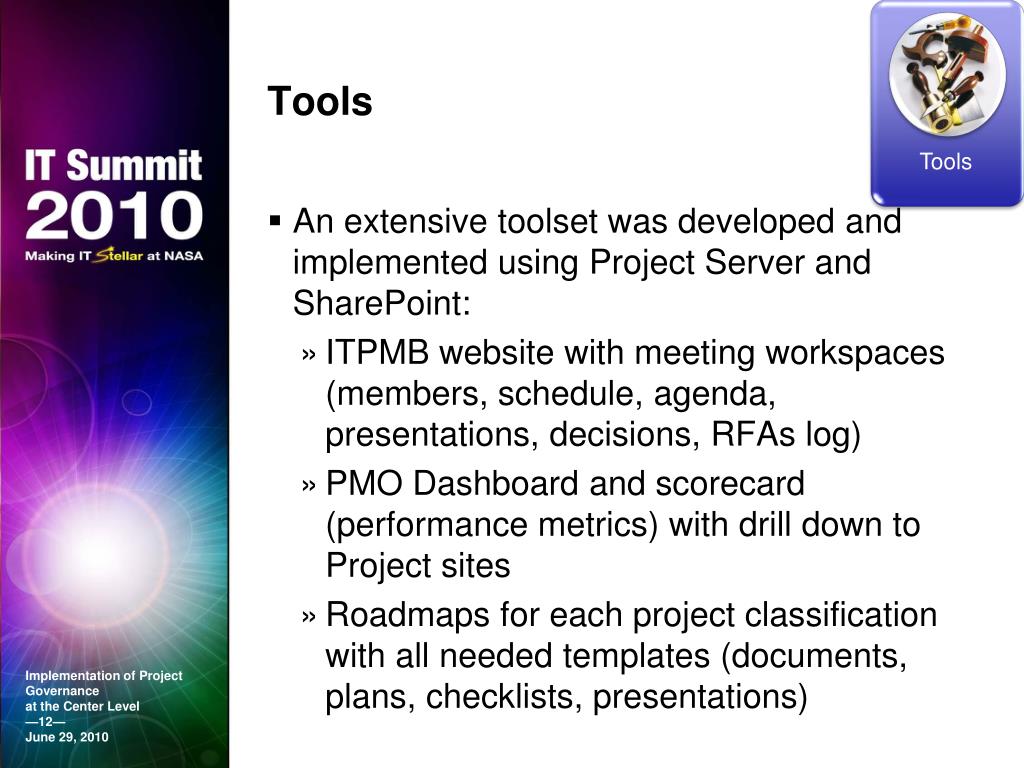

  12. Tools • An extensive toolset was developed and implemented using Project Server and SharePoint: • ITPMB website with meeting workspaces (members, schedule, agenda, presentations, decisions, RFAs log) • PMO Dashboard and scorecard (performance metrics) with drill down to Project sites • Roadmaps for each project classification with all needed templates (documents, plans, checklists, presentations) Tools Implementation of Project Governanceat the Center Level—12—June 29, 2010

  13. Tools – ITPMB Site Code I ITPMB details Tools Upcoming and previous meetings Code I ITPMB members Implementation of Project Governanceat the Center Level—13—June 29, 2010

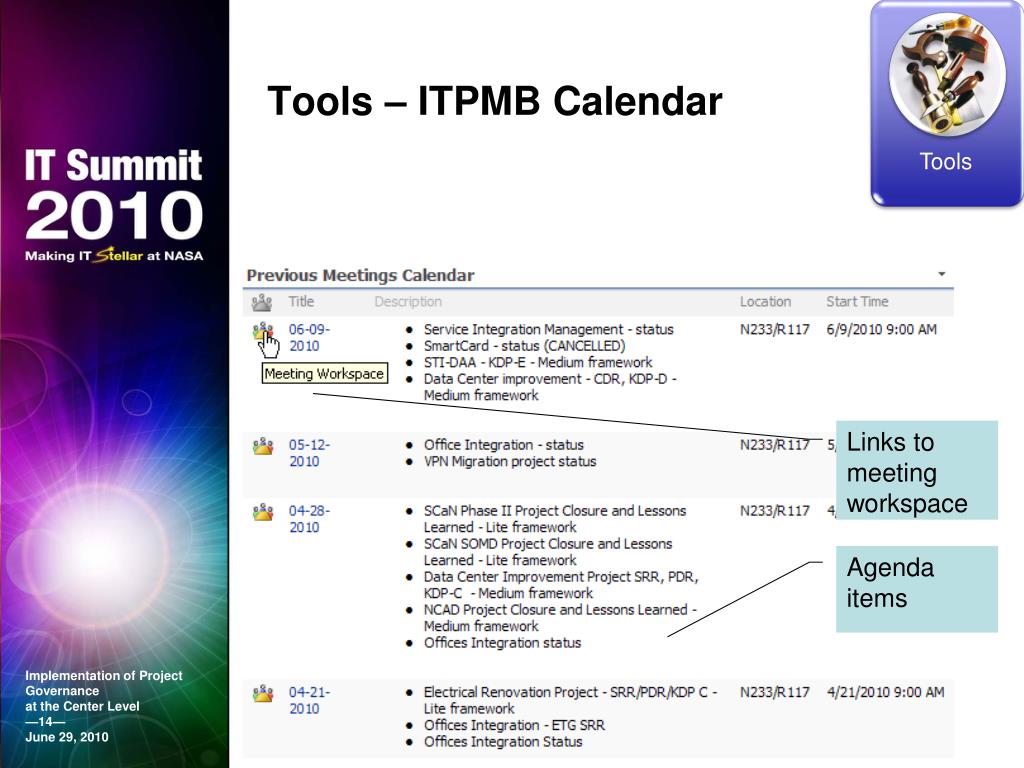

  14. Tools – ITPMB Calendar Tools Links to meeting workspace Agenda items Implementation of Project Governanceat the Center Level—14—June 29, 2010

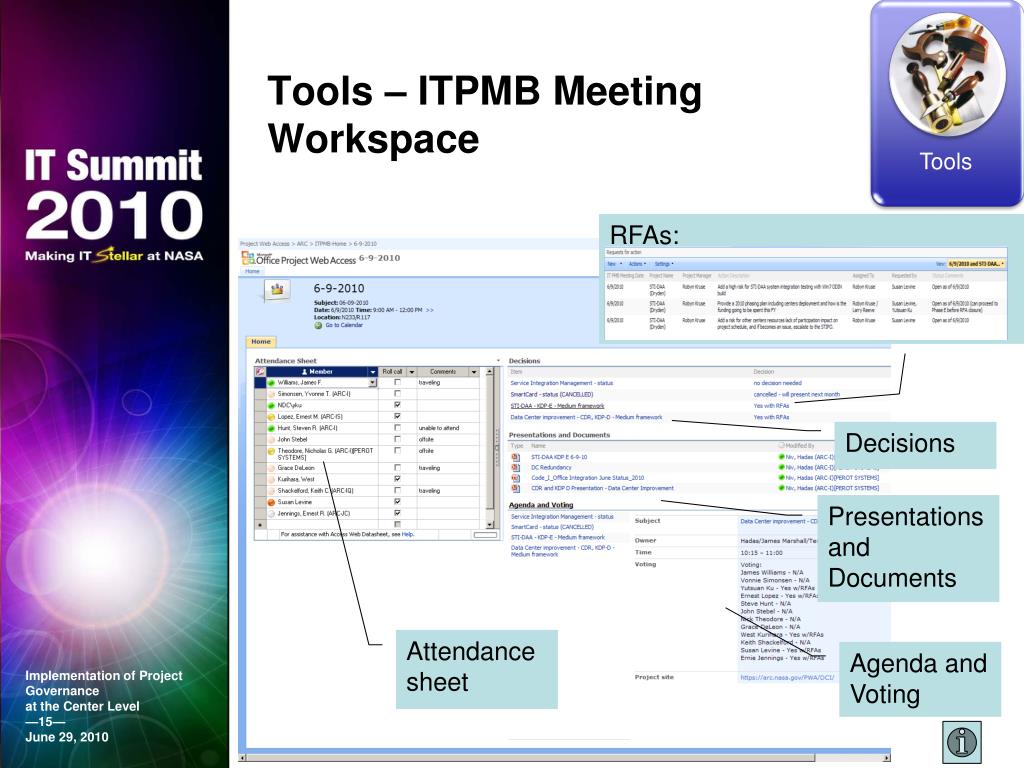

  15. Tools – ITPMB Meeting Workspace RFAs: Tools Decisions Presentations and Documents Attendance sheet Implementation of Project Governanceat the Center Level—15—June 29, 2010 Agenda and Voting

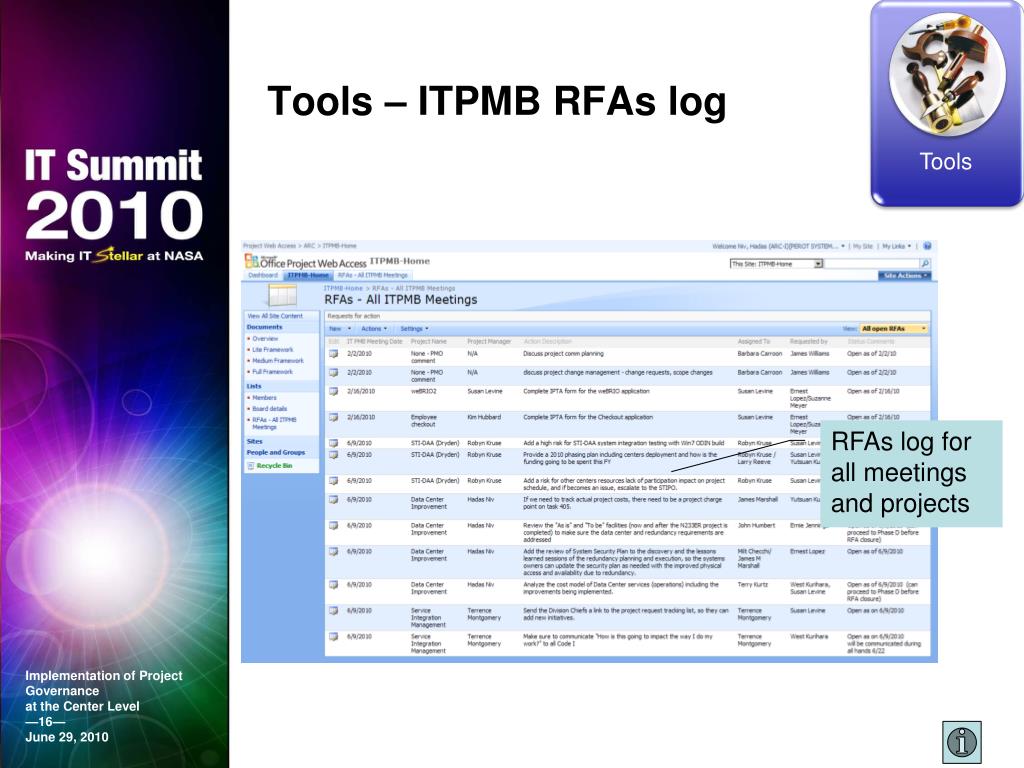

  16. Tools – ITPMB RFAs log Tools RFAs log for all meetings and projects Implementation of Project Governanceat the Center Level—16—June 29, 2010

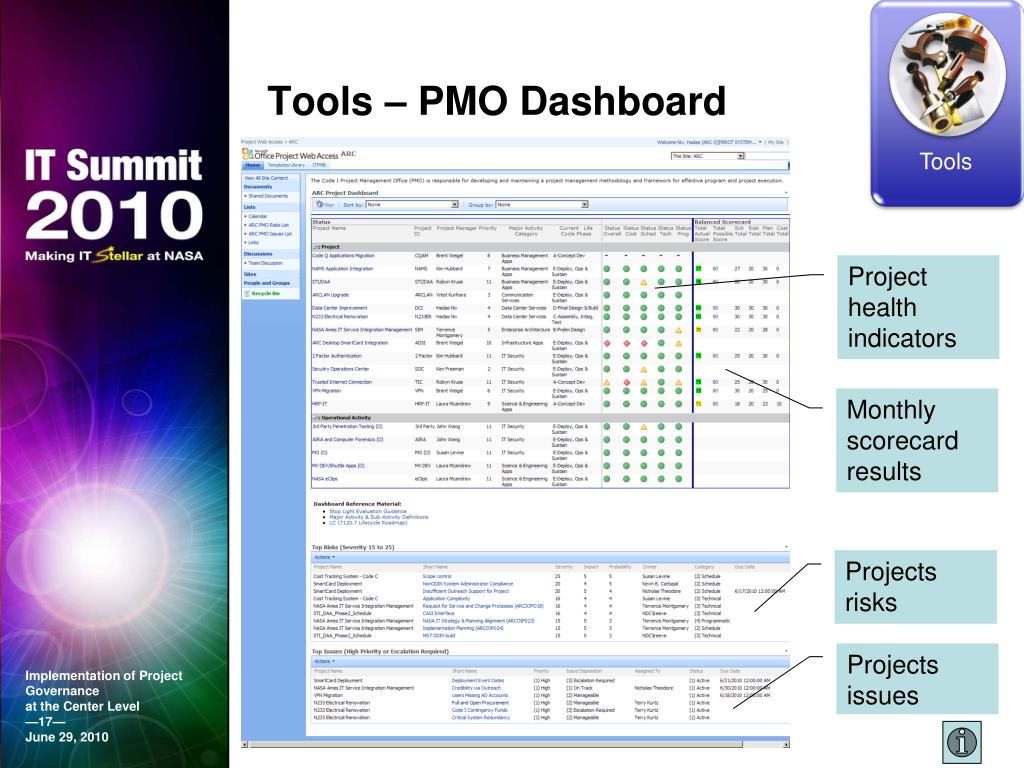

  17. Tools – PMO Dashboard Project health indicators Tools Monthly scorecard results Projects risks Implementation of Project Governanceat the Center Level—17—June 29, 2010 Projects issues

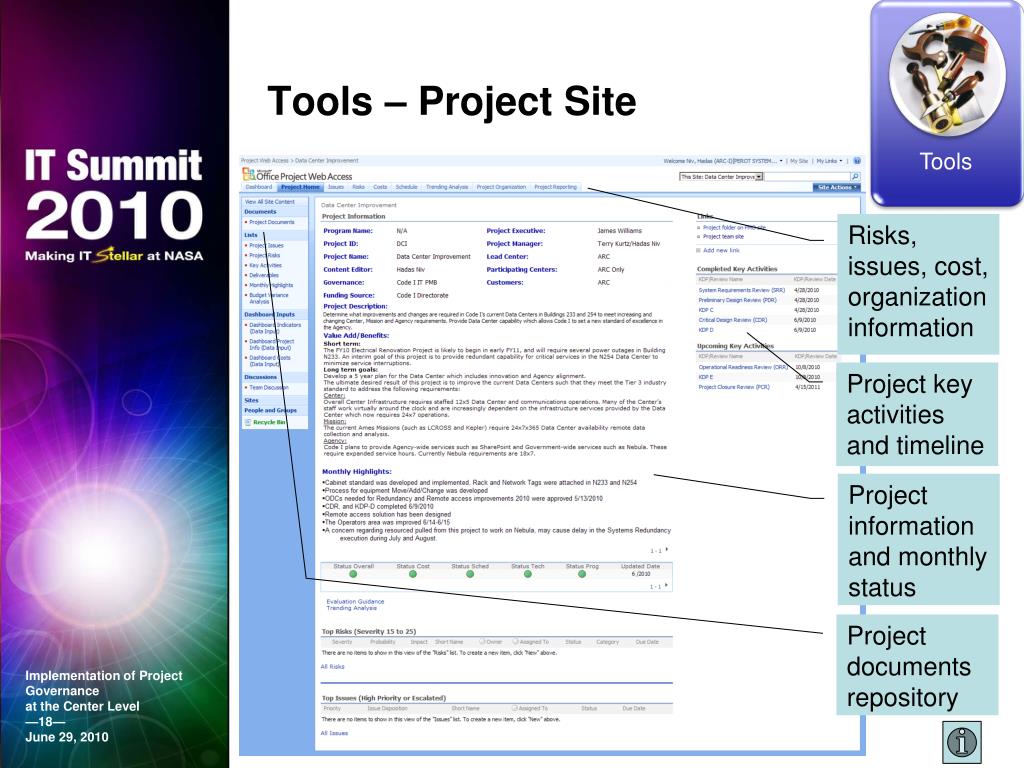

  18. Tools – Project Site Risks, issues, cost, organization information Tools Project key activities and timeline Project information and monthly status Project documents repository Implementation of Project Governanceat the Center Level—18—June 29, 2010

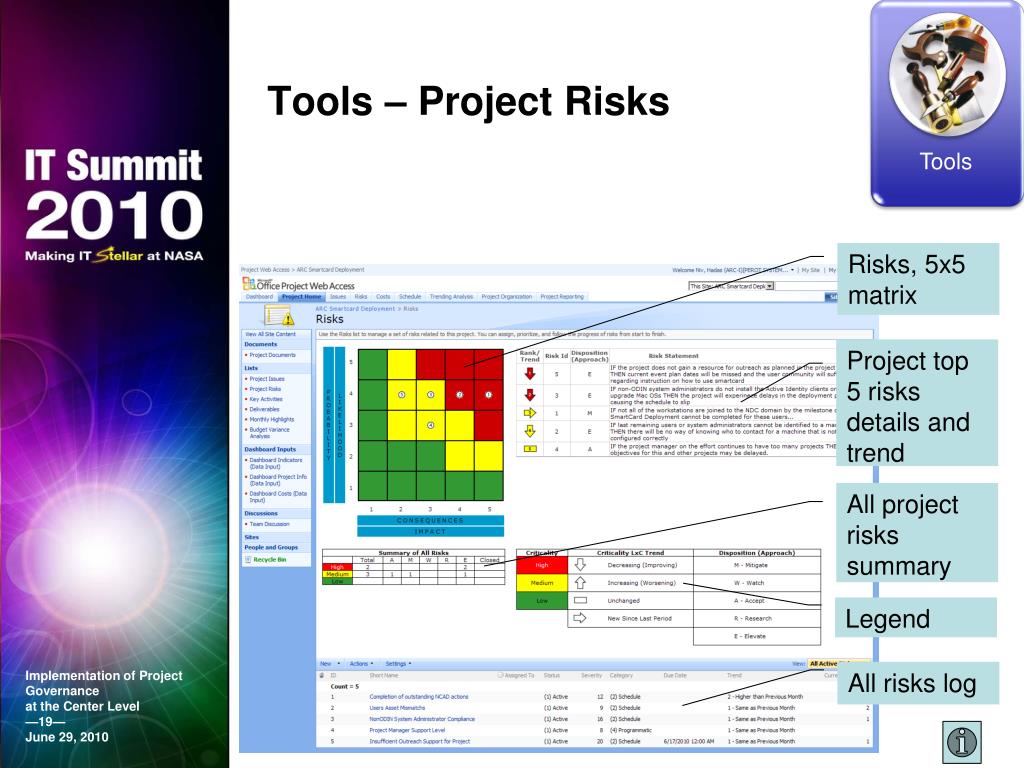

  19. Tools – Project Risks Risks, 5x5 matrix Tools Project top 5 risks details and trend All project risks summary Legend Implementation of Project Governanceat the Center Level—19—June 29, 2010 All risks log

  20. Tools – PMO Framework and Templates Library Project roadmaps: Lite, Medium, Full Tools Lifecycle templates library Implementation of Project Governanceat the Center Level—20—June 29, 2010

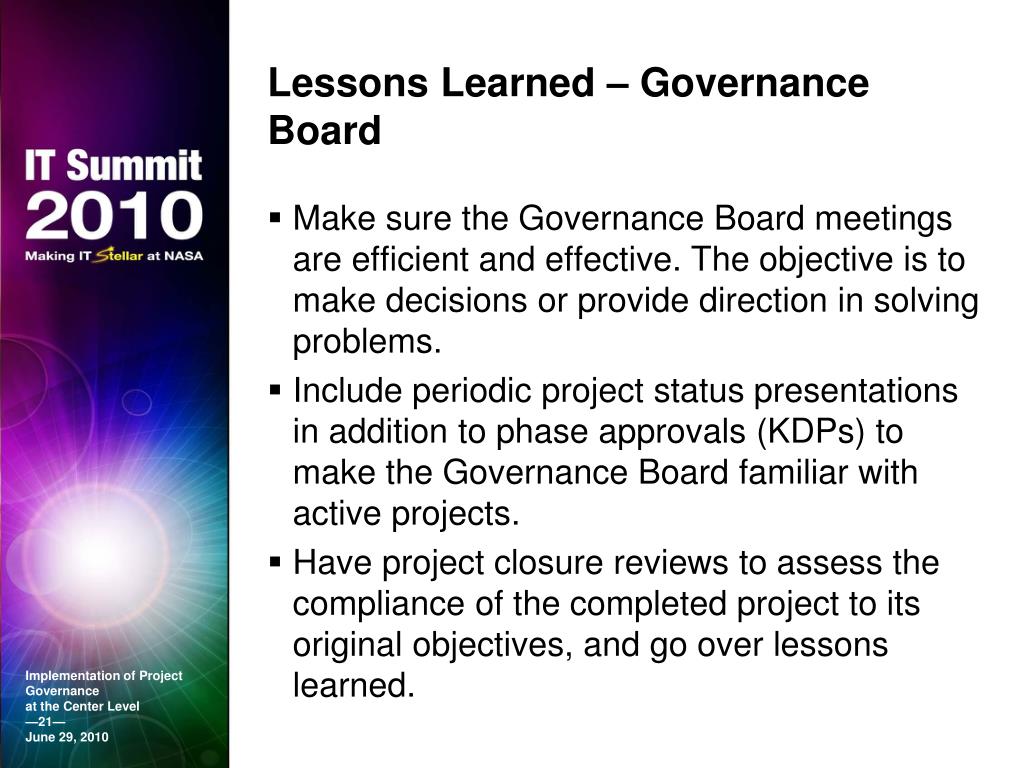

  21. Lessons Learned – Governance Board • Make sure the Governance Board meetings are efficient and effective. The objective is to make decisions or provide direction in solving problems. • Include periodic project status presentations in addition to phase approvals (KDPs) to make the Governance Board familiar with active projects. • Have project closure reviews to assess the compliance of the completed project to its original objectives, and go over lessons learned. Implementation of Project Governanceat the Center Level—21—June 29, 2010

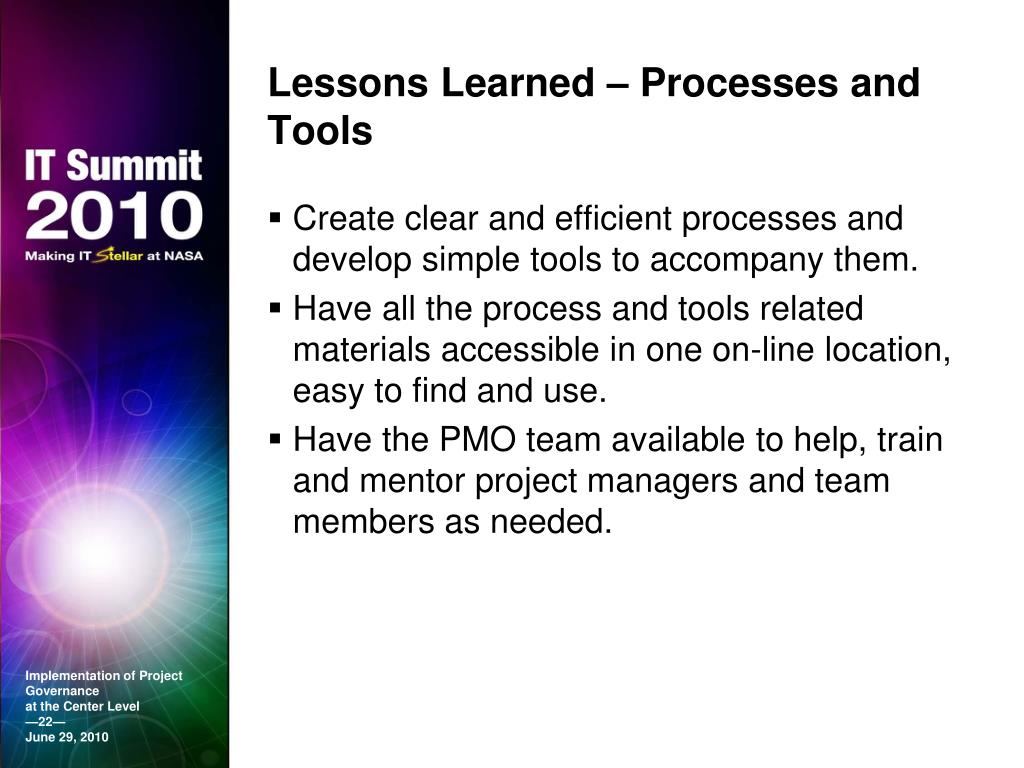

  22. Lessons Learned – Processes and Tools • Create clear and efficient processes and develop simple tools to accompany them. • Have all the process and tools related materials accessible in one on-line location, easy to find and use. • Have the PMO team available to help, train and mentor project managers and team members as needed. Implementation of Project Governanceat the Center Level—22—June 29, 2010

  23. Lessons Learned – Visibility and Accuracy • Be prepared for increased projects visibility and transparency. Since governance entails knowing to a greater extent what is going on in the organization, more people become “interested” in the projects. • Ensure the reported information is as accurate as possible. When details are viewed by senior management and governance board members , any inconsistent, incomplete, or inaccurate data will be questioned. Implementation of Project Governanceat the Center Level—23—June 29, 2010

  24. Lessons Learned – Metrics • Adopt a Stoplight project health reporting format so the PMO and Governance Board will be able to look at a dashboard quickly and tell whether or not a project is on target or in jeopardy (cost, schedule, technology, etc.) • Track the metrics over time to check for trends. PMs should be prepared to justify the reported stoplight rating. • Use scorecard to rank project management deliverables. This approach is useful to ensure processes and tools have been effectively adopted by the organization. Implementation of Project Governanceat the Center Level—24—June 29, 2010

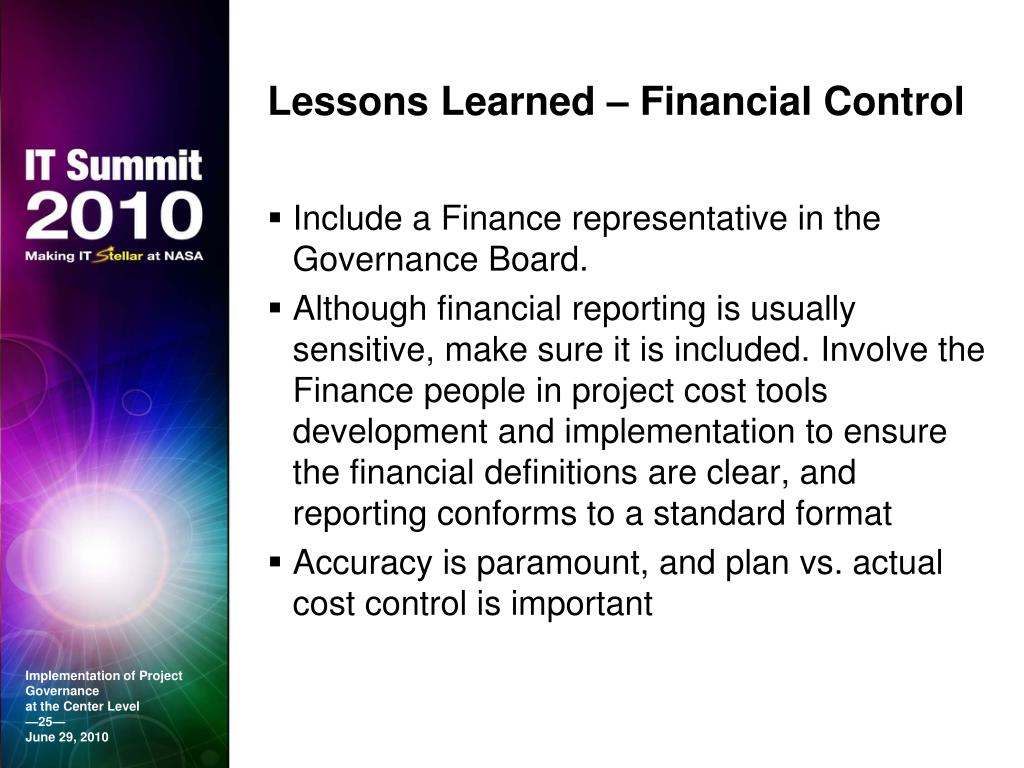

  25. Lessons Learned – Financial Control • Include a Finance representative in the Governance Board. • Although financial reporting is usually sensitive, make sure it is included. Involve the Finance people in project cost tools development and implementation to ensure the financial definitions are clear, and reporting conforms to a standard format • Accuracy is paramount, and plan vs. actual cost control is important Implementation of Project Governanceat the Center Level—25—June 29, 2010

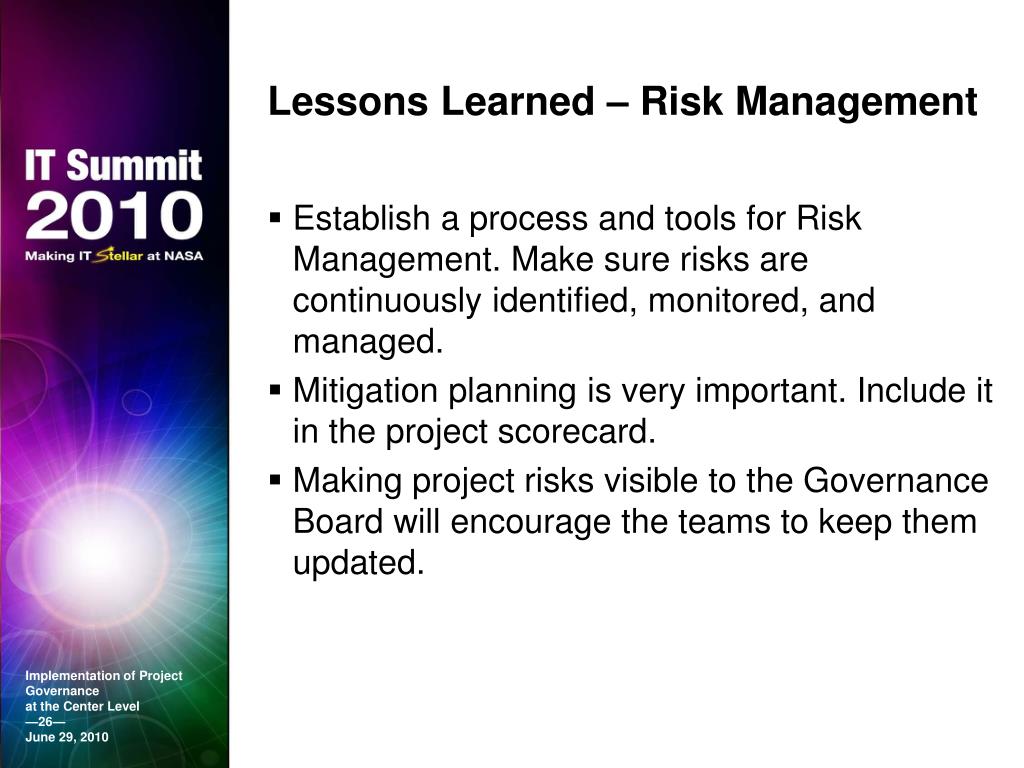

  26. Lessons Learned – Risk Management • Establish a process and tools for Risk Management. Make sure risks are continuously identified, monitored, and managed. • Mitigation planning is very important. Include it in the project scorecard. • Making project risks visible to the Governance Board will encourage the teams to keep them updated. Implementation of Project Governanceat the Center Level—26—June 29, 2010

  27. Questions?

  28. Take away – useful elements of IT project governance • A compelling business case, stating the objects of the project and specifying the in-scope and out-of-scope aspects • A mechanism to assess the compliance of the completed project to its original objectives • Identifying all stakeholders with an interest in the project • A defined method of communication to each stakeholder • A set of business-level requirements as agreed by all stakeholders • An agreed specification for the project deliverables • The appointment of a project manager • Clear assignment of project roles and responsibilities • A current, published project plan that spans all project stages from project initiation through development to the transition to operations. • A system of accurate upward status- and progress-reporting including time records. • A central document repository for the project • A centrally-held glossary of project terms • A process for the management and resolution of issues that arise during the project • A process for the recording and communication of risks identified during the project • A standard for quality review of the key governance documents and of the project deliverables. Implementation of Project Governanceat the Center Level—28—June 29, 2010
