Infrastructure Update As at 11 th March 2009

Infrastructure Update As at 11 th March 2009. Remaining four plates now fitted to North shield wall North & South walls and all galleries are considered complete Uneven floor under spectrometer platform not serious; simple fix done

bairn
Download Presentation

Infrastructure Update As at 11 th March 2009

An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript

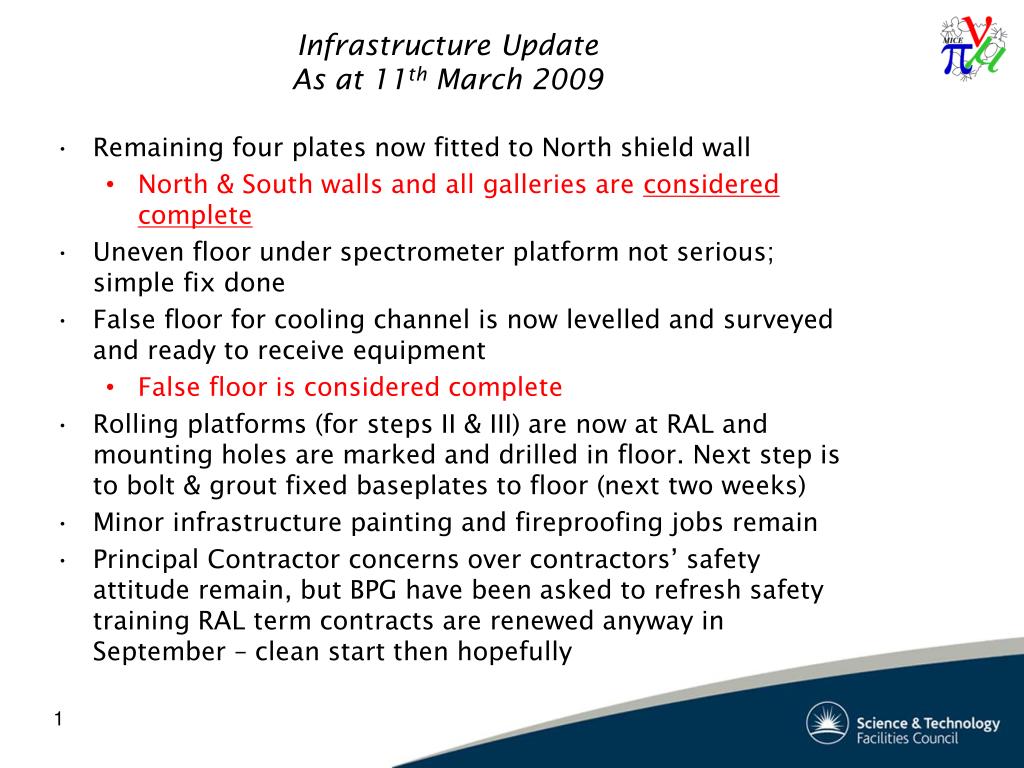

  1. Infrastructure UpdateAs at 11th March 2009 • Remaining four plates now fitted to North shield wall • North & South walls and all galleries are considered complete • Uneven floor under spectrometer platform not serious; simple fix done • False floor for cooling channel is now levelled and surveyed and ready to receive equipment • False floor is considered complete • Rolling platforms (for steps II & III) are now at RAL and mounting holes are marked and drilled in floor. Next step is to bolt & grout fixed baseplates to floor (next two weeks) • Minor infrastructure painting and fireproofing jobs remain • Principal Contractor concerns over contractors’ safety attitude remain, but BPG have been asked to refresh safety training RAL term contracts are renewed anyway in September – clean start then hopefully

  2. Infrastructure update • Electrical: • Good progress with 2MVA upgrade: highly detailed proposal and layout completed by DL staff – heroic effort • Next step is to submit to Andy Dickenson, MICE’s route to Operations Dept, to agree implementation • Cost is around £75K, but thirty-week lead time still applies, so a worry • Aim to meet with Andy D in early April • Air conditioning, lighting, fire protection making steady progress – no disasters • PPS: • Mandatory accreditation to IEC61508 (the relevant safety framework) has begun • Meeting arranged with external consultancy and ISIS • Aim to have PPS all finished by late Summer

  3. Infrastructure update • General: • MICE Hall needs overall interior re-decoration, more for cleanliness during integration & running than for appearance • RAL (BPG + WFL) pays, plan to take ‘holiday’ in August so painters can have free reign • Noise level in R5.2 is more than twice level above which ear protection obligatory – potentially a serious problem • Chief culprit is the Linde He plant • Short term is enforced PPE-wearing • Longer term, Mike Courthold has been asked to present MICE Technical Board with options for siting the Linde compressor outside R5.2

  4. Decay solenoid • Rather provisional schedule, hot off the press: • Warm up – 2/2 • Downstream MLI – 5/2 • Pump down – 12/2 • Cooldown – 19/2 • Measurements – 26/2 • Fix quench protection, etc 12/3 • Warm up – 1/4 • Remove Beamstopper – 4/4 • Add upstream MLI – 4/4 • Pump down – 13/4 • Cooldown – 20/4 • Powering test – 28/4 • Proper schedule/plan in progress, suggestion TB meets to discuss Mon 2nd Feb – wider audience review later in Feb.
