  1. Project Management (2) Chapter 16, Part 2

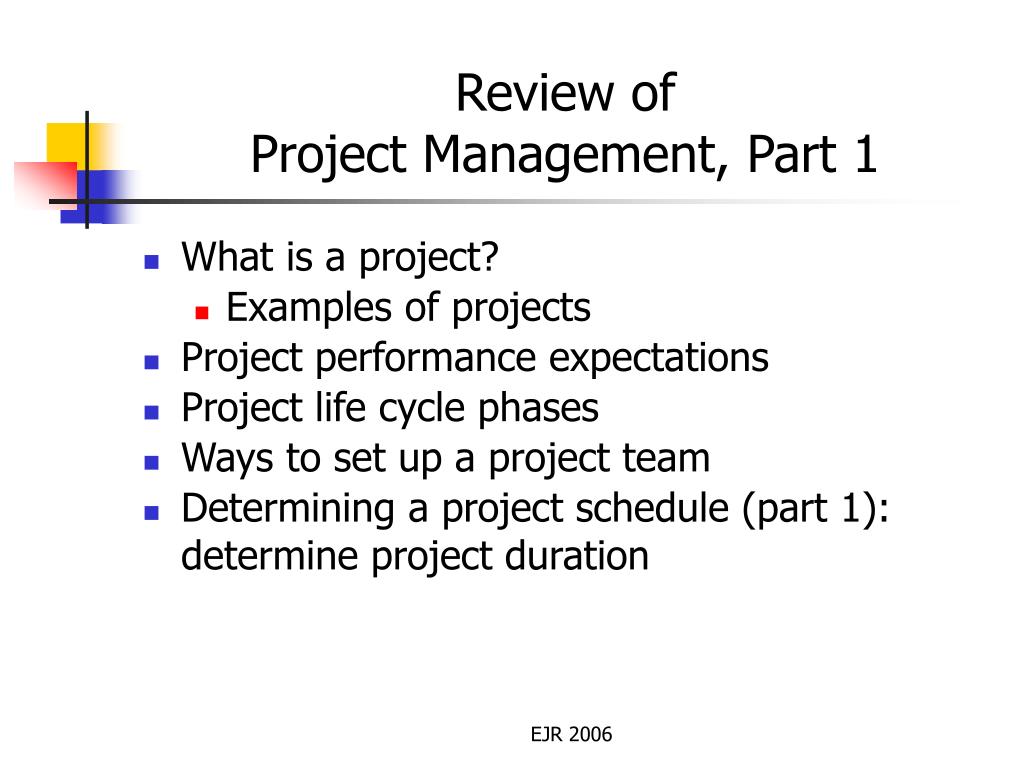

  2. Review ofProject Management, Part 1 • What is a project? • Examples of projects • Project performance expectations • Project life cycle phases • Ways to set up a project team • Determining a project schedule (part 1): determine project duration EJR 2006

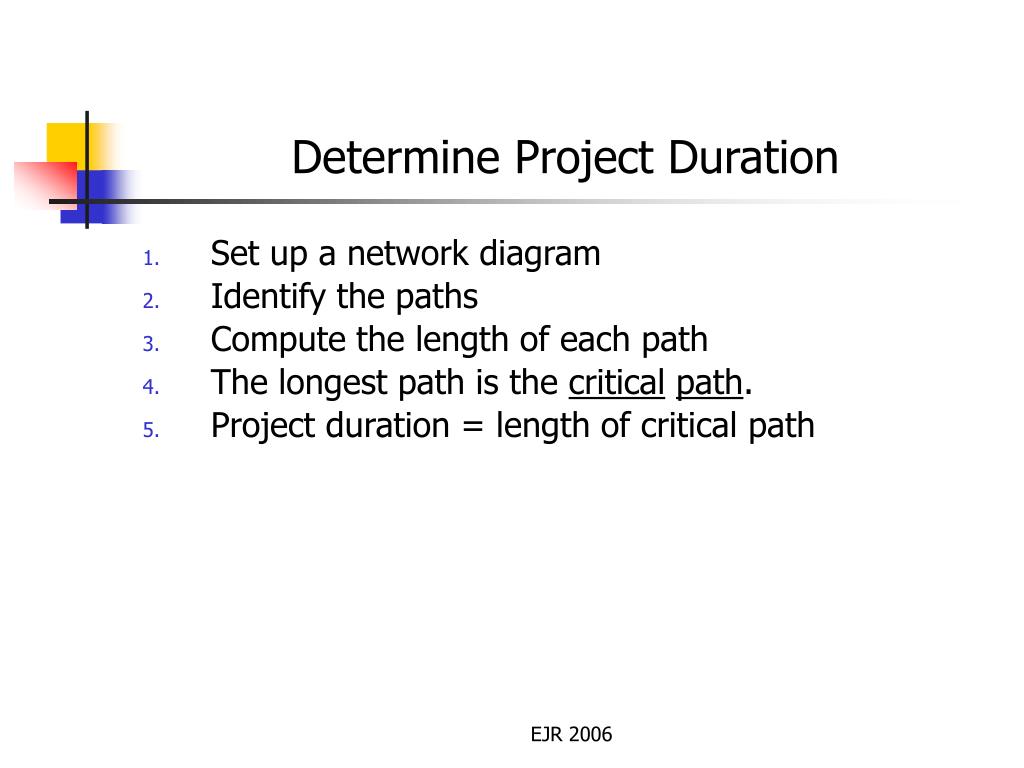

  3. Determine Project Duration • Set up a network diagram • Identify the paths • Compute the length of each path • The longest path is the criticalpath. • Project duration = length of critical path EJR 2006

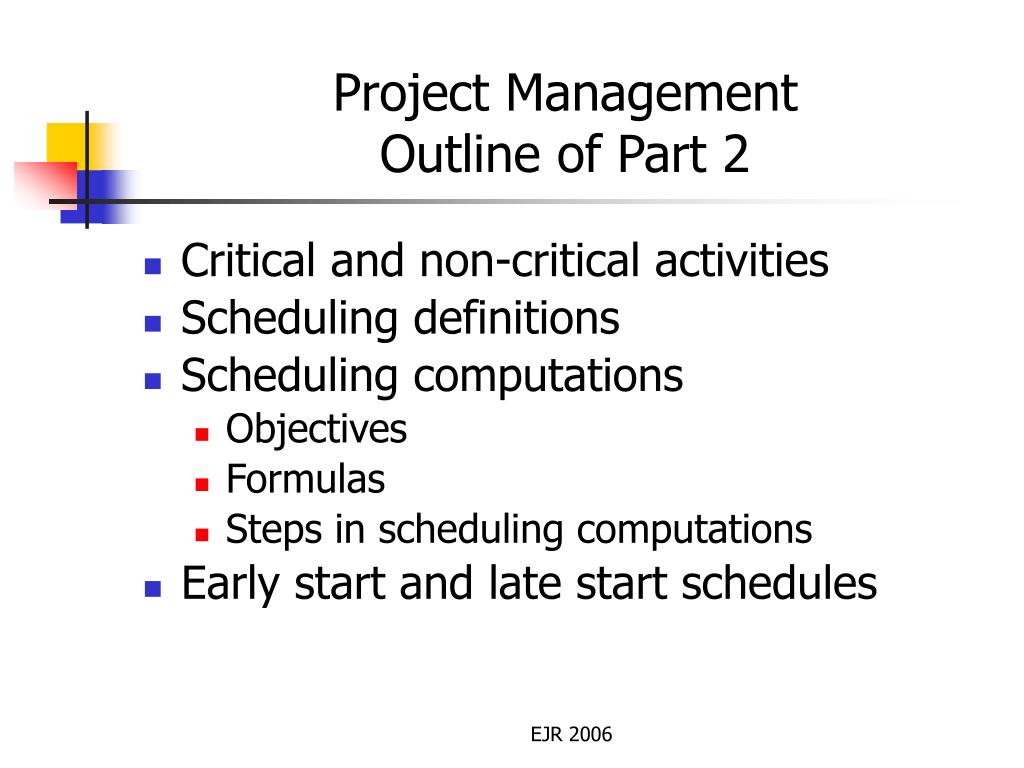

  4. Project ManagementOutline of Part 2 • Critical and non-critical activities • Scheduling definitions • Scheduling computations • Objectives • Formulas • Steps in scheduling computations • Early start and late start schedules EJR 2006

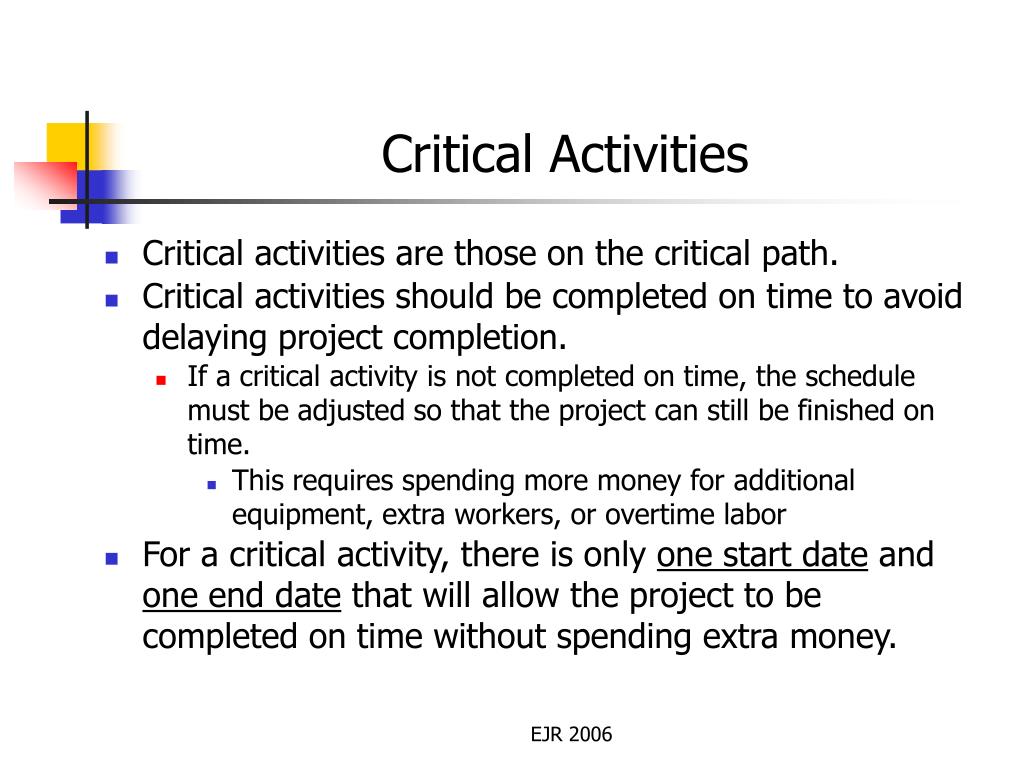

  5. Critical Activities • Critical activities are those on the critical path. • Critical activities should be completed on time to avoid delaying project completion. • If a critical activity is not completed on time, the schedule must be adjusted so that the project can still be finished on time. • This requires spending more money for additional equipment, extra workers, or overtime labor • For a critical activity, there is only one start date and one end date that will allow the project to be completed on time without spending extra money. EJR 2006

  6. Non-critical Activities • Non-critical activities are not on the critical path. • For a non-critical activity, there is a range of start dates and a range of end dates that will allow the project to be completed on time without spending extra money. • In scheduling non-critical activities, we can consider factors such as cash flow and resource availability. EJR 2006

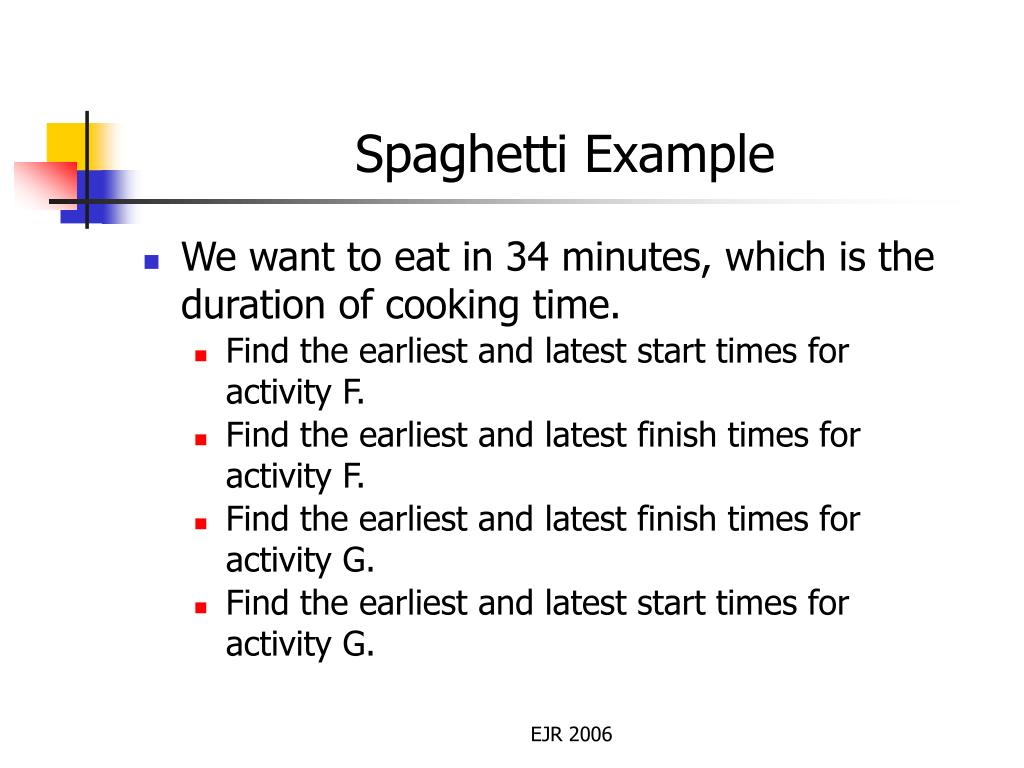

  7. Spaghetti Example • We want to eat in 34 minutes, which is the duration of cooking time. • Find the earliest and latest start times for activity F. • Find the earliest and latest finish times for activity F. • Find the earliest and latest finish times for activity G. • Find the earliest and latest start times for activity G. EJR 2006

  8. Scheduling Terms • For each activity in a project: • The early start (ES) is the earliest time that an activity can be started. • The early finish (EF) is the earliest time that an activity can be finished. • The late finish (LF) is the latest time that an activity can be finished. • The late start is the latest time that an activity can be started. EJR 2006

  9. Objectives of Scheduling Computations • To determine the acceptable start and end dates for each activity. • These computations can also be used to determine project duration and the critical path. • To provide a basis for developing a project schedule EJR 2006

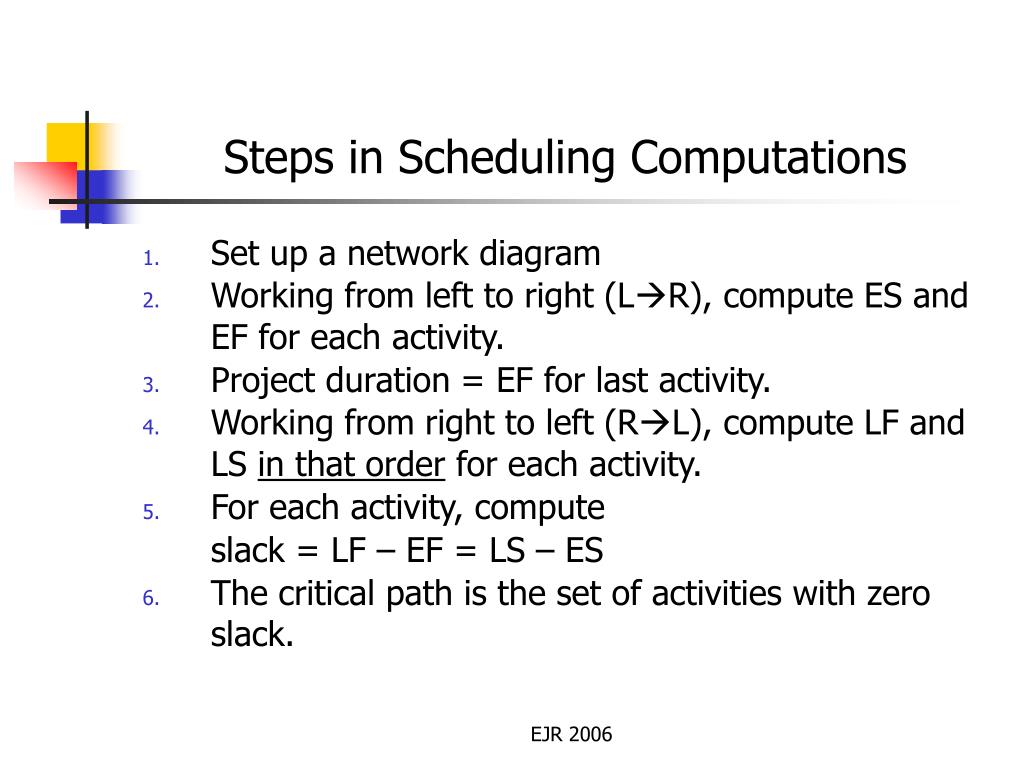

  10. Steps in Scheduling Computations • Set up a network diagram • Working from left to right (LR), compute ES and EF for each activity. • Project duration = EF for last activity. • Working from right to left (RL), compute LF and LS in that order for each activity. • For each activity, compute slack = LF – EF = LS – ES • The critical path is the set of activities with zero slack. EJR 2006

  11. Computing ES and EF • Work from left to right (LR) • For first activity, ES = 0 • For all other activities, ES = Largest {EF for immediately preceding activities} • For all activities, EF = ES + activity time (inside the circle or box) EJR 2006

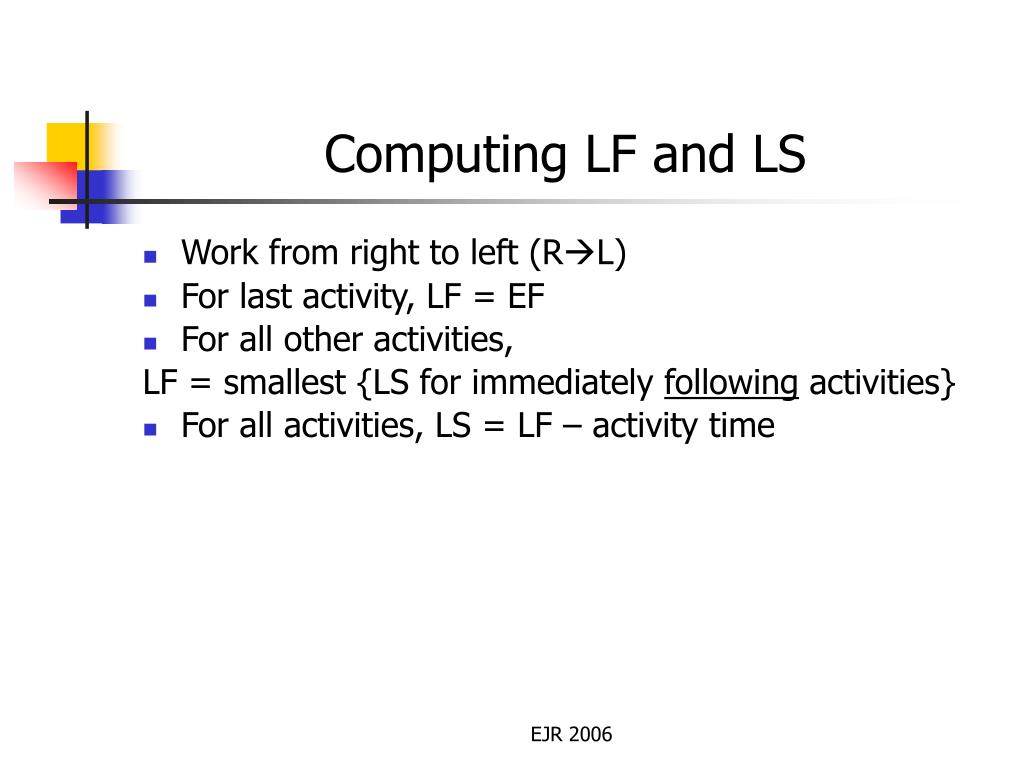

  12. Computing LF and LS • Work from right to left (RL) • For last activity, LF = EF • For all other activities, LF = smallest {LS for immediately following activities} • For all activities, LS = LF – activity time EJR 2006

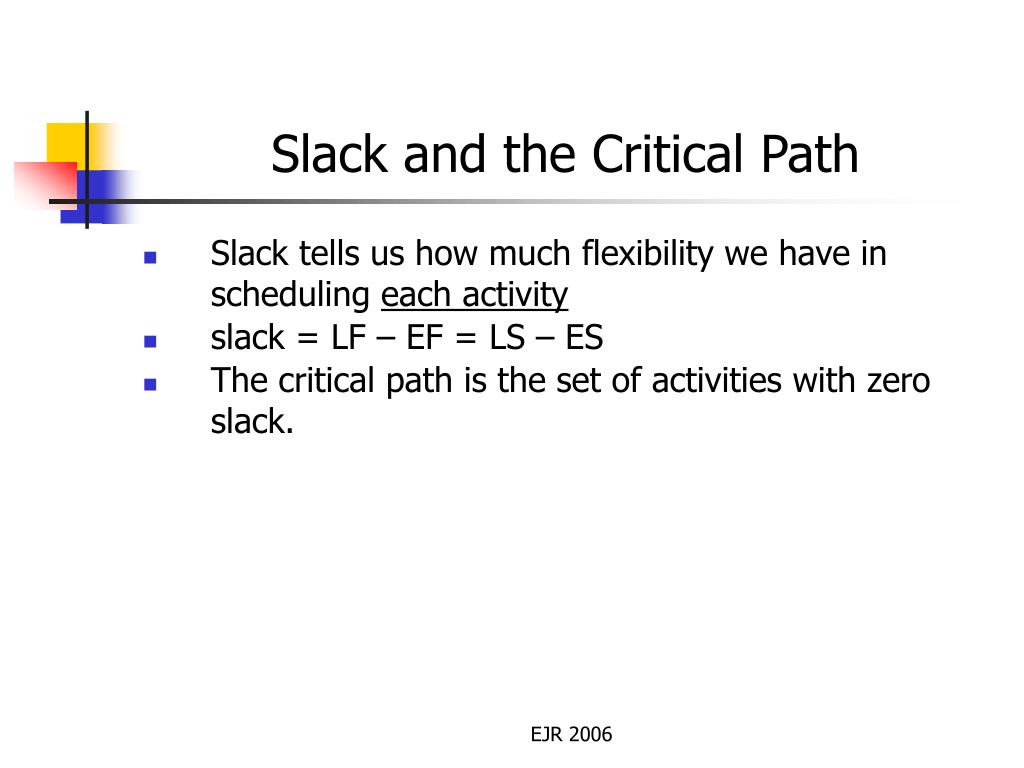

  13. Slack and the Critical Path • Slack tells us how much flexibility we have in scheduling each activity • slack = LF – EF = LS – ES • The critical path is the set of activities with zero slack. EJR 2006

  14. ES and LS Schedules • In an early start (ES) schedule, each activity begins at time ES and ends at time EF • In a late start (LS) schedule, each activity begins at time LS and ends at time LF • Other schedules may be possible. For all activities, we must have ES < start time < LS • The activity must start between ES and LS (inclusive) EJR 2006
