1 / 20

BPA Guidelines for Measurement & Verification of Energy Efficiency Measures

BPA Guidelines for Measurement & Verification of Energy Efficiency Measures. Presented at Brown Bag Session November 29, 2006. Reasons for M&V. BPA provides payments or credits to project sponsor for completion of projects that produce energy savings.

ismail
Download Presentation

BPA Guidelines for Measurement & Verification of Energy Efficiency Measures

An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript


  1. BPA Guidelines forMeasurement & Verification of Energy Efficiency Measures Presented at Brown Bag Session November 29, 2006

  2. Reasons for M&V • BPA provides payments or credits to project sponsor for completion of projects that produce energy savings. • Measurement & Verification methods are used to determine BPA’s payments or credits to a project sponsor. • M&V activities often lead to higher energy savings and greater persistence of savings.

  3. The M&V Plan • The M&V Plan is a key element in any Project Proposal. • During review, we focus on the M&V Plan much more than the estimated energy savings.

  4. Energy Savings are a reduction in electric energy consumption as a result of increased efficiency, beyond what would have occurred without the project. Energy Savings can only be determined by comparing Baseline Energy Use to Post-Project Energy Use Energy Savings = Baseline kWh/year – Post-Project kWh/year Key Concepts – Energy Savings

  5. Metered Power Salesvs.Calculated Energy Savings(Or, why you need M&V.)

  6. M&V Uncertainty • Measurement Error • Sampling Error • Weather • Changing Operating Schedules • Varying Loads • Changes in Setpoints • Changes in Use • Manual Overrides • Occupancy Changes • Production Levels Changes

  7. Key Concepts – Baseline • Baseline energy use must be established and agreed to prior to project approval. • Baselines may also be needed for weather, operating schedules etc. • Typical baseline period is one year.

  8. Key Concepts – MeasuredBaseline • Retrofits usually use existing conditions for the baseline. • Existing Conditions can be measured, …….but only before the project begins! • The period of the measurement is usually set long enough to capture operational cycles, but not seasonal weather cycles; typically 1 to 2 weeks.

  9. Key Concepts – HypotheticalBaseline • New construction, planned replacements, and major remodels require a hypothetical baseline. • This baseline cannot be measured! • The inherent uncertainty is a key issue. • Must also include cost baseline. • In general, this baseline must exceed standard practice, energy codes, and related requirements and standards.

  10. Favorite References • International Performance Measurement & Verification Protocols http://www.ipmvp.org/ • Site Specific Verification Guidelines, BPA 1992 http://www.bpa.gov/Energy/N/Projects/cr_discount/pdf/site_specific_verification.pdf

  11. M&V Methods IPMVP Options • Partially Measured Retrofit Isolation • Retrofit Isolation • Whole Facility • Calibrated Simulation

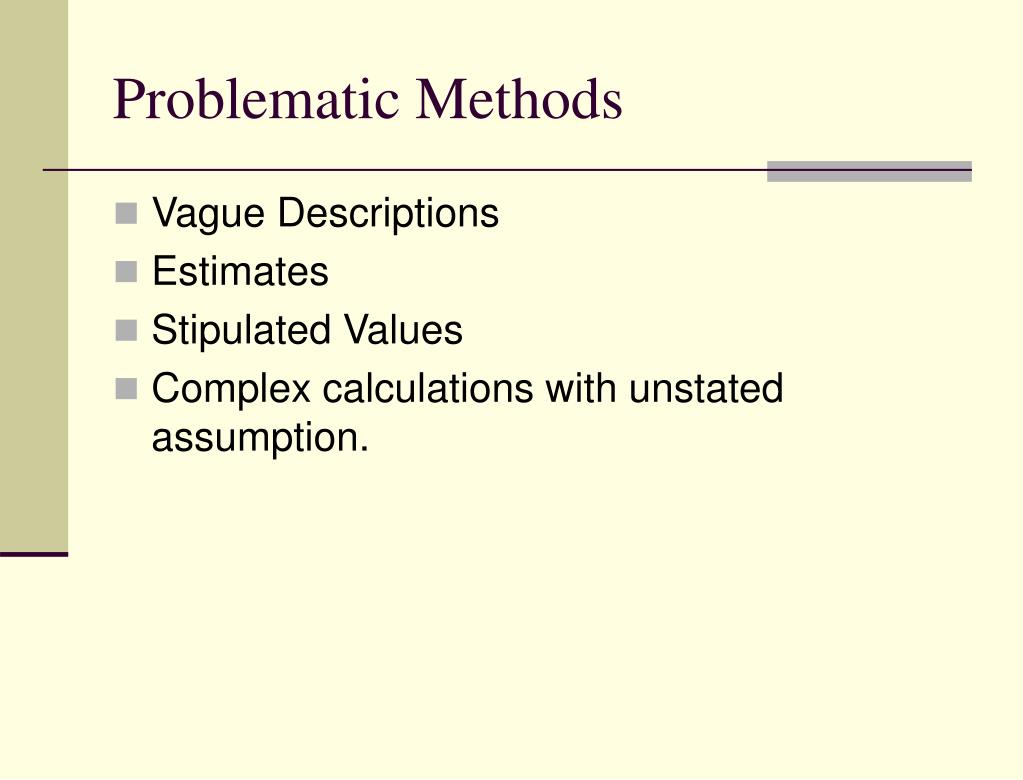

  12. Problematic Methods • Vague Descriptions • Estimates • Stipulated Values • Complex calculations with unstated assumption.

  13. Sample Spreadsheet Calculation

  14. Favorite Techniques • Retrofit Isolation with Pre and Post Metering • Extrapolation to Annual • Simple multiplication if metered period is representative of entire year • Outside Air Temperature Regression • BIN analysis

  15. Outside Temperature vs. kW

  16. Programs and Procedures • BPA has a variety of programs, e.g. CAA & CRC • Programs and contracts have specific requirements, but there are common steps for review and acceptance of projects. • Our focus today is on some common elements in review and approval of site specific proposals in the commercial sector.

  17. Basic Steps for Project Review • Sponsor submits a project proposal to BPA. • BPA and works with the sponsor to develop a mutually acceptable proposal. • Approved project is implemented. • Sponsor submits a Completion Report with Verified savings to BPA. • BPA reviews and approves the Completion Report

  18. Key Elements of Proposal • Eligibility • Measure Description • Baseline • Estimated Cost • Estimated Energy Savings • M&V Plan

  19. Specific Requirements • Info at http://www.bpa.gov/Energy/N/projects/post2006conservation/ • Note Lite M&V Plan Requirements, pages 16 & 17 of Implementation Manual (see next slide) • Also, http://www.ptr.nwcouncil.org/

  20. Lite M&V Plan Examples • Steady Loads Equipment, such as Exhaust Fans & Water Pumps • Dairy Vacuum Pump • Others?
