An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript


  1. Data Communications Program Departure Clearance (DCL) Trials DCIT17 To: DCIT Plenary From: Matt Maki, Trials Lead Date: 08.23.2012

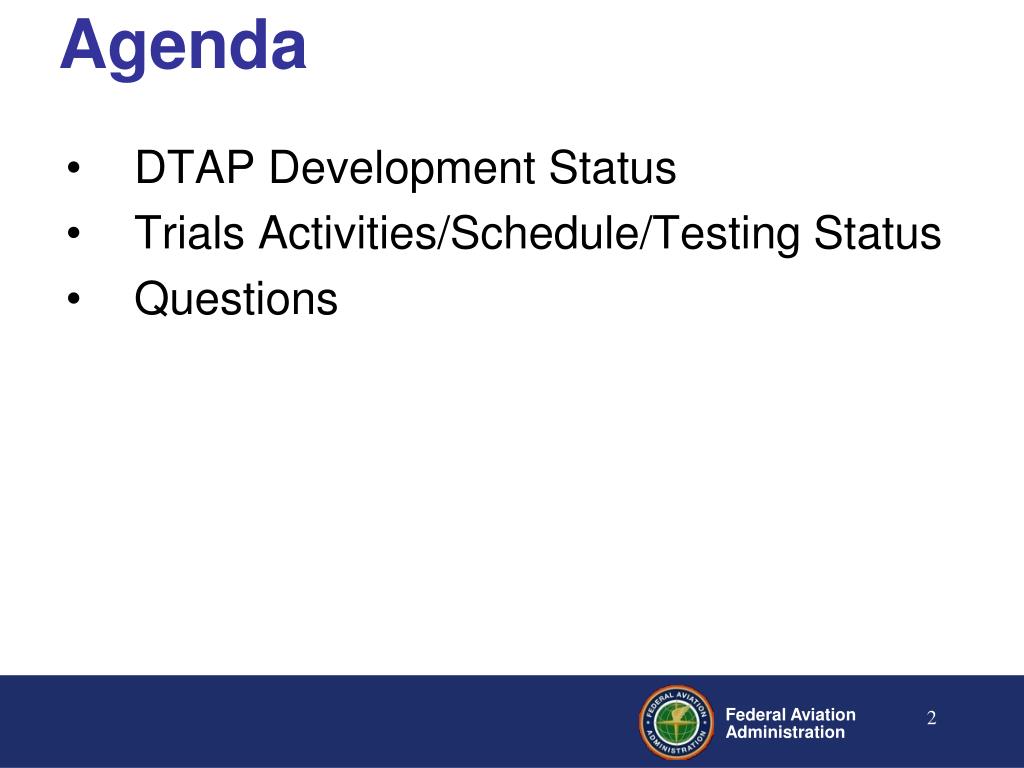

  2. Agenda • DTAP Development Status • Trials Activities/Schedule/Testing Status • Questions

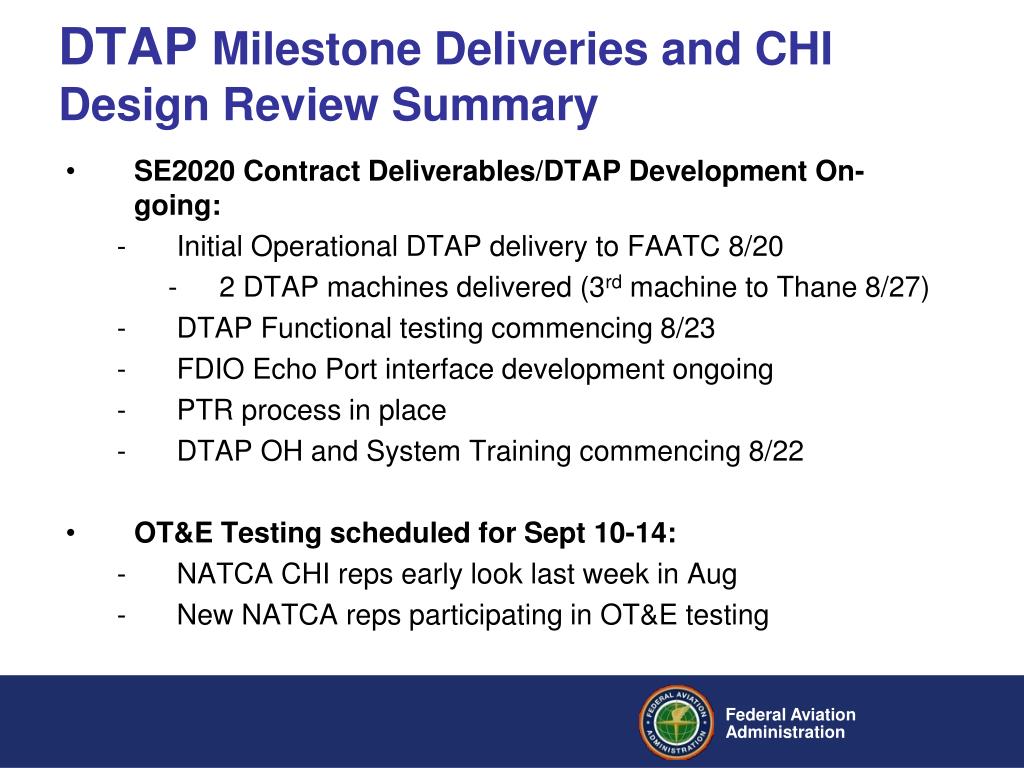

  3. DTAP Milestone Deliveries and CHI Design Review Summary • SE2020 Contract Deliverables/DTAP Development On-going: • Initial Operational DTAP delivery to FAATC 8/20 • 2 DTAP machines delivered (3rd machine to Thane 8/27) • DTAP Functional testing commencing 8/23 • FDIO Echo Port interface development ongoing • PTR process in place • DTAP OH and System Training commencing 8/22 • OT&E Testing scheduled for Sept 10-14: • NATCA CHI reps early look last week in Aug • New NATCA reps participating in OT&E testing

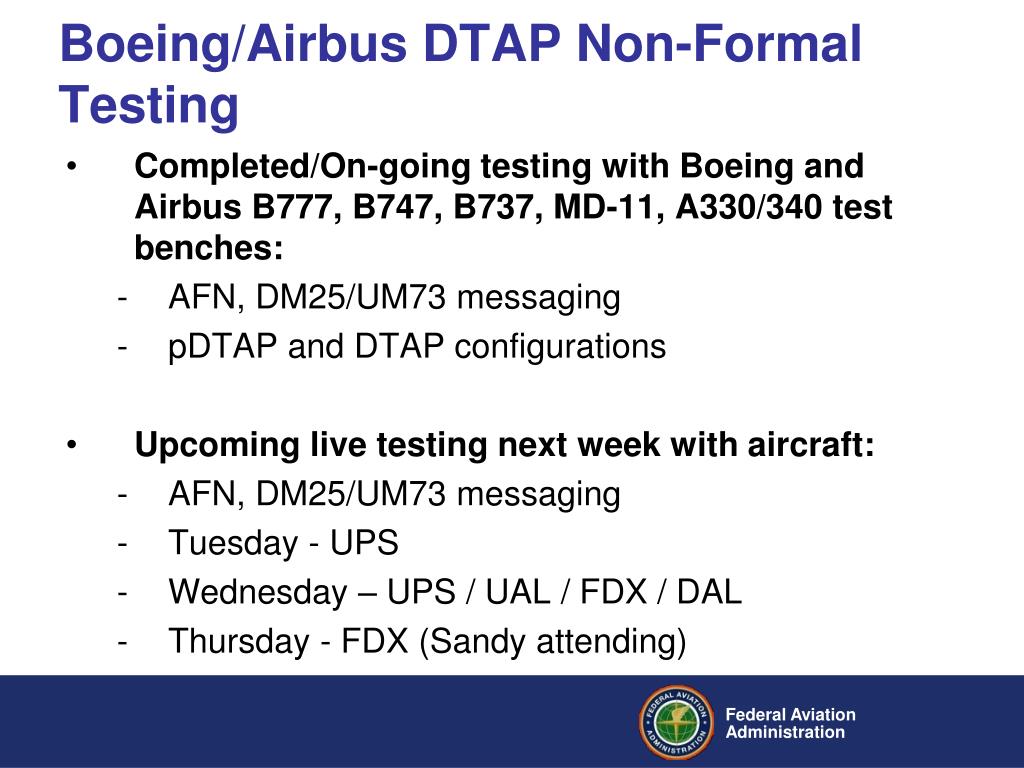

  4. Boeing/Airbus DTAP Non-Formal Testing • Completed/On-going testing with Boeing and Airbus B777, B747, B737, MD-11, A330/340 test benches: - AFN, DM25/UM73 messaging - pDTAP and DTAP configurations • Upcoming live testing next week with aircraft: - AFN, DM25/UM73 messaging - Tuesday - UPS - Wednesday – UPS / UAL / FDX / DAL - Thursday - FDX (Sandy attending)

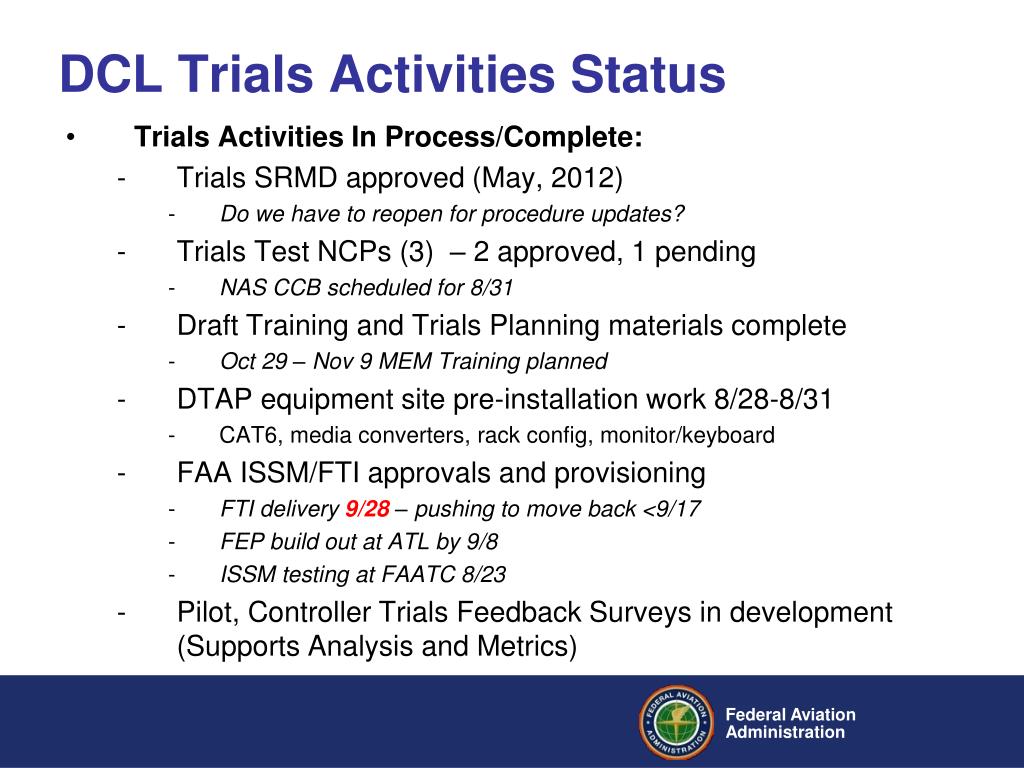

  5. DCL Trials Activities Status • Trials Activities In Process/Complete: • Trials SRMD approved (May, 2012) • Do we have to reopen for procedure updates? • Trials Test NCPs (3) – 2 approved, 1 pending • NAS CCB scheduled for 8/31 • Draft Training and Trials Planning materials complete • Oct 29 – Nov 9 MEM Training planned • DTAP equipment site pre-installation work 8/28-8/31 • CAT6, media converters, rack config, monitor/keyboard • FAA ISSM/FTI approvals and provisioning • FTI delivery 9/28 – pushing to move back <9/17 • FEP build out at ATL by 9/8 • ISSM testing at FAATC 8/23 • Pilot, Controller Trials Feedback Surveys in development (Supports Analysis and Metrics)

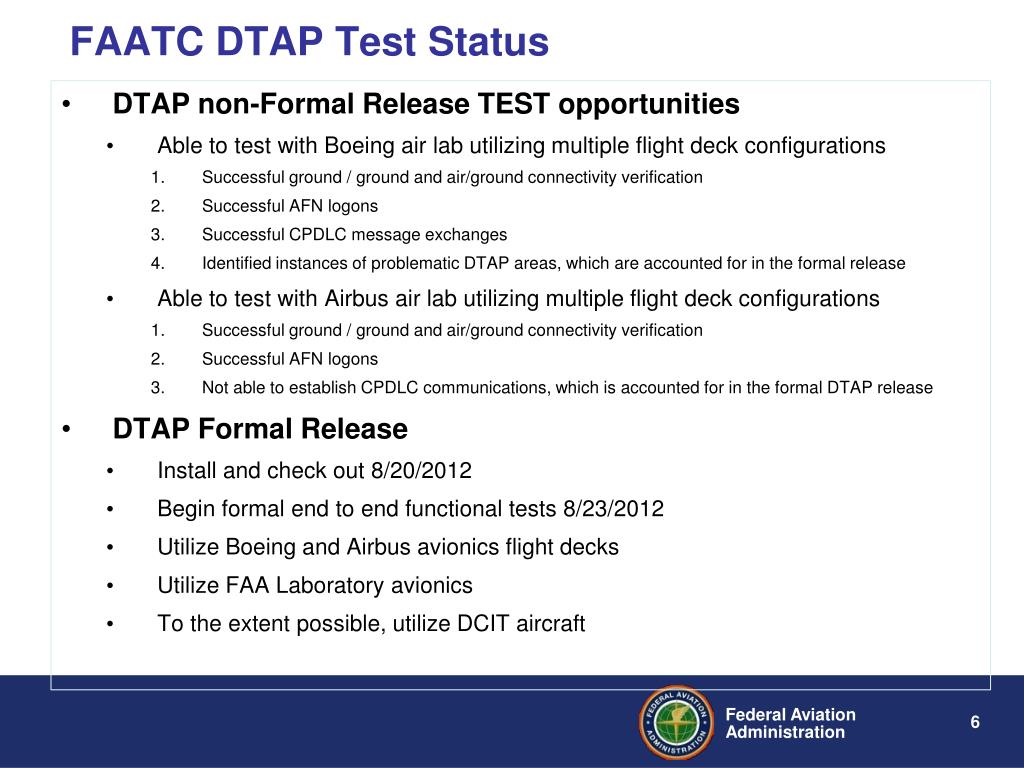

  6. FAATC DTAP Test Status DTAP non-Formal Release TEST opportunities Able to test with Boeing air lab utilizing multiple flight deck configurations Successful ground / ground and air/ground connectivity verification Successful AFN logons Successful CPDLC message exchanges Identified instances of problematic DTAP areas, which are accounted for in the formal release Able to test with Airbus air lab utilizing multiple flight deck configurations Successful ground / ground and air/ground connectivity verification Successful AFN logons Not able to establish CPDLC communications, which is accounted for in the formal DTAP release DTAP Formal Release Install and check out 8/20/2012 Begin formal end to end functional tests 8/23/2012 Utilize Boeing and Airbus avionics flight decks Utilize FAA Laboratory avionics To the extent possible, utilize DCIT aircraft 6

  7. DCL Trials Test Timeline (updated: 8/10/2012) Tech Center DTAP E-E Functional Testing (DTAP 1) SAT @ MEM DTAP 1&2 pDTAP DTAP 1&2 setup/prep Video crew @ Tech Center event (Sept. 13) AFN and CPDLC connect with Boeing event (July 31, Aug 3, 7, 11) DCL & AFN attempt with DCIT aircraft pre-arranged event (Aug 28, 29 & 30) Conduct Thales install & checkout AFN and CPDLC connect with Airbus event (Aug 6-8) Training Controller OT&E (35) Oct 29 Dry & Prep Controllers early look & feel (Aug. 29) Dry run & prep (B4) Nov 30 Conduct (B3) Oct 1 (B1) Aug 17 (B2) Sept 3 May 10 Aug 22 Sept 7 Sept 14 Sept 17 Nov 12 • Controller OT • Prep / Dry run & Conduct • System test case / bench avionics + TC aircraft • System test case / Boeing air lab • System test case / Airbus air lab • System test case / DCIT aircraft • Error conditions / failover • PTR fixes / regression • 8/23/1012: Security Assessment • Regression with B2 (in lab) • DTAP Test Report • Install & checkout • Training • SAT sub_test cases final • SAT sub_test cases functional testing/ FedEx aircraft • E-E Operational scenarios based on DCIT v1.0 doc / FedEx aircraft • Error conditions / failover in field env. • Regression with B3 (in lab & in field) • SAT Test Report • pDTAP / HADDS in box test • pDTAP / HADDS via FNTB Failover / Rev # test • pDTAP / HADDS / CSP Interface via FNTB + bench Avionics • pDTAP (applicable reqs/VRTM) testing with bench avionics • pDTAP testing via Boeing + Airbus air labs • PTR fixes / regression • Test Cases document final • pDTAP Quick Look Report (B3) = Adds UM80, AOC CC ACK (B4) = Adds UM83, FDIO (possibly in B3) (B1) = CAF, UM73, CHI, AFN (B2) = Adds UM79, AOC CC (no ack)

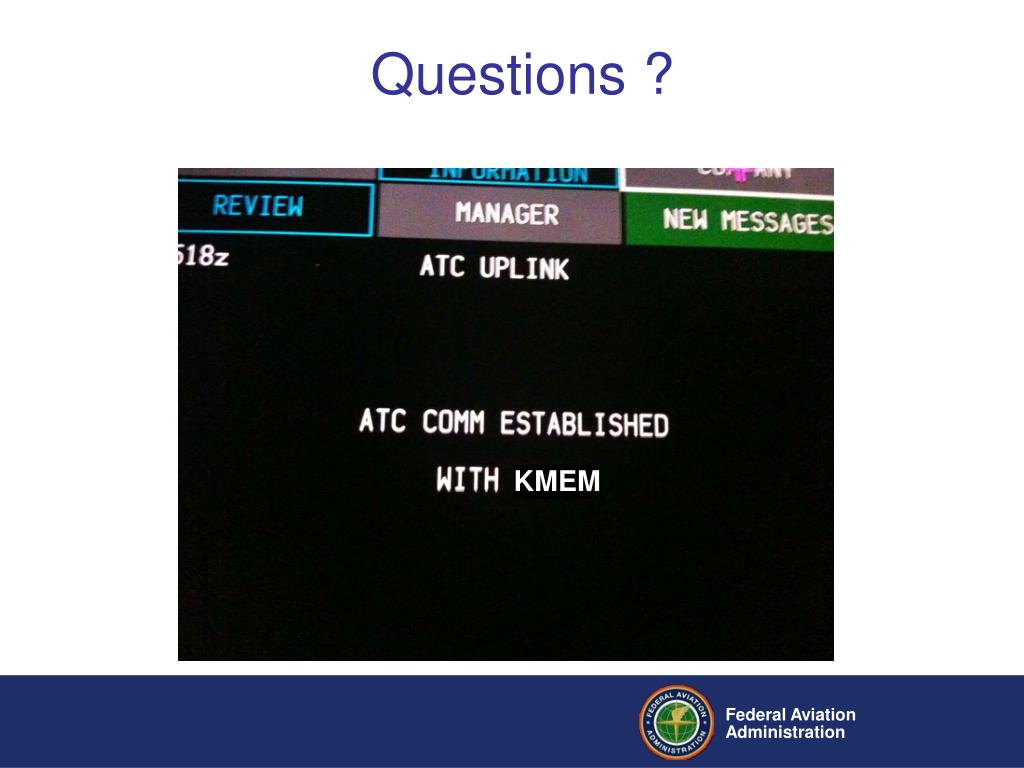

  8. Questions ? KMEM
