LAr No LHe DO Timeline 2000 2001 J F M A M J J A S O N D J F M D ICD FT install/hookup SMT install/ hookup Remove shield wall Roll in FPS 1/2 VLPCs installed All VLPCs installed Beam-ready Lum (L0) Platform moves Install silicon front-end Install final CFT electronics 1st CFT crate operational Hookup ECS Run II begins: Mar 1, 2001 Waveguide production Install/checkout CAL BLS Forwardm MDT & pixel planes install/survey (A&B) CC cosmics ECN cosmics End toroids installed Forwardm MDT & pixel planes install/survey (C) Assemble/install/ align EMC Cosmic Ray Commissioning Phase II: Fiber tracker, trigger, preshowers, VLPCs, CTT, forward muon Phase III: Full Cosmic Ray Run (add TRIG, SMT, CAL) Phase I: Central muon, DAQ, RECO, trigger, tracker front-end

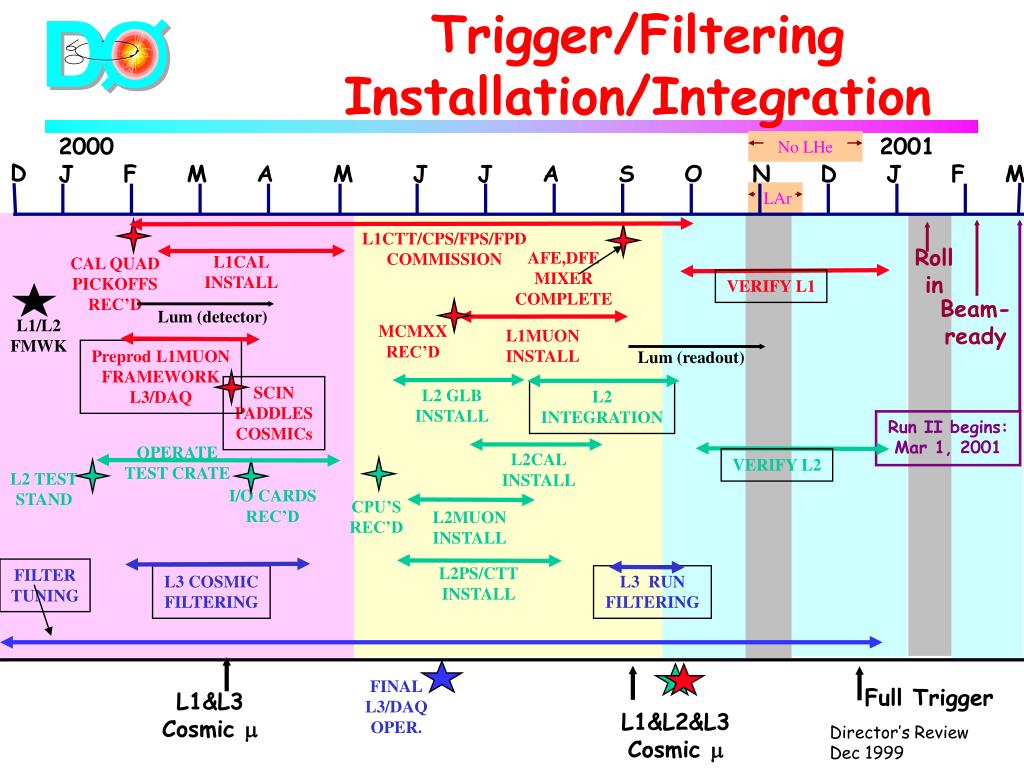

LAr No LHe Trigger/Filtering Installation/Integration 2000 2001 J F M A M J J A S O N D J F M D L1CTT/CPS/FPS/FPD COMMISSION Roll in AFE,DFE MIXER COMPLETE L1CAL INSTALL CAL QUAD PICKOFFS REC’D VERIFY L1 Beam-ready Lum (detector) L1/L2 FMWK MCMXX REC’D L1MUON INSTALL Preprod L1MUON FRAMEWORK L3/DAQ Lum (readout) SCIN PADDLES COSMICs L2 GLB INSTALL L2 INTEGRATION Run II begins: Mar 1, 2001 OPERATE TEST CRATE L2CAL INSTALL VERIFY L2 L2 TEST STAND I/O CARDS REC’D CPU’S REC’D L2MUON INSTALL L2PS/CTT INSTALL FILTER TUNING L3 COSMIC FILTERING L3 RUN FILTERING FINAL L3/DAQ OPER. Full Trigger L1&L3 Cosmic m L1&L2&L3 Cosmic m
