LARP QXF Conductor Plan

LARP QXF Conductor Plan. Arup K Ghosh Lab C oordination Meeting March 21, 2013. Current LARP activities. Procurement of RRP-108/127 Ti-Ternary Strand Validating billet design from OST that improves RRR Evaluation of recent 400 kg delivery from OST QXF Cable Development

Download Presentation

LARP QXF Conductor Plan

An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript


  1. LARP QXF Conductor Plan Arup K Ghosh Lab Coordination Meeting March 21, 2013

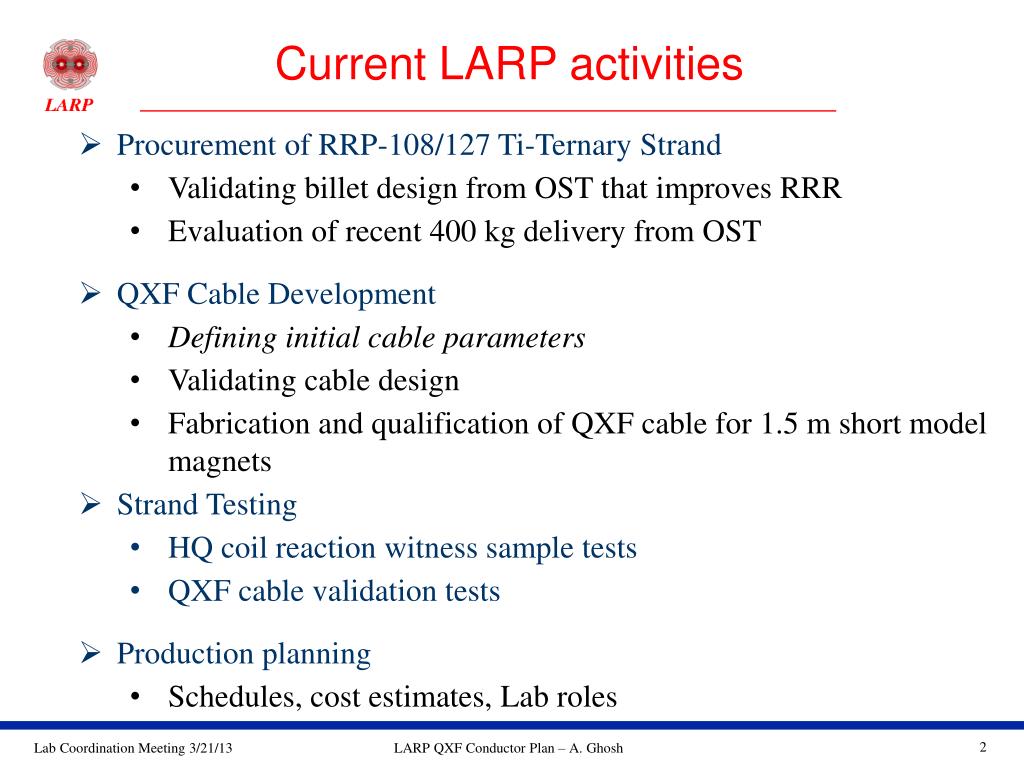

  2. Current LARP activities • Procurement of RRP-108/127 Ti-Ternary Strand • Validating billet design from OST that improves RRR • Evaluation of recent 400 kg delivery from OST • QXF Cable Development • Defining initial cable parameters • Validating cable design • Fabrication and qualification of QXF cable for 1.5 m short model magnets • Strand Testing • HQ coil reaction witness sample tests • QXF cable validation tests • Production planning • Schedules, cost estimates, Lab roles

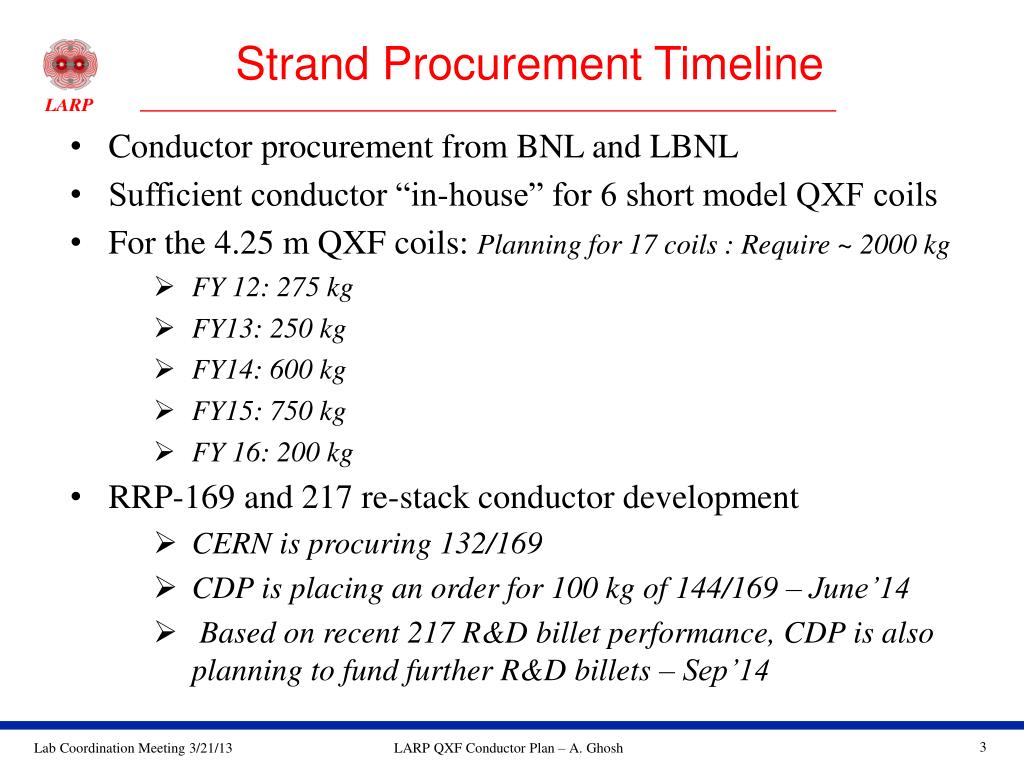

  3. Strand Procurement Timeline • Conductor procurement from BNL and LBNL • Sufficient conductor “in-house” for 6 short model QXF coils • For the 4.25 m QXF coils: Planning for 17 coils : Require ~ 2000 kg • FY 12: 275 kg • FY13: 250 kg • FY14: 600 kg • FY15: 750 kg • FY 16: 200 kg • RRP-169 and 217 re-stack conductor development • CERN is procuring 132/169 • CDP is placing an order for 100 kg of 144/169 – June’14 • Based on recent 217 R&D billet performance, CDP is also planning to fund further R&D billets – Sep’14

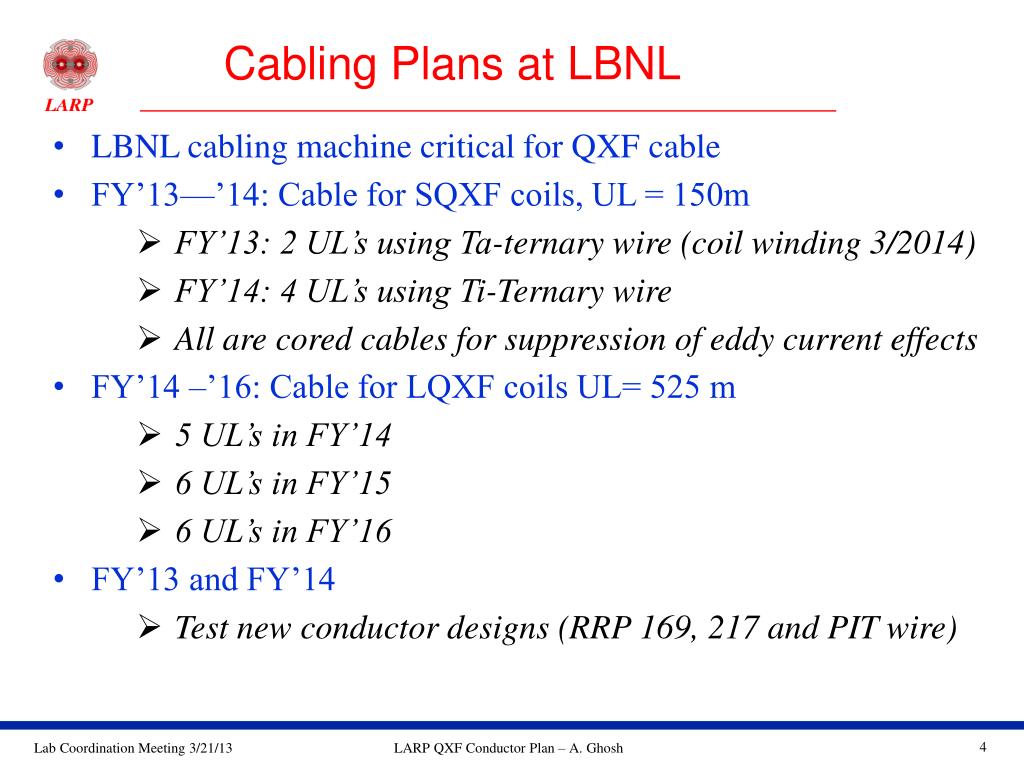

  4. Cabling Plans at LBNL • LBNL cabling machine critical for QXF cable • FY’13—’14: Cable for SQXF coils, UL = 150m • FY’13: 2 UL’s using Ta-ternary wire (coil winding 3/2014) • FY’14: 4 UL’s using Ti-Ternary wire • All are cored cables for suppression of eddy current effects • FY’14 –’16: Cable for LQXF coils UL= 525 m • 5 UL’s in FY’14 • 6 UL’s in FY’15 • 6 UL’s in FY’16 • FY’13 and FY’14 • Test new conductor designs (RRP 169, 217 and PIT wire)

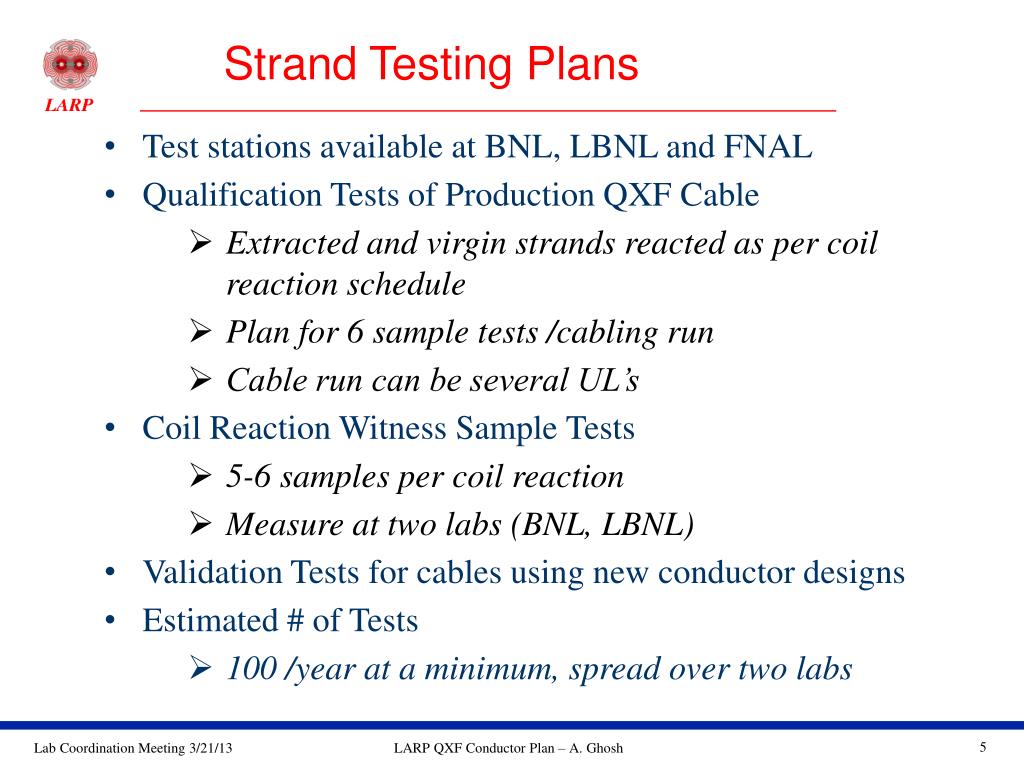

  5. Strand Testing Plans • Test stations available at BNL, LBNL and FNAL • Qualification Tests of Production QXF Cable • Extracted and virgin strands reacted as per coil reaction schedule • Plan for 6 sample tests /cabling run • Cable run can be several UL’s • Coil Reaction Witness Sample Tests • 5-6 samples per coil reaction • Measure at two labs (BNL, LBNL) • Validation Tests for cables using new conductor designs • Estimated # of Tests • 100 /year at a minimum, spread over two labs
