An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript


  1. Mod 0273: Governance of Feasibility Study Requests to Support Changes to Network Exit Agreements – National Grid NTS Response

  2. Mod 0273 Overview • Raised by E.ON UK • Focuses on Feasibility Studies required to change max flow / ramp rate changes to NTS NExAs, NTS new connections & DN equivalent processes • No published timescales for completion of Feasibility Study or associated Agreement • No indicative costs published • Proposes CUSC style formal timescales & costs to introduce: • 3 month turnaround of Feasibility Study • Fixed costs (with option for users to opt for later reconciliation) • Proposed benefits are: • Improved transparency • Greater competition via increased flow rates

  3. NG NTS Initial Views • There is confusion over the electricity model deployed • The 3 month Connection and Use of System Code (CUSC) Modification Application process employed in electricity does not include a feasibility/engineering study • Feasibility Study fees are not published in electricity • The gas process needs to be fully understood • In comparison to electricity, the number of new connections and Network Exit Agreement (NExA) changes are relatively few. Receiving quite a few enquiries in a relatively short period can cause workload planning difficulties. • The timescales in gas vary considerably depending on the complexity of the customer requirements/installation • Feasibility and Conceptual Design Studies are important as they are undertaken to meet legislative obligations

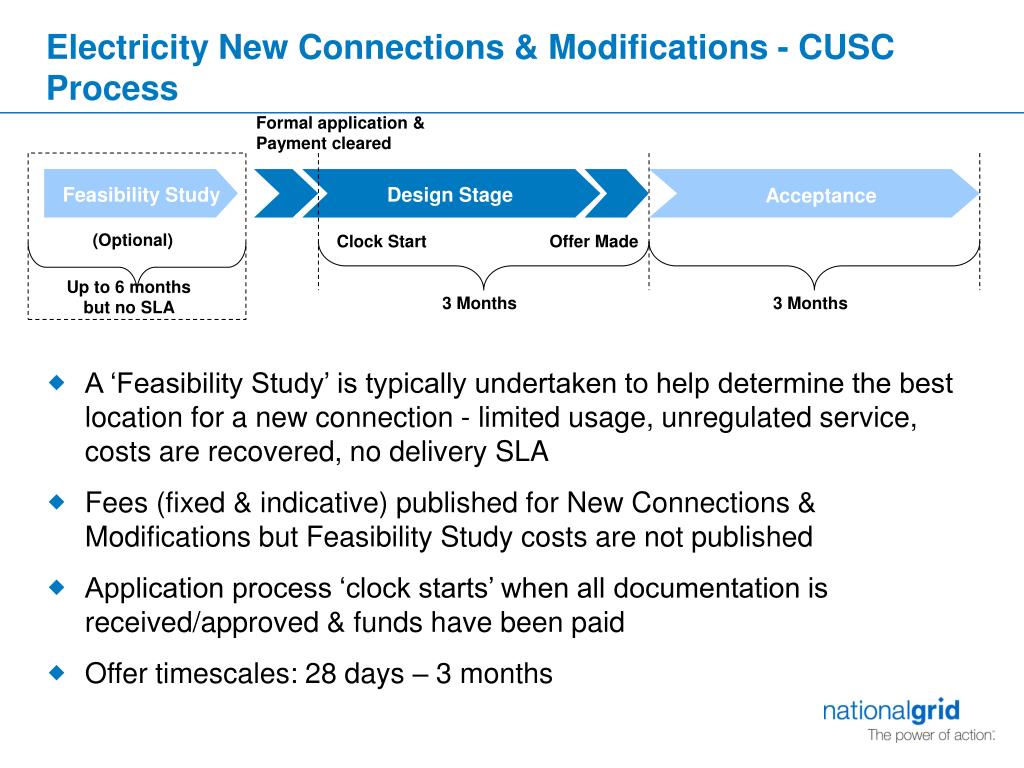

  4. Electricity New Connections & Modifications - CUSC Process Formal application & Payment cleared • A ‘Feasibility Study’ is typically undertaken to help determine the best location for a new connection - limited usage, unregulated service, costs are recovered, no delivery SLA • Fees (fixed & indicative) published for New Connections & Modifications but Feasibility Study costs are not published • Application process ‘clock starts’ when all documentation is received/approved & funds have been paid • Offer timescales: 28 days – 3 months Feasibility Study Design Stage Acceptance (Optional) Clock Start Offer Made Up to 6 months but no SLA 3 Months 3 Months

  5. Gas Exit Connection Processes • For New Connections an indicative 20 week turn-around is published • Flexibility – the studies undertaken are tailored to suit the particular customer requirements • The costs/timescales of the analysis conducted is calculated accordingly • Typical study timescales and costs:

  6. Why is it important we conduct studies? • Rapid load changes during start up and shutdown could affect the efficient and effective operation of the pipeline system • Trigger safety devices and cut off supply at the installation • Cause damage to National Grid equipment at installations such as pressure regulators, filters and orifice plate meters • Adversely affect other Users of the system (entry and exit points) in the vicinity • Legislation • Health and Safety at Work Act etc. 1974 • Pressure Systems Safety Regulations (PSSR) 2000 • Pipeline Safety Regulations (PSR) 1996

  7. What is involved in conducting a study? • Influencing factors: • Customers don’t always know what they want! • Customers often experience difficulties in providing the information requested • Difficulties in agreeing Contractual terms (between Customer and NG) • Nature of the study • Contractor Procurement process • Workload planning – NG and Contractors
