An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript

  1. In-house vs. Out-sourced Clinical Engineering David M. Dickey, CHC, CCE Corporate Director, McLaren Health Care Clinical Engineering Services

  2. Disclaimer/Transparency • I do have a biased opinion! • 30+ years managing in-house clinical engineering programs • Currently Corporate Director CE McLaren Health Care • 15+ years clinical engineering consulting (Medical Technology Management., Inc.) www.mtminc.org • Practice area focus is in creating and/or expansion of CE programs • Conversion of out-sourced programs to in-house • Having been in this profession for my entire career, I know a lot of CE professionals that have ‘gone both ways’, switching back and forth as needed

  3. I do agree • Out-sourced programs may make sense for smaller hospitals, < 100-150 beds, especially if they are not part of a larger system with internal CE resources • Not all in-house, or out-sourced, programs are created equal • Common factors that impact degree of success • Quality and education of the staff • Resources • Administrative support • ‘Fix it’ shop vs. a ‘professional service’…what are the needs? • Either type of program is doomed for failure if the program delivered does not fit the needs and expectations of the organization! • Neither are free

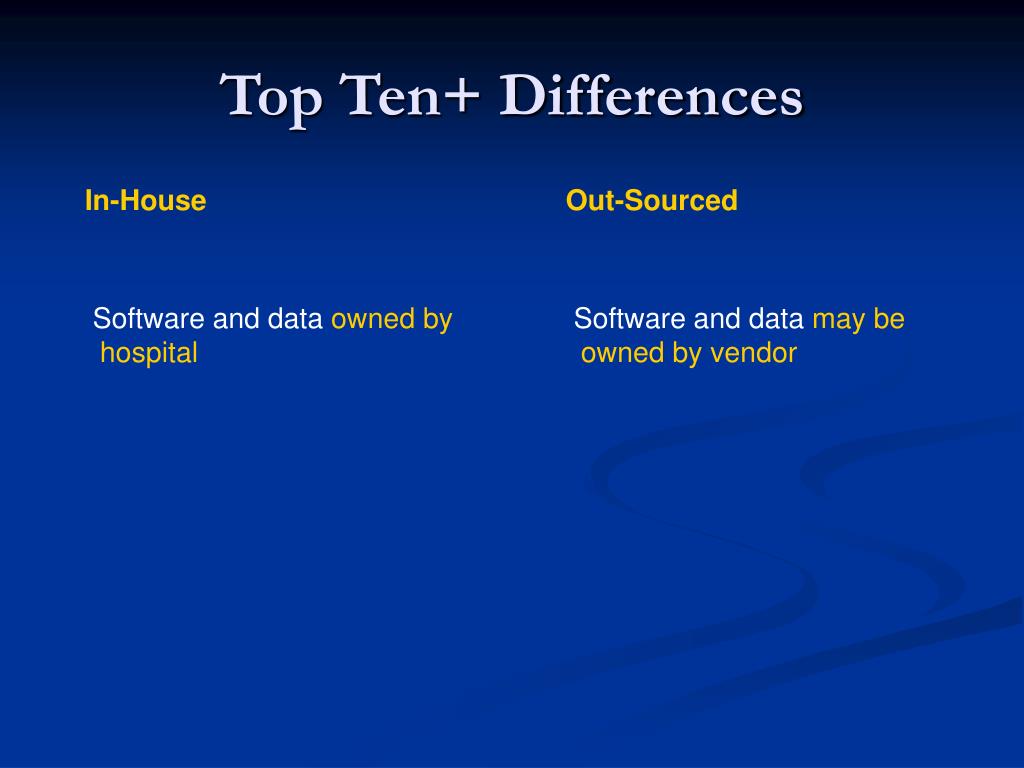

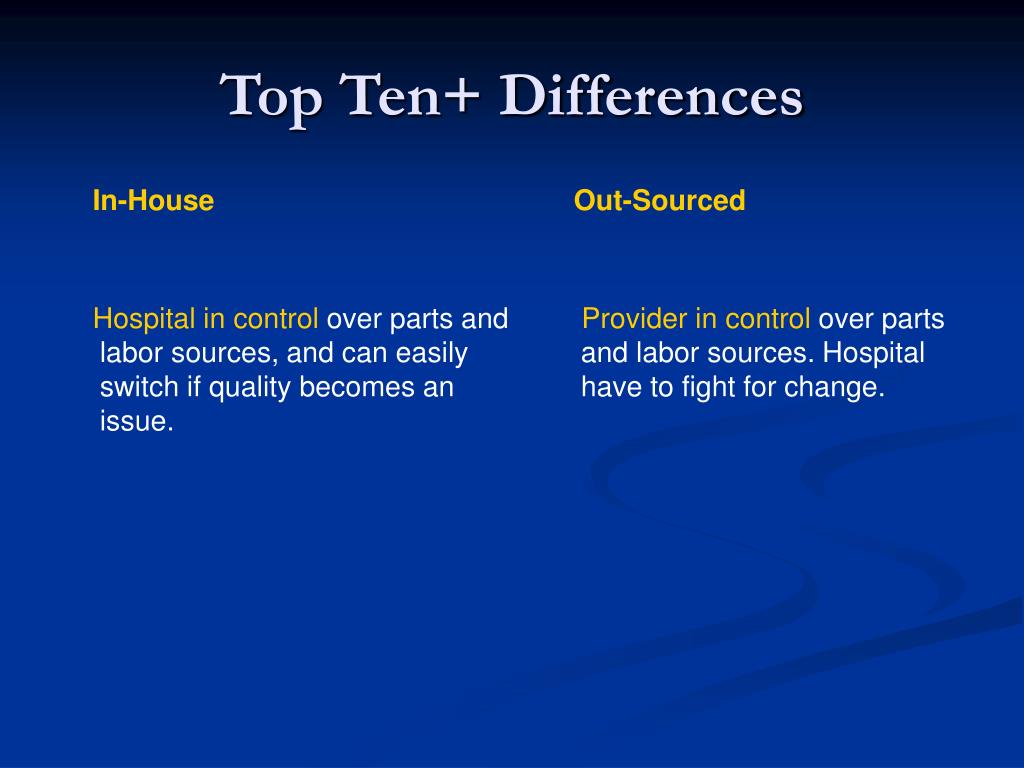

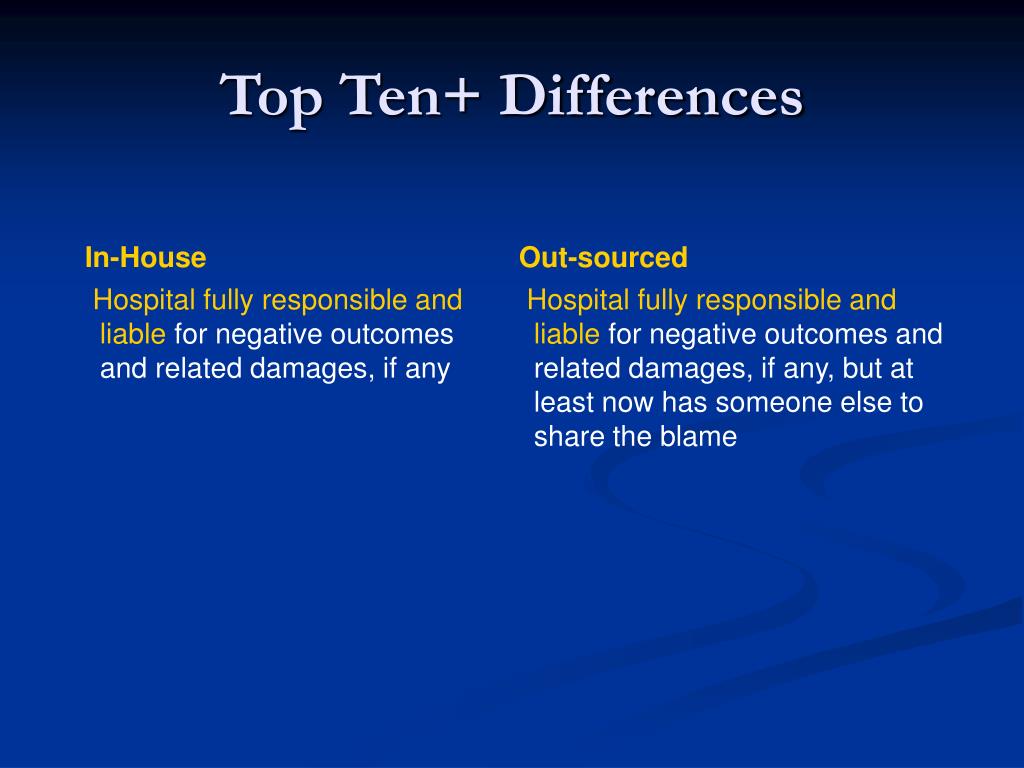

  4. Top Ten+ Differences

  5. Top Ten+ Differences

  6. Top Ten+ Differences

  7. Top Ten+ Differences

  8. Top Ten+ Differences

  9. Top Ten+ Differences

  10. Top Ten+ Differences

  11. Top Ten+ Differences

  12. Top Ten+ Differences

  13. Top Ten+ Differences

  14. Top Ten+ Differences

  15. Top Ten+ Differences

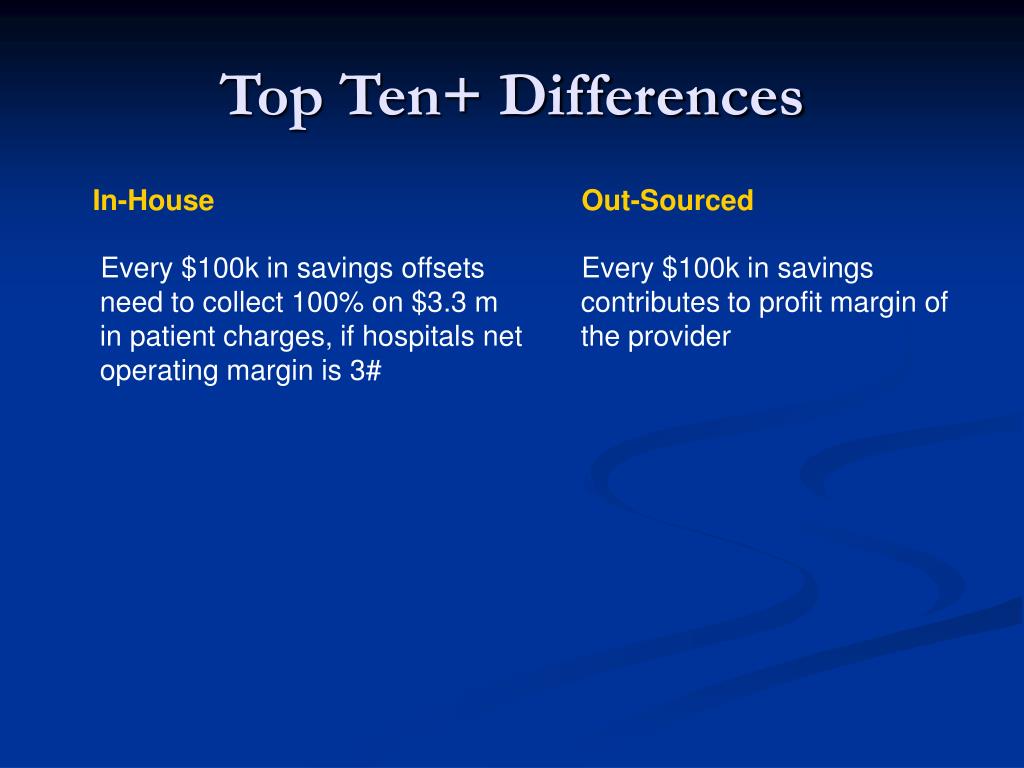

  16. Example of cash impact if you outsource • If inventory is $290,000,000 • COSR = 4.7% Budget is then $13,630,000 • Outsource to a provide that has 20% profit margin, cost now becomes $16,356,000 (COSR now 5.6%) • If hospital’s net annual operating margin is 2%, the additional $’s paid needs to be made up by the hospital collection of 100% on $13,630,000 of patient charges!

  17. Top Ten+ Differences

  18. Top Ten+ Differences

  19. Top Ten+ Differences

  20. Issues of concern when converting to in-house from out-sourced program • Software CMMS and data conversions • Test equipment and tools • Manuals • Over due PMs and CM’s wip credits • Staffing and ability to hire providers staff • Contracts and OEM discounts • Policies and procedures • Clerical and call center support • Clinical engineering expertise • Three to six months lead time

  21. In order to convert to an in-house model • Develop a business plan (three years), based on cost and quality • Set realistic goals and expectations • Consolidate all service budgets into one • Include contract/vendor management services • Start with general biomedical equipment support • Plan for expansion into service of ultrasound; sterilization; imaging; cath lab; clinical lab; radiation oncology; surgical instrument mgt.

  22. If you have an out-sourced program • Perform bi-annual assessment of equipment actually serviced, PM or CM, and remove from inventory items never seen, to lower your program contract cost • Read your contract and verify deliverables are being delivered • Negotiate the margin, full disclosure of all costs • If vendor gets credits for parts returned, it should be credited back to the hospital • Mandate full staffing levels. If not met, get credit • Mandate credits for PM’s not done on time • Obtain quarterly downloads (Excel format) of inventory and work histories • Consider getting help…call me when you are ready to save money! (daved@mtminc.org)
