  1. Schedule Management Techniques For Complex Projects W. Scott Nainis Noblis, Inc. August 12, 2009

  2. Today’s Agenda • Motivation for the topic • Why do many projects get behind (and cost more)? • How do we track project progress? • Role of Earned Value • Transition to Earned Schedule • How can we be both Pessimistic and Optimistic at the Same Time? • How can Event Chains (and similar simulation approaches) help us? • Power of Synergy – • How can ES and Event Chain work together? • How is the schedule management article related to other articles within the SIGMA PMO Edition?

  3. Motivation for the Topic • Historic value of quantitative methods for project management – role of management science/operations research (MS/OR) • PERT (Program Evaluation and Review Technique) • CPM (Critical Path Method) • Network and Optimization (linear programming, dynamic programming, simulation, etc.) • What has MS/OR done for project management lately? • Project management tools (e.g. MS Project) have incorporated many of the MS/OR quantitative methods • Simulation (Monte Carlo analysis, simulation-based training, what-if analysis) has been an active area for development

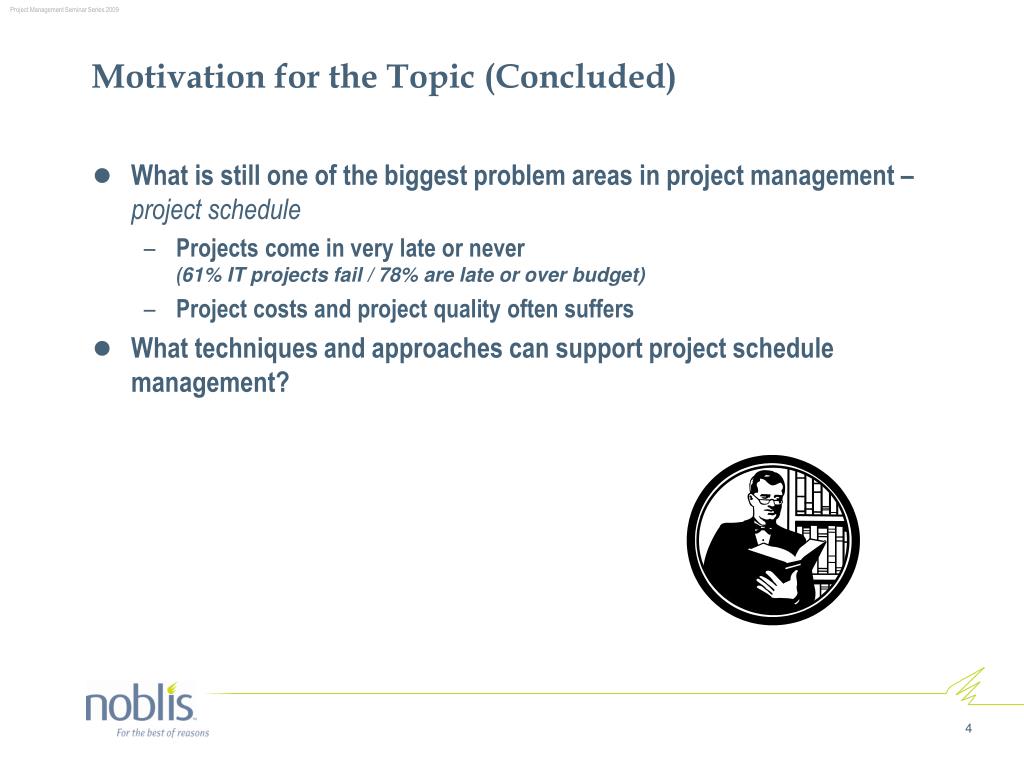

  4. Motivation for the Topic (Concluded) • What is still one of the biggest problem areas in project management – project schedule • Projects come in very late or never (61% IT projects fail / 78% are late or over budget) • Project costs and project quality often suffers • What techniques and approaches can support project schedule management?

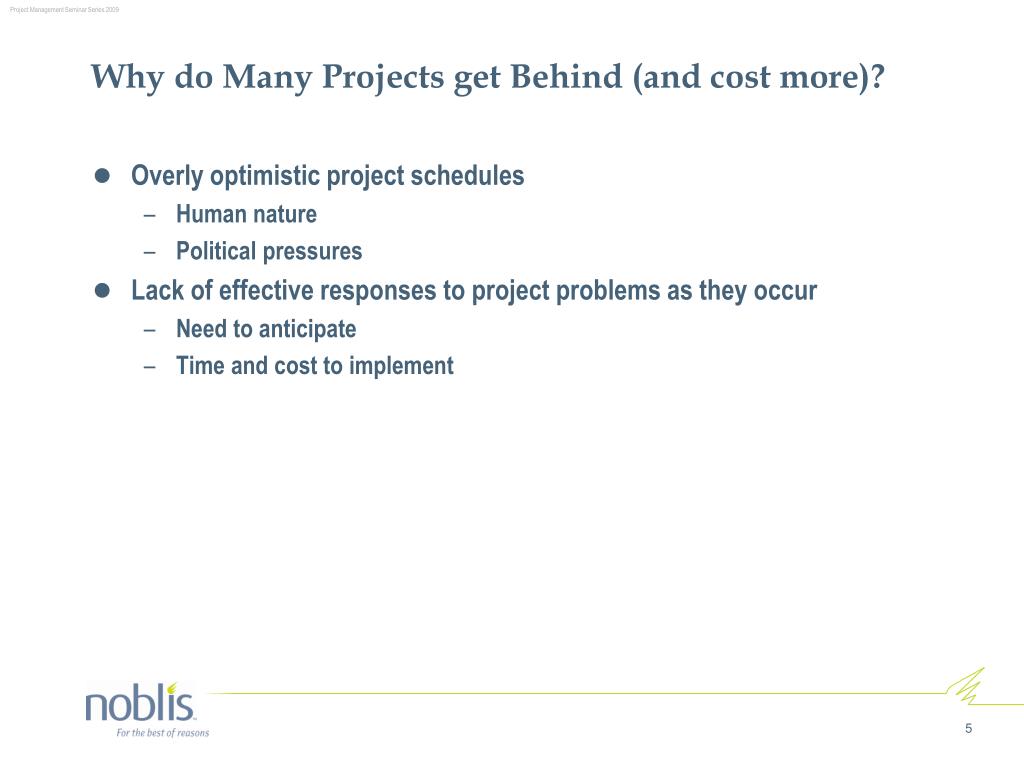

  5. Why do Many Projects get Behind (and cost more)? • Overly optimistic project schedules • Human nature • Political pressures • Lack of effective responses to project problems as they occur • Need to anticipate • Time and cost to implement

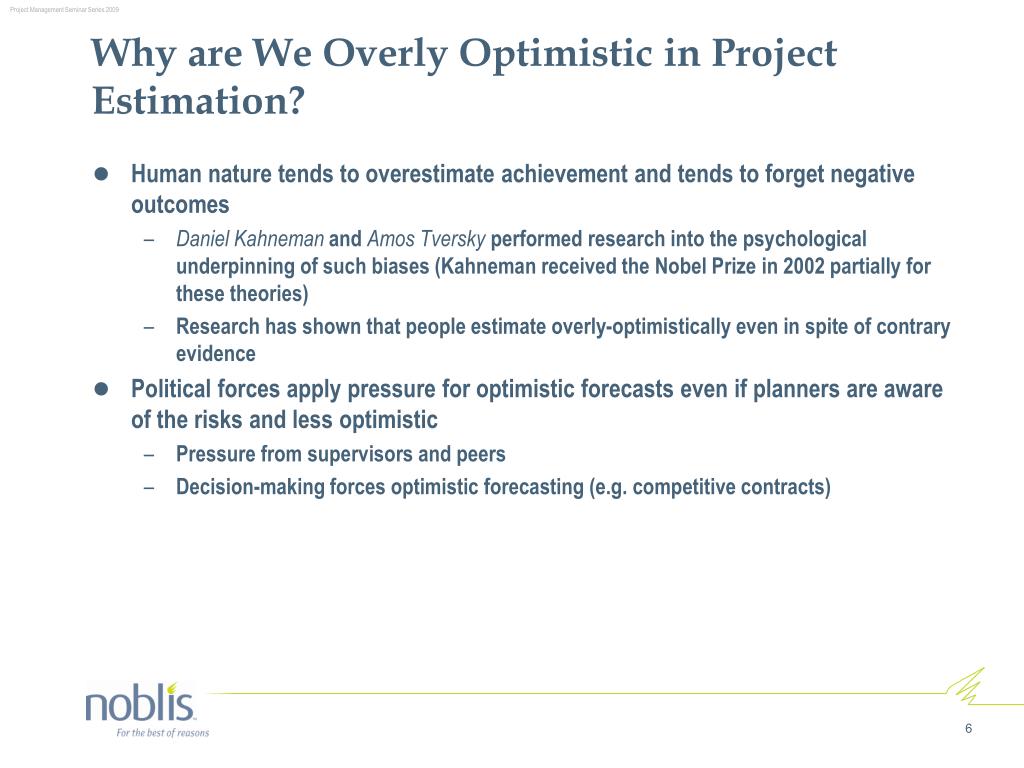

  6. Why are We Overly Optimistic in Project Estimation? • Human nature tends to overestimate achievement and tends to forget negative outcomes • Daniel Kahneman and Amos Tversky performed research into the psychological underpinning of such biases (Kahneman received the Nobel Prize in 2002 partially for these theories) • Research has shown that people estimate overly-optimistically even in spite of contrary evidence • Political forces apply pressure for optimistic forecasts even if planners are aware of the risks and less optimistic • Pressure from supervisors and peers • Decision-making forces optimistic forecasting (e.g. competitive contracts)

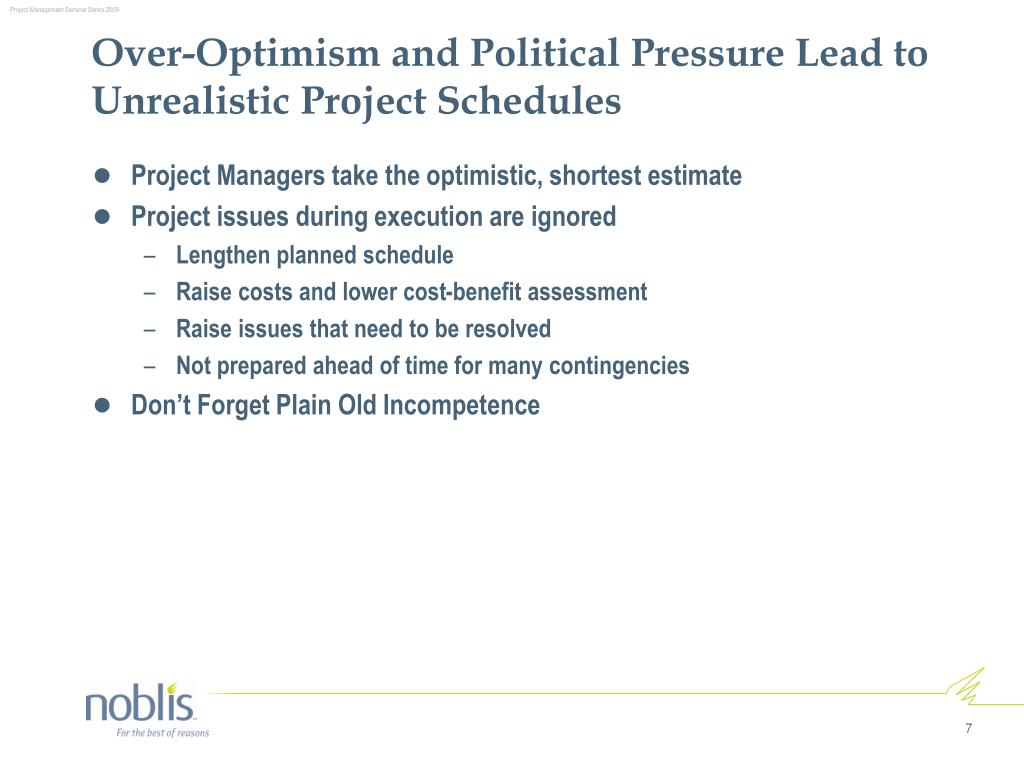

  7. Over-Optimism and Political Pressure Lead to Unrealistic Project Schedules • Project Managers take the optimistic, shortest estimate • Project issues during execution are ignored • Lengthen planned schedule • Raise costs and lower cost-benefit assessment • Raise issues that need to be resolved • Not prepared ahead of time for many contingencies • Don’t Forget Plain Old Incompetence

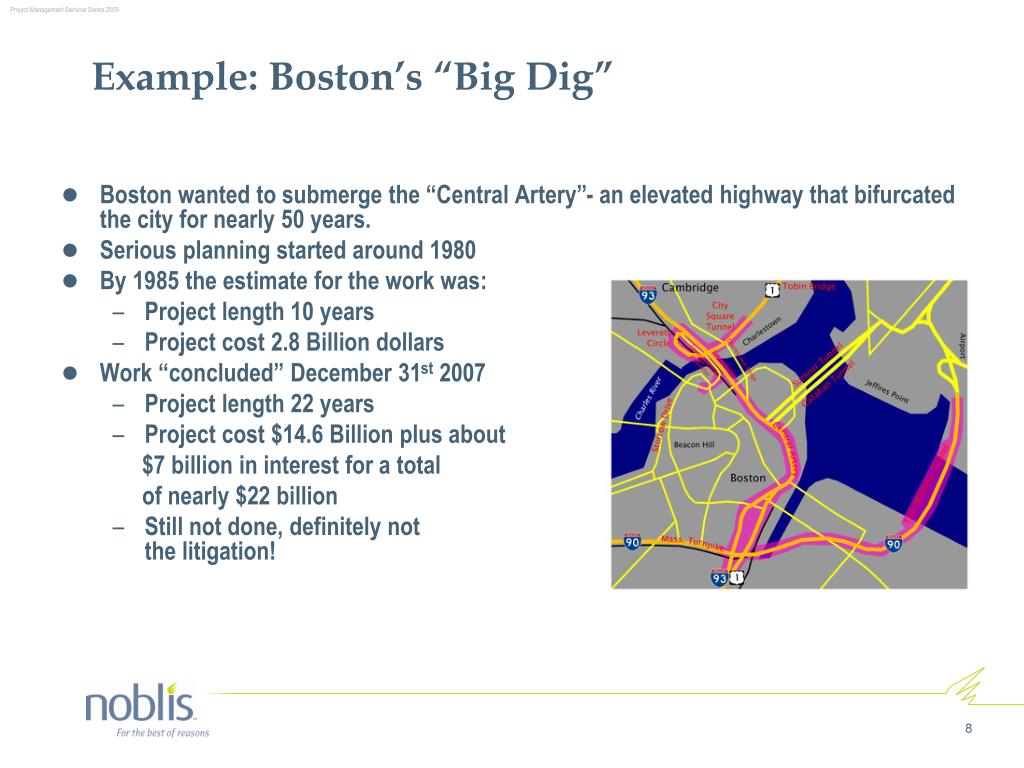

  8. Example: Boston’s “Big Dig” • Boston wanted to submerge the “Central Artery”- an elevated highway that bifurcated the city for nearly 50 years. • Serious planning started around 1980 • By 1985 the estimate for the work was: • Project length 10 years • Project cost 2.8 Billion dollars • Work “concluded” December 31st 2007 • Project length 22 years • Project cost $14.6 Billion plus about $7 billion in interest for a total of nearly $22 billion • Still not done, definitely not not the litigation!

  9. Alternative Methods for Project Forecasting • Concept of “insider” forecasting versus “outsider” forecasting • Developed in 2006 to the concept of Reference Class Forecasts • Use of real data from similar projects • Become aware of what can actually go wrong with complex projects • Take into account the “distributional” nature of project activities, impacts and results • Allow for input and appraisal from those who are not “too close” to the project

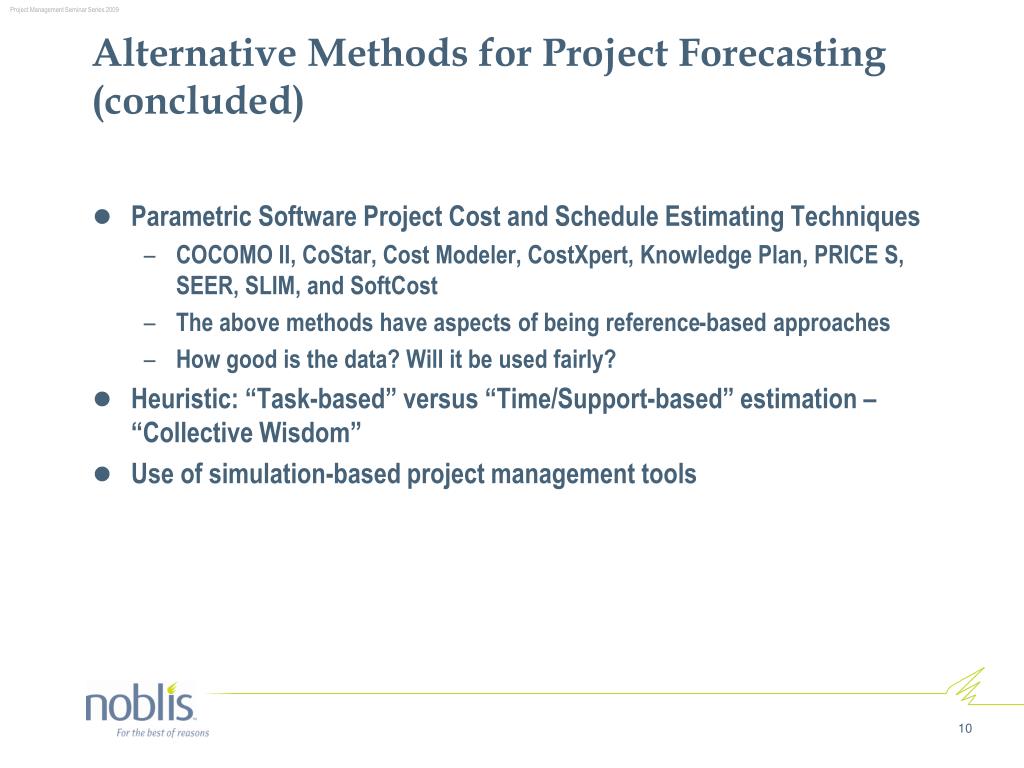

  10. Alternative Methods for Project Forecasting (concluded) • Parametric Software Project Cost and Schedule Estimating Techniques • COCOMO II, CoStar, Cost Modeler, CostXpert, Knowledge Plan, PRICE S, SEER, SLIM, and SoftCost • The above methods have aspects of being reference-based approaches • How good is the data? Will it be used fairly? • Heuristic: “Task-based” versus “Time/Support-based” estimation – “Collective Wisdom” • Use of simulation-based project management tools

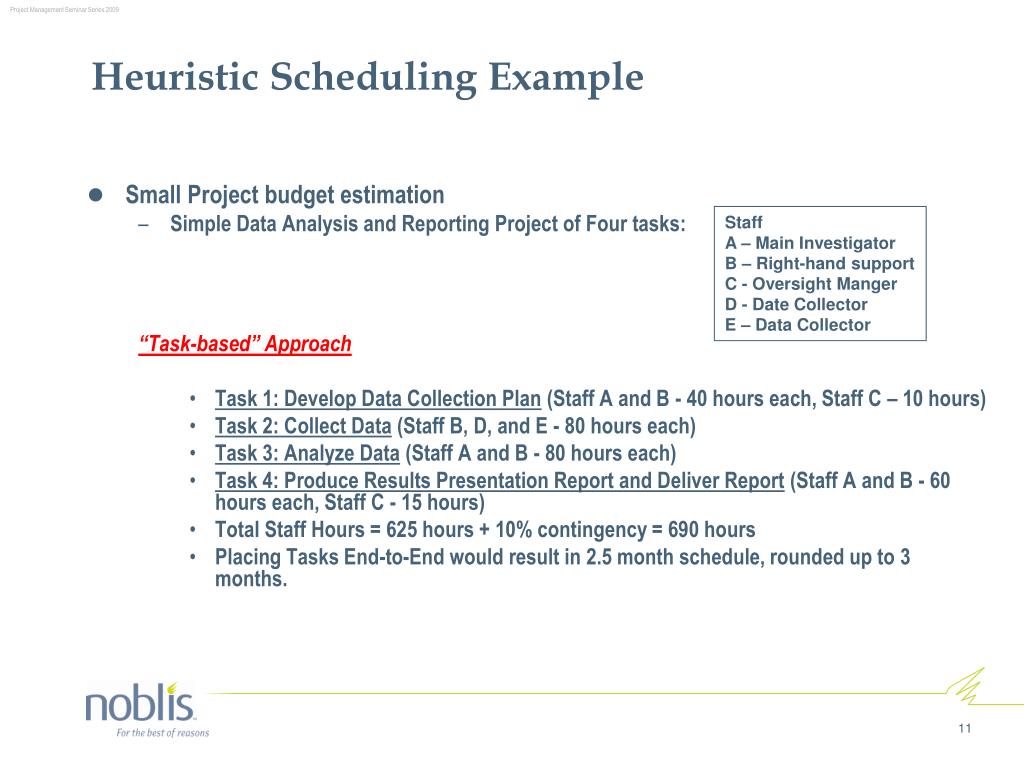

  11. Heuristic Scheduling Example • Small Project budget estimation • Simple Data Analysis and Reporting Project of Four tasks: “Task-based” Approach • Task 1: Develop Data Collection Plan (Staff A and B - 40 hours each, Staff C – 10 hours) • Task 2: Collect Data (Staff B, D, and E - 80 hours each) • Task 3: Analyze Data (Staff A and B - 80 hours each) • Task 4: Produce Results Presentation Report and Deliver Report (Staff A and B - 60 hours each, Staff C - 15 hours) • Total Staff Hours = 625 hours + 10% contingency = 690 hours • Placing Tasks End-to-End would result in 2.5 month schedule, rounded up to 3 months. Staff A – Main Investigator B – Right-hand support C - Oversight Manger D - Date Collector E – Data Collector

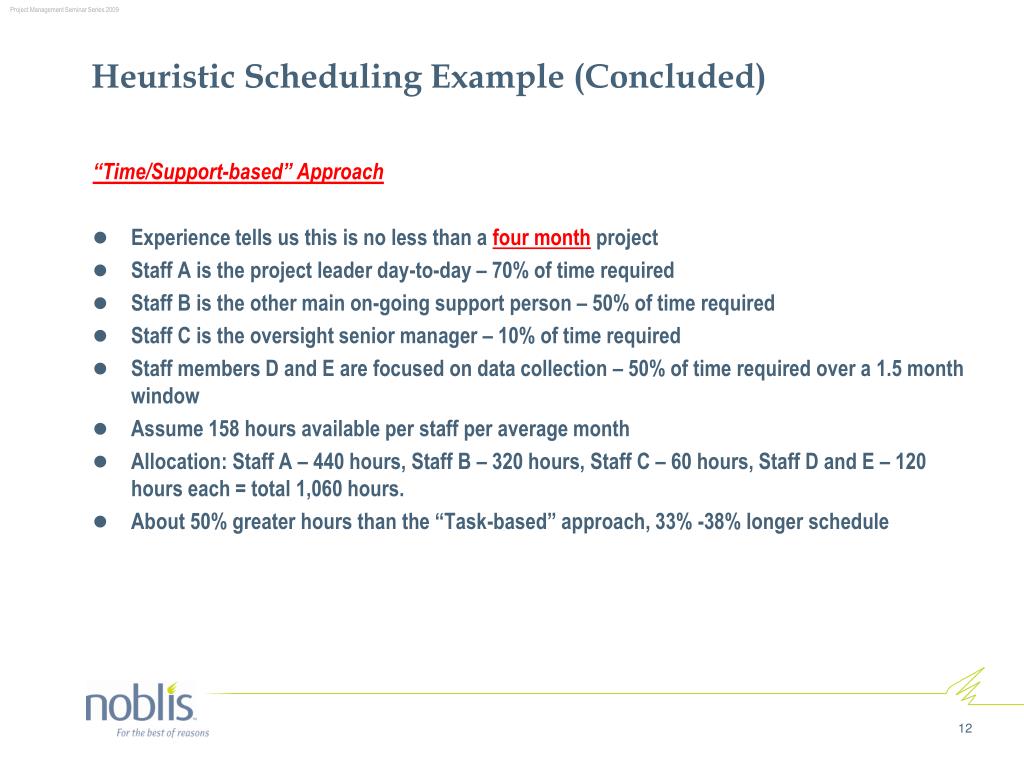

  12. Heuristic Scheduling Example (Concluded) “Time/Support-based” Approach • Experience tells us this is no less than a four month project • Staff A is the project leader day-to-day – 70% of time required • Staff B is the other main on-going support person – 50% of time required • Staff C is the oversight senior manager – 10% of time required • Staff members D and E are focused on data collection – 50% of time required over a 1.5 month window • Assume 158 hours available per staff per average month • Allocation: Staff A – 440 hours, Staff B – 320 hours, Staff C – 60 hours, Staff D and E – 120 hours each = total 1,060 hours. • About 50% greater hours than the “Task-based” approach, 33% -38% longer schedule

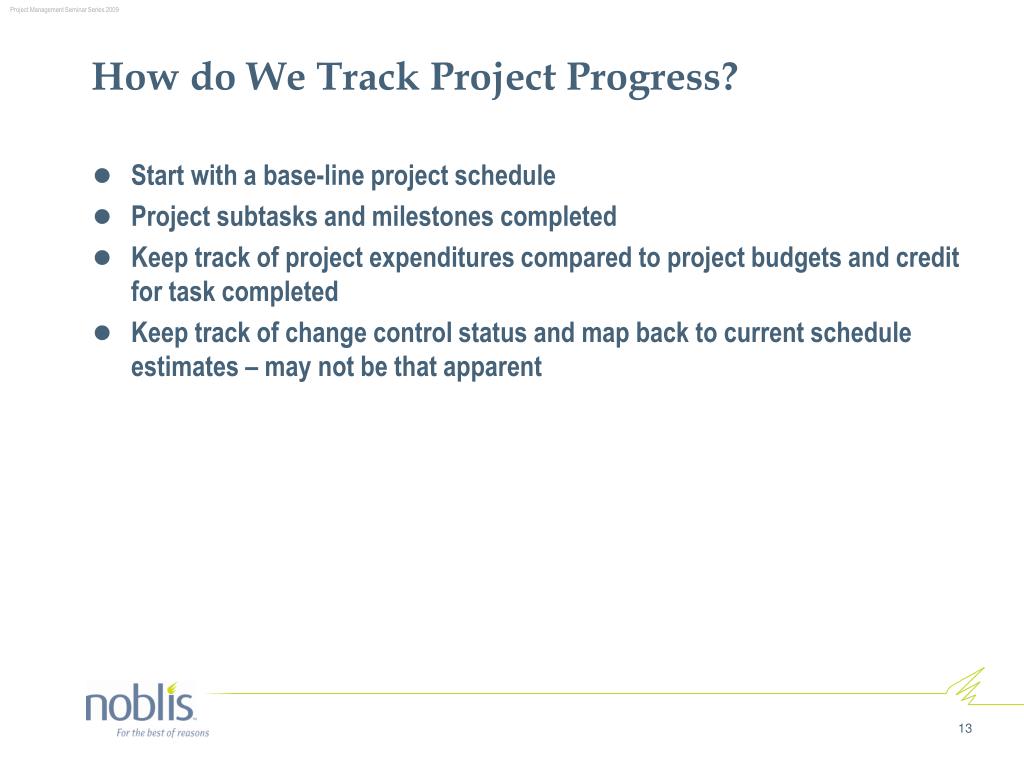

  13. How do We Track Project Progress? • Start with a base-line project schedule • Project subtasks and milestones completed • Keep track of project expenditures compared to project budgets and credit for task completed • Keep track of change control status and map back to current schedule estimates – may not be that apparent

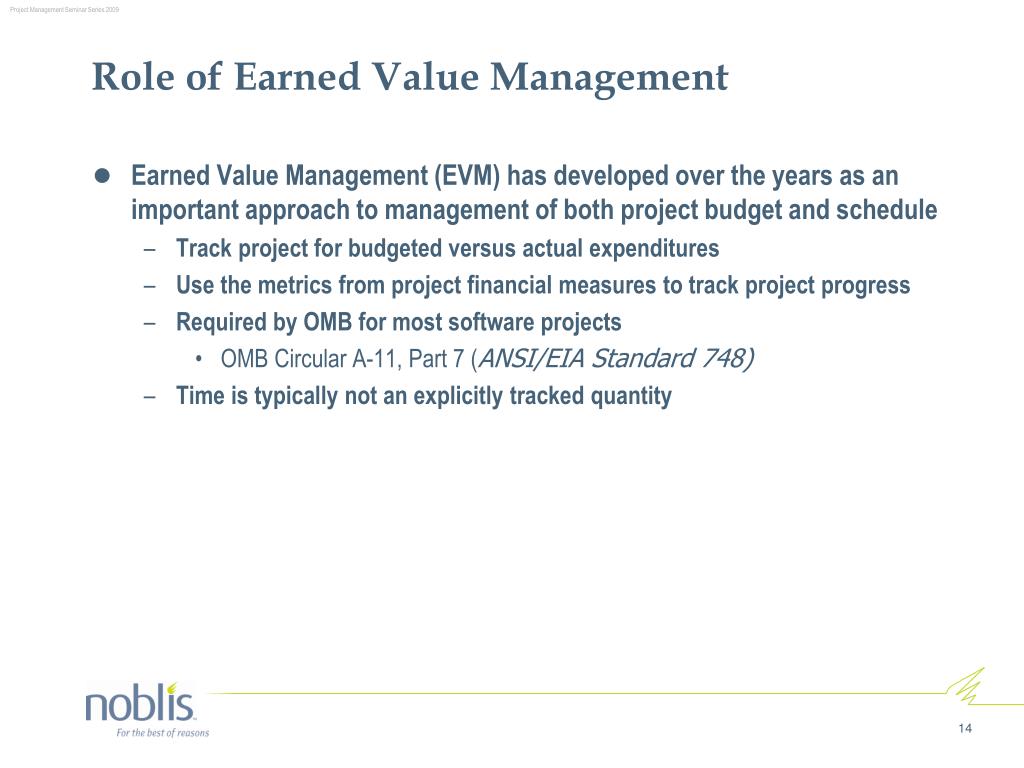

  14. Role of Earned Value Management • Earned Value Management (EVM) has developed over the years as an important approach to management of both project budget and schedule • Track project for budgeted versus actual expenditures • Use the metrics from project financial measures to track project progress • Required by OMB for most software projects • OMB Circular A-11, Part 7 (ANSI/EIA Standard 748) 7 • Time is typically not an explicitly tracked quantity

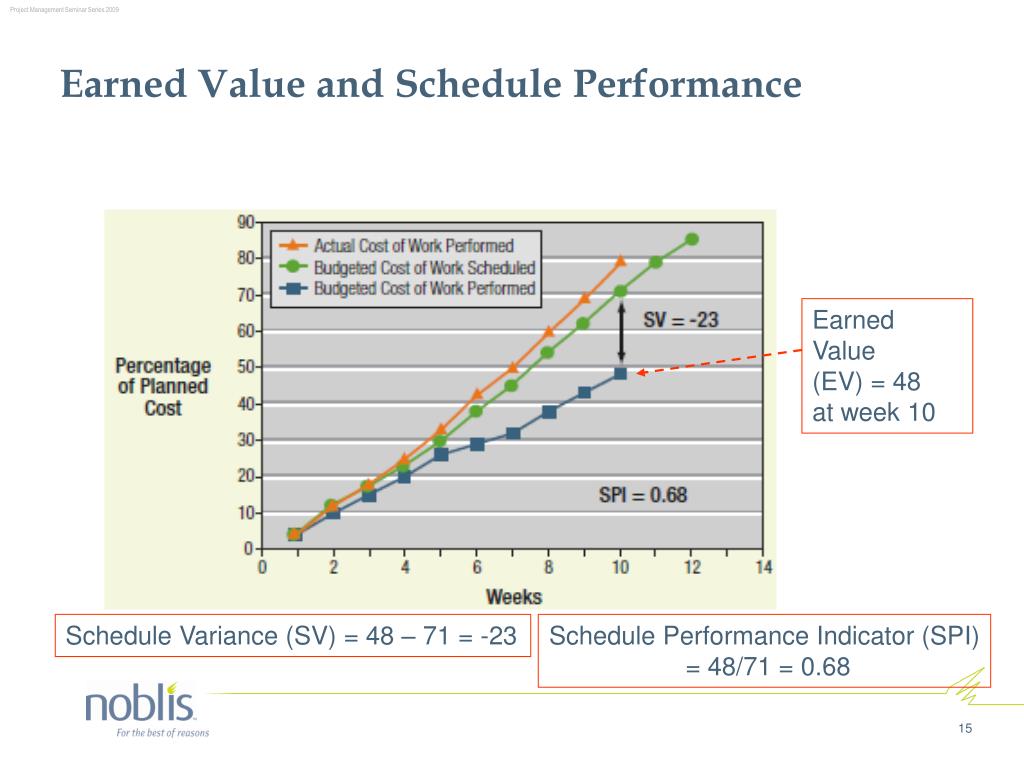

  15. Schedule Variance (SV) = 48 – 71 = -23 Schedule Performance Indicator (SPI) = 48/71 = 0.68 Earned Value and Schedule Performance Earned Value (EV) = 48 at week 10

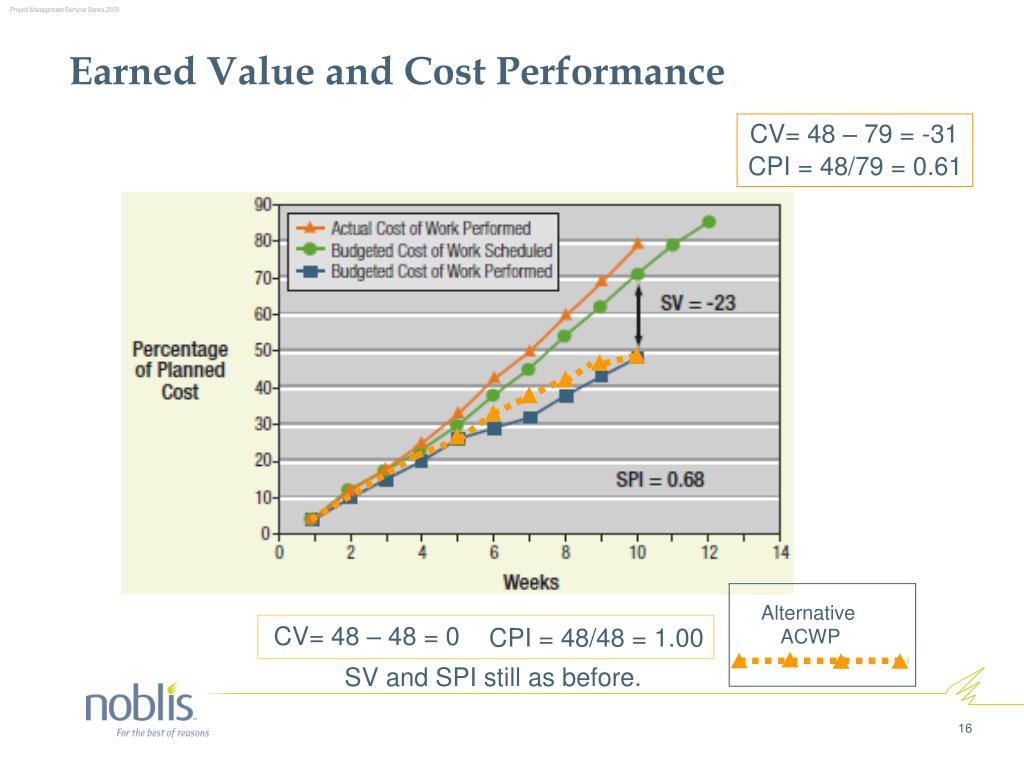

  16. Alternative ACWP Earned Value and Schedule Performance (Continued) Earned Value and Cost Performance CV= 48 – 79 = -31 CPI = 48/79 = 0.61 CV= 48 – 48 = 0 CPI = 48/48 = 1.00 SV and SPI still as before.

  17. Earned Value and Schedule Performance (Continued)

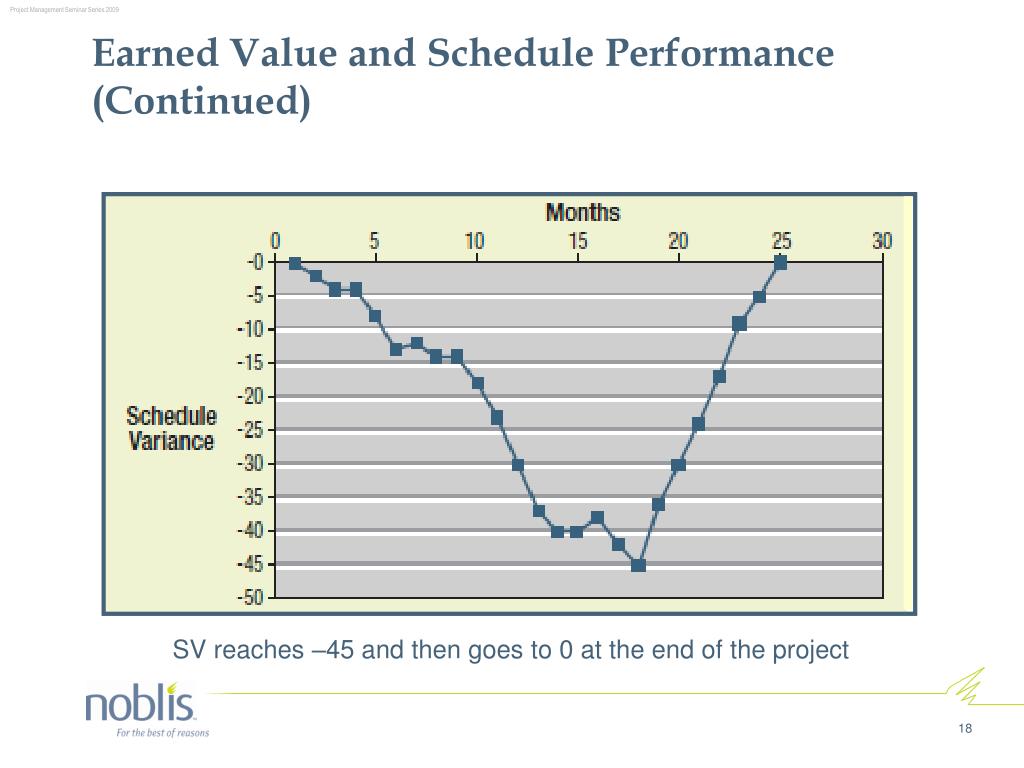

  18. Earned Value and Schedule Performance (Continued) SV reaches –45 and then goes to 0 at the end of the project

  19. Earned Value and Schedule Performance (Concluded)

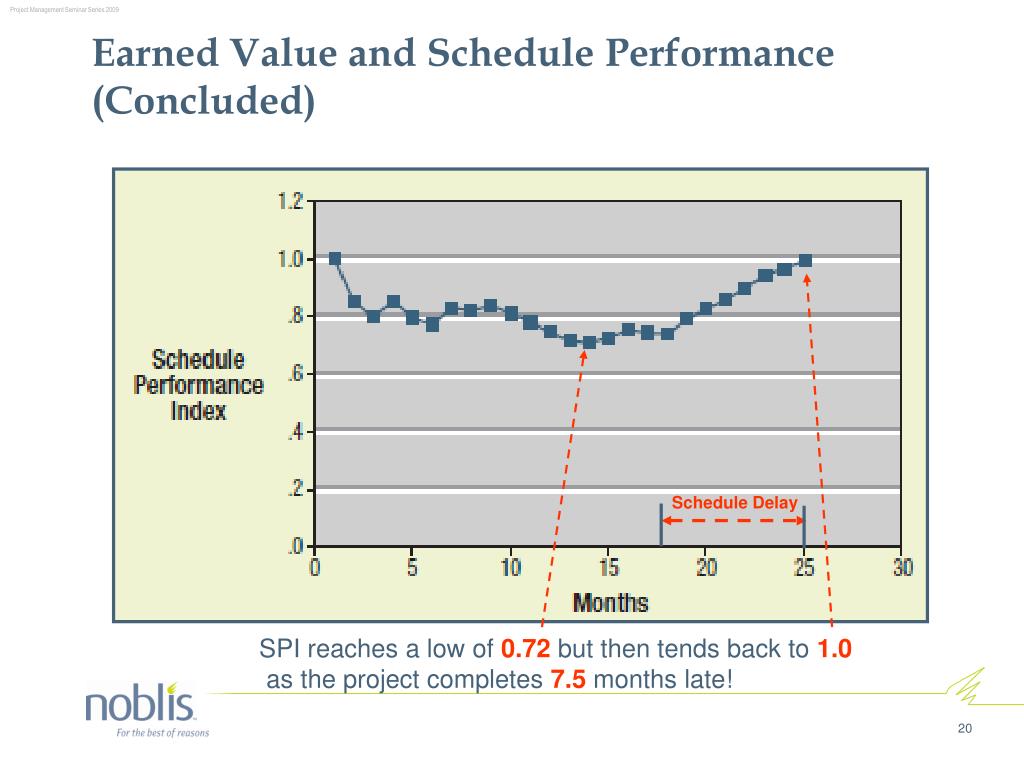

  20. Earned Value and Schedule Performance (Concluded) Schedule Delay SPI reaches a low of 0.72 but then tends back to 1.0 as the project completes 7.5 months late!

  21. What is Earned Schedule? • Simple, but elegant concept • Uses EVM data to produce a more useful index of project schedule status • Devised in 2003 by Walter Lipke, software project manager who has pioneered the use of EVM for software development project management • Empirical studies found Earned Schedule (ES) to be a superior predictor of project schedule and completion www.earnedschedule.com

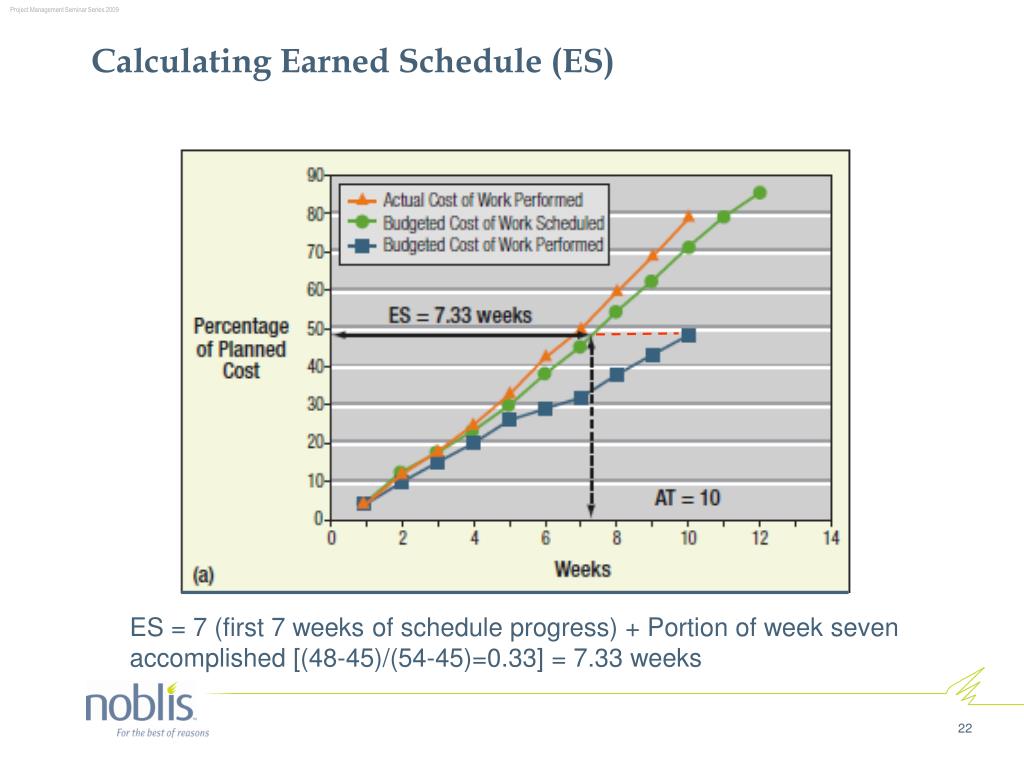

  22. Calculating Earned Schedule (ES) ES = 7 (first 7 weeks of schedule progress) + Portion of week seven accomplished [(48-45)/(54-45)=0.33] = 7.33 weeks

  23. How Can We be Both Pessimistic and Optimistic at the Same Time? • Monte Carlo simulation analysis allows us to consider reference class forecasting • Distributional impacts on activities duration and cost • Takes into account the interaction of project activity events • Leads to longer, more costly and pessimistic forecasts • Need a way to counter-balance the pessimistic trends with Monte Carlo simulation • Consider risk moderation responses • “What if?” responses considered ahead of time

  24. Basically We Need to Establish a Risk Analysis Exercise During Project Planning and Continue It During Project Execution Source: Jane Powanda, Noblis, Inc.

  25. How can the Event Chain Method help us? • An external event can occurs which impacts the status of one or more project activities • In response to the first event subsequent events are triggered to respond to the effects of the first event • Event Chains are established and simulation software is used to track and manage all the events across the project activities • Interventions included in response events attempt to modify and manage the inherent risk to the project

  26. Project Activities Can be Linked Through an Event Chain • Events can be external and • autonomous – a Triggering Event • Event can be in response to a • Triggering event Excited State

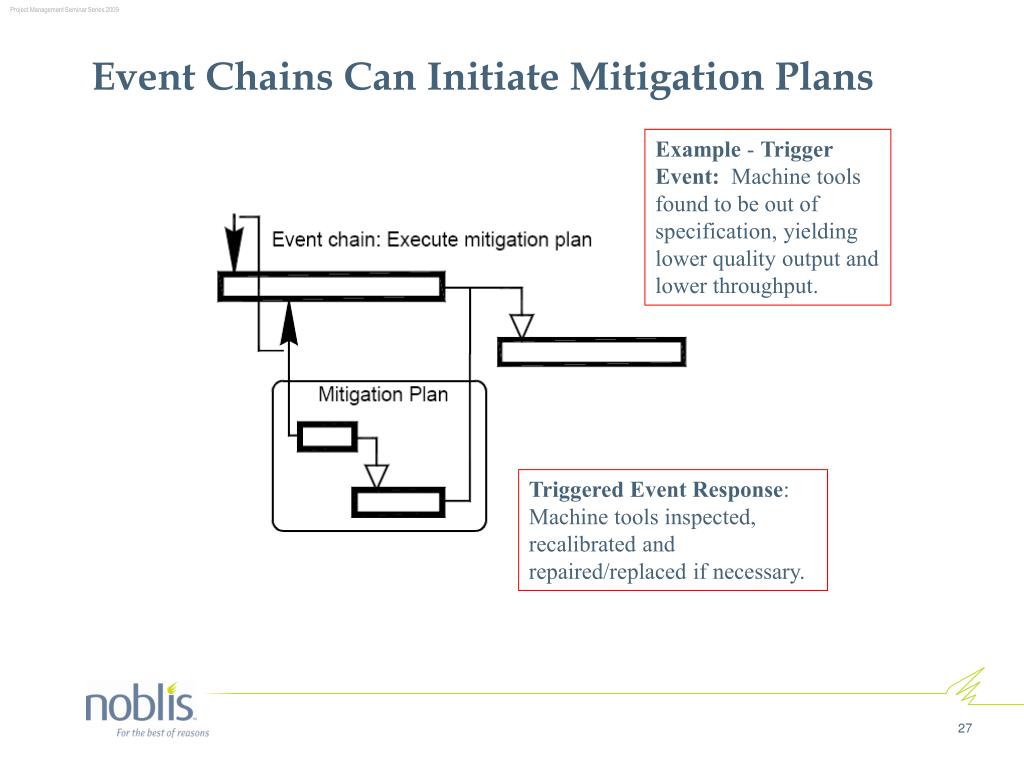

  27. Event Chains Can Initiate Mitigation Plans Example - Trigger Event: Machine tools found to be out of specification, yielding lower quality output and lower throughput. Triggered Event Response: Machine tools inspected, recalibrated and repaired/replaced if necessary.

  28. Features Useful to Support Event Chain Method – Wish List • Provide classic project management scheduling reporting and resource management capabilities • Incorporate and interface with major project management scheduling software (e.g. MS Project, Primavera, etc.) • Handle development and management of event chains • Allow for interaction of triggering events and responsive events impacting one or more project activities and their associated resources • Be capable of supporting Monte Carlo Analysis and statistical results reporting • Support project resource utilization and activity completion accounting • Support EVM maintenance • Allow for project branching due to event occurrence • Allow for re-baselining and maintenance of all project accounts for each baseline

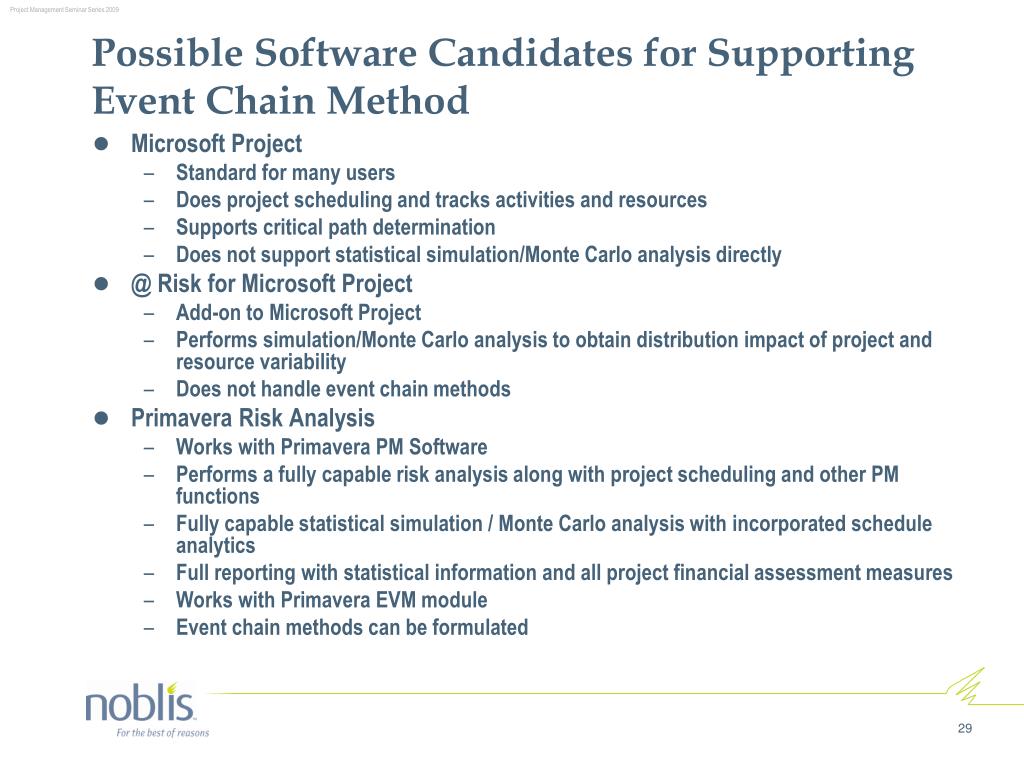

  29. Possible Software Candidates for Supporting Event Chain Method • Microsoft Project • Standard for many users • Does project scheduling and tracks activities and resources • Supports critical path determination • Does not support statistical simulation/Monte Carlo analysis directly • @ Risk for Microsoft Project • Add-on to Microsoft Project • Performs simulation/Monte Carlo analysis to obtain distribution impact of project and resource variability • Does not handle event chain methods • Primavera Risk Analysis • Works with Primavera PM Software • Performs a fully capable risk analysis along with project scheduling and other PM functions • Fully capable statistical simulation / Monte Carlo analysis with incorporated schedule analytics • Full reporting with statistical information and all project financial assessment measures • Works with Primavera EVM module • Event chain methods can be formulated

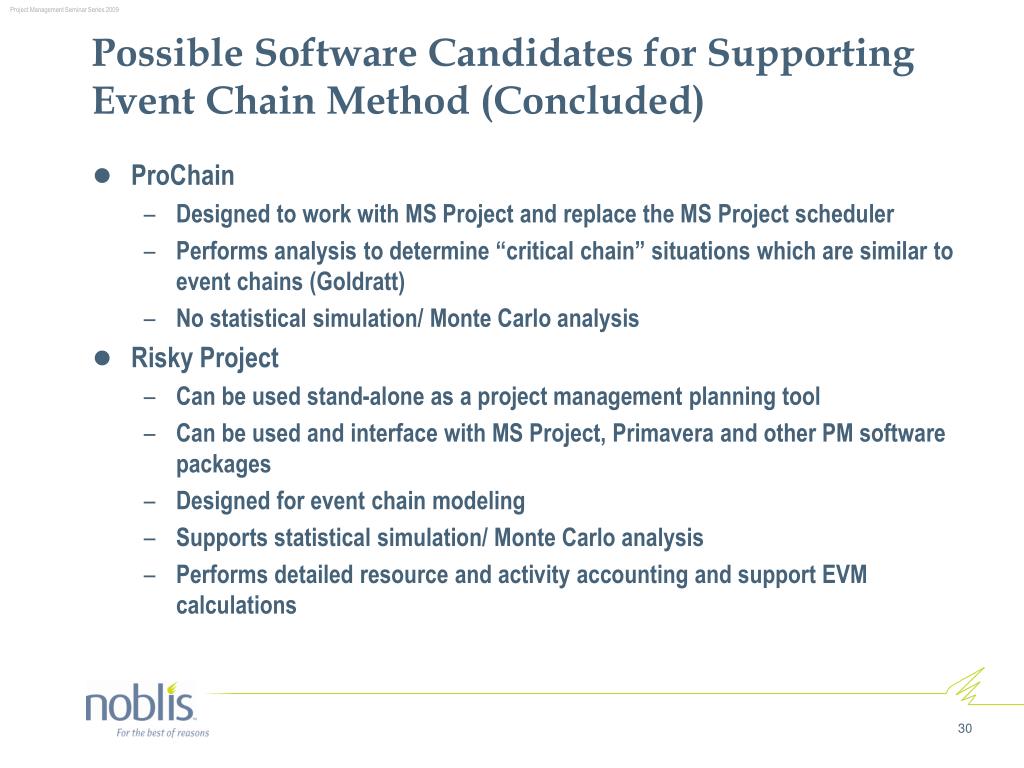

  30. Possible Software Candidates for Supporting Event Chain Method (Concluded) • ProChain • Designed to work with MS Project and replace the MS Project scheduler • Performs analysis to determine “critical chain” situations which are similar to event chains (Goldratt) • No statistical simulation/ Monte Carlo analysis • Risky Project • Can be used stand-alone as a project management planning tool • Can be used and interface with MS Project, Primavera and other PM software packages • Designed for event chain modeling • Supports statistical simulation/ Monte Carlo analysis • Performs detailed resource and activity accounting and support EVM calculations

  31. Power of Synergy – How can Earned Schedule and Event Chain Work Together? Step 1. The project team develops the work breakdown Structure (WBS) and lays out project plan with resources and durations. EVM accounting is put in place along with ES. Step 2. A second team or sub-team group takes plan and introduces risk elements to activities. Identifies negative impact areas. Both teams consider response events to mitigate or avoid risk effects. Step 3. Both teams work to develop an event chain structure incorporating all information known to date. New plan with incorporated event chains is run to finalize the project schedule and costs. Step 4. Original Project team continues to monitor and manage project execution. Implements planned event responses as necessary. Can deviate and modify the event chains as events unfold. Completed activities are documented.

  32. Power of Synergy –Schedule Management and the other SIGMA PMO Articles • Toward Best-Practice Management • by Robert G. Vorthman, Jr. • Many methods, templates and practices in PM are mentioned • Some relate to schedule management, particularly risk analysis • Monte Carlo and simulation cited as less useful, but what • does this information from Bresner and Hobbs mean? • The Modern Program Office: New Goals, • New Organization • by Michael D. Nelson and Shawn J. Margolis • 61% IT projects fail / 78% are late or over budget • Project leadership differs from project management • Schedule management needs both • The PMO can be the source of expertise and knowledge to • support improved schedule management approaches • Toolkit for Federal Information Technology • Project Managers • by Brian H. Price and David W. Vera • Devised an integrated approach to financial management/ • investment control and the SDLC • Linkage to proper IT support roles • Schedule management approaches must be consistent • with financial and resource requirements • Managing Mutiple Information Technlogy Projects: • Lessons Learned • by Daphne B. Byron and Chip Steiner • Project tracking knowledge and response essential • Must understand how change control impacts schedule • Existing EVM schedule indices not as useful, suggests ES • The Case for Agile Management • by John E. Freeman • “Plan-driven” PMO may not be responsive enough • Agile PM looks for internal initiative and controls, and • flexible responses • Schedule management can take advantage of pre-planned • knowledge, yet be responsive to continuous • learning and adjustment – point of operation mid-way between • agile management and the “plan-driven” PMO • Using Six Sigma in Project Forensics • by John K. Stevenson and Frederick W. James • Looking for project “defects” after the fact • Uses DMAIC* framework • Found project forecasting and unrealistic project schedule • defects • Also found project experience and requirements • development defects * Design-Measure-Analyze-Identify-Control

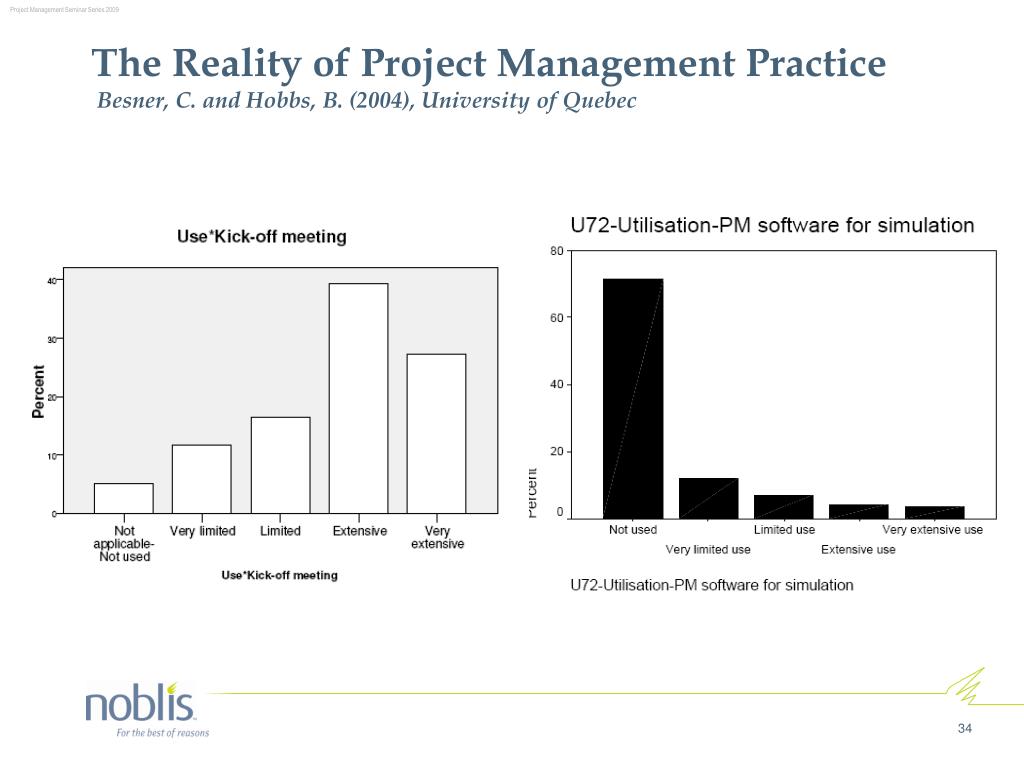

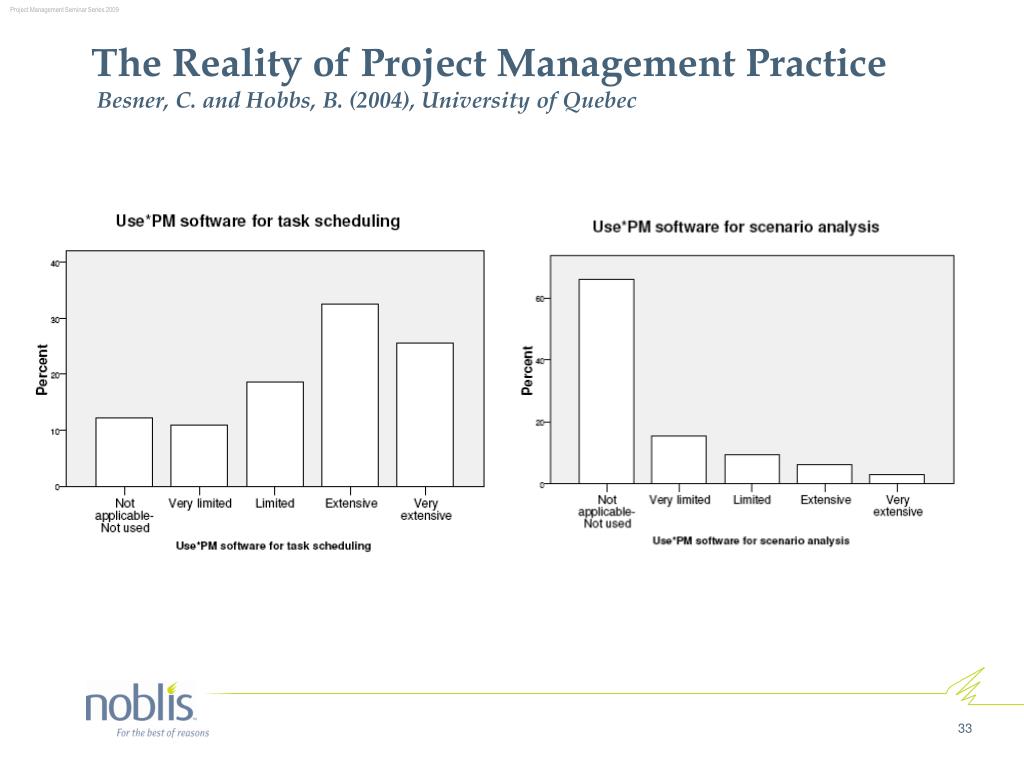

  33. The Reality of Project Management PracticeBesner, C. and Hobbs, B. (2004), University of Quebec

  34. The Reality of Project Management PracticeBesner, C. and Hobbs, B. (2004), University of Quebec
