] po [ Rollout Methodology

] po [ Rollout Methodology. Frank Bergmann frank.bergmann@project-open.com. (cc) Except where otherwise noted , content on this slide is licensed under a Creative Commons Attribution 3.0 License. Contents. Overview Schematic Planning Implementation Steps Overview

willow
Download Presentation

] po [ Rollout Methodology

An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript


  1. ]po[Rollout Methodology Frank Bergmannfrank.bergmann@project-open.com (cc) Except where otherwise noted, content on this slide is licensed under a Creative Commons Attribution 3.0 License

  2. Contents • Overview • Schematic Planning • Implementation Steps Overview • ]po[ Project Definition Check points • ]po[ Go-Live Check Points • ]po[ Operations Check Points • ]po[ Implementation Steps • Definition Phase • Extensions Phase • Installation Phase • Training Phase • Go-Live Phase • After Go-Live Phase • ]po[ Rollout Options • „Vertical“ Rollout • „Horizontal“ Rollout • Typical Rollout 1 – Test Operations • Typical Rollout 2 – Accounting Integration • Typical Rollout 3 – Workflow Rollout • Typical Rollout 4 – Involve Other PMs • Typical Rollout 5 – Further Options

  3. ProjectOverview

  4. Go-Live Kickoff Schematic Planning For medium sized companies Defi-nition BaseInst. GapAnalysis Configuration Requirements Configu-ration ExtensionRequirements ExtensionDevelopment Data Import Requirements Legacy Data Import Training Training Training Go-LiveSupport Normal Support

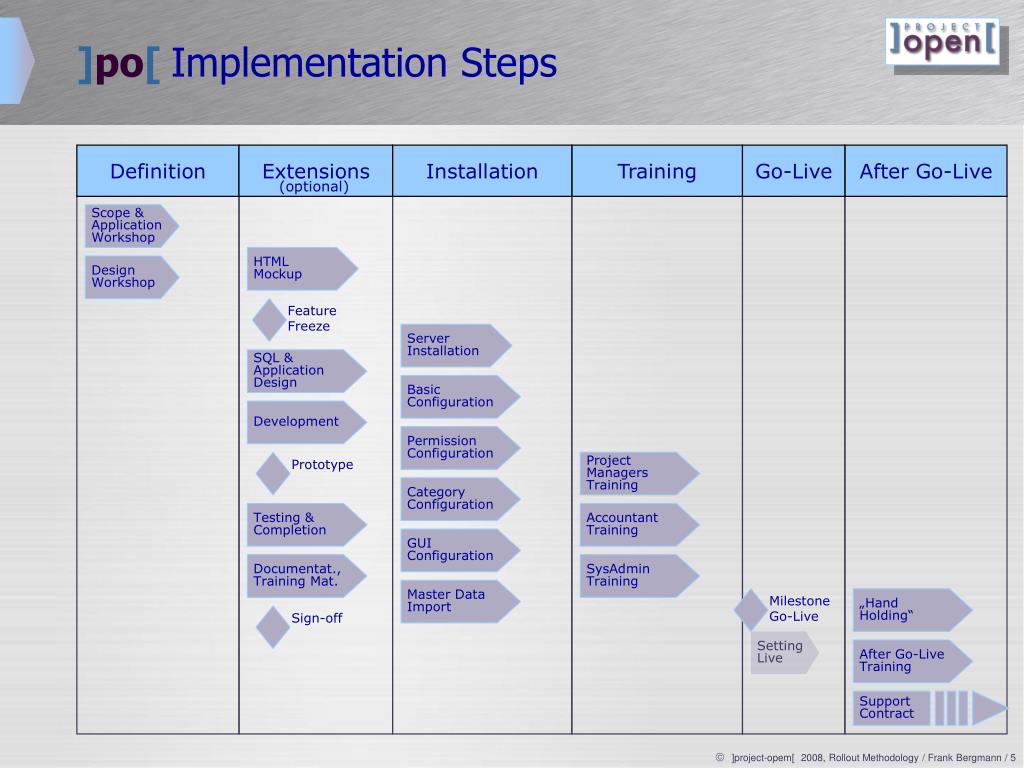

  5. ]po[Implementation Steps Definition Extensions Installation Training Go-Live After Go-Live (optional) Scope & Application Workshop HTMLMockup Design Workshop Feature Freeze Server Installation SQL & Application Design Basic Configuration Development Permission Configuration Prototype Project Managers Training Category Configuration Testing & Completion AccountantTraining GUI Configuration Documentat., Training Mat. SysAdminTraining Master Data Import MilestoneGo-Live „Hand Holding“ Sign-off Setting Live After Go-LiveTraining Support Contract

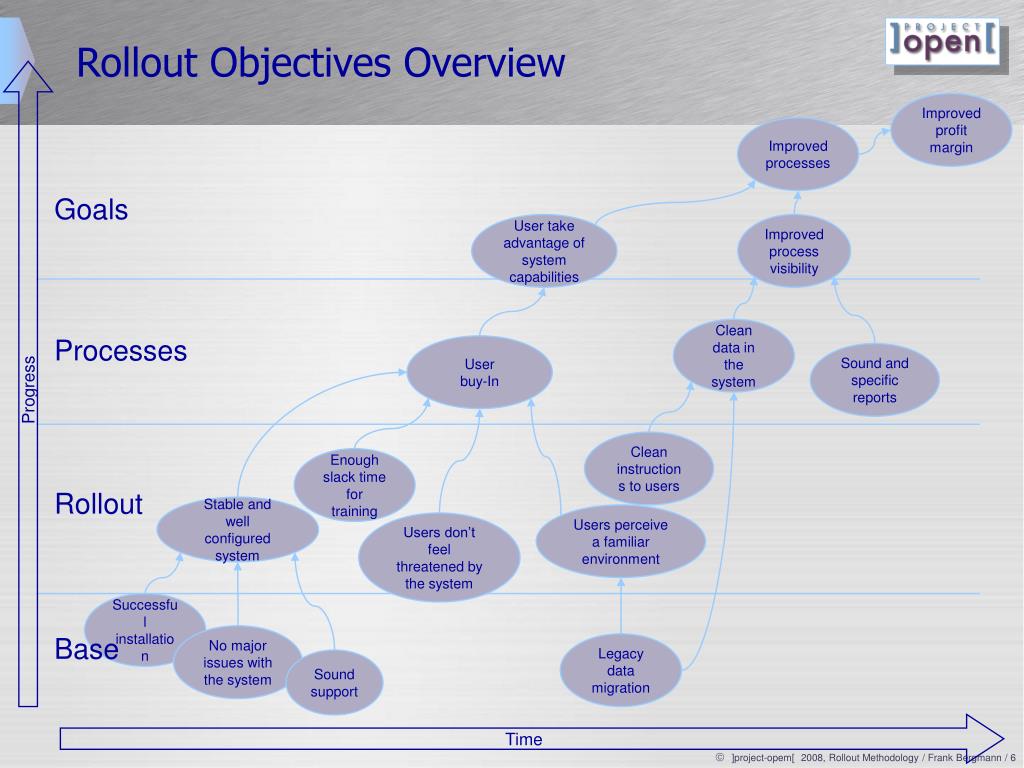

  6. Rollout Objectives Overview Improvedprofit margin Improvedprocesses Goals User take advantage of system capabilities Improved processvisibility Clean data in the system Processes Userbuy-In Sound and specific reports Progress Clean instructions to users Enough slack time for training Rollout Stable and well configured system Users perceive a familiar environment Users don’t feel threatened by the system Successful installation No major issues with the system Base Legacy data migration Sound support Time

  7. Key Terms for a Successful Rollout • Change-Management • Psychological process describing how person move on from an existing situation (comfort zone) to a new situation. • All system users and some stakeholders need to go through this process • Reference: Ross-Kanter • “Taking Ownership” • In some projects, the supposed users reject to use the system • Rejecting ownership is frequently related to bad data in the system that the user can’t trust. • A user starts “taking ownership” when he or she starts to add or modify data. • Buy-In • Describes the attitude of stakeholders towards the system and the project team • Based on

  8. ]po[ Project Definition • The decision “Adapt ]po[ or adapt the company” is the single most important factor to determine the project cost and implementation speed. • The “Strong Key User” is the most important factor in a project’s success. A strong Key User is somebody with detailed knowledge of all company processes and has some technology skills, quickly understanding the logic of a software. • The outcome of the Project Definition is used in the following phases, so it is important to document the decisions here.

  9. ]po[ Implementation and Go-Live • Each of the factors below need to be covered about 80% in order to allow a successful “go-live”. Small modifications (20%) are usually fine after the go-live if expectations are managed accordingly. • The key for a successful go-live is the “Training Manual” that explains how users should use ]po[. Writing this manual can take 5-10 net days of work..

  10. ]po[ Operations • The #1 issue after the go-live is the quality of data in the system. Please make sure that user can “trust” the data inside the system and know who entered these data, so that complaints can be converted in improvements. • The key for successful long-term ]po[ operations is a Support Team that is capable of modifying/ extending ]po[. This team can be either in-house with 3rd level support from ]po[ (recommended) of outsourced. • System Admin is usually not an issue anymore after the go-live. But please make sure to test recovery operations every 2-3 month.

  11. Process Map

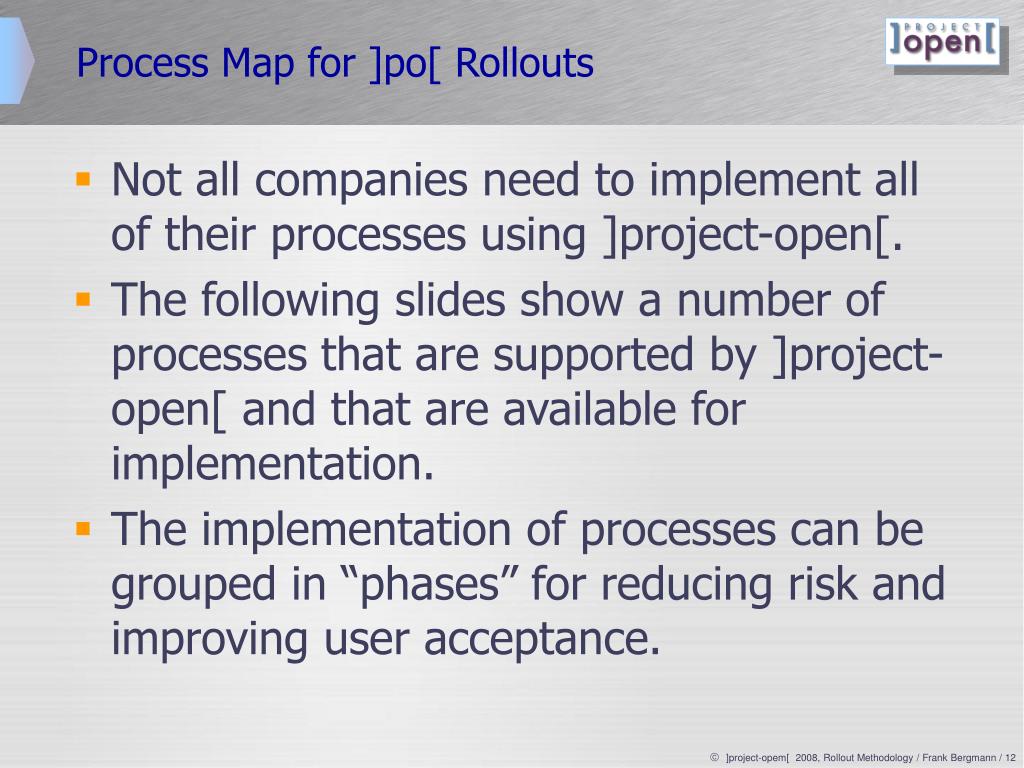

  12. Process Map for ]po[ Rollouts • Not all companies need to implement all of their processes using ]project-open[. • The following slides show a number of processes that are supported by ]project-open[ and that are available for implementation. • The implementation of processes can be grouped in “phases” for reducing risk and improving user acceptance.

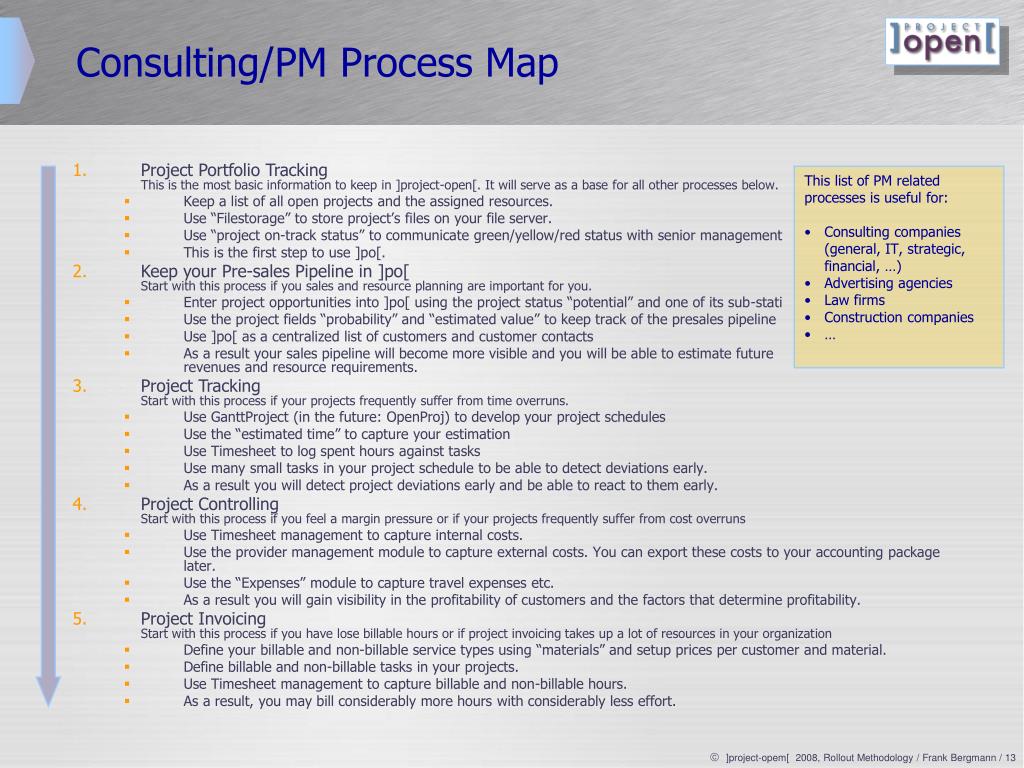

  13. Consulting/PM Process Map • Project Portfolio TrackingThis is the most basic information to keep in ]project-open[. It will serve as a base for all other processes below. • Keep a list of all open projects and the assigned resources. • Use “Filestorage” to store project’s files on your file server. • Use “project on-track status” to communicate green/yellow/red status with senior management • This is the first step to use ]po[. • Keep your Pre-sales Pipeline in ]po[Start with this process if you sales and resource planning are important for you. • Enter project opportunities into ]po[ using the project status “potential” and one of its sub-stati • Use the project fields “probability” and “estimated value” to keep track of the presales pipeline • Use ]po[ as a centralized list of customers and customer contacts • As a result your sales pipeline will become more visible and you will be able to estimate future revenues and resource requirements. • Project TrackingStart with this process if your projects frequently suffer from time overruns. • Use GanttProject (in the future: OpenProj) to develop your project schedules • Use the “estimated time” to capture your estimation • Use Timesheet to log spent hours against tasks • Use many small tasks in your project schedule to be able to detect deviations early. • As a result you will detect project deviations early and be able to react to them early. • Project ControllingStart with this process if you feel a margin pressure or if your projects frequently suffer from cost overruns • Use Timesheet management to capture internal costs. • Use the provider management module to capture external costs. You can export these costs to your accounting package later. • Use the “Expenses” module to capture travel expenses etc. • As a result you will gain visibility in the profitability of customers and the factors that determine profitability. • Project InvoicingStart with this process if you have lose billable hours or if project invoicing takes up a lot of resources in your organization • Define your billable and non-billable service types using “materials” and setup prices per customer and material. • Define billable and non-billable tasks in your projects. • Use Timesheet management to capture billable and non-billable hours. • As a result, you may bill considerably more hours with considerably less effort. • This list of PM related • processes is useful for: • Consulting companies (general, IT, strategic, financial, …) • Advertising agencies • Law firms • Construction companies • …

  14. Translation Mgmt. Process Map • Translation Project Portfolio • Use ]po[ to maintain the list of currently open translation projects • Translation Workflow Management • Keep track of the translation tasks per project and their respective status • Involve freelancers to download/upload their files themselves • Provider Management • Create Purchase Orders and Bills from ]project-open[ • Query Management • Keep track of queries and provide a history of queries to project managers • Freelance Skill Management • Keep track of your freelancer’s skills and improve the matching of freelancers to projects • Quality Management • Keep track of your freelancer’s performance • This list of PM related • processes is useful for: • Translation agencies • Internal translation departments • Freelancers and groups of freelancers

  15. HR Process Map • Basic Employee information in the system • Keeping track of current employees • Integrate access and security management • Resource management • Keep track of available resources • Keep track of resources assigned to projects • Identify over- and under utilization of resources • Skill Management • Keep track of resources’ skills and skill levels • Improve matching of resource skills to projects • Recruiting • Track candidates in ]po[ • Keep track of the recruiting workflow • Knowledge Management • Keep or track critical knowledge resources in ]po[ • Make knowledge resources available to the right people This list of processes is useful for most service companies.

  16. IT Services ManagementProcess Map & Rollout ITILProcesses AdditionalProcesses Phase 3: Projects and their artifacts: This is driven by Timesheet Mgmt, because staff needs projects to log their hours. Then Release Mgmt comes naturally, because all relevant information is already there. Project Portfolio Mgmt ProblemMgmt 3 Project Mgmt IncidentMgmt TimesheetMgmt SoftwareDevelopment ServiceDesk FinancialMgmt (1) 1 ReleaseMgmt CapacityMgmt (human) Phase 1: Service Desk + Timesheet: This is all you need to calculate the price per service request. ITStrategy Phase 2: Control systems and performance. Manual processes are hopeless, but Nagios + OCS Inventory do the job. Now you can compare SLAs with actual data. 4 Phase 4: Additional processes: These are not directly connected to the other processes and can be introduced at any time. Purchasing & Inventory Config.Mgmt HRMgmt FinancialMgmt (2) OCSInventory ProviderMgmt Service LevelMgmt SecurityMgmt ServerMonitoring 2 CapacityMgmt (system) ContinuityMgmt

  17. Data “Hygiene”

  18. “Data Hygiene” Intro “An ERP system is mostly about trust: Users who pull out data at one end have to trust the users who entered data at the other end. This is the true challenge.” From a posting in [erp-select] • “Clean” data is necessary for invoicing, financial controlling and any high-level reporting. • Data “pollution” can happen because of various factors: • Insufficient definition on how data should be entered • Lack of user training • Time pressure may lead to a conflict between a user’s performance evaluation and clean data entry • Lack of control to detect “polluted” data in the system • Lack of power to force users to enter clean data

  19. “Data Hygiene” Maturity Roadmap • Incomplete Production Data:The parallel use of other systems or Excel sheets leads to the situation that not all “production data” (projects etc.) are available in the system. • Inconsistencies in Core Data:Once all “production data” are available in the system, there may still be coarse inconsistencies in projects and financial, leading to incomplete invoicing and meaningless financial controlling results. • Inconsistencies in Non-Core Data:Once projects and finance are OK, there may still be inconsistencies in auxiliary data such as task definitions, price lists, invoice “unit of measure”, etc. • Consistent Data in all Major Processes:Once all data are captured consistently, you can correlate the organization’s operational with financial performance for all major processes and define performance indicators.

  20. “Data Hygiene” Feedback Loops • Data Hygiene is an iterative learning process. • Example Processes: • Projects (name, start & end dates, hierarchy) • Customer information for CRM • Provider information for provider mgmt. • Invoicing (produce quotes and invoices for each project). • Customer price lists • Provider price lists • Provider Billing (produce purchase orders and bills for providers) • Project planning (% assignation of users to projects) • Timesheet information • Absences and vacation • Quality reports and evaluations • Skill database • Query & issue management via forum • … • For each process you need to define: • The manager responsible for data hygiene • Norms to define “clean data” • The reports (or other control mechanisms) to extract information • The users responsible to enter/ correct data • The “feedback mechanism” and its escalation levels FeedbackLoop ]po[ InformationProducer InformationConsumer/Manager Report InformationProducer

  21. Benefits from “Data Hygiene” • ]po[ allows you to extract a wealth of high-level information if your data are entered correctly. Examples include: • Profit & Loss per project • Profit & Loss per customer over time • Profit & Loss per sales rep or project manager • Quality of delivered work vs. cost of service • … (please see the “Indicators” section for a range or performance indicators).

  22. Detailed Project Phase Description

  23. Work Package Objective Deliverables Definition Phase • Customer’s Senior Management learns about the application and identifies the ]po[modules to be implemented. • Identification of extension development necessities. • Senior Management or Key Users specify configuration and customization necessities. • Scoping and functional requirement definition for extension development. • Scope of project • Input for first cost estimate • Decision structure • Configuration requirements • Extension requirements • Input for detailed quote Scope & Application Workshop Design Workshop

  24. Work Package Objective Deliverables Extensions Phase • Build a functional “mockup” using static HTML pages based on input from the “Design Workshop”. • Mockup confirmation in a functional design workshop and freeze of specifications. • Define how extensions should relate to existing ]po[ modules. • Design a SQL data model. • Implement the specified extensions. • Presentation of a prototype to the customer. • Completion of the prototype functionality and testing in the customer’s context. • Documentation of the extensions and development / adaptation of training material. • Extensions sign-off. • HTML mockup • Functional specifications • Reutilization Concept • Data Model • Working code • Confirmation of functionality • Working system • Documentation & training material • Working extensions HTMLMockup FeatureFreeze SQL & Application Design Development Prototype Testing & Completion Documentat., Training Mat. Sign-off

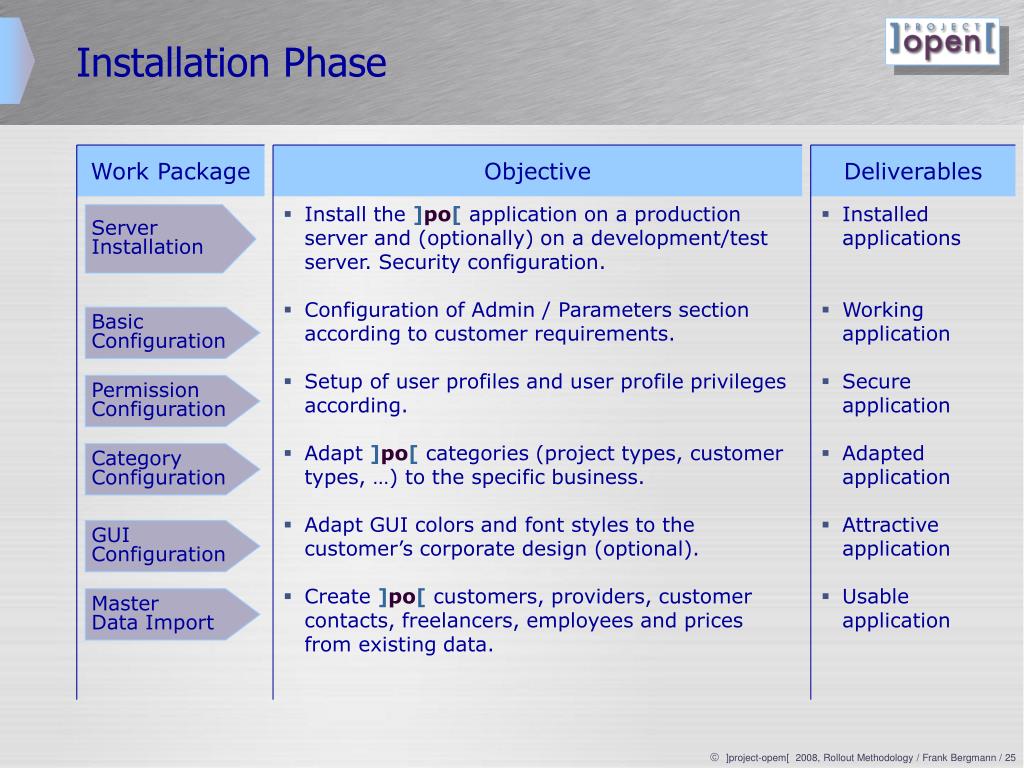

  25. Work Package Objective Deliverables Installation Phase • Install the ]po[ application on a production server and (optionally) on a development/test server. Security configuration. • Configuration of Admin / Parameters section according to customer requirements. • Setup of user profiles and user profile privileges according. • Adapt ]po[ categories (project types, customer types, …) to the specific business. • Adapt GUI colors and font styles to the customer’s corporate design (optional). • Create ]po[ customers, providers, customer contacts, freelancers, employees and prices from existing data. • Installed applications • Working application • Secure application • Adaptedapplication • Attractive application • Usableapplication Server Installation Basic Configuration Permission Configuration CategoryConfiguration GUI Configuration Master Data Import

  26. Work Package Objective Deliverables Training Phase • Allow PMs to efficiently use the “Translation Workflow”, “File Storage” and “Forum” modules. • Allow accountants to efficiently use the “Translation Invoices” and “Freelance Invoices” (optional) modules. • Enable the Sysadmin to perform backup, restore and recovery operations. • Successful training • Successful training • Successful training Project Managers Training AccountantTraining SysAdminTraining

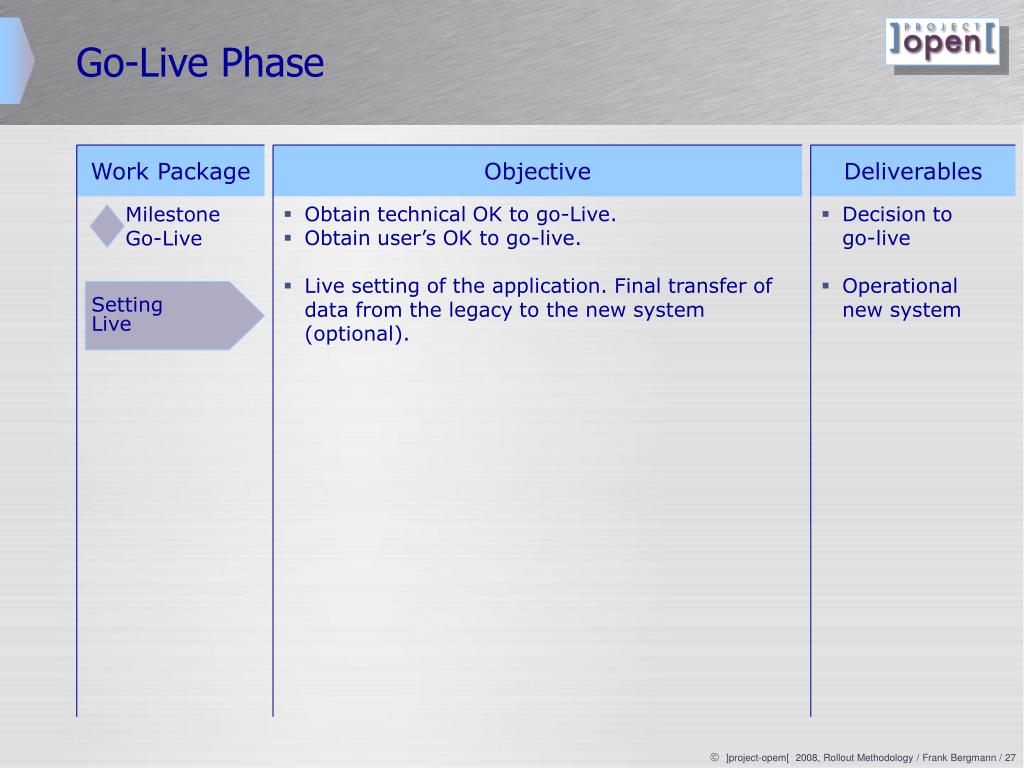

  27. Work Package Objective Deliverables Go-Live Phase • Obtain technical OK to go-Live. • Obtain user’s OK to go-live. • Live setting of the application. Final transfer of data from the legacy to the new system (optional). • Decision to go-live • Operational new system MilestoneGo-Live Setting Live

  28. Work Package Objective Deliverables Support Contract After Go-Live • Presence of implementation team members during the first days after going live in order to deal with questions and issues. • Training to deal with unanticipated or unresolved questions after the go-live. • Ongoing support. • Successful completion of the first project cycles • All users are capable of using the system • A stable and updated system „Hand Holding“ After Go-LiveTraining

  29. ]po[ Implementation Phases Definition Extensions Installation Training Go-Live After Go-Live (optional) Scope & Application Workshop HTMLMockup Design Workshop Feature Freeze Server Installation SQL & Application Design Basic Configuration Development Permission Configuration Prototype Project Managers Training Category Configuration Testing & Completion AccountantTraining GUI Configuration Documentat., Training Mat. SysAdminTraining Master Data Import MilestoneGo-Live „Hand Holding“ Sign-off Setting Live After Go-LiveTraining Support Contract

  30. Change ManagementStrategies

  31. Processes OperationsManager Customer2 Customer1 Freelance2 Freelance1 Man. Dir. SalesManager PM 1 PM 3 PM 2 PM 4 ResourceManager Finance ]po[ Rollout Options PM Vertical Rollout Option: One project manager starts using the system, possibly only for a limited number of customers Filestorage Freelance-DB CRM Accounting Workflow Horizontal Rollout Option: A single process (PM, CRM, filestorage, ...) is being used by all PMs Quality-DB ...

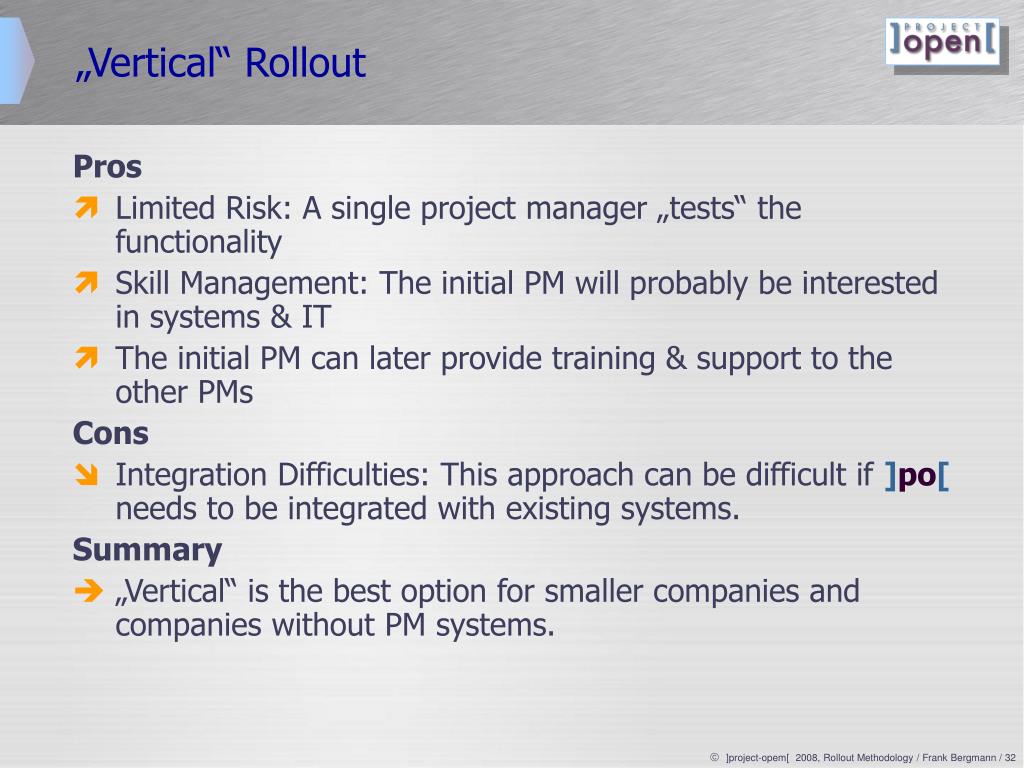

  32. „Vertical“ Rollout Pros • Limited Risk: A single project manager „tests“ the functionality • Skill Management: The initial PM will probably be interested in systems & IT • The initial PM can later provide training & support to the other PMs Cons • Integration Difficulties: This approach can be difficult if ]po[ needs to be integrated with existing systems. Summary • „Vertical“ is the best option for smaller companies and companies without PM systems.

  33. „Horizontal“ Rollout Pros • Reduces Integration Difficulties: „Big Bang“ rollout is cheaper if there are existing systems that would have to run in parallel otherwise. • No duplicated training Cons • Higher Risk: Initial implementation difficulties have bigger impact on the company Summary • „Horizontal“ is the best option for complex rollouts in larger companies in order to avoid high integration costs with existing systems. • „Horizontal“ may be combined with a „vertical“ test phase.

  34. Processes OperationsManager Customer2 Customer1 Freelance1 Freelance2 Man. Dir. SalesManager PM 1 PM 3 PM 2 PM 4 ResourceManager Finance Typical Rollout (1) Test Operations Start with the most IT-savvy PM. He or she will later provide training to the other PMs Start with project management and the freelance-DB. You will need to setup a few customers and freelancers in order to get started. PM Filestorage Freelance-DB CRM Accounting Workflow Quality-DB ...

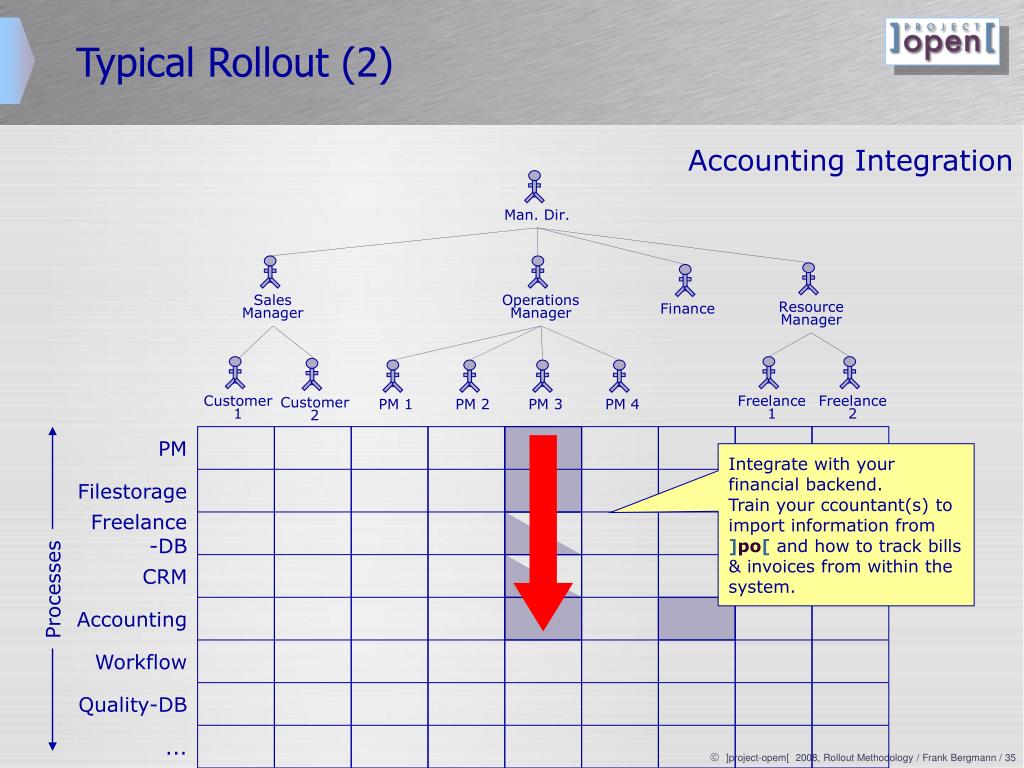

  35. Processes OperationsManager Customer2 Customer1 Freelance1 Freelance2 Man. Dir. SalesManager PM 1 PM 3 PM 2 PM 4 ResourceManager Finance Typical Rollout (2) Accounting Integration PM Integrate with your financial backend. Train your ccountant(s) to import information from ]po[ and how to track bills & invoices from within the system. Filestorage Freelance-DB CRM Accounting Workflow Quality-DB ...

  36. Processes OperationsManager Customer2 Customer1 Freelance1 Freelance2 Man. Dir. SalesManager PM 1 PM 3 PM 2 PM 4 ResourceManager Finance Typical Rollout (3) Workflow Rollout PM Now one option is to start using the translation workflow and to involve the first freelancers in the process. However, this is not a necessary step. Filestorage Freelance-DB CRM Accounting Workflow Quality-DB ...

  37. Processes OperationsManager Customer2 Customer1 Freelance1 Freelance2 Man. Dir. SalesManager PM 1 PM 3 PM 2 PM 4 ResourceManager Finance Typical Rollout (4) Involve other PMs PM Now (some 1-3 month after starting with the first PM) your company is typically ready to rollout ]po[ for the other PMs. Filestorage Freelance-DB CRM Accounting Workflow Quality-DB ...

  38. Processes OperationsManager Customer2 Customer1 Freelance1 Freelance2 Man. Dir. SalesManager PM 1 PM 3 PM 2 PM 4 ResourceManager Finance Typical Rollout (5) Further Options PM After this point there are several options on how to proceed. However, your company will have made a lot of progress understanding the system, allowing you to take an informed decision. Filestorage Freelance-DB CRM Accounting Workflow Quality-DB ...

  39. Two-Week Rapid Rollout

  40. Week 1 Week 2 Fix Issues, clarify processes Fix Issues, clarify processes Two-Week Rapid Rollout Getting ]po[ running in two condensed weeks Preconditions Specs BaseInst. Training on the configured system.Last check with PMs if everything OK. Training for Accounting, Sales, ... GapAnalysis Configu-ration Configuration Requirements Legcy Data Import Go-Live ExtensionRequirements • The Go-Live Condition: • All #1 prios need to be OK in order to go-live Go-Live"Hand-Holding" Data Import Requirements • Week 2 is to fix prio #2 issues and questions, such as incomplete master data or process variants • Prio #3 issues can be fixed remotely Support(Contract)

  41. End Frank Bergmann frank.bergmann@project-open.com www.project-open.com
